FDOT District Four - Broward County Header Image

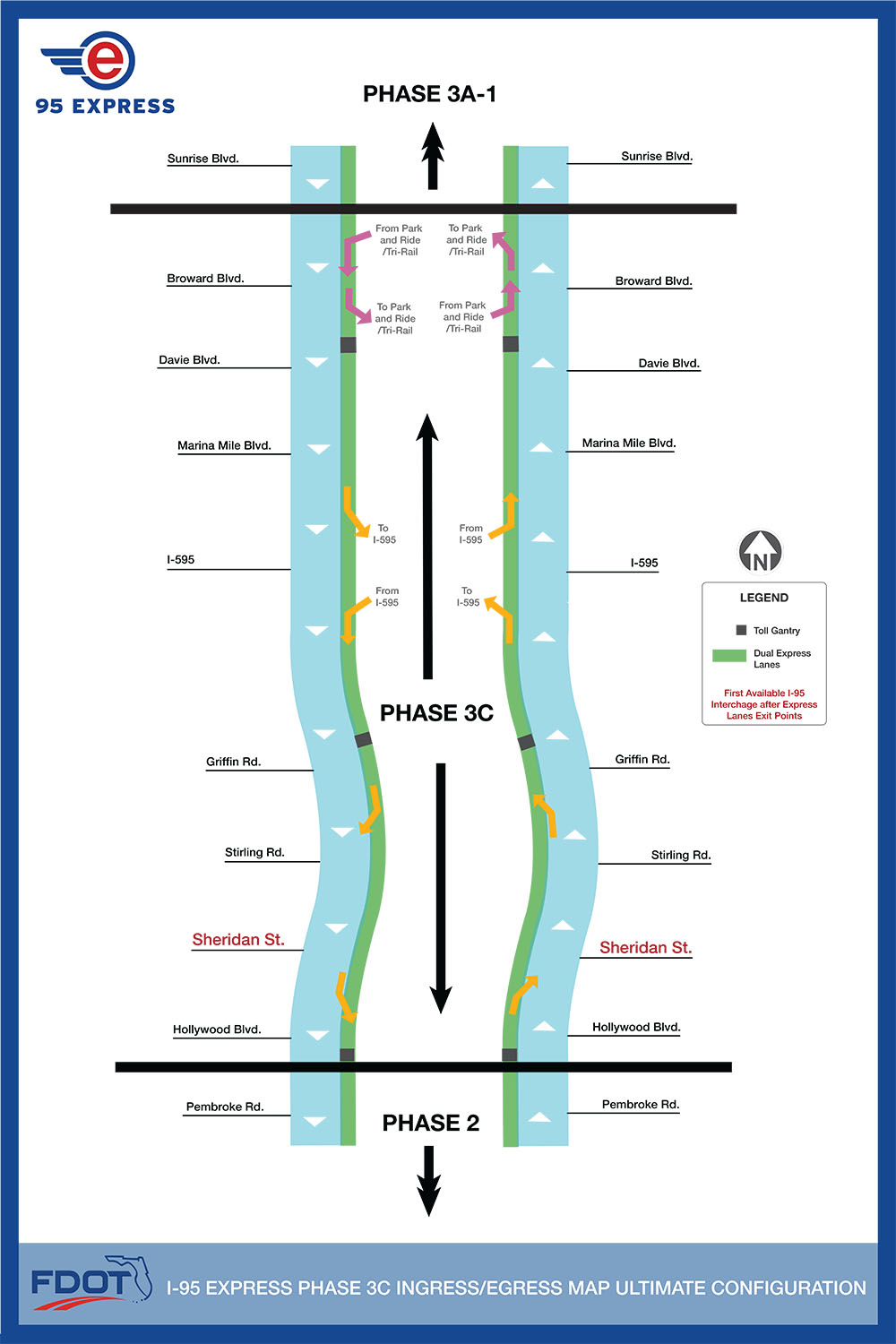

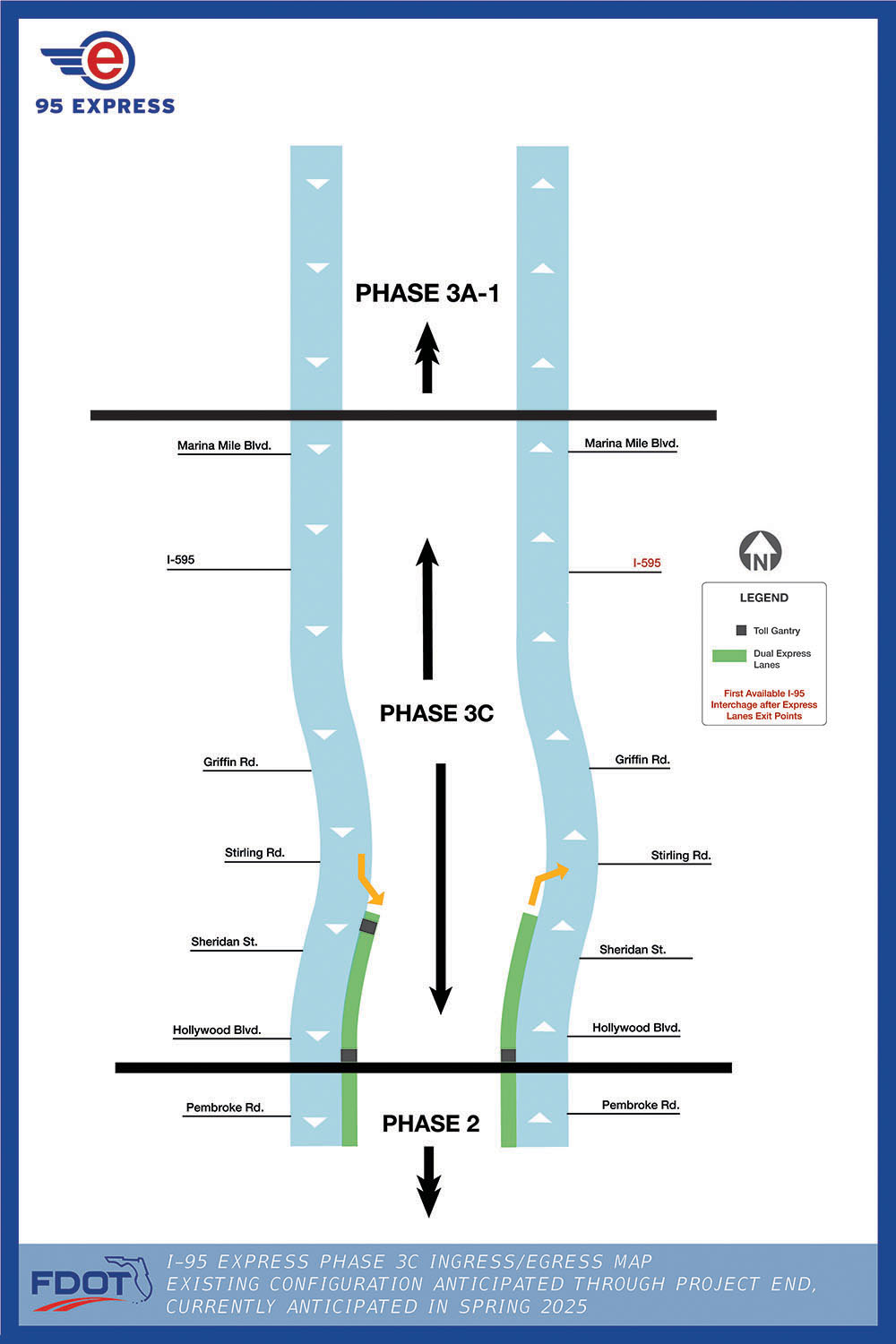

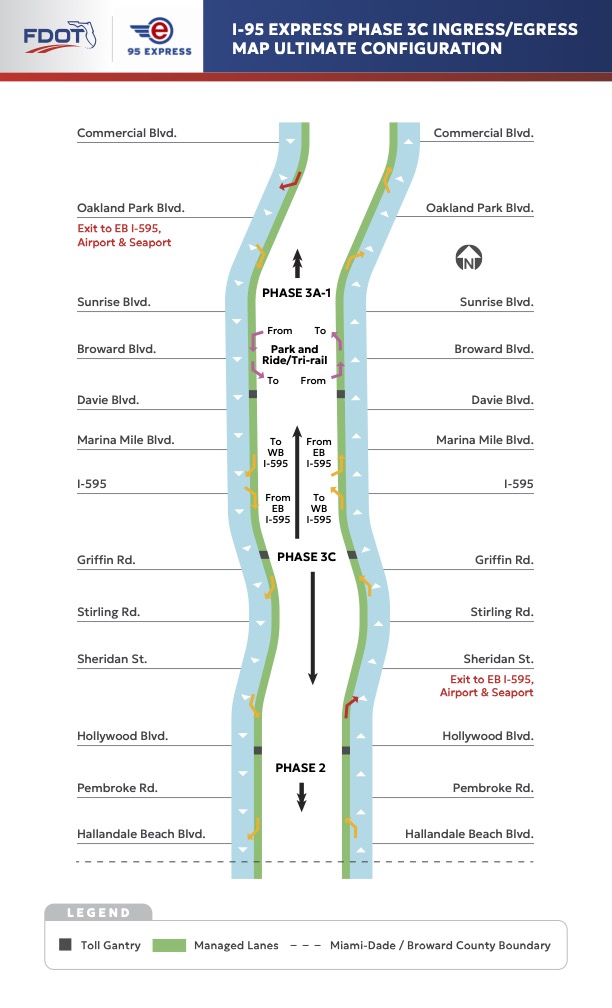

95 Express Phase 3C, I-95 from south of Hollywood Boulevard to south of Broward Boulevard

Financial Number: 409354-2-52-01 & 432222-1-52-01

Project Length: 9 miles

Project Limits: I-95 from south of Hollywood Boulevard to south of Broward Boulevard & I-595 from west of SR-7 to I-95

Start Date: Late 2025

Completion Date: Spring 2025

Contractor: Archer Western Construction, LLC & The deMoya Group, Inc.

Estimated Construction Cost: $457 million

Scope of Work:

Reconstruction, milling, resurfacing, overbuild, widening, and/or restriping of I-95 from south of Hollywood Boulevard to south of Broward Boulevard to accommodate the following:

  • One additional Express Lane in each direction (2 lanes total in each direction), between south of Stirling Road and Broward Boulevard.

  • A southbound Express Lanes entrance and a northbound Express Lanes exit location, serving Sheridan Street and interchanges to the north for traffic to and from the south.

  • A northbound Express Lanes entrance and a southbound Express Lanes exit location, serving Sheridan Street and interchanges to the south for traffic to and from the north.

  • Construction of dual exits for the northbound and southbound exit ramps to Sheridan Street.

  • Dual right turn lane improvements at the ramp terminal for the I-95 northbound exit ramp movement to eastbound Griffin Road.

I-95/I-595 Direct Connectors between northbound and southbound 95 Express Lanes and I-595, to and from the west.

I-95/SR 84 Interchange modifications, including replacement of the westbound SR 84 bridge over I-95, to accommodate one additional Express Lane in each direction along I-95 and Direct Connectors to and from I-595.

Reconstruction, milling, resurfacing, overbuild, widening, and/or restriping of I-595 from SR-7 to I-95, including the I-595 bridges of Pond Apple Slough, to accommodate the following:
  • Additional auxiliary lanes along I-595 and to/from the Direct Connectors.

  • A new westbound I-595 exit ramp to Turnpike.

  • A new eastbound I-595 entrance ramp from Turnpike.

  • A new eastbound I-595 exit ramp to eastbound SR-84.

Other work includes bridge widening, bridge painting, ITS, Tolling/gantry, signage, ramp signalization, lighting, drainage, shoulder mounted sound walls, and retaining walls.

Documents:

PDF Icon95 E Phase 3C_I-95 SB Stirling to Sheridan to Close Dec 9 & 10.pdf

PDF Icon95 Express Fact Sheet_Phase3C_Fall2024.pdf

Point of Contact:

Para información y preguntas en Español, por favor llame al (954) 777-4302.

Click here for upcoming lane closures

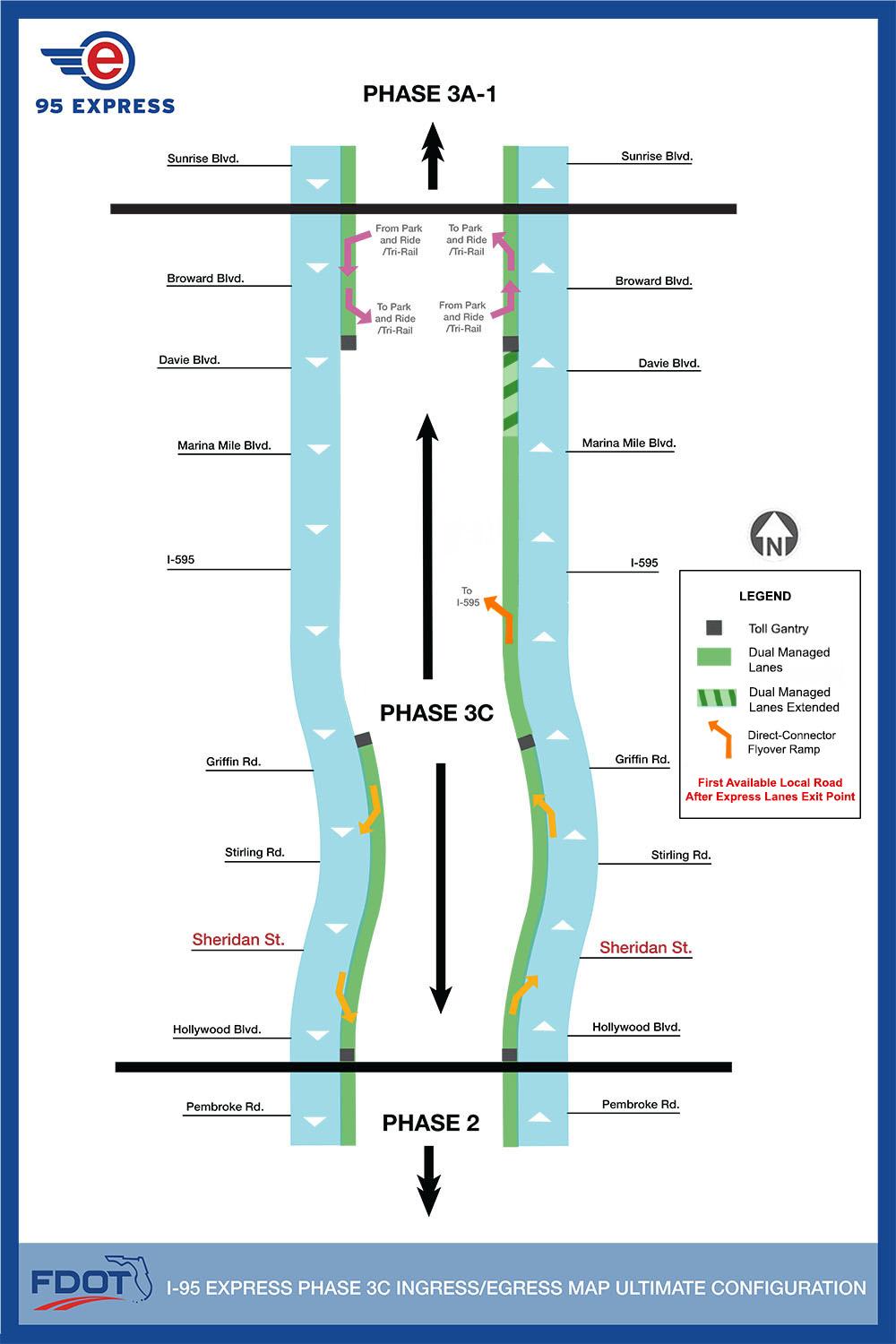

Project Photos

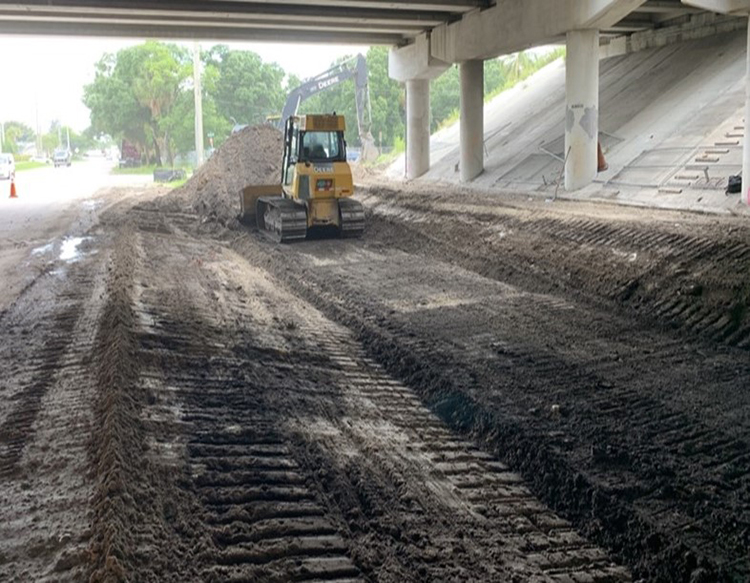

Pre-Construction

During Construction

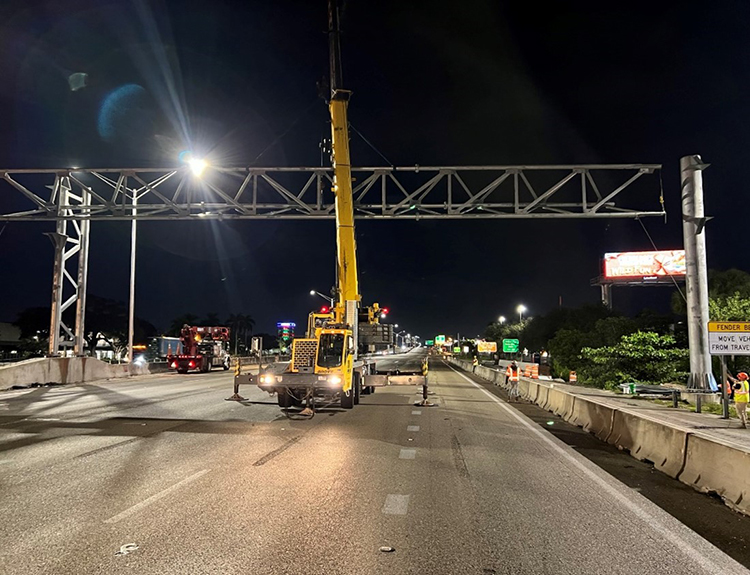

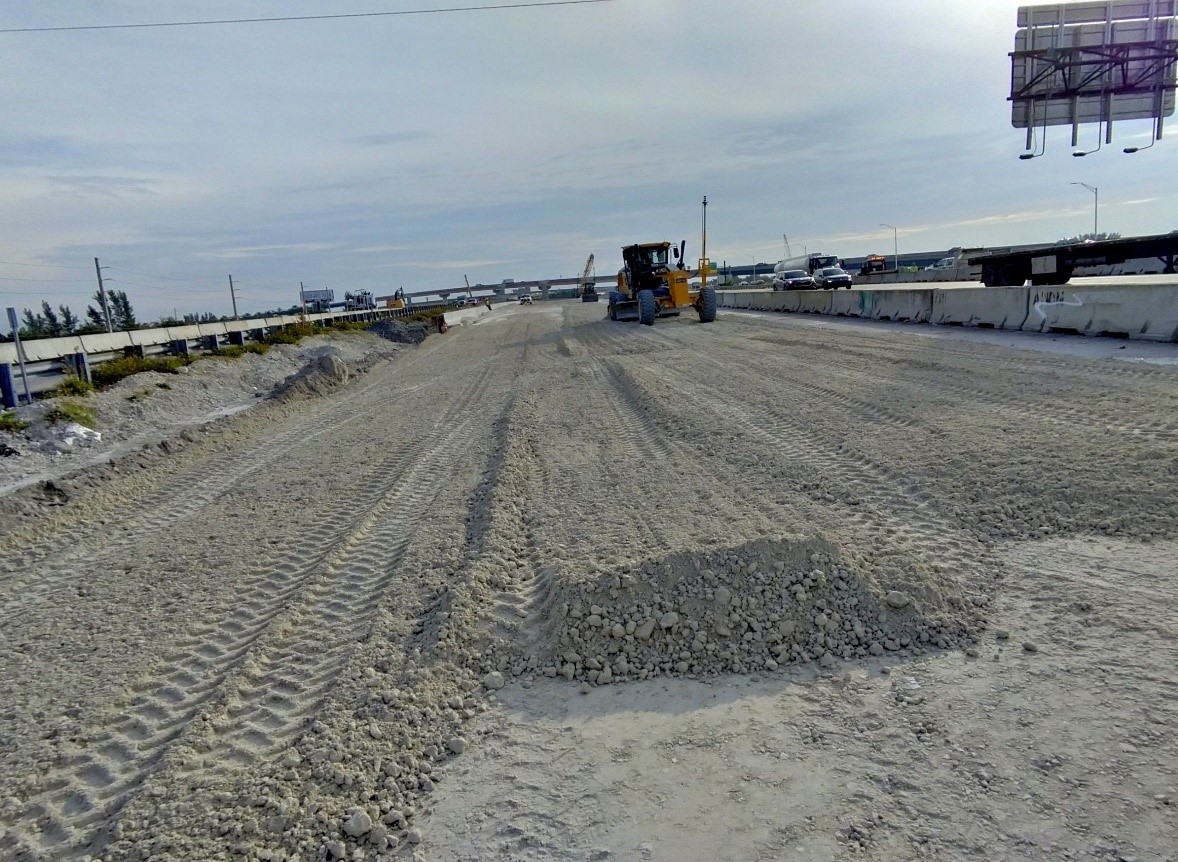

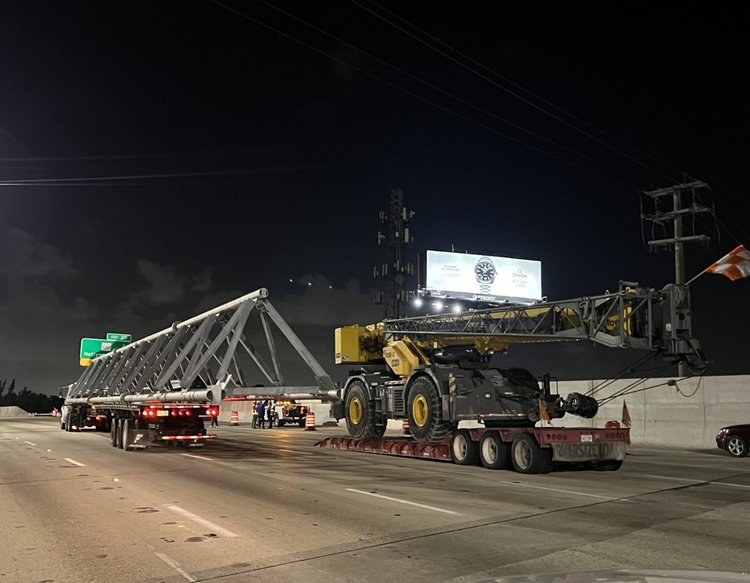

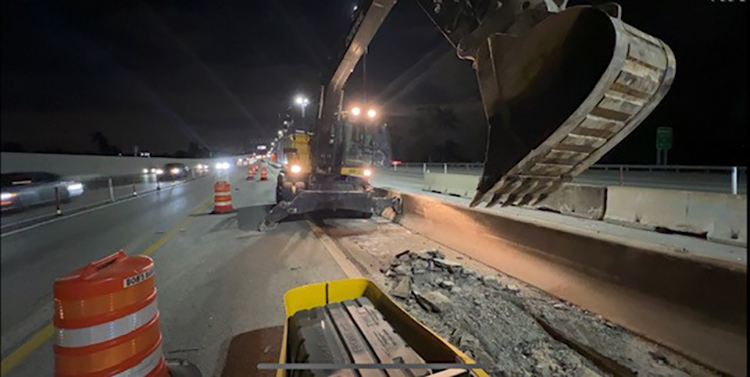

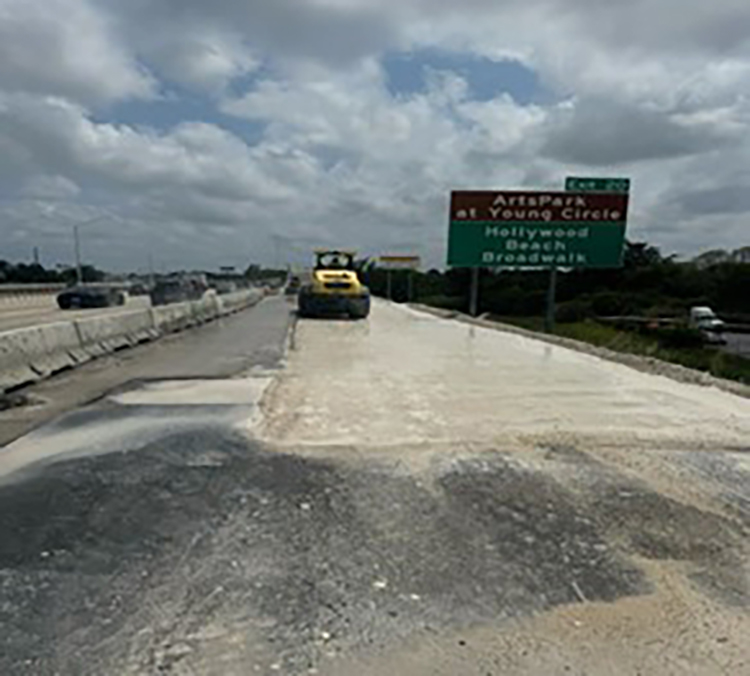

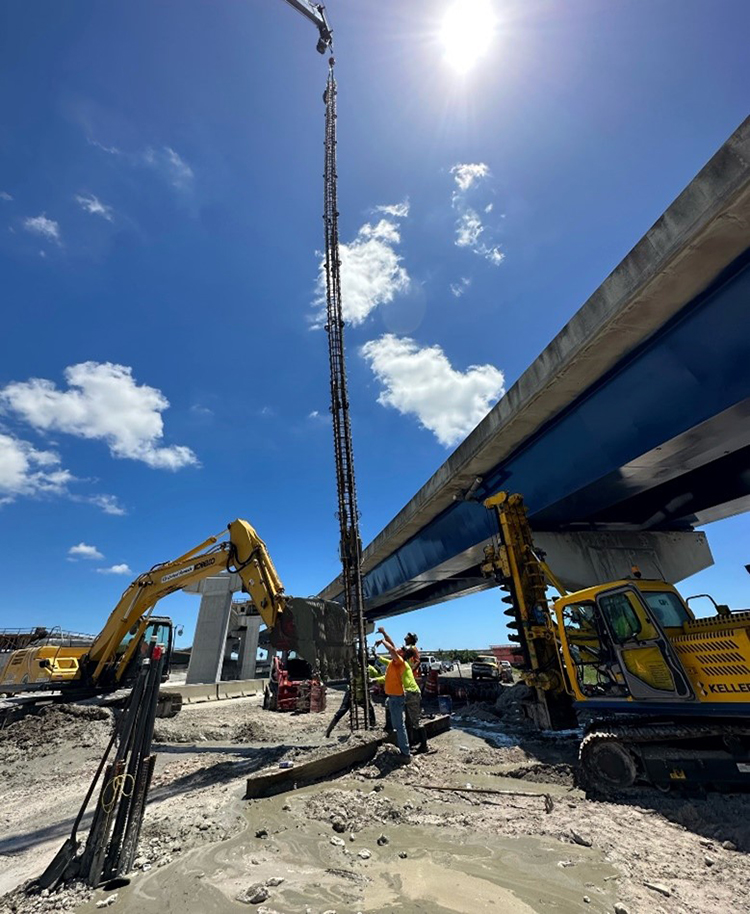

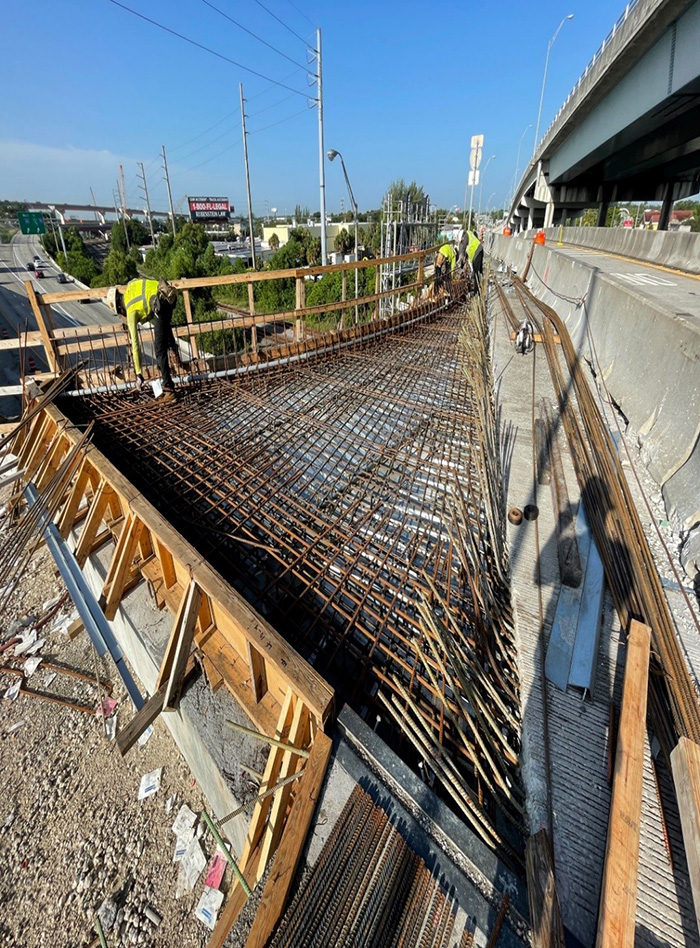

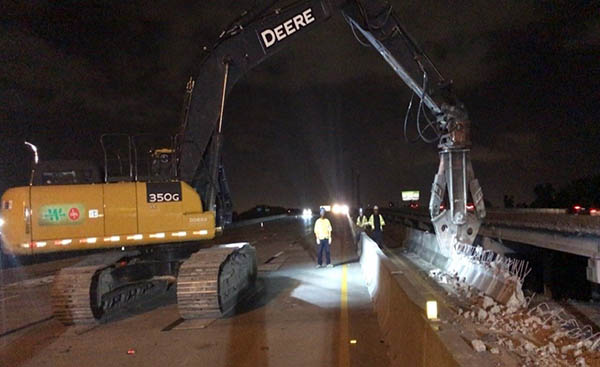

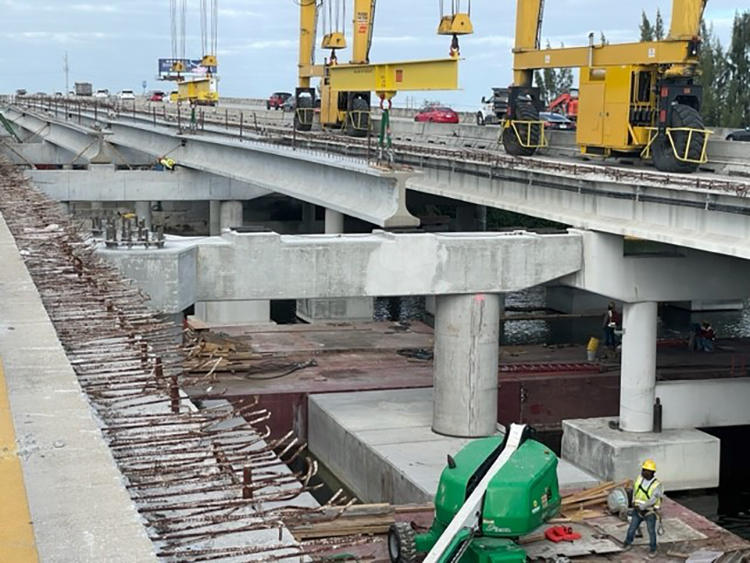

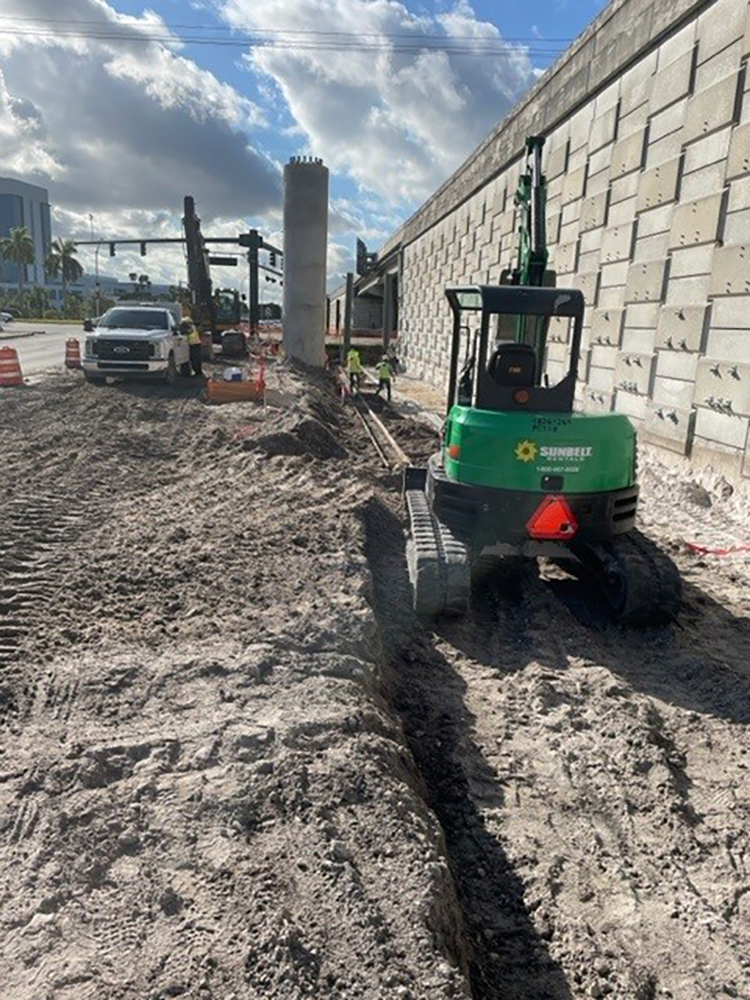

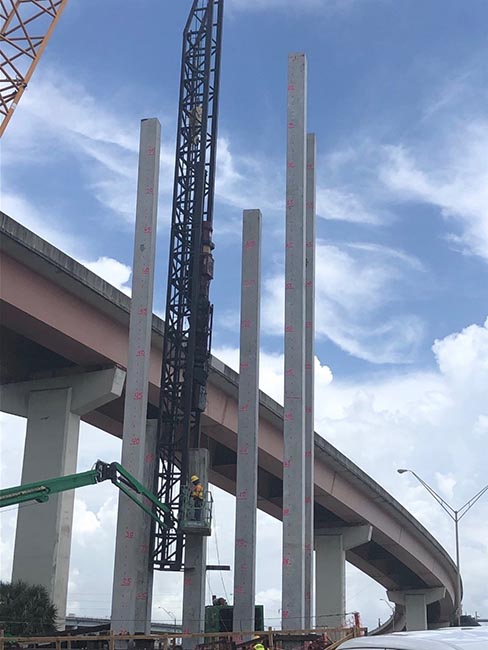

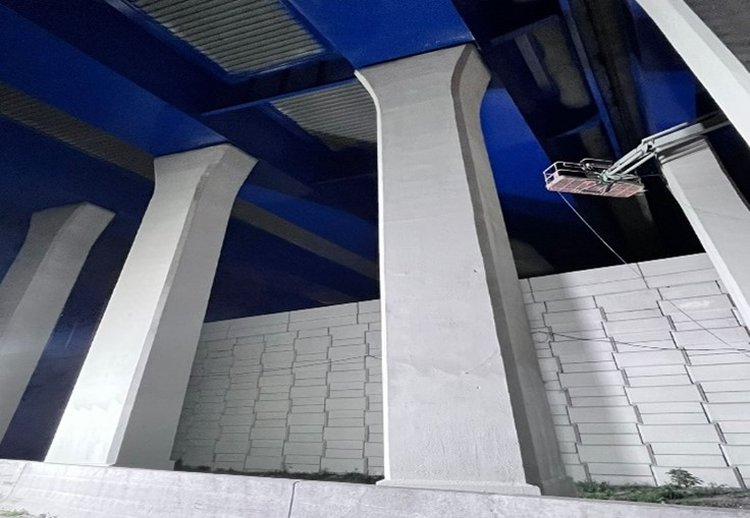

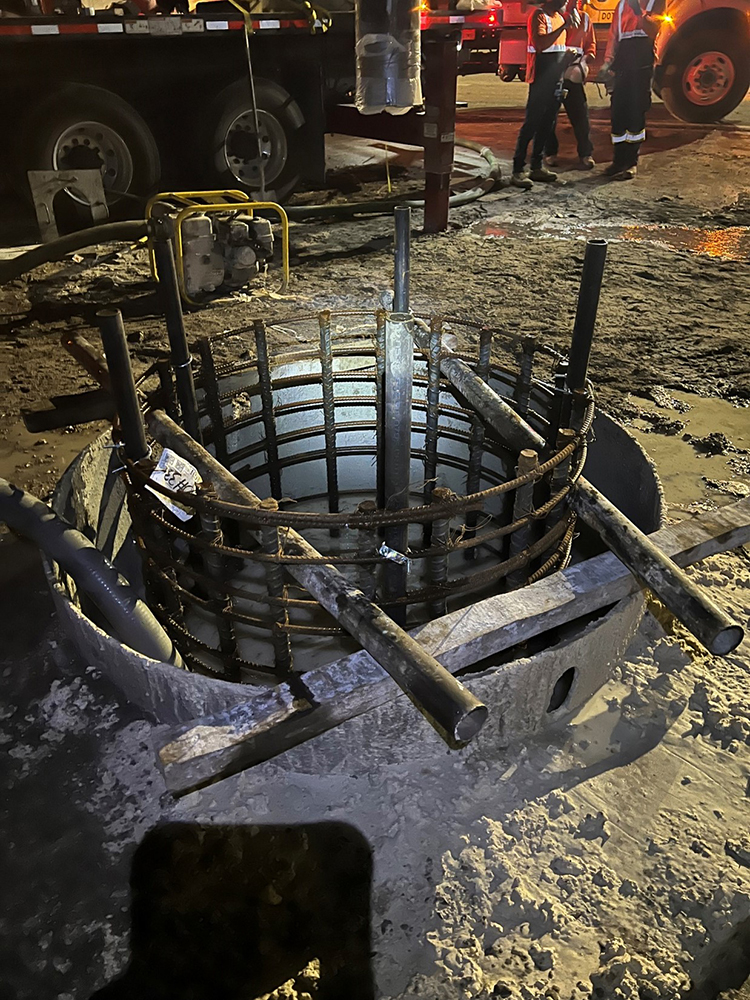

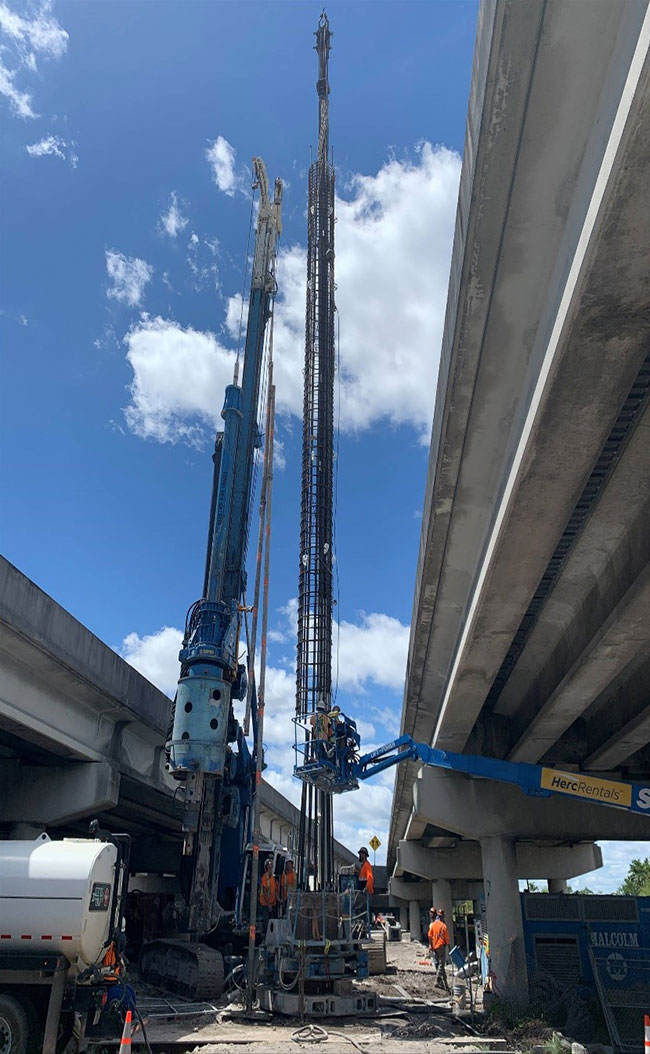

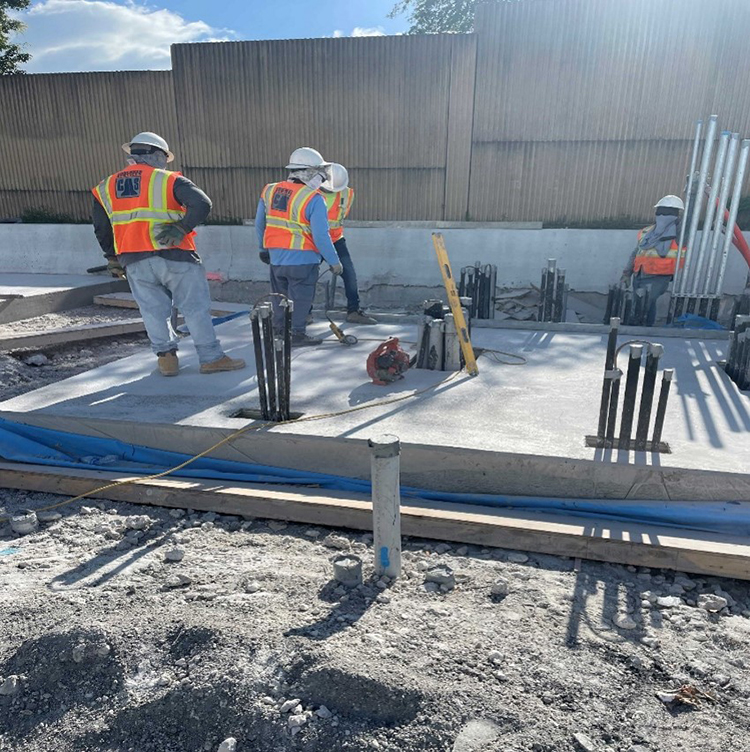

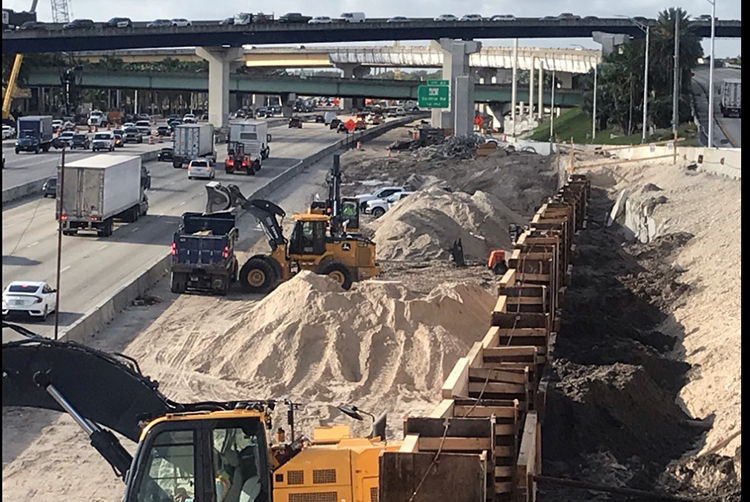

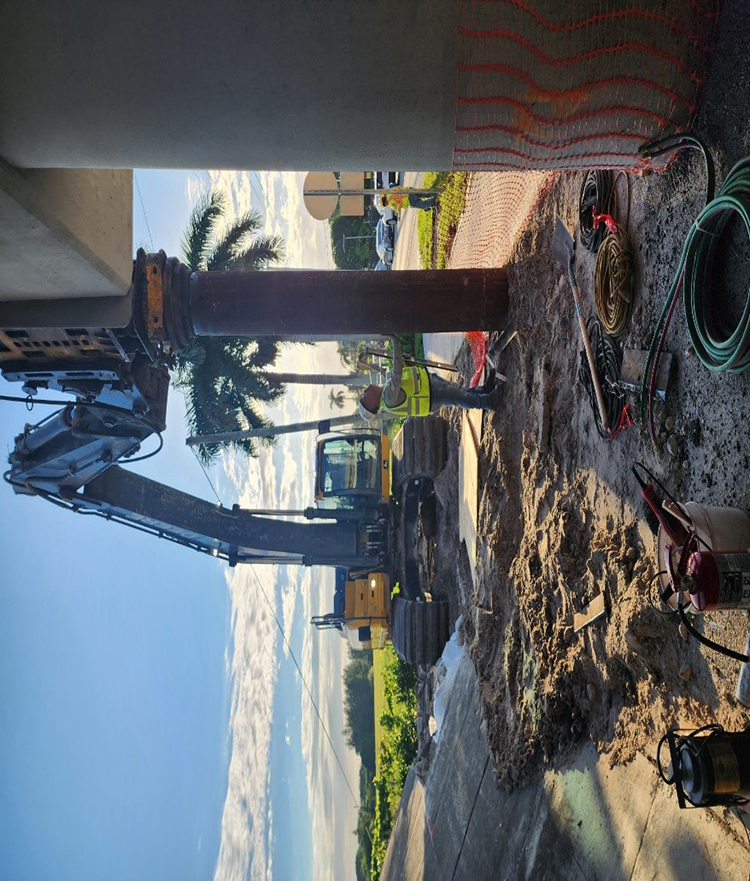

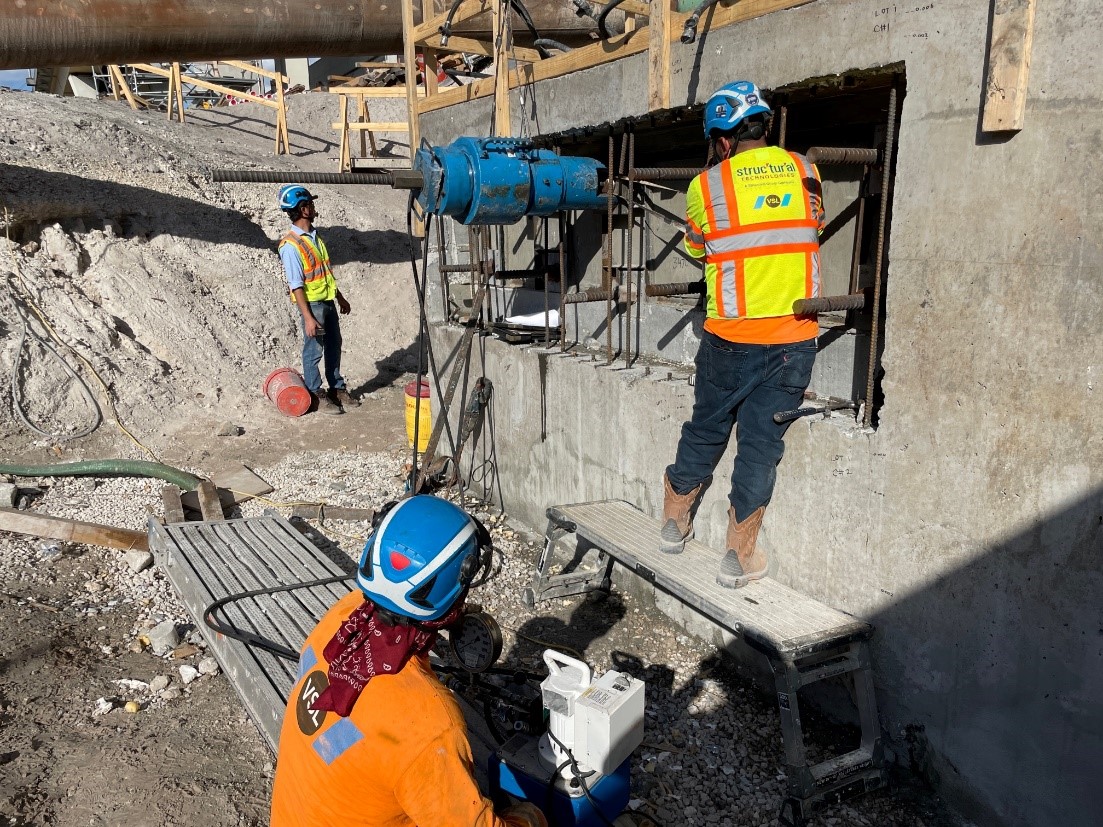

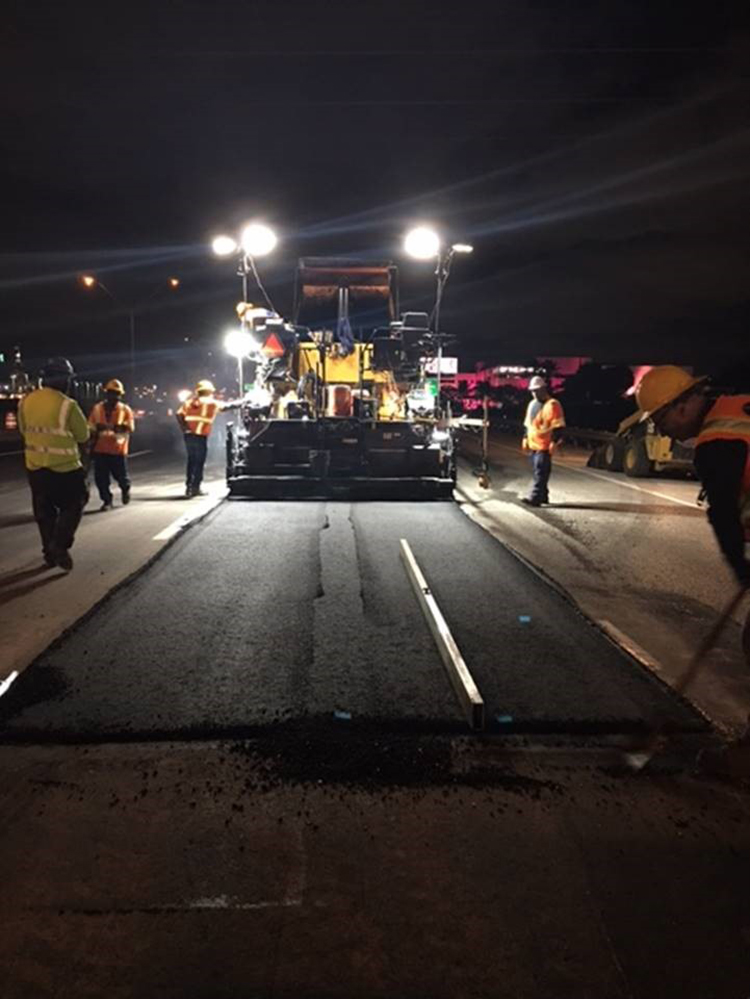

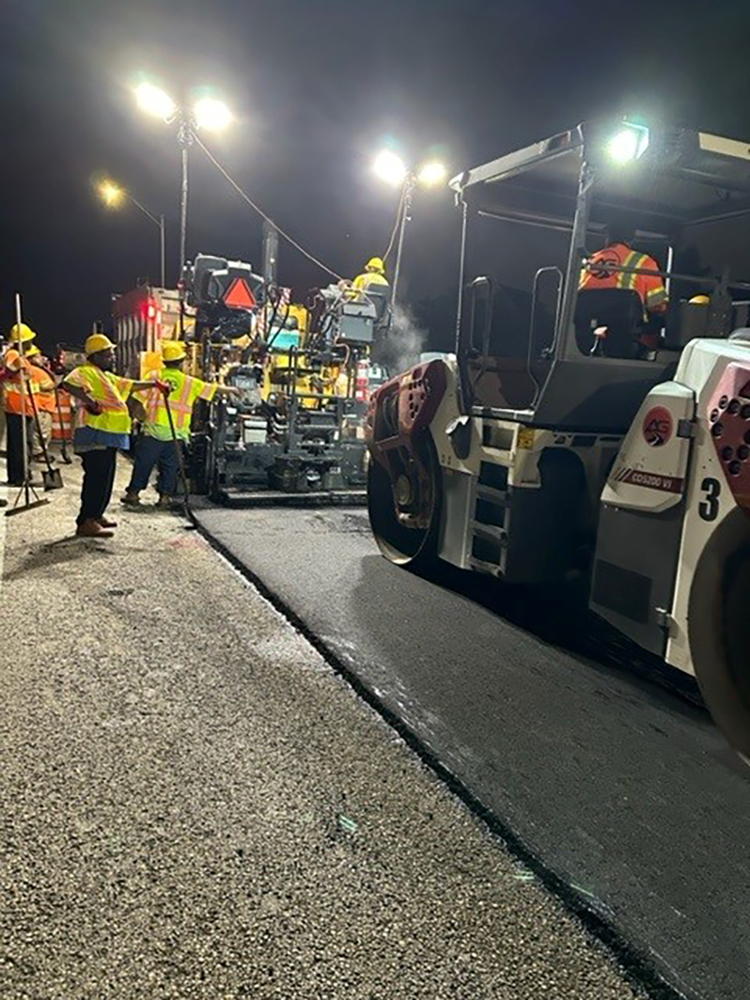

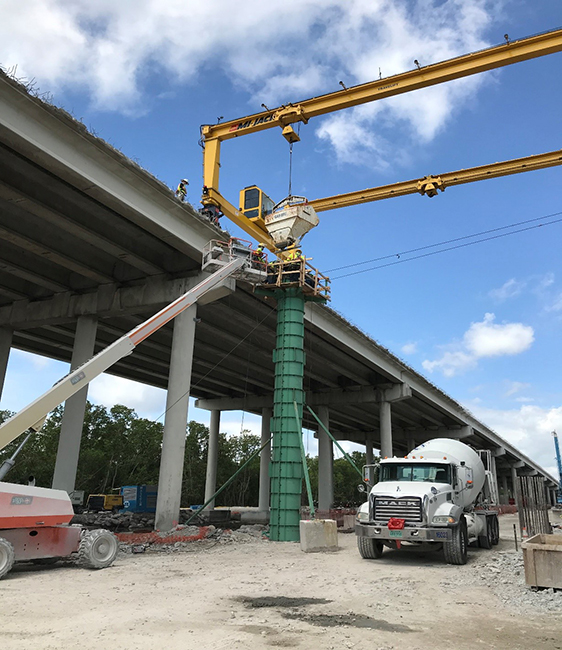

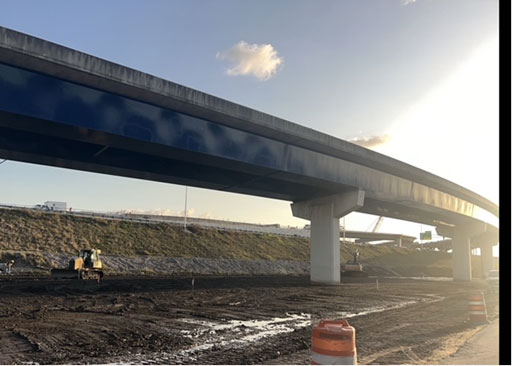

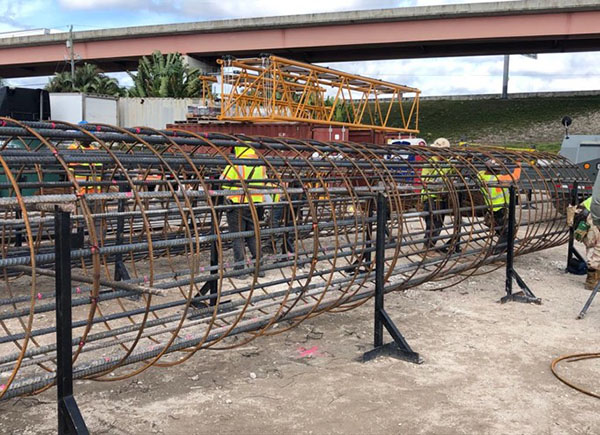

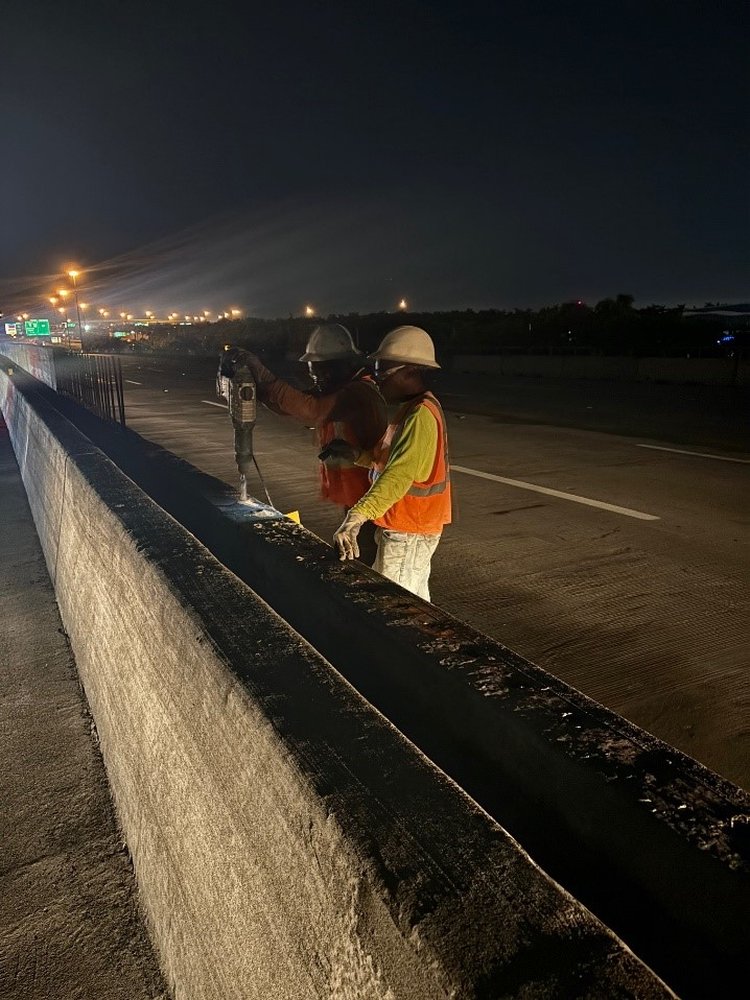

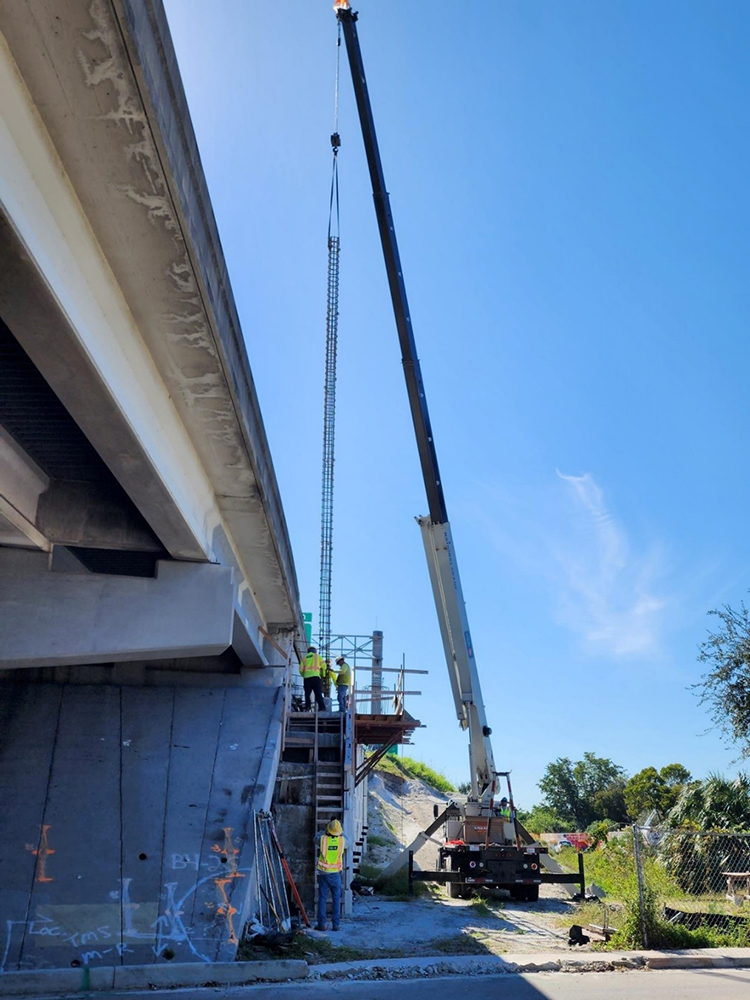

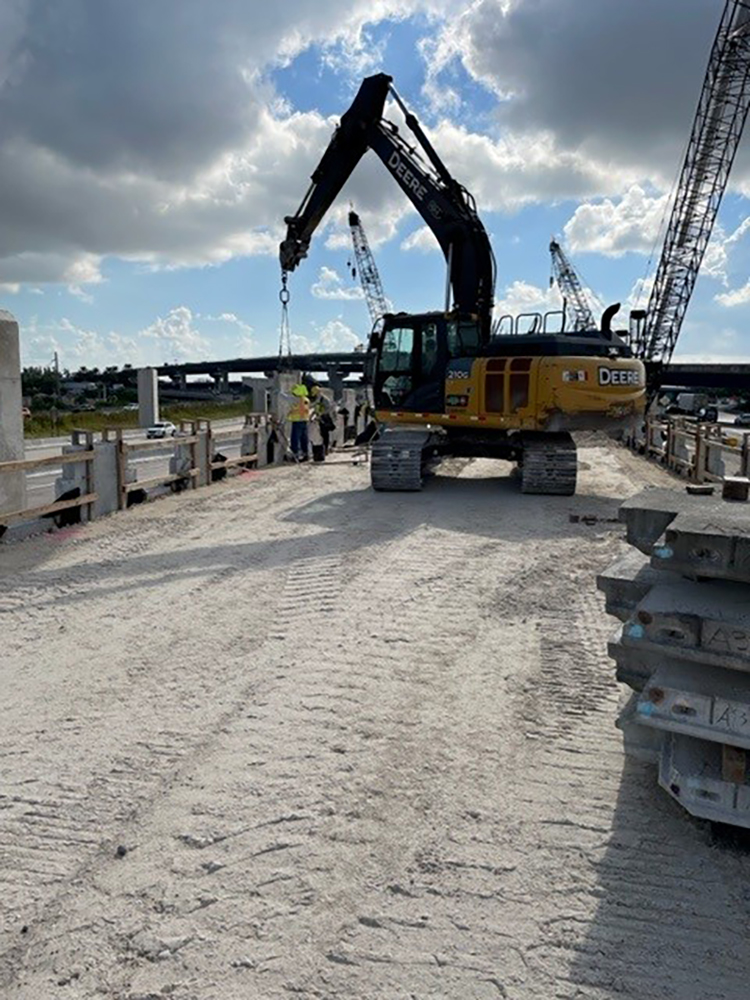

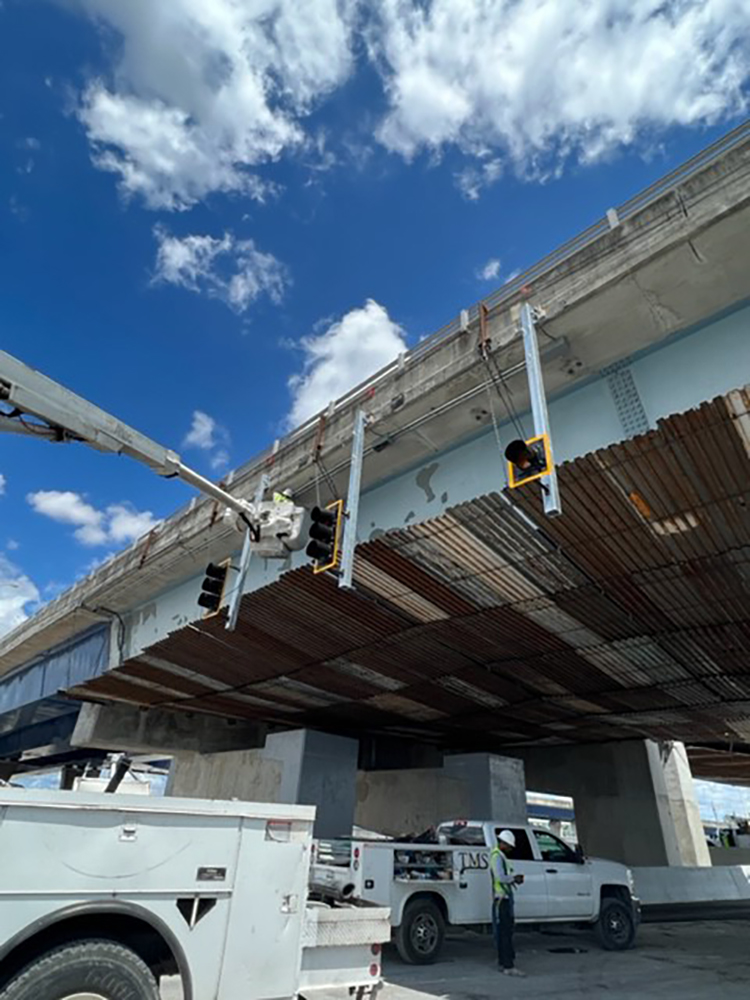

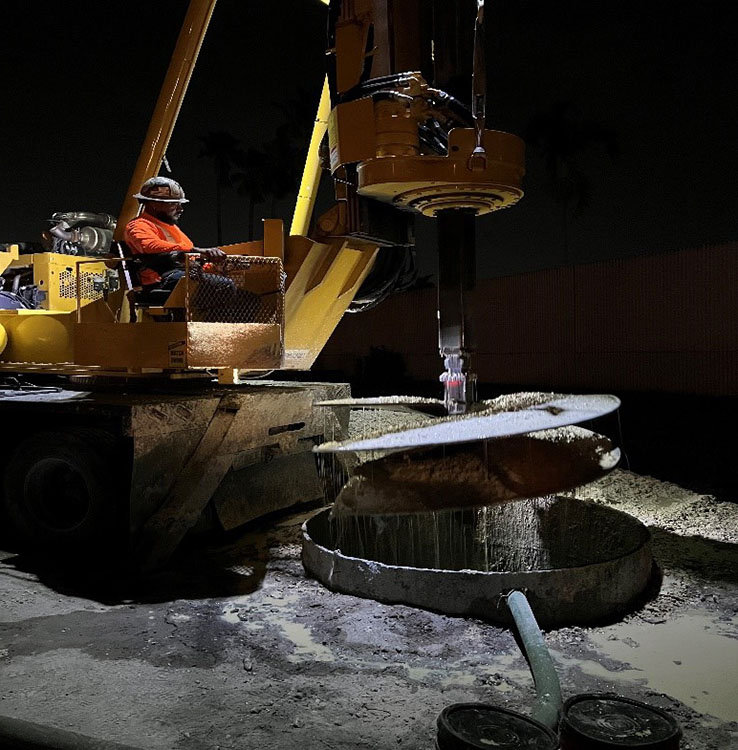

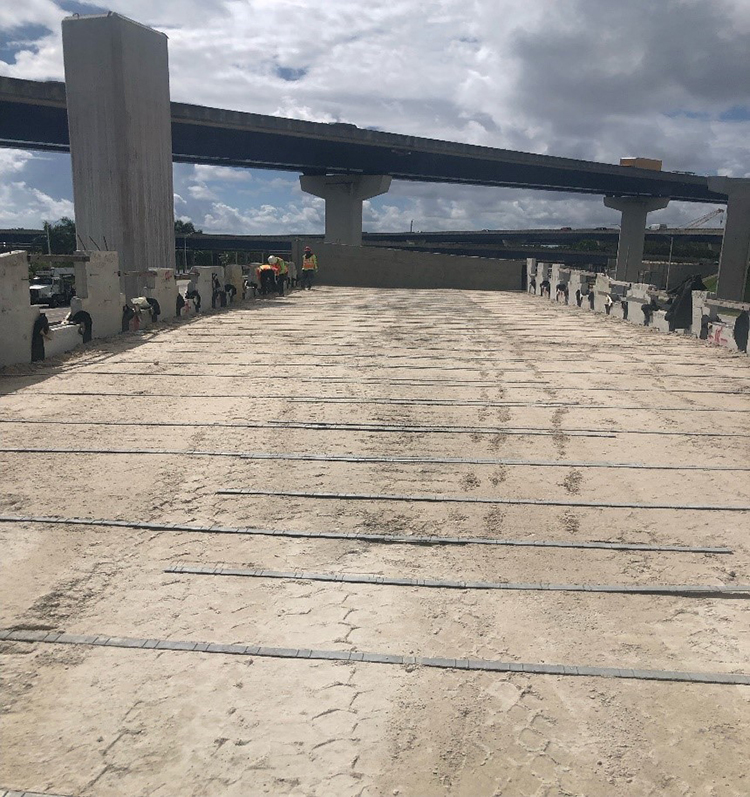

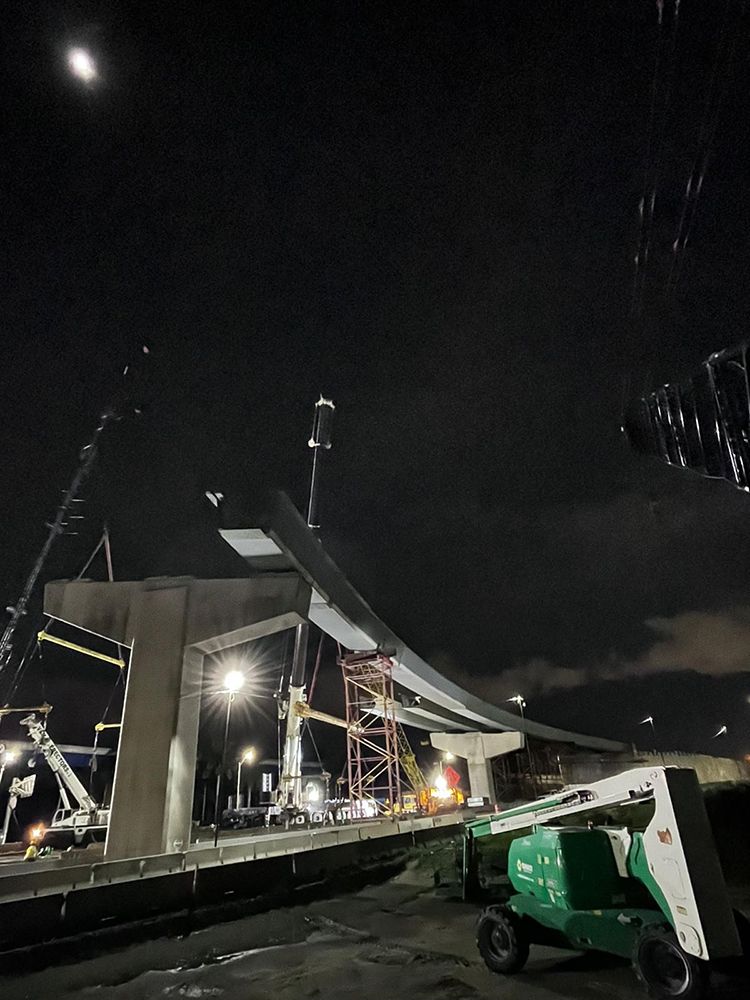

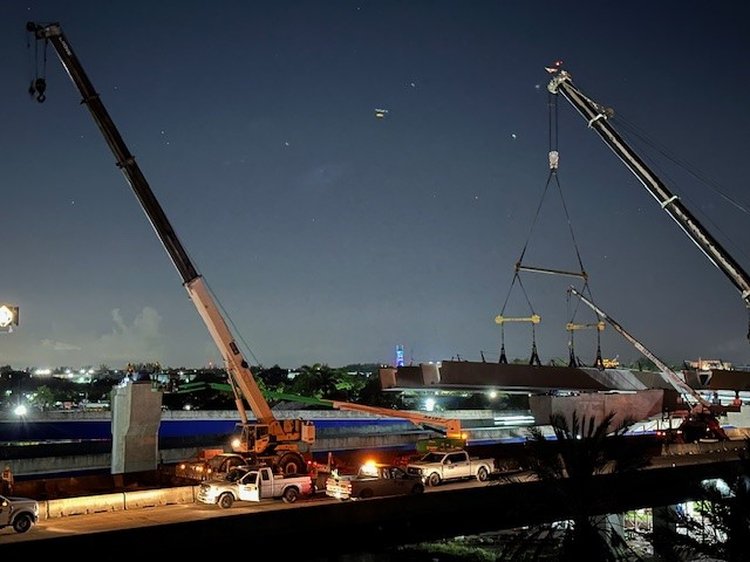

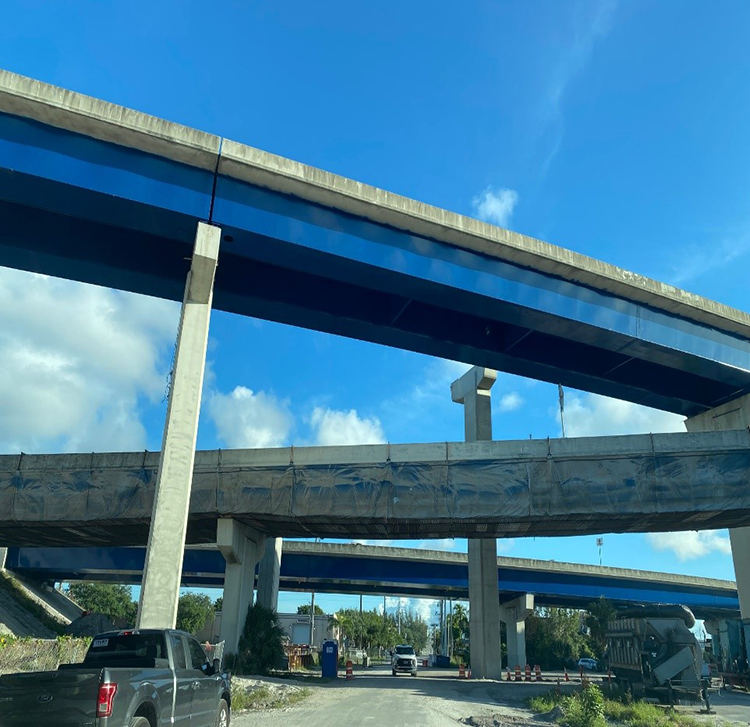

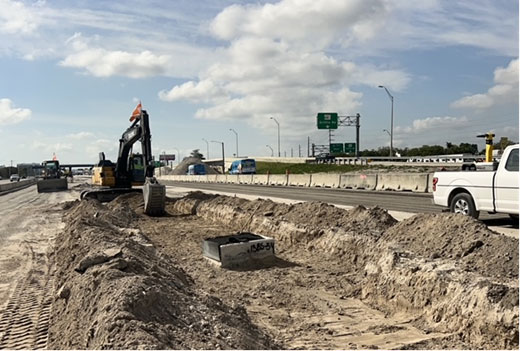

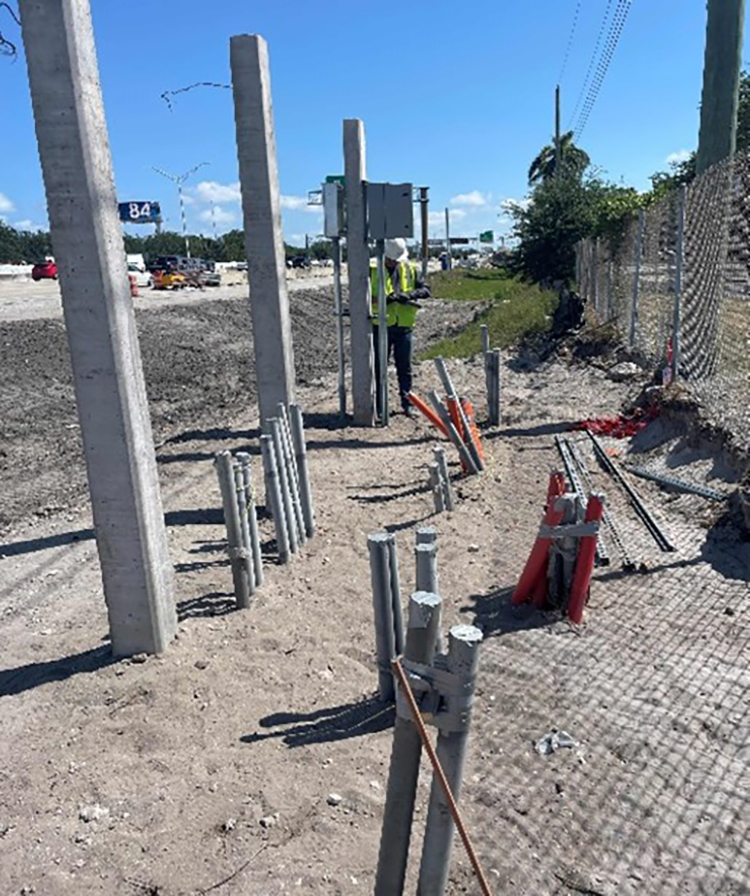

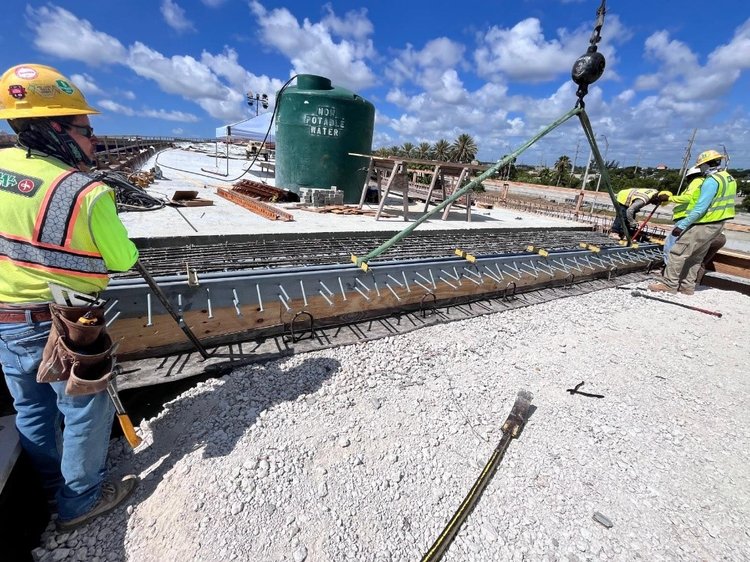

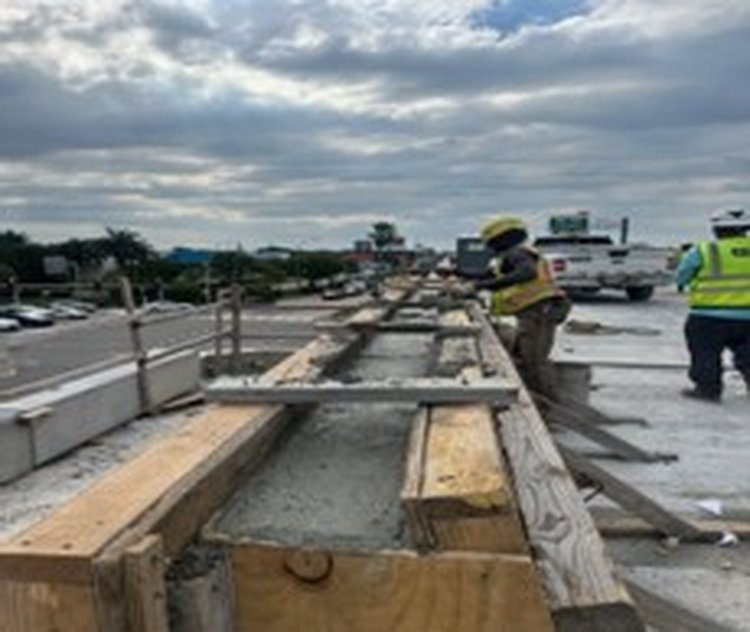

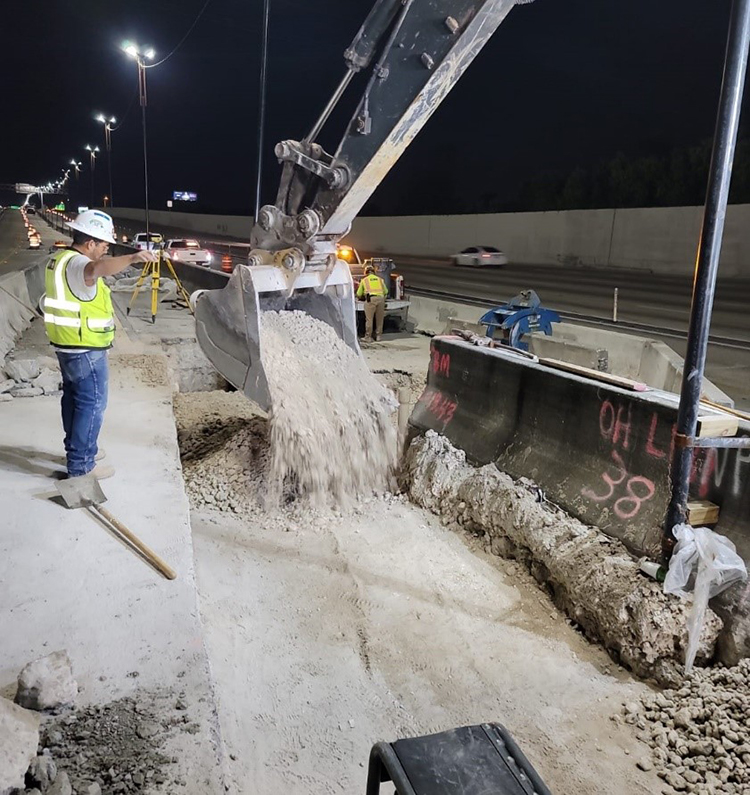

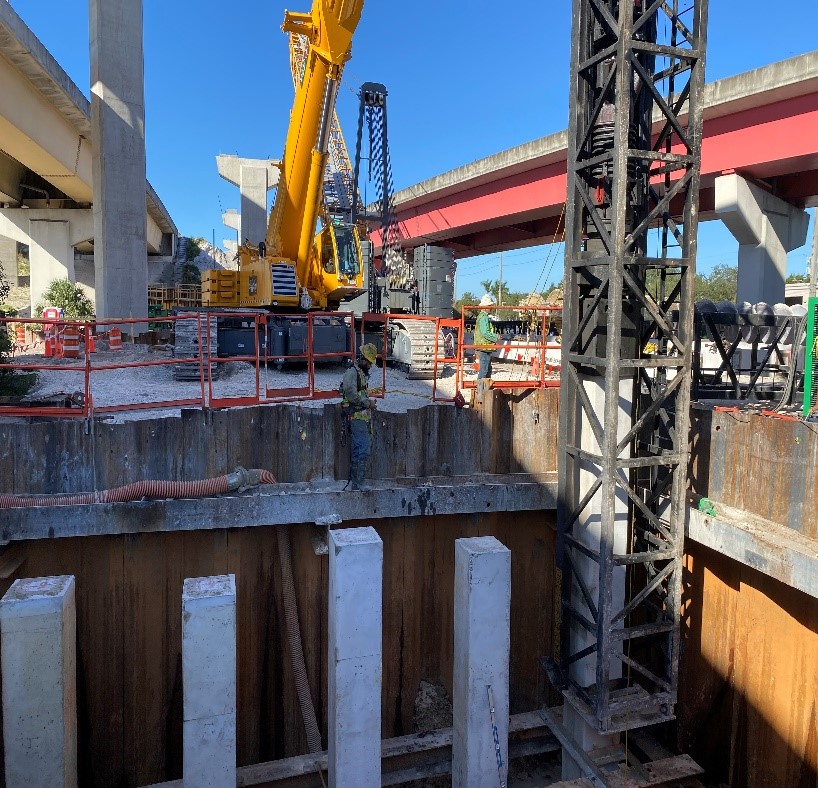

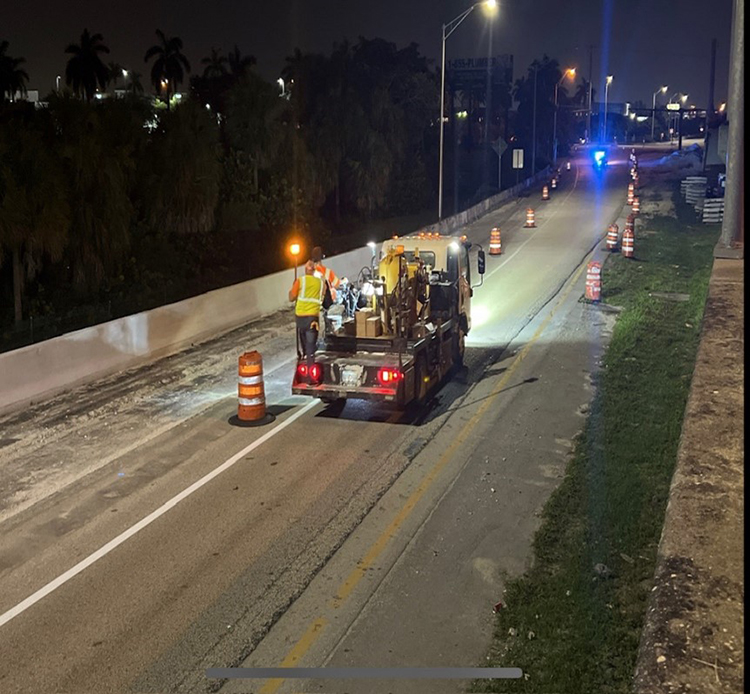

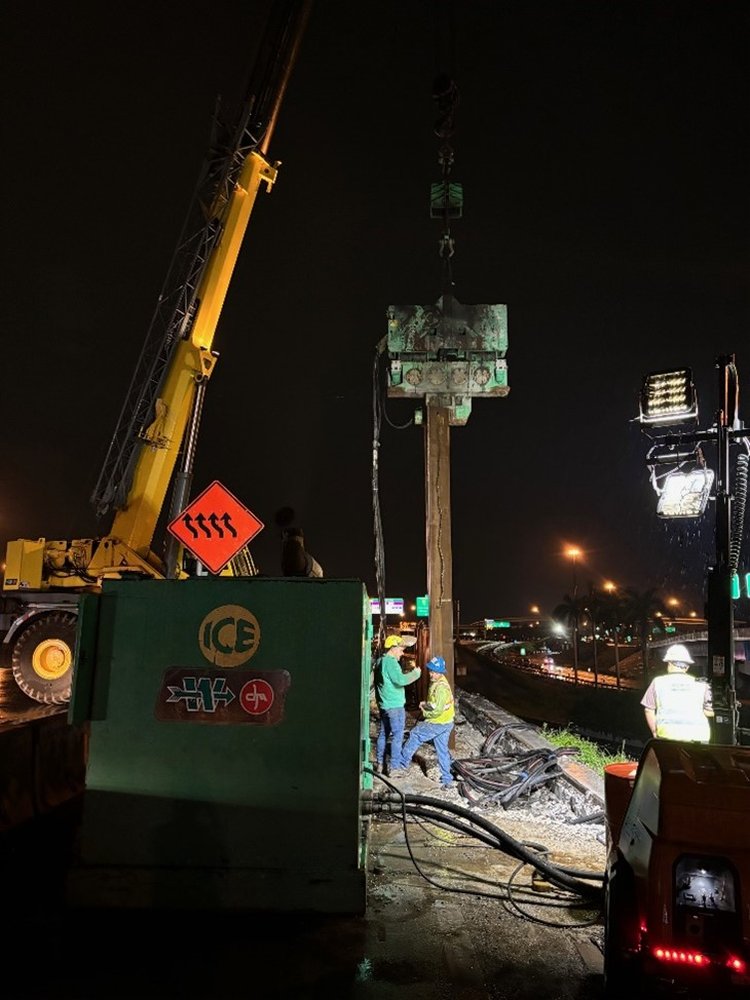

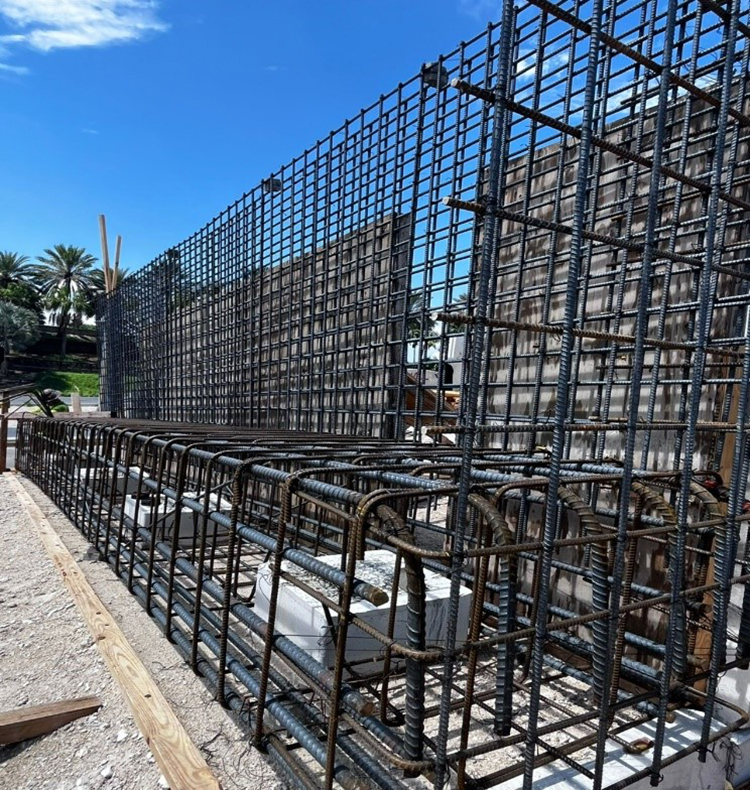

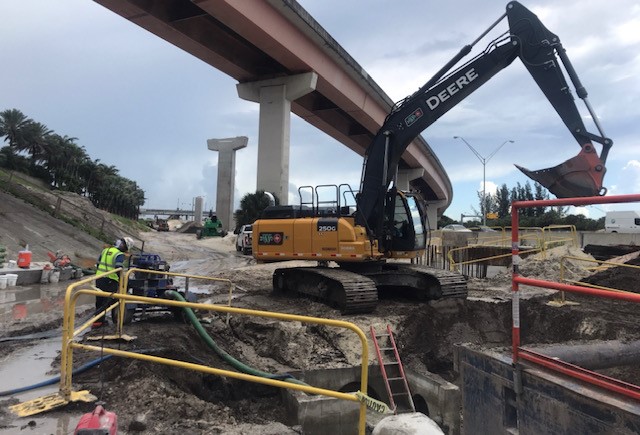

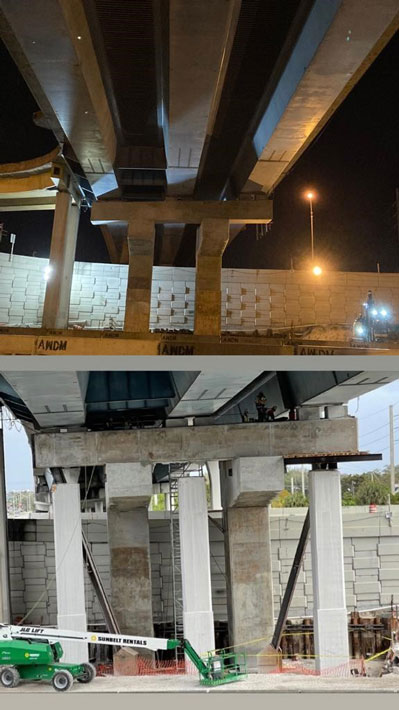

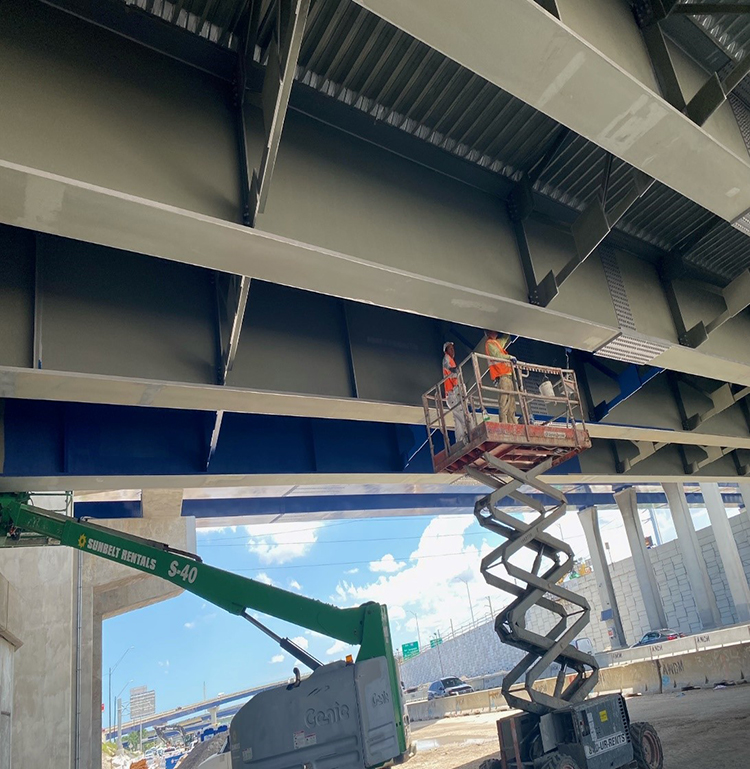

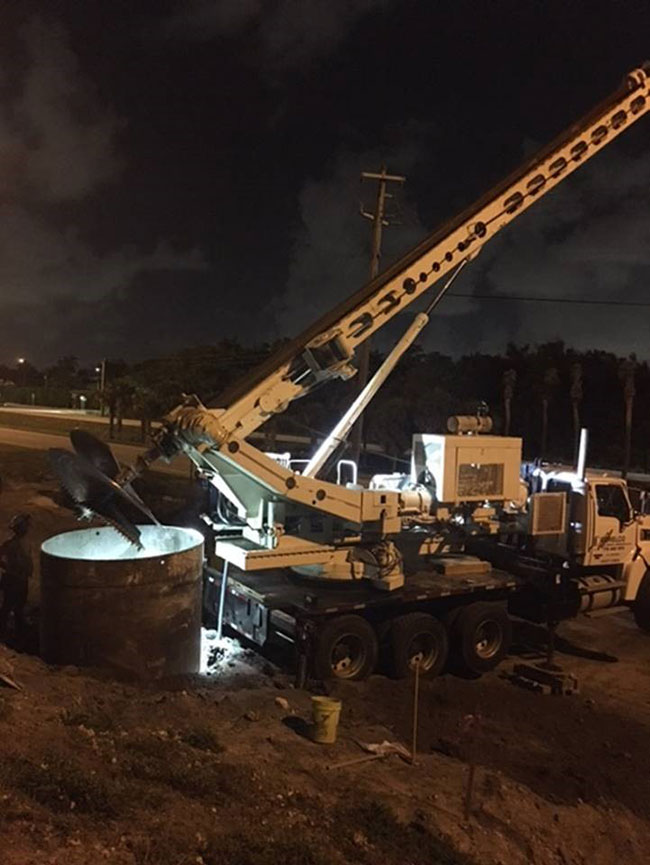

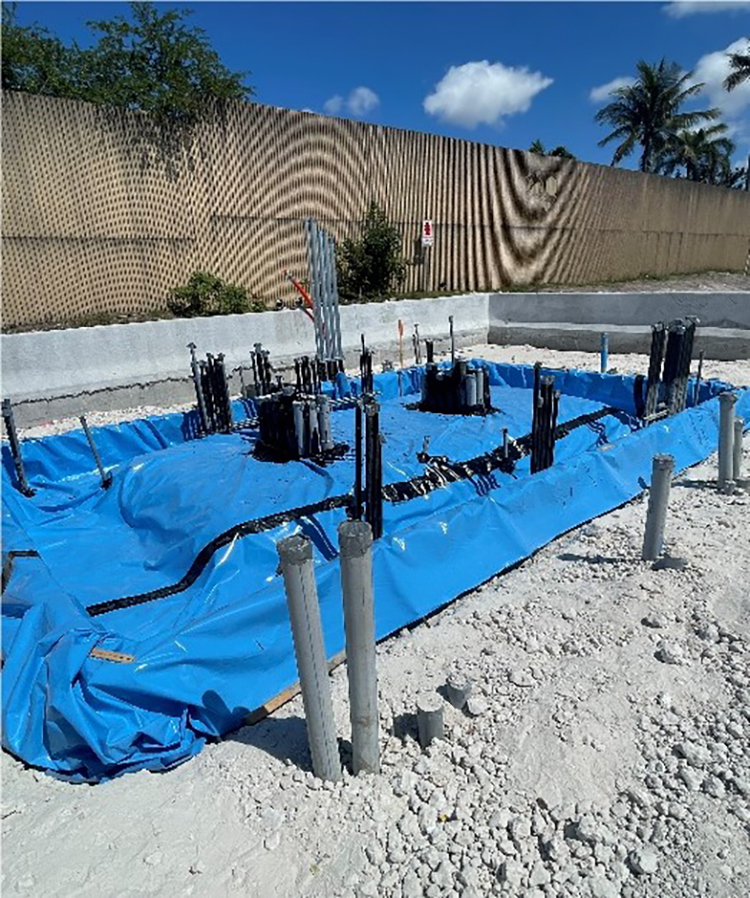

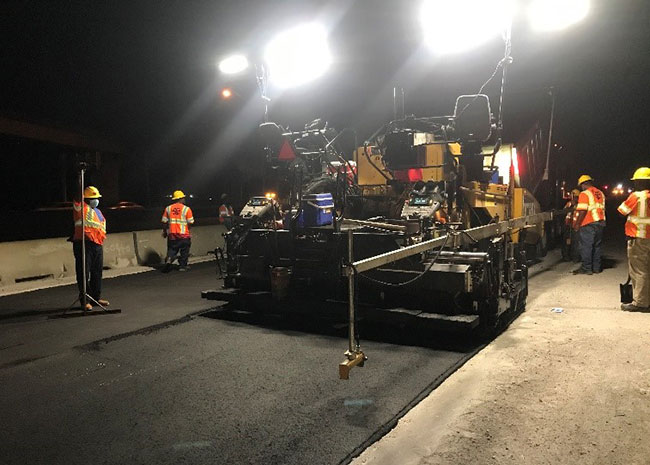

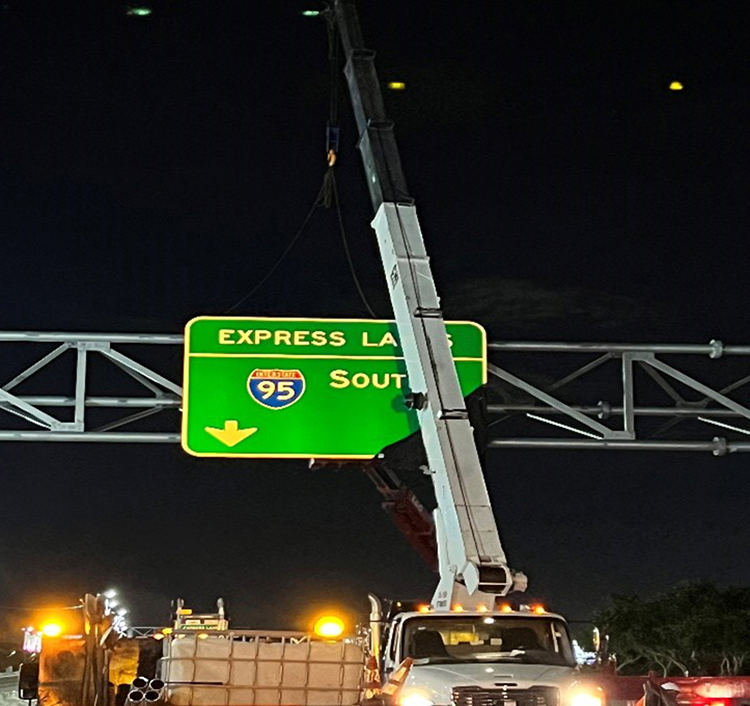

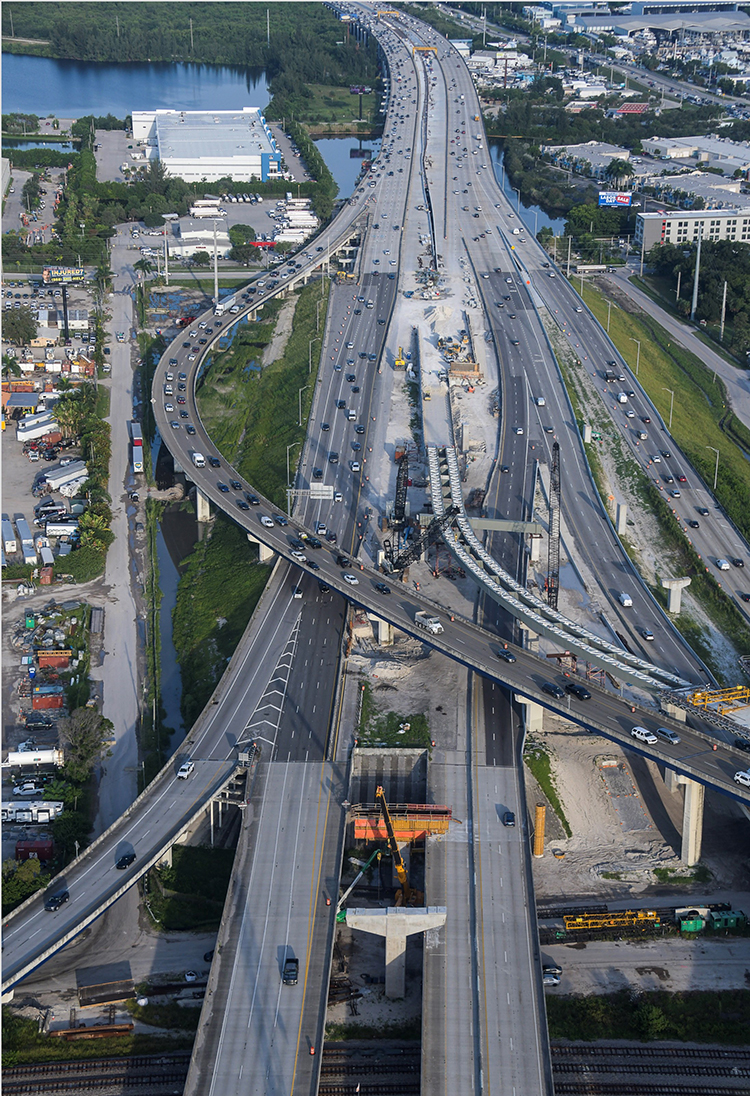

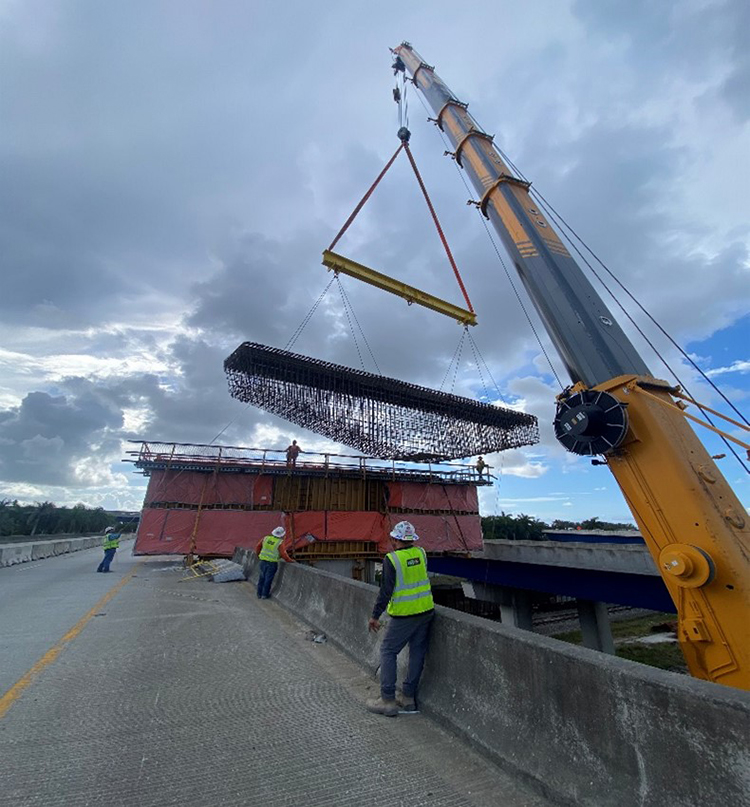

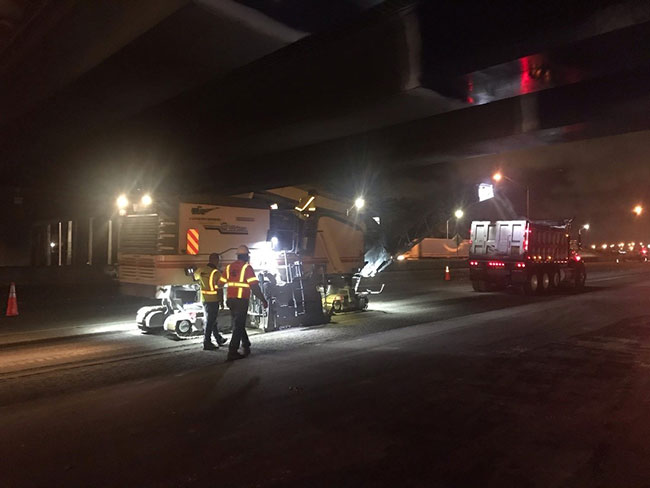

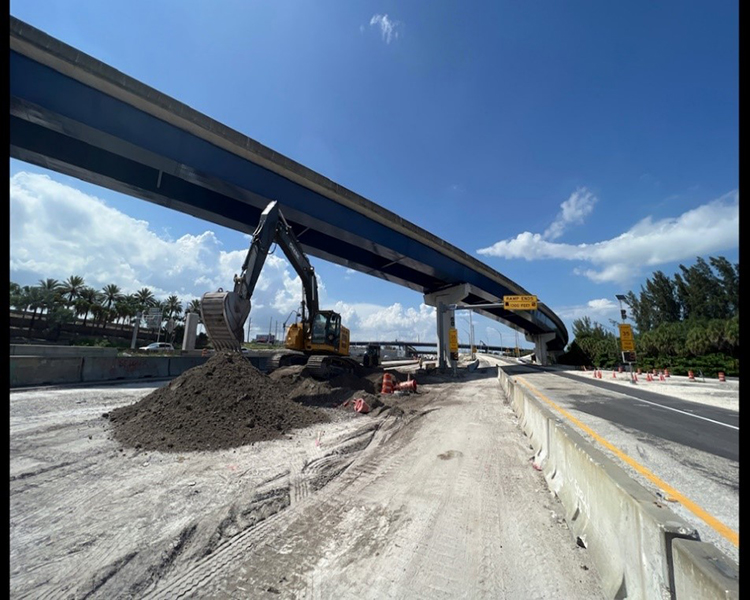

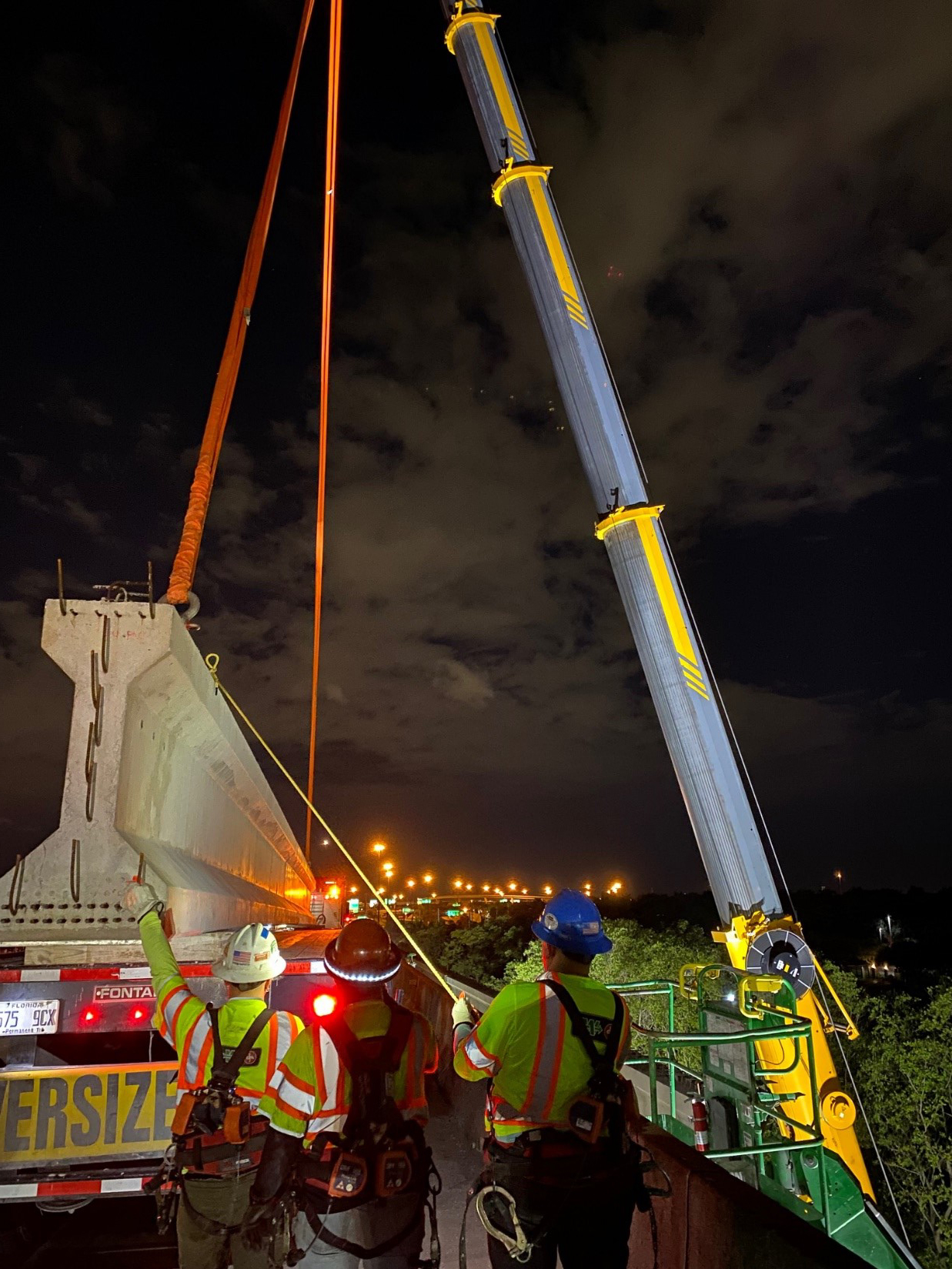

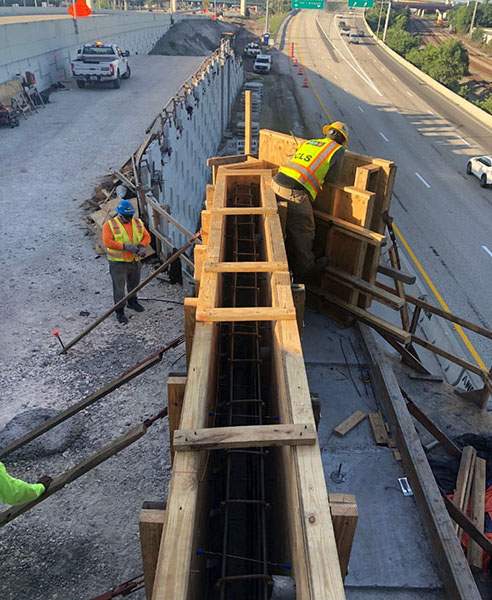

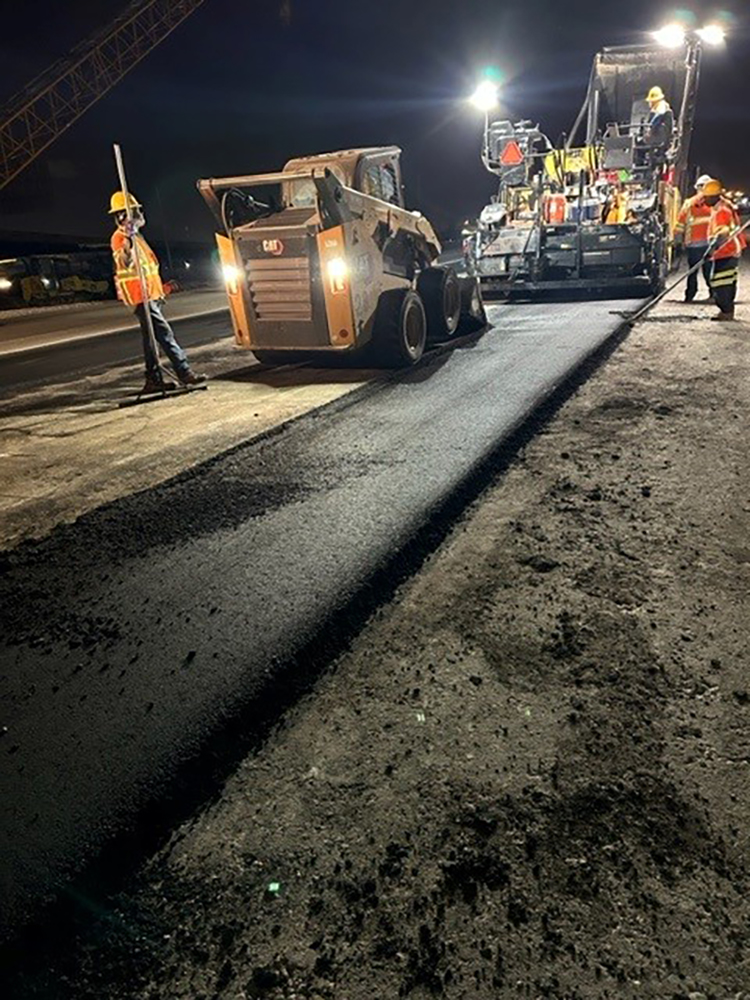

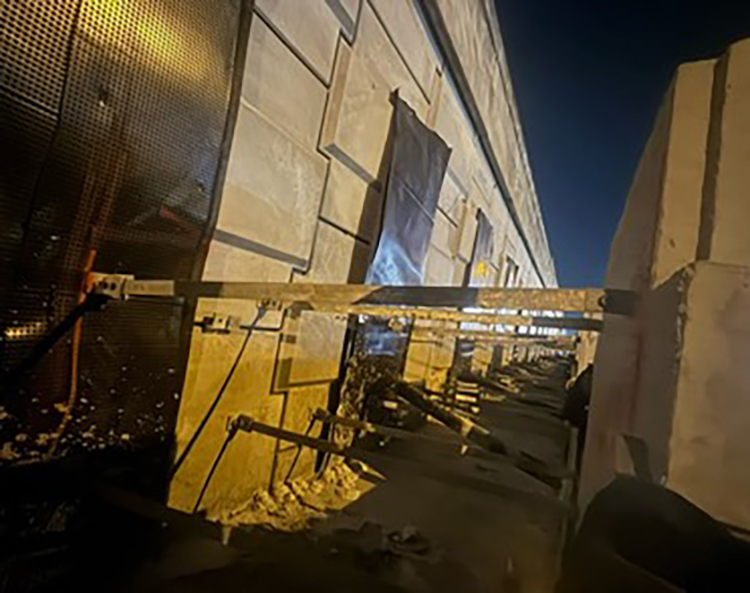

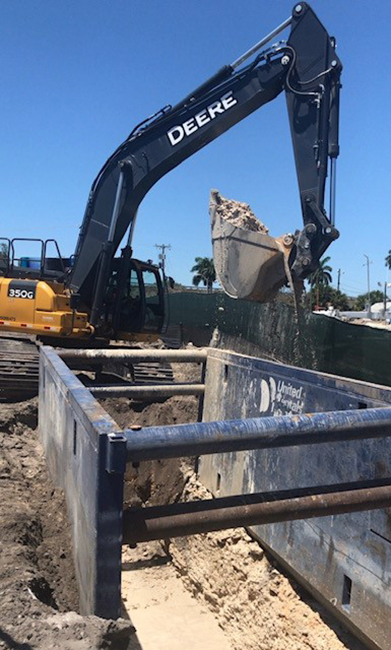

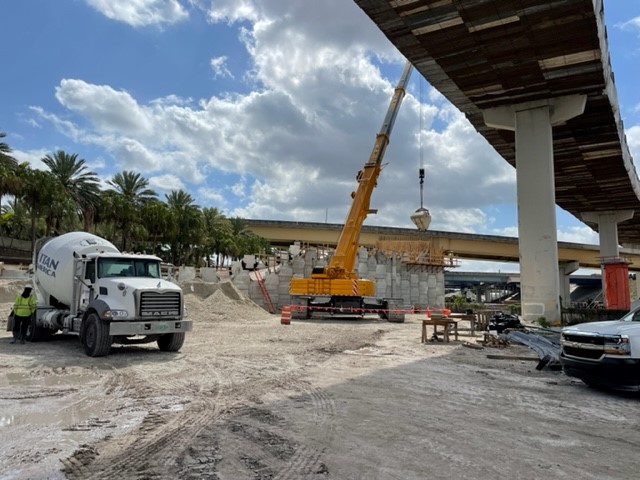

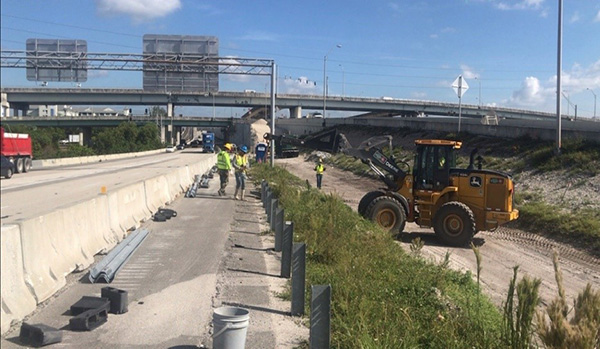

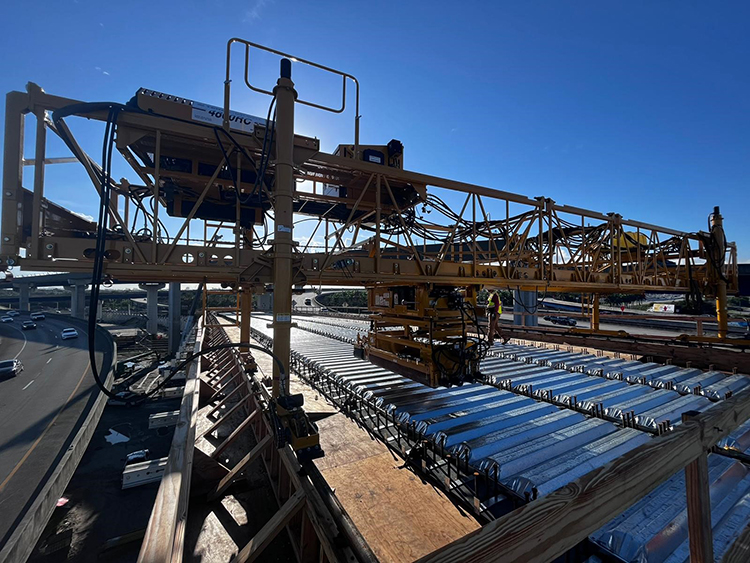

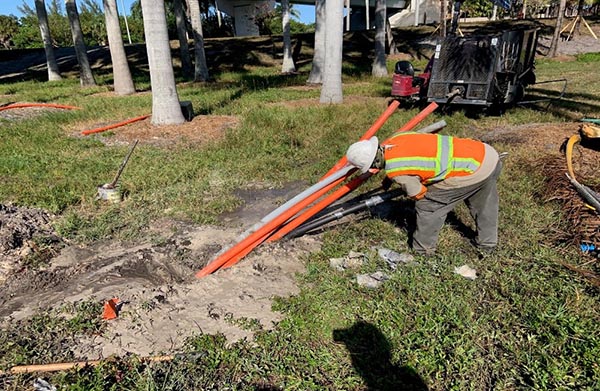

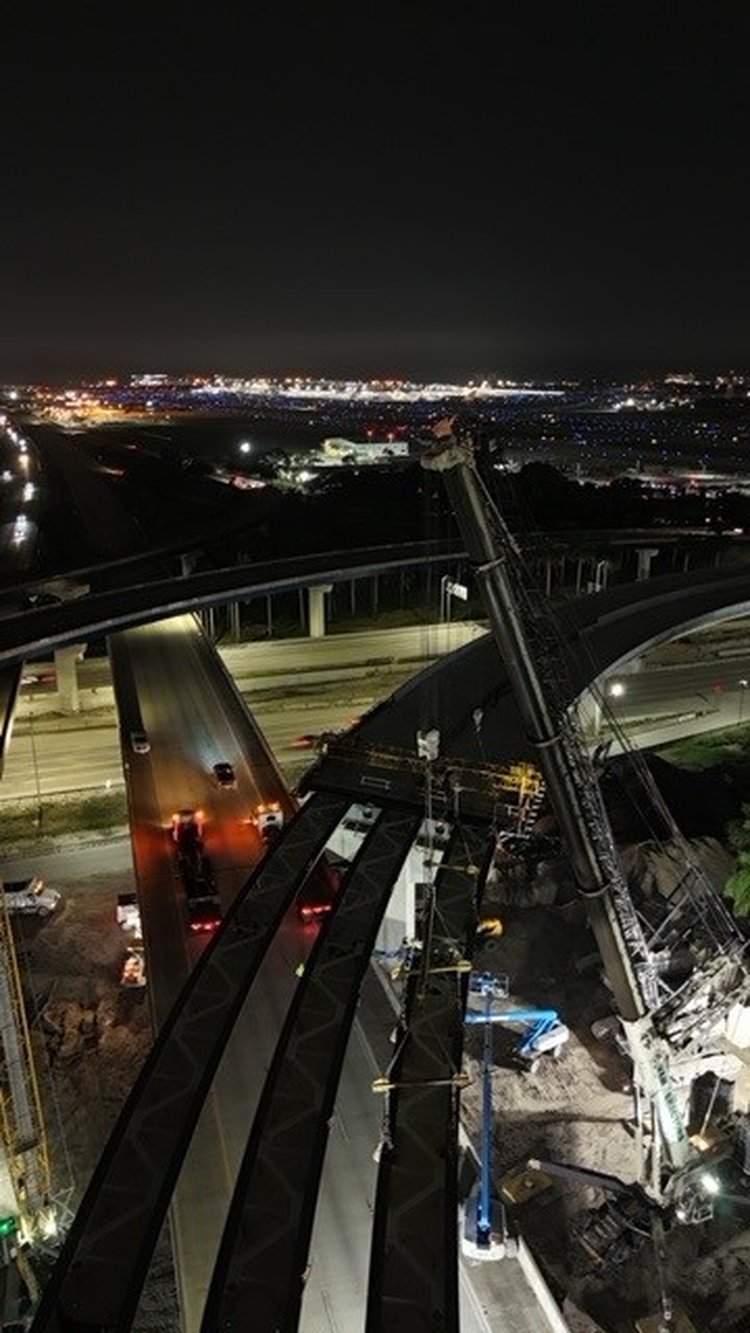

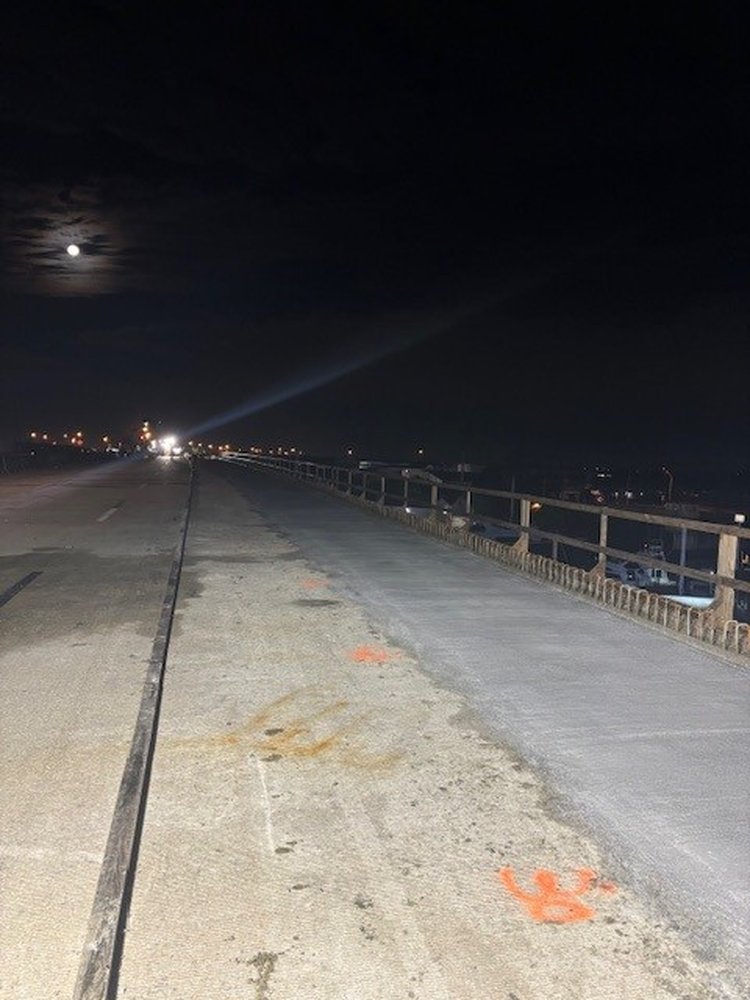

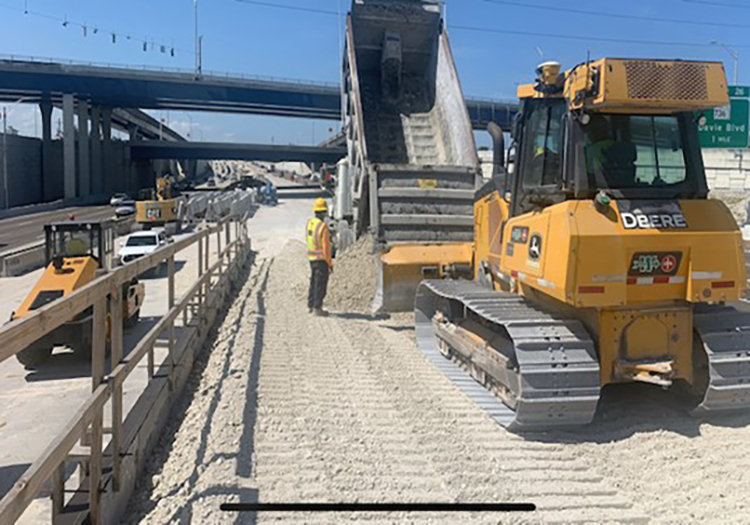

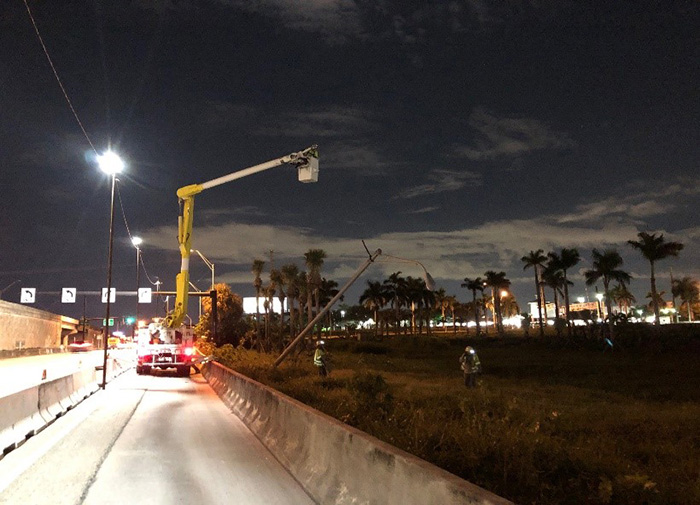

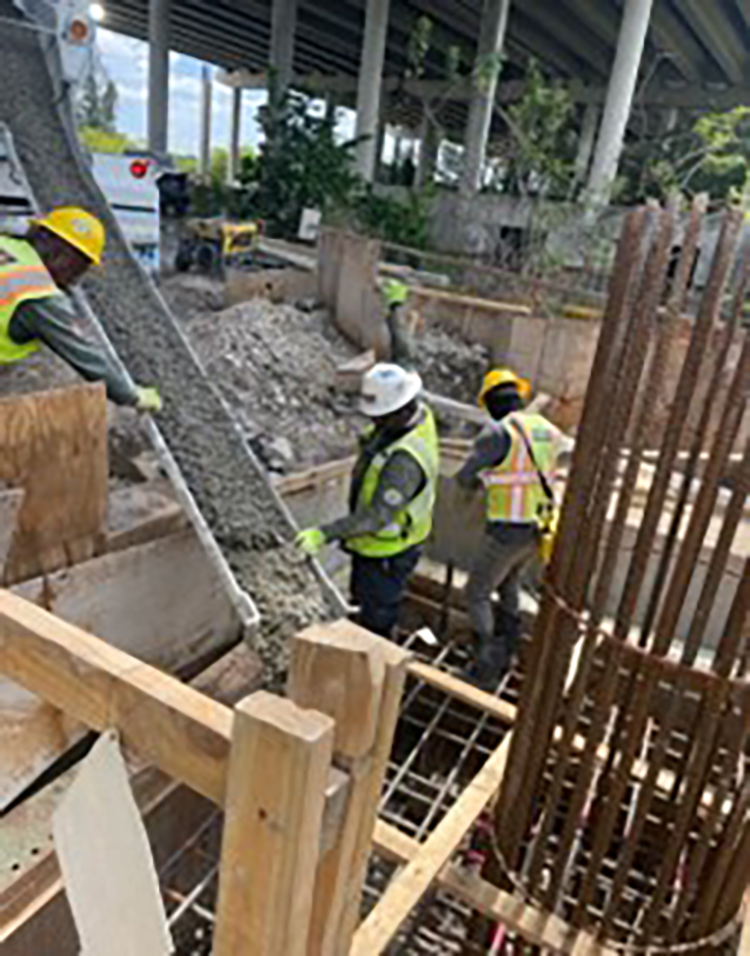

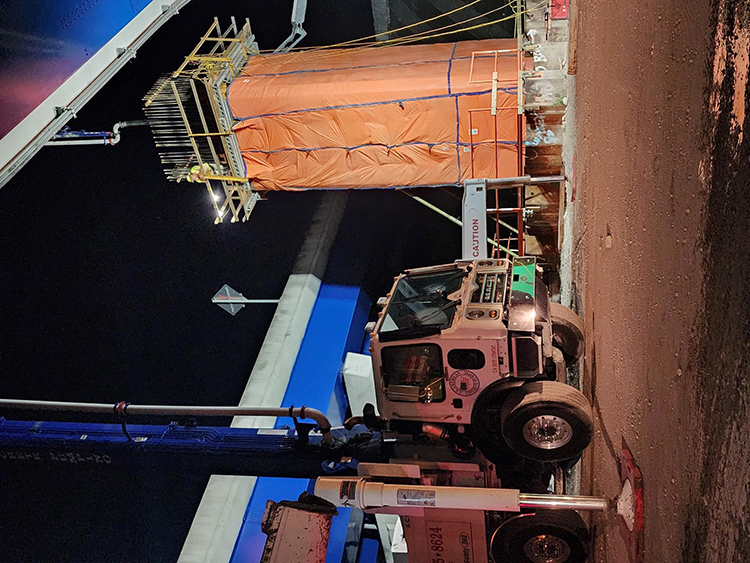

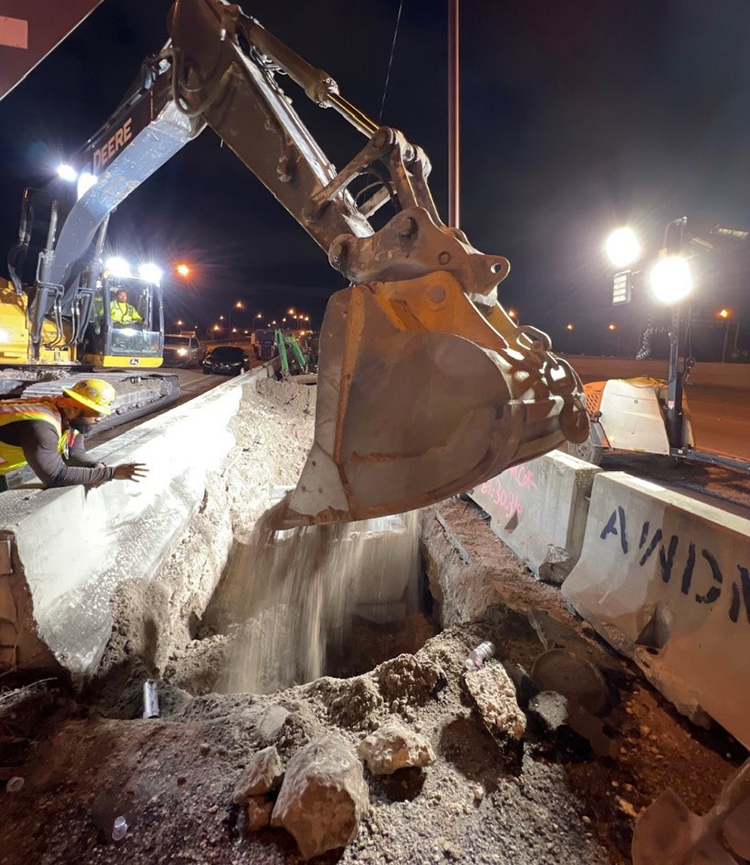

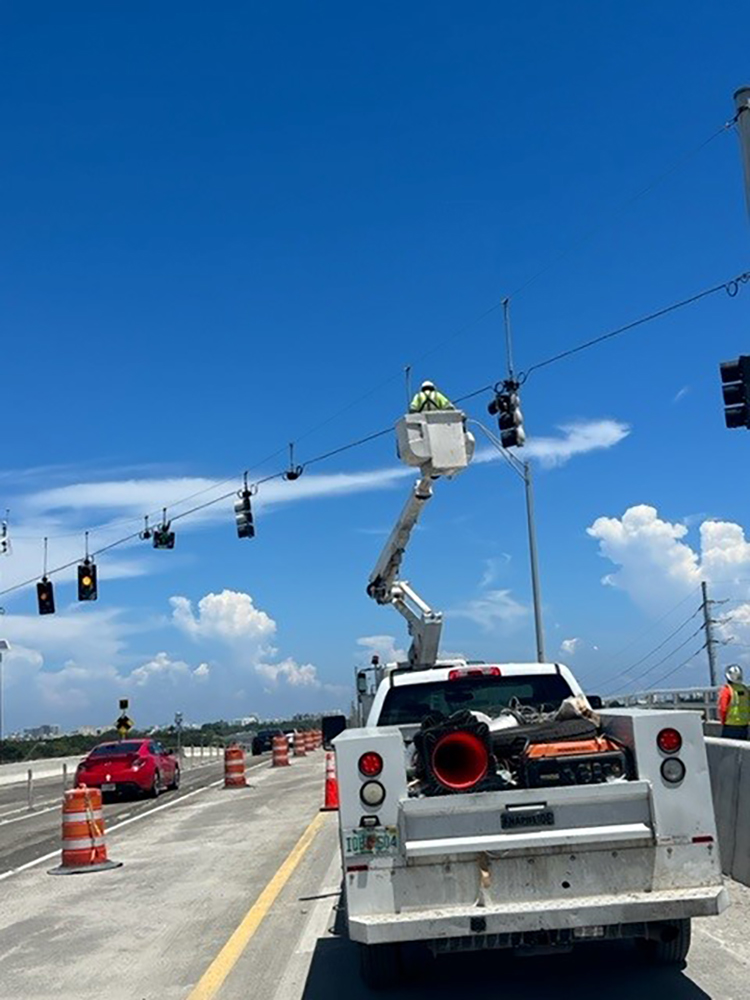

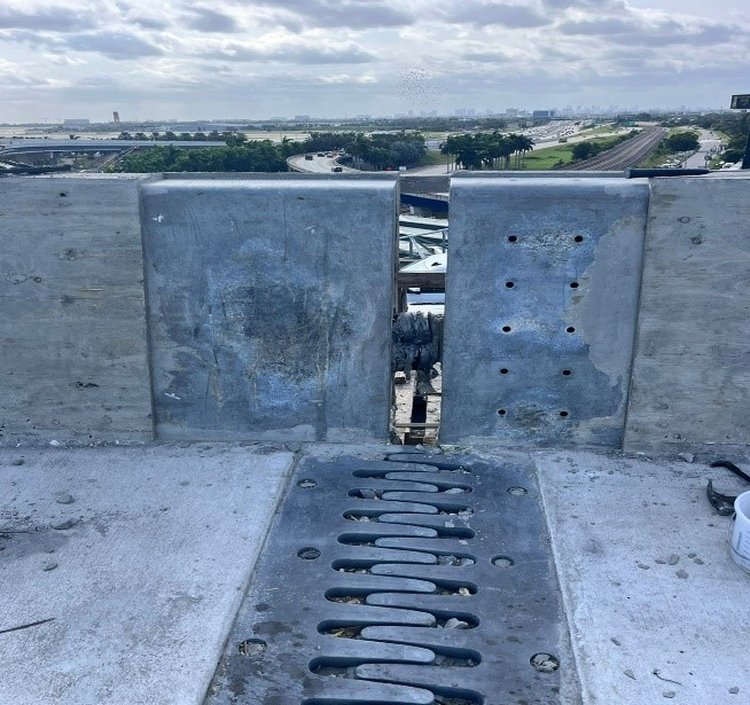

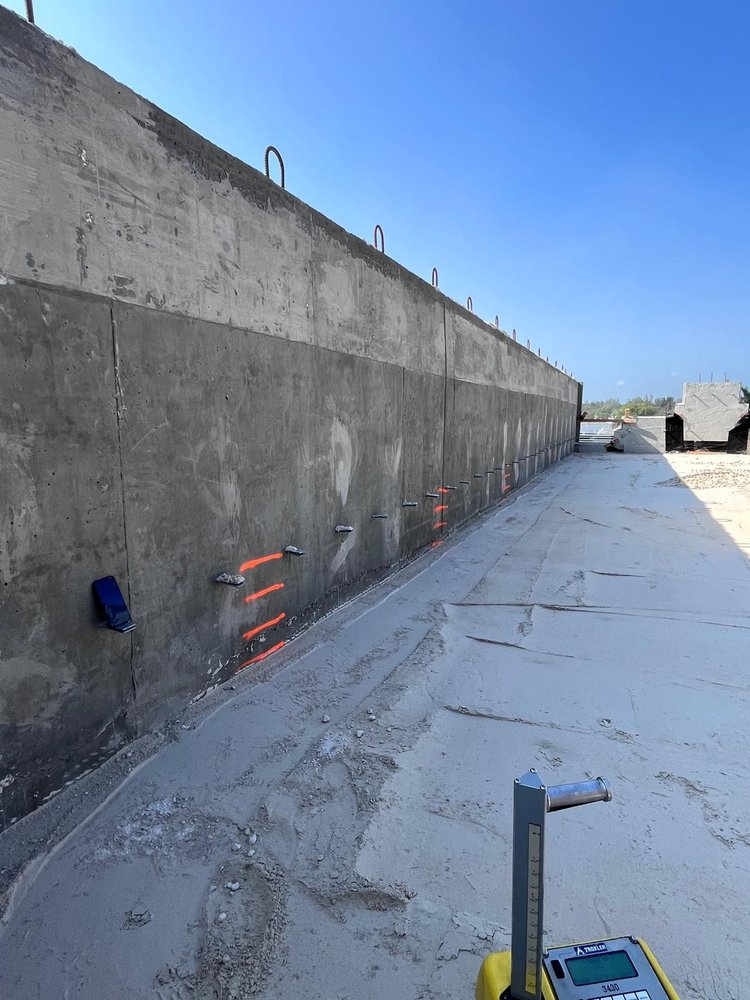

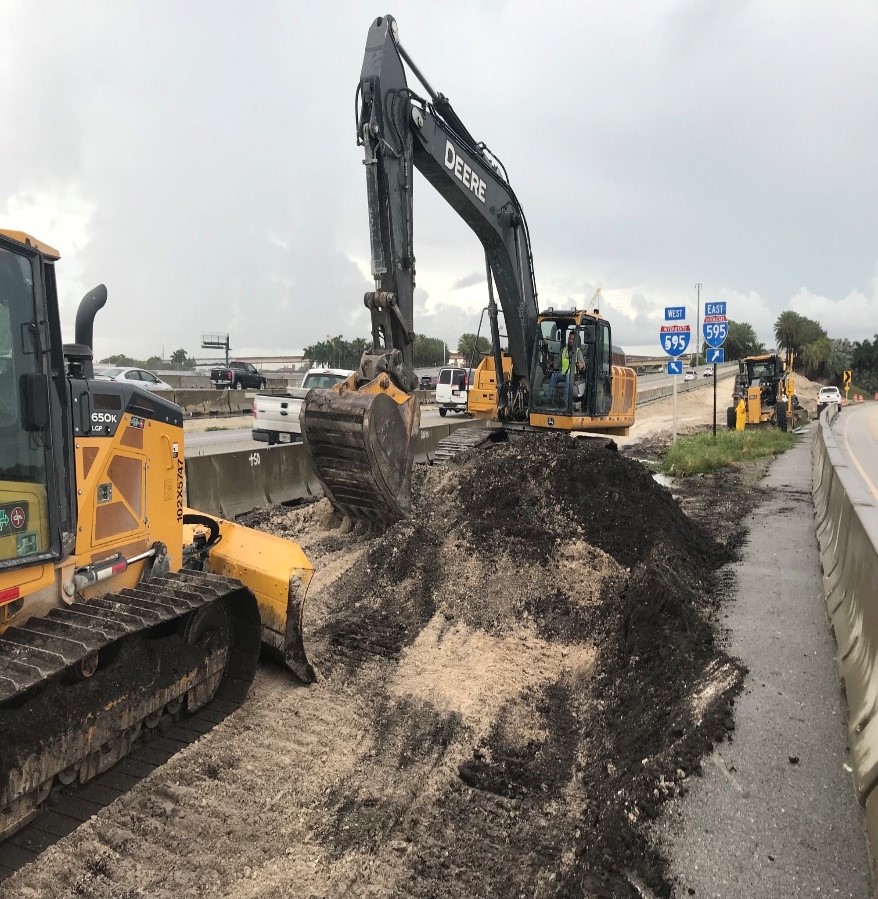

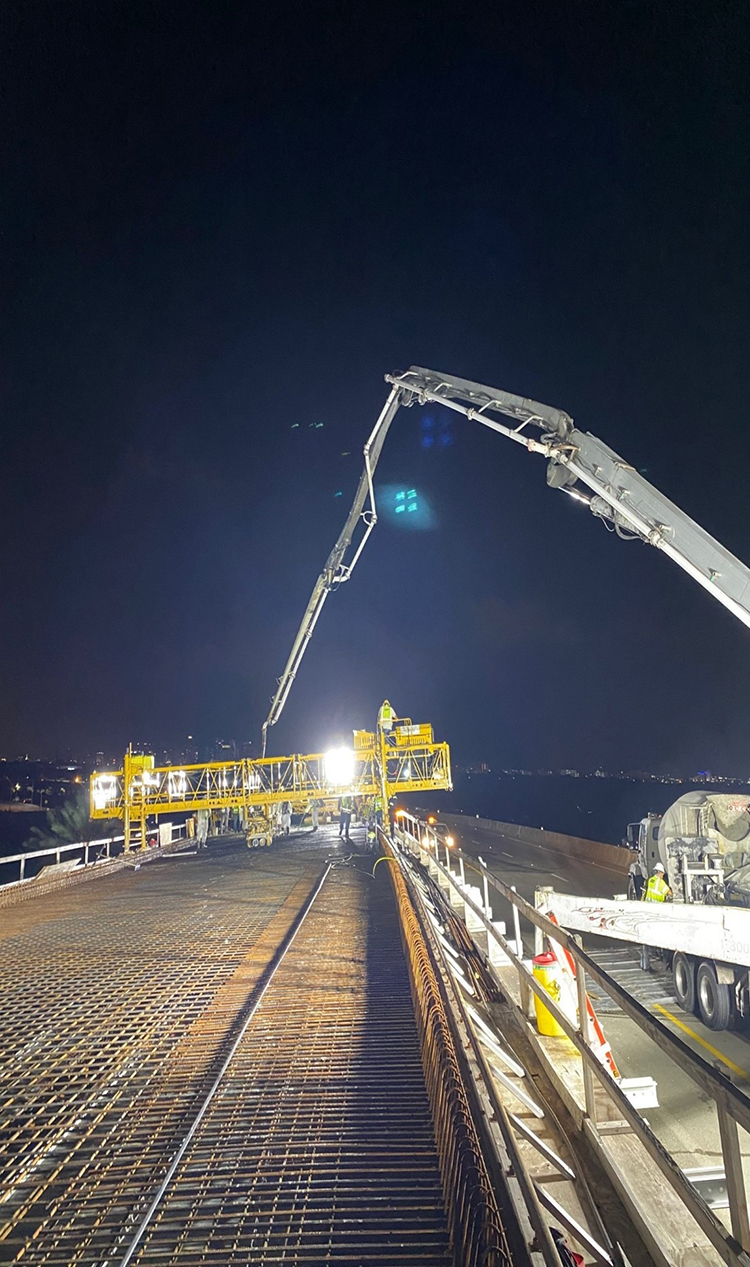

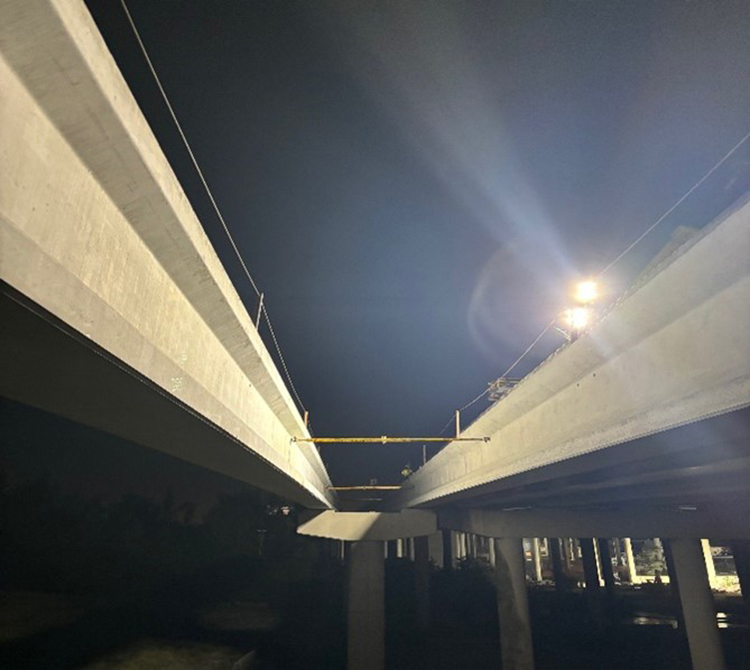

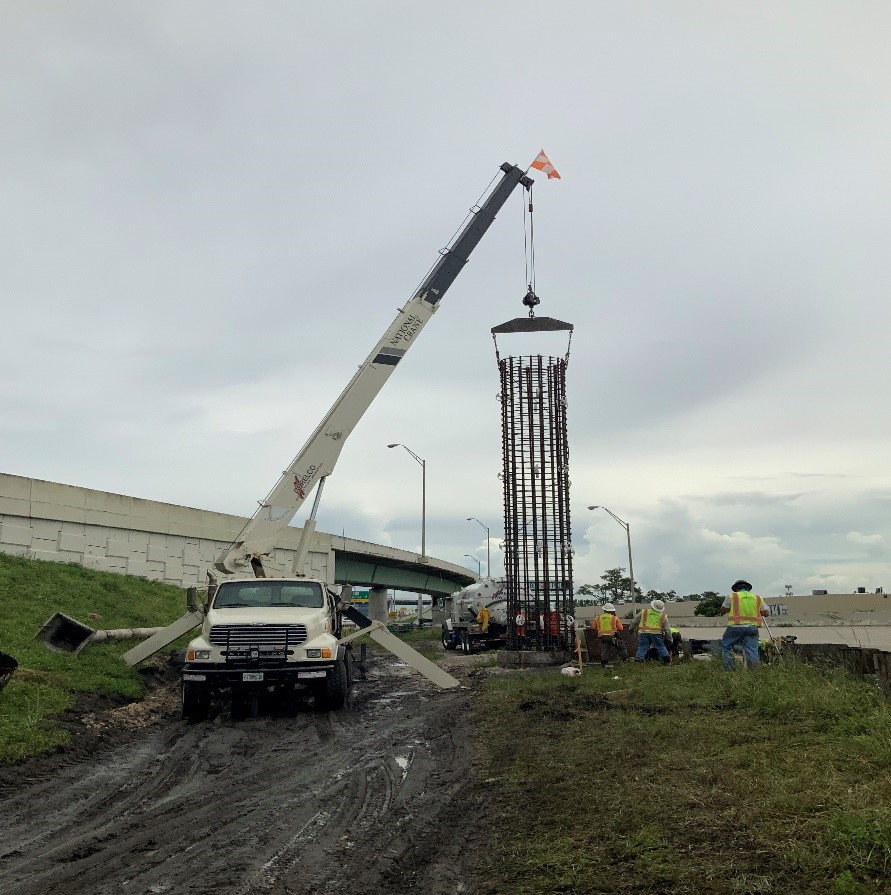

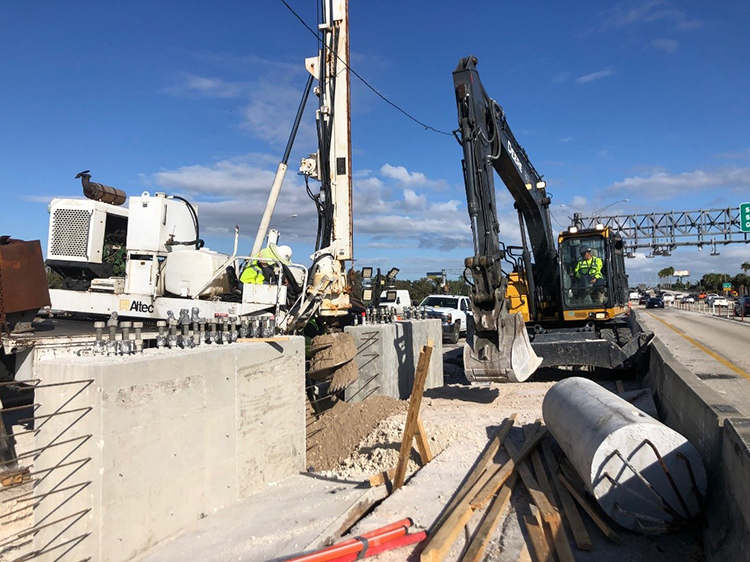

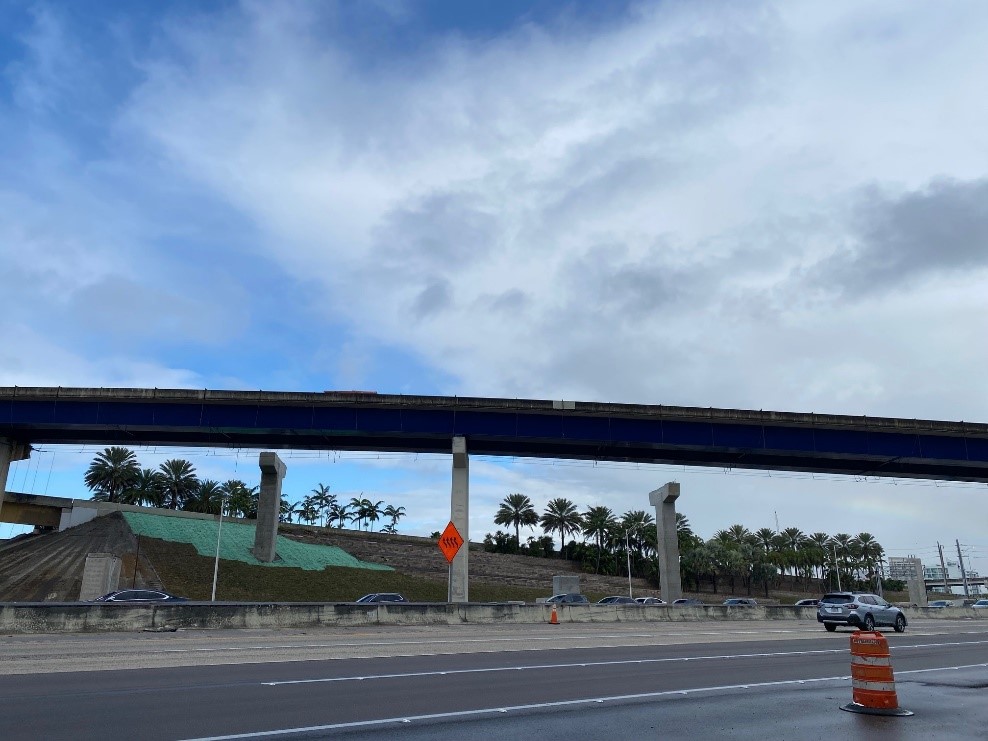

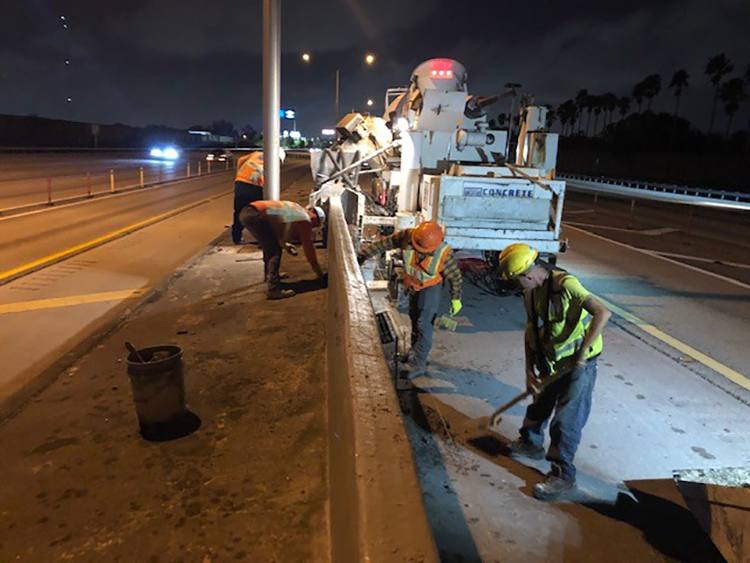

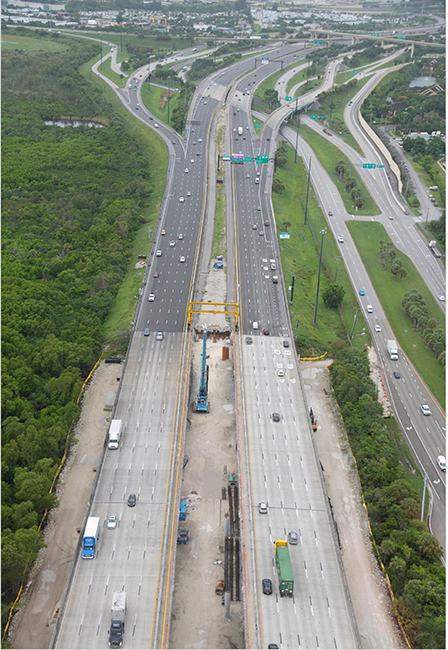

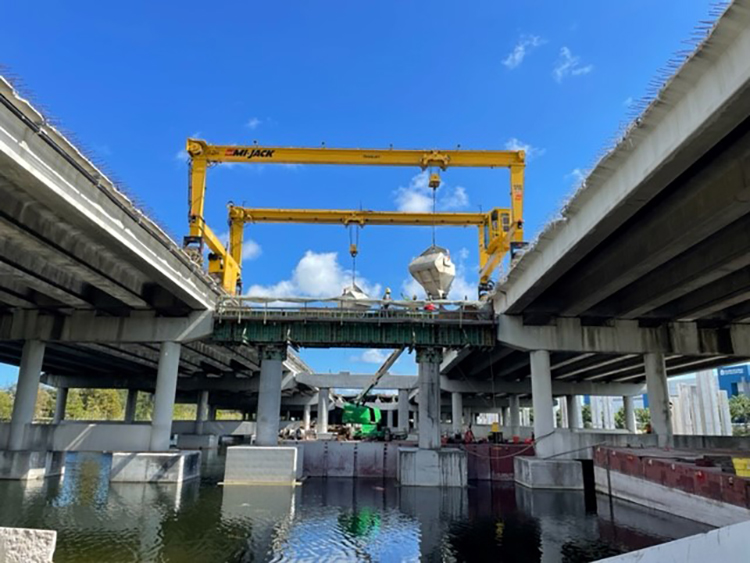

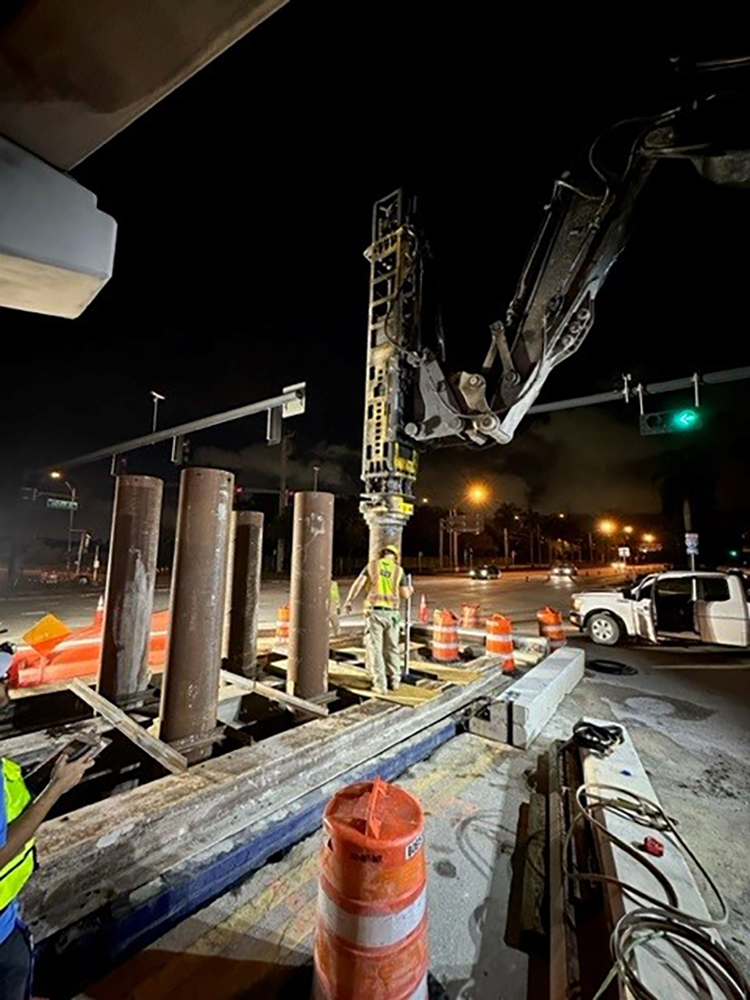

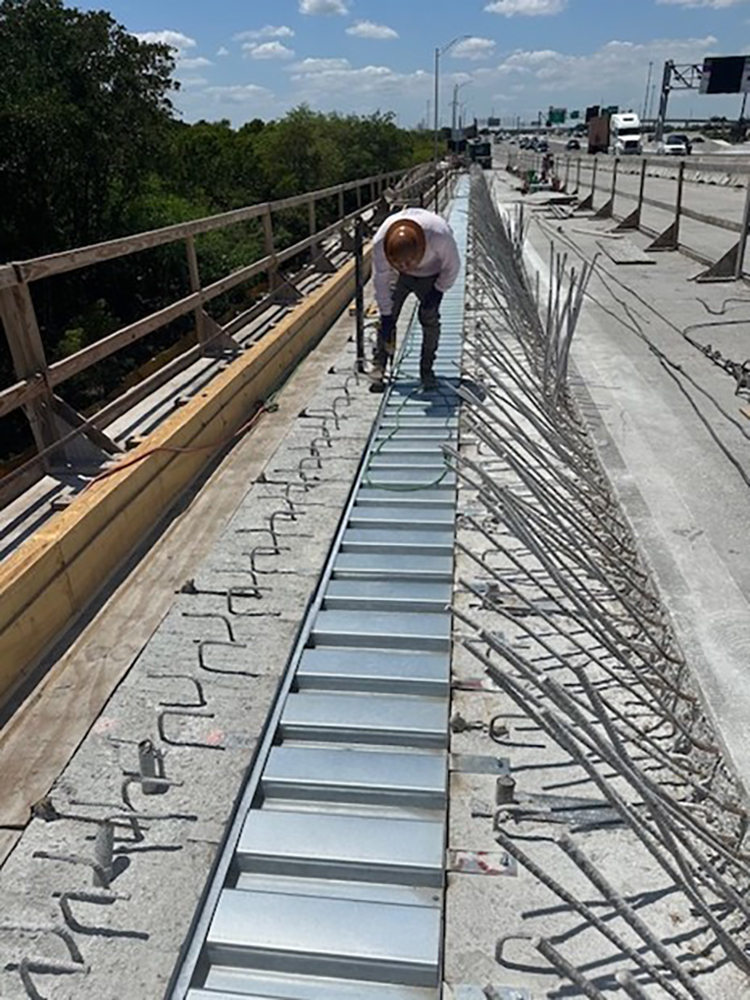

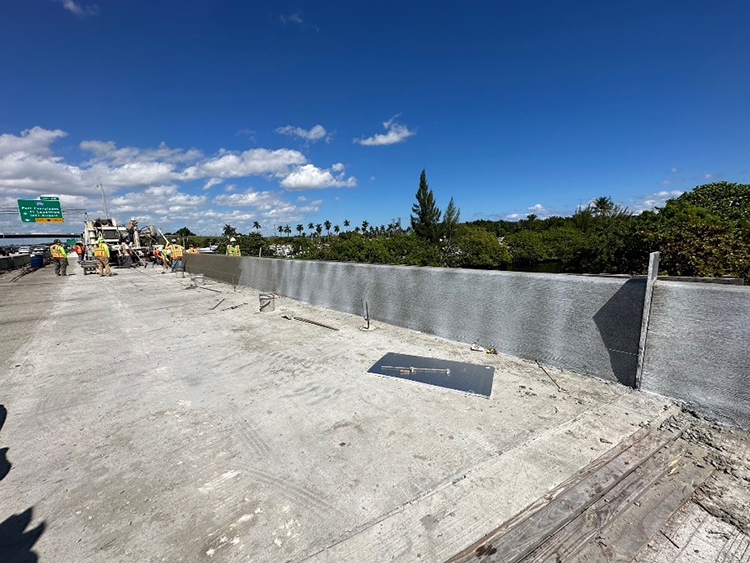

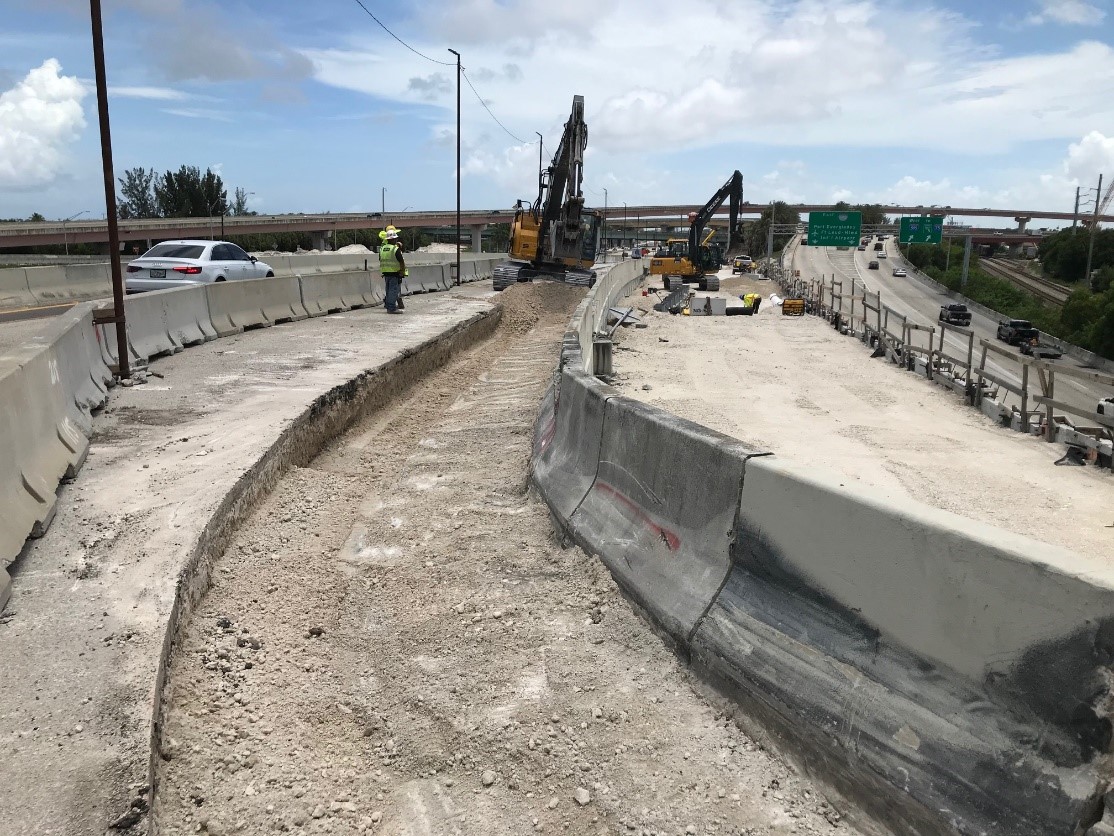

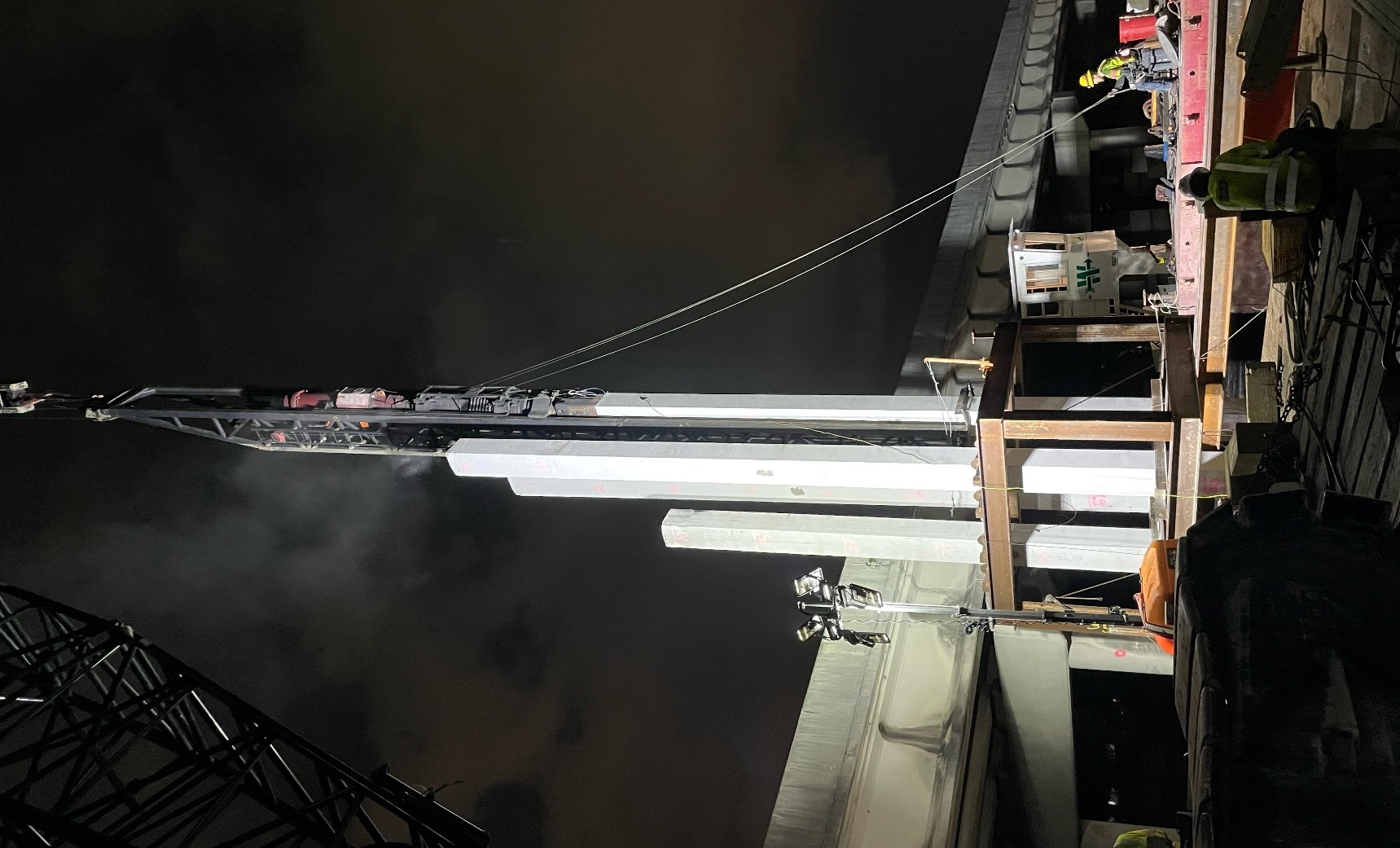

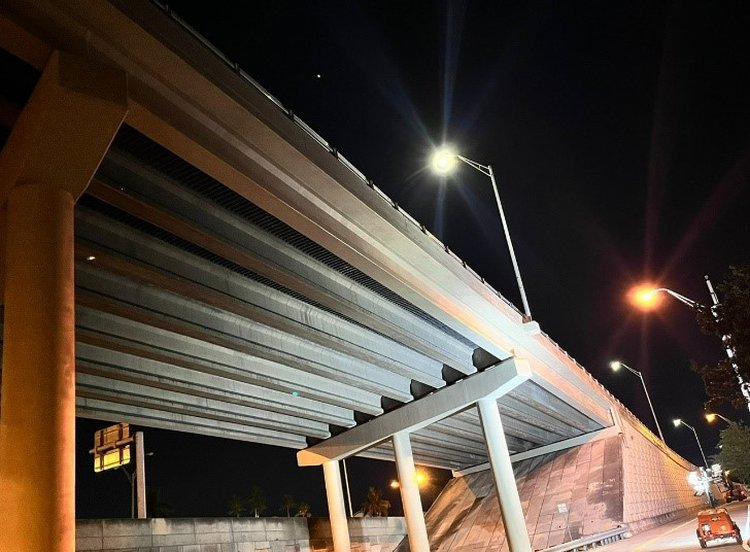

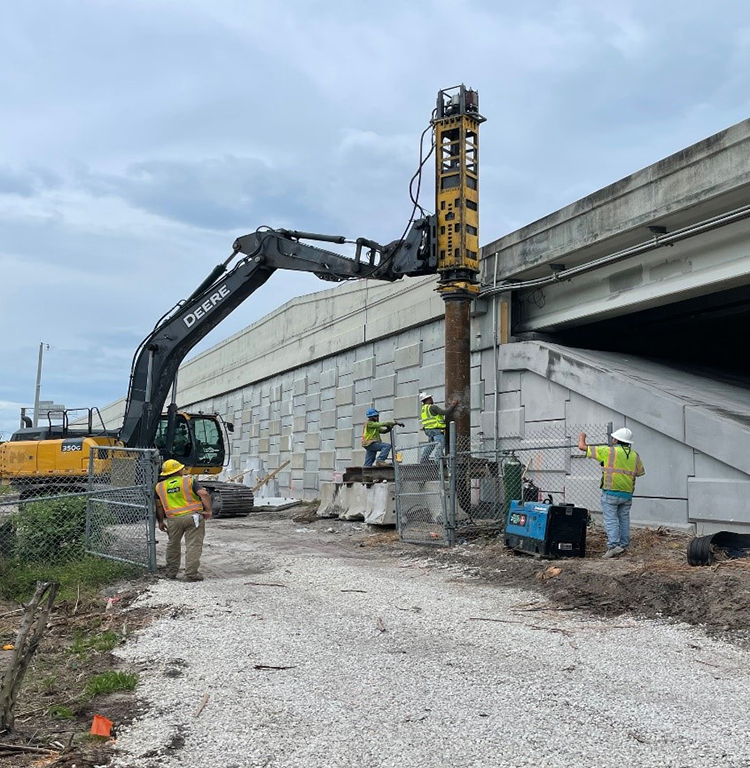

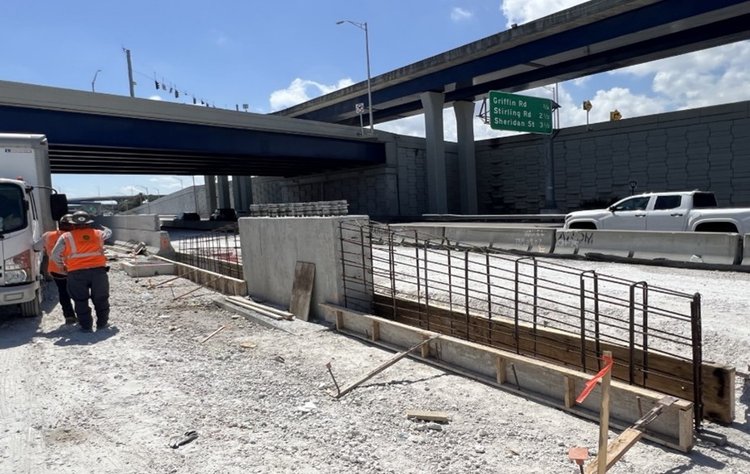

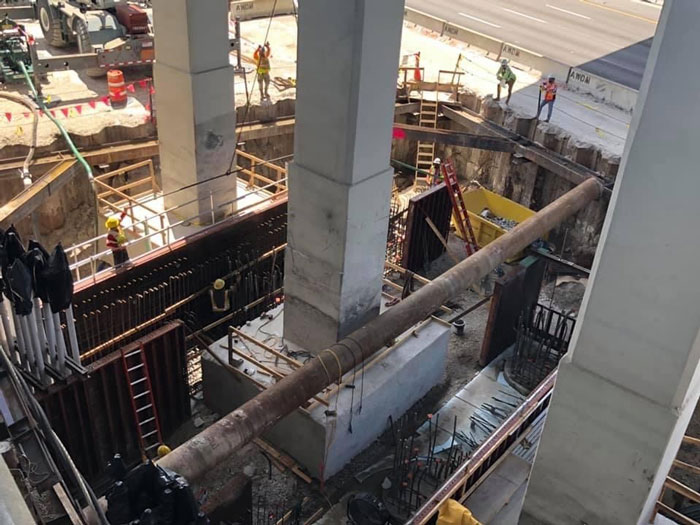

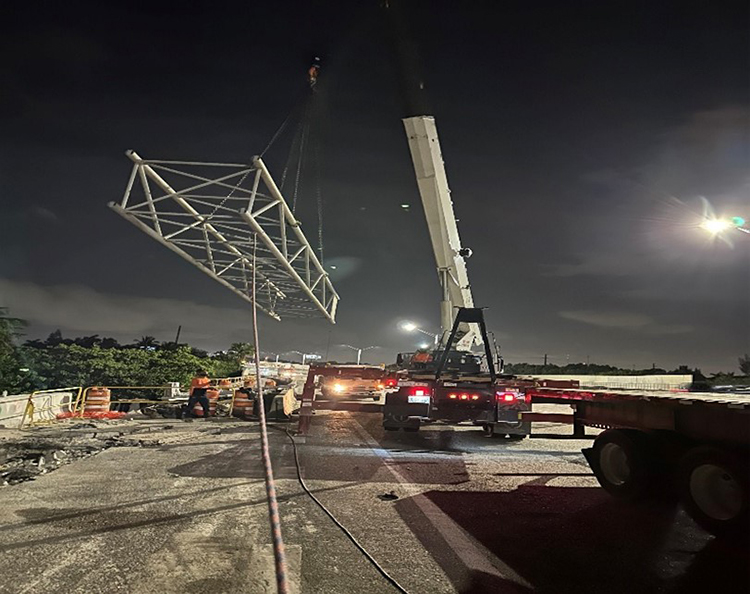

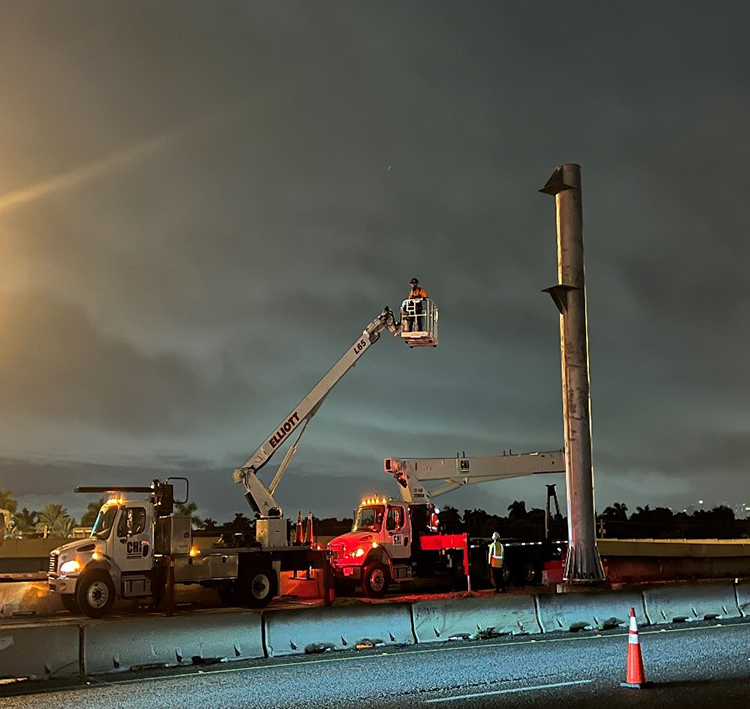

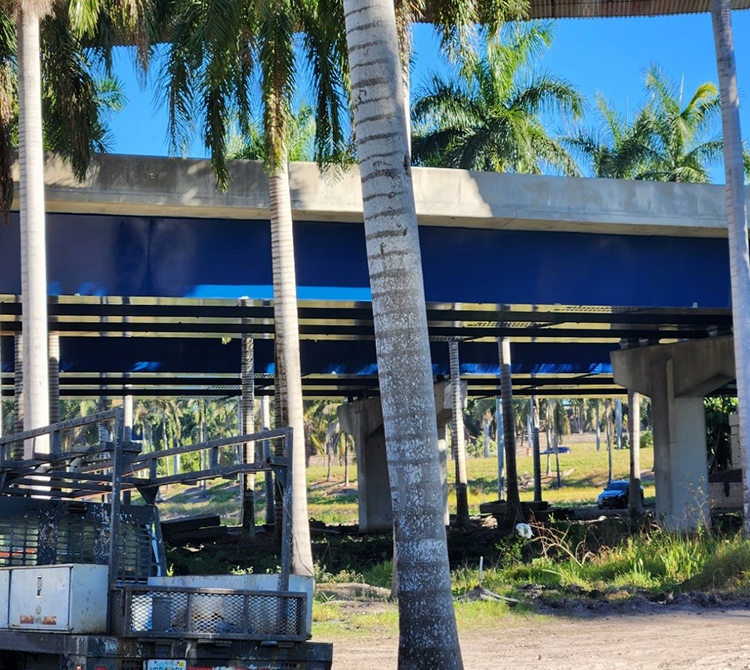

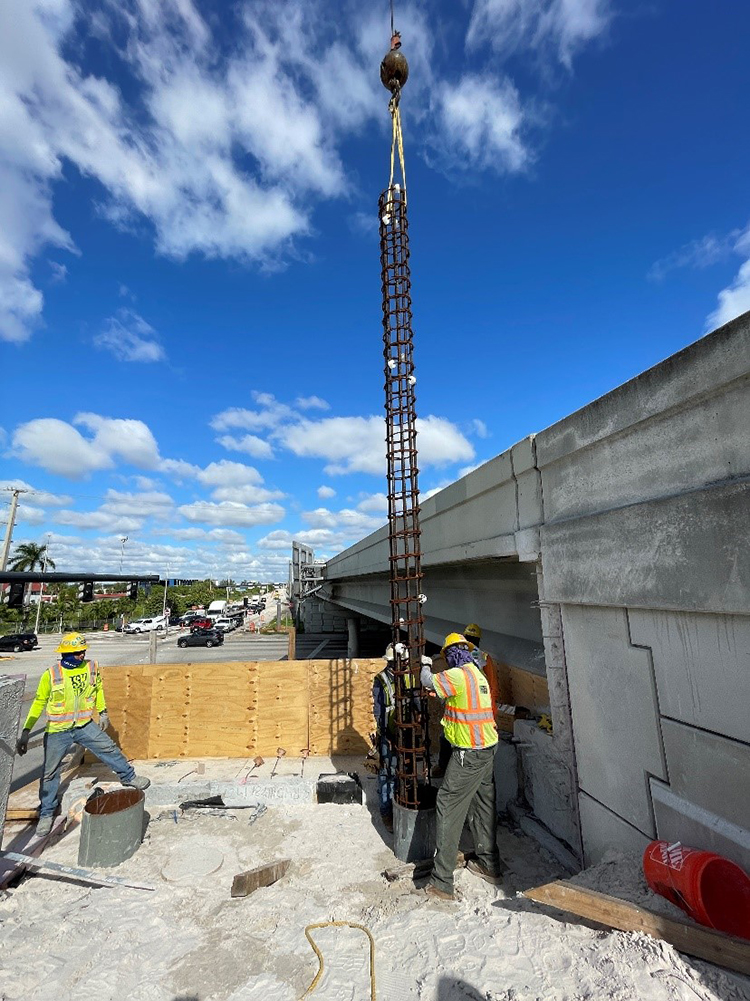

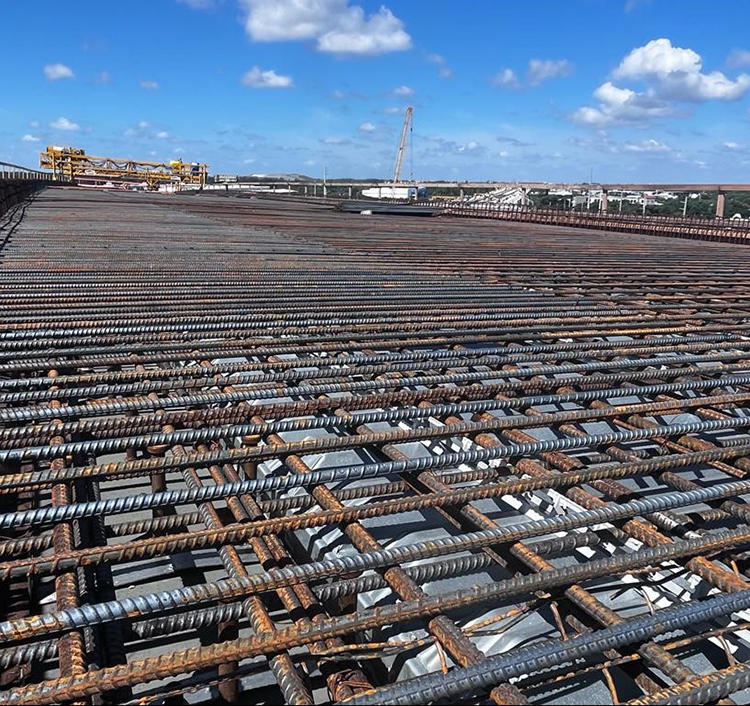

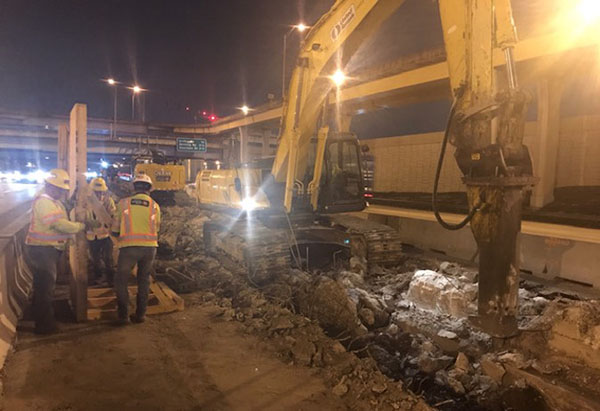

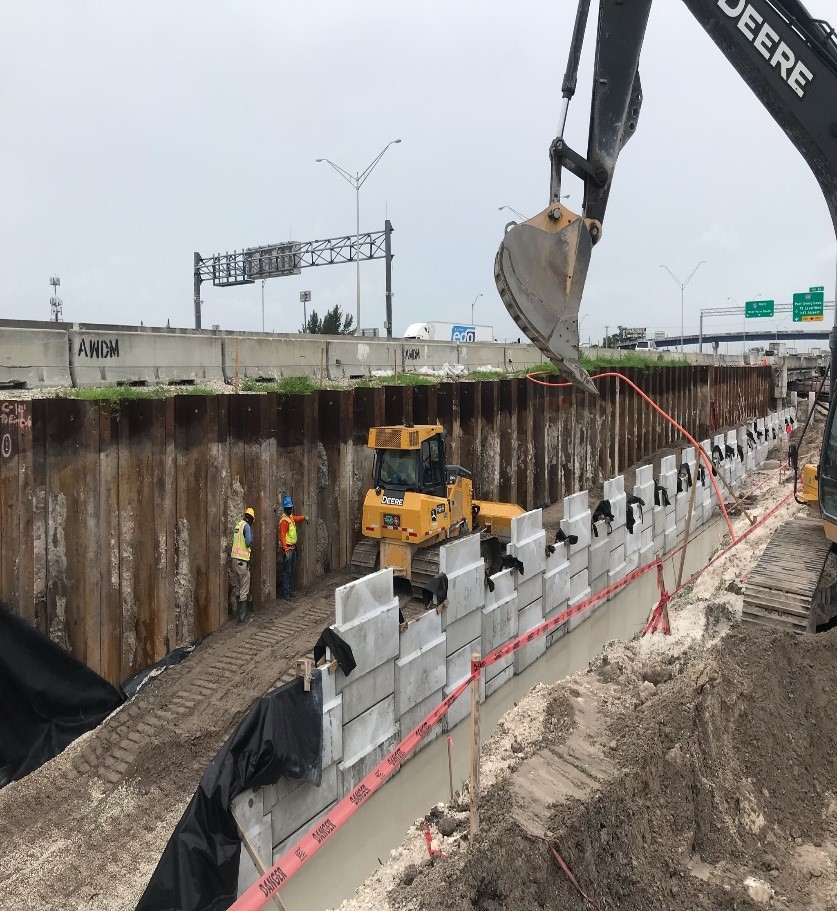

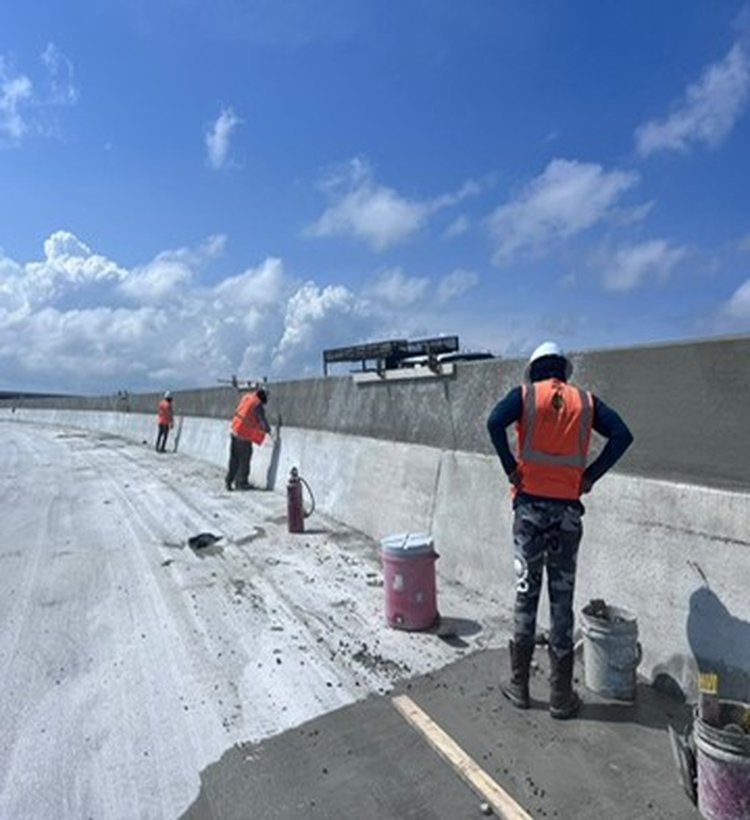

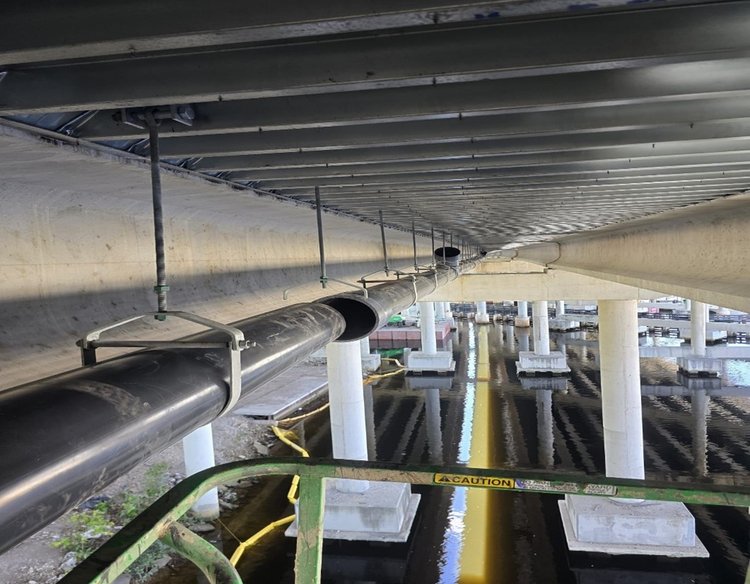

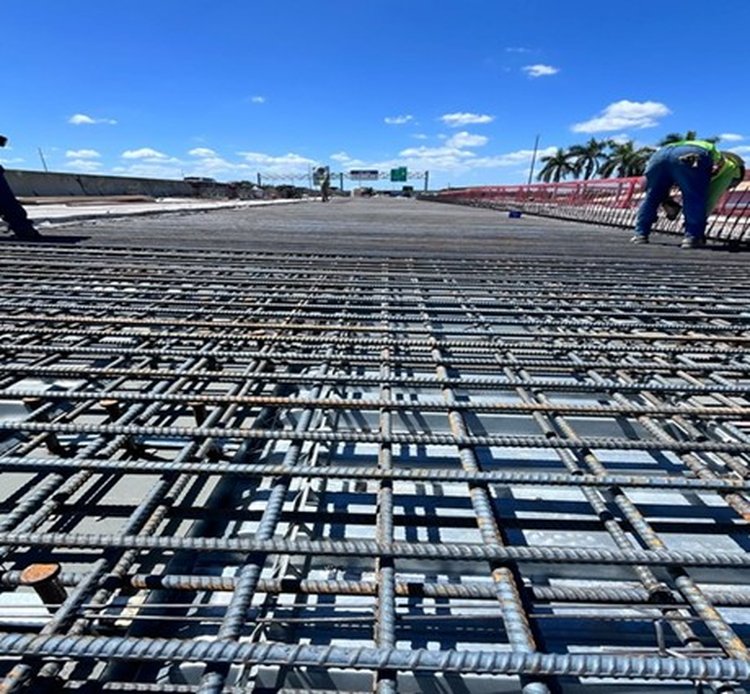

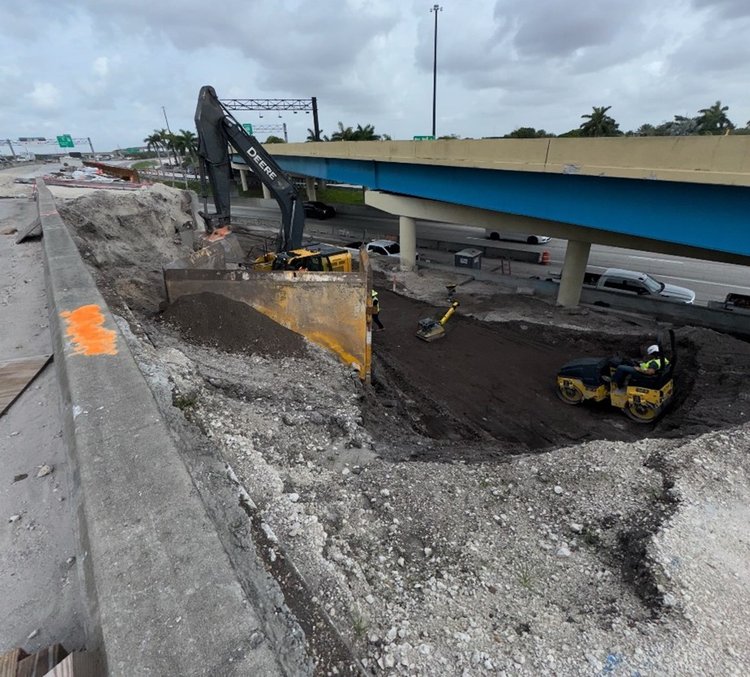

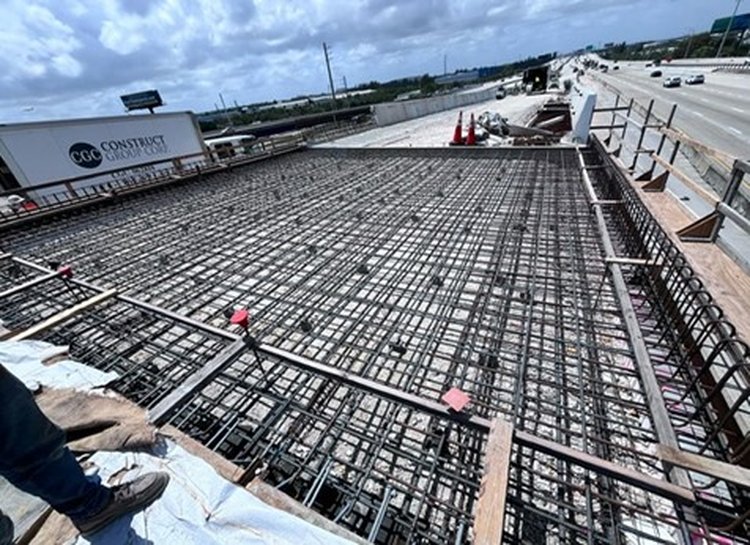

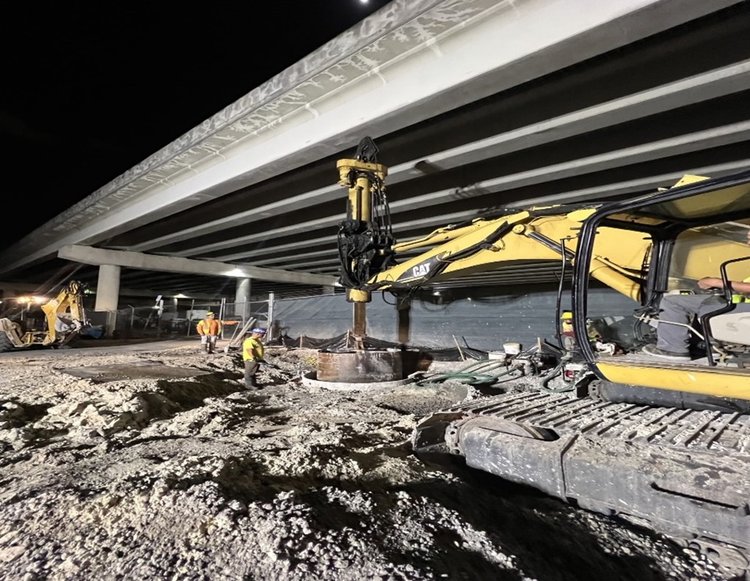

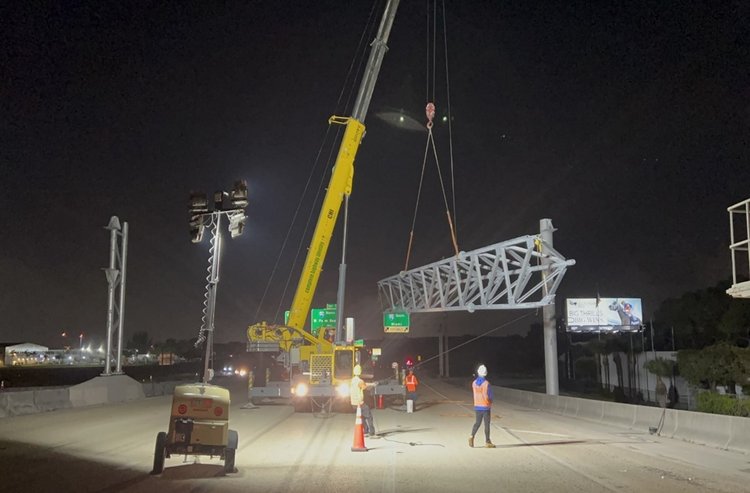

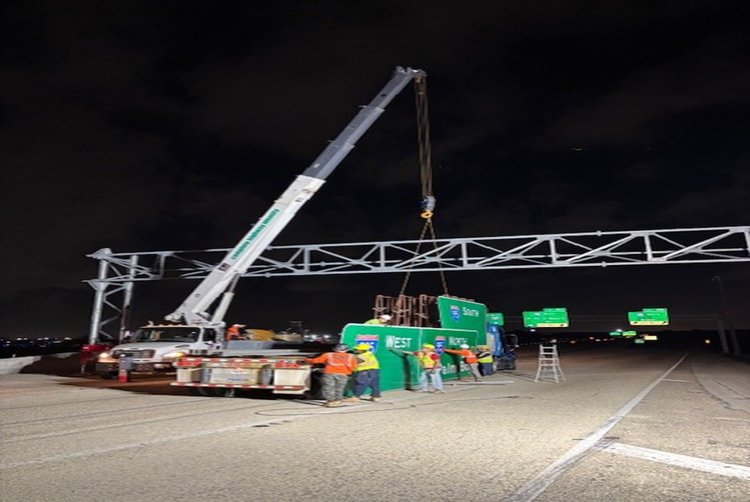

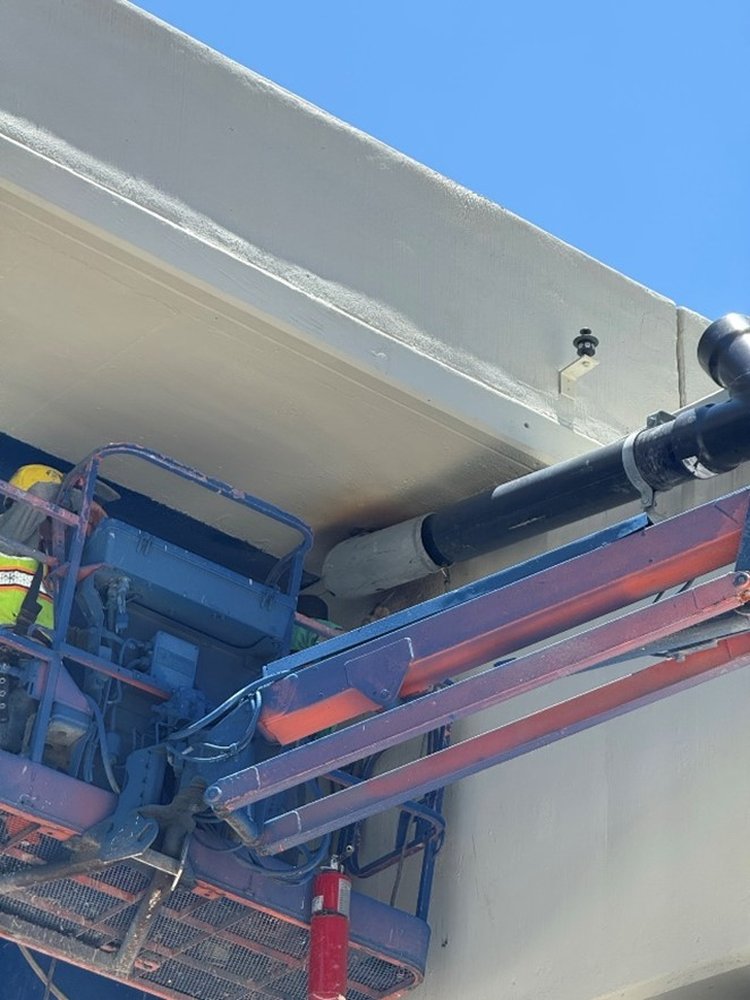

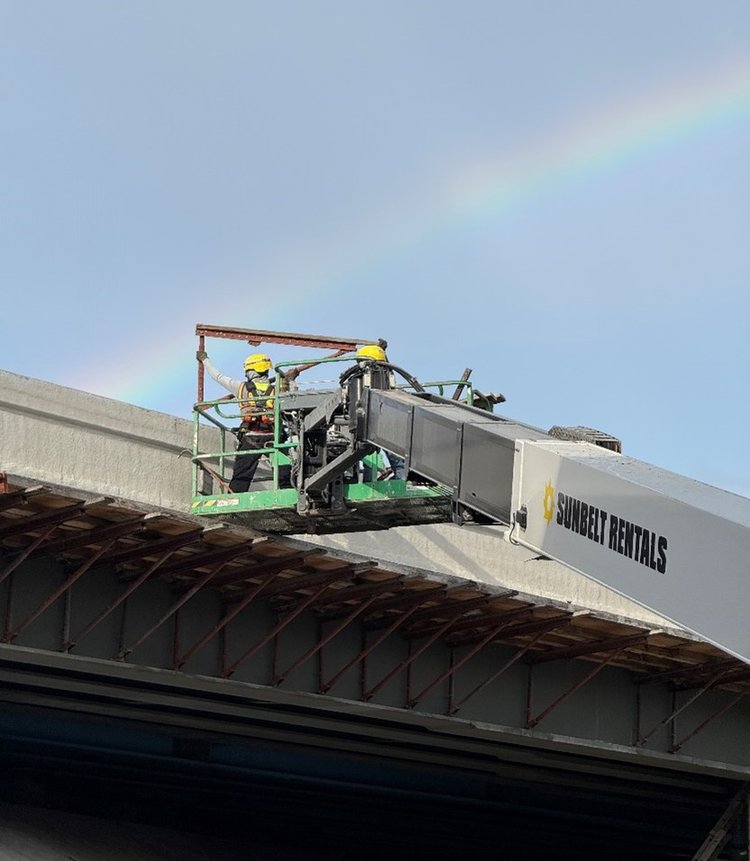

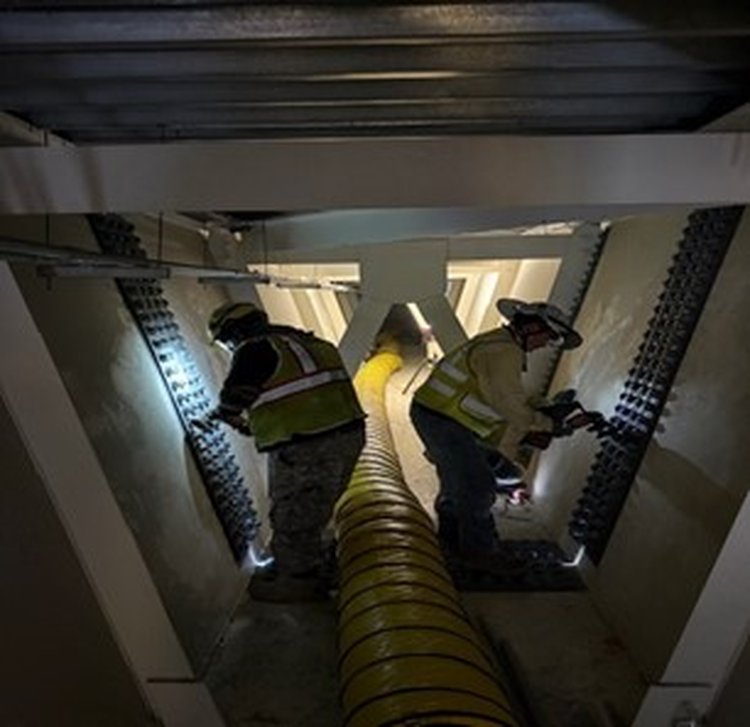

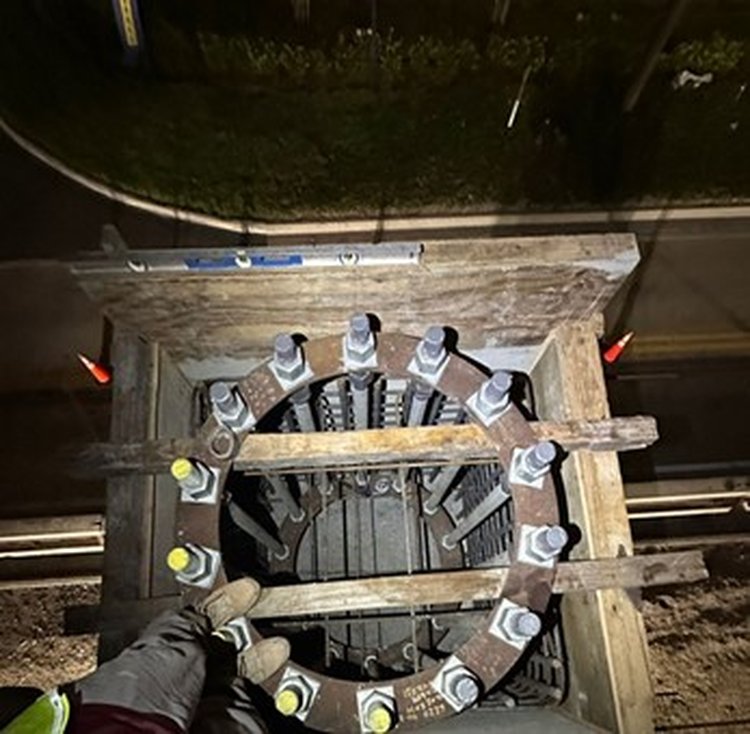

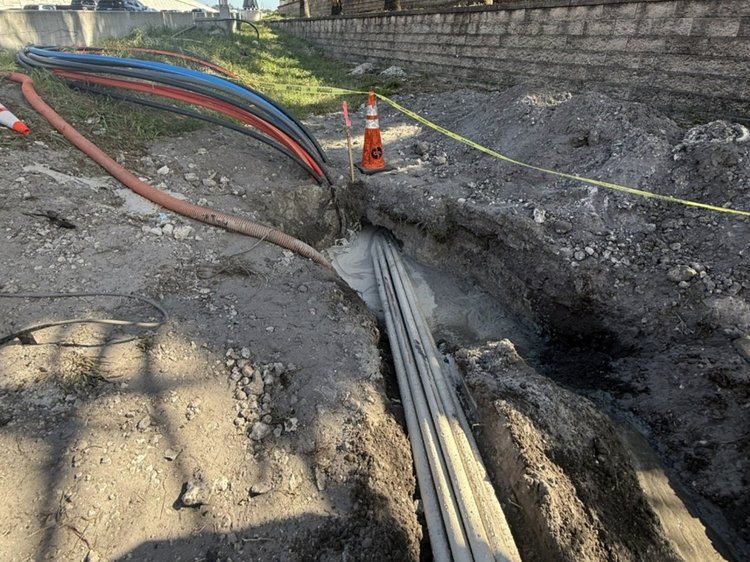

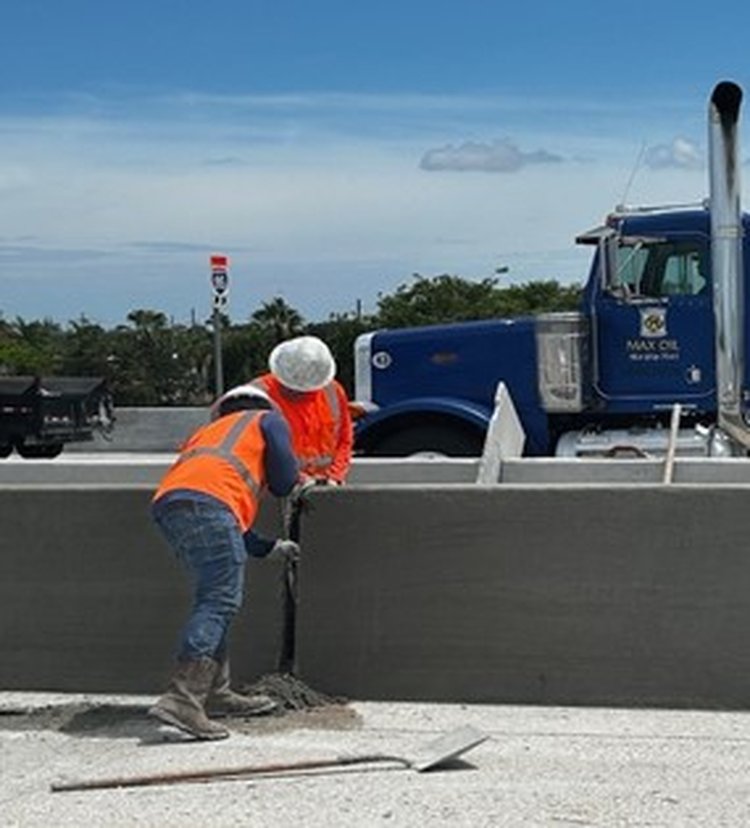

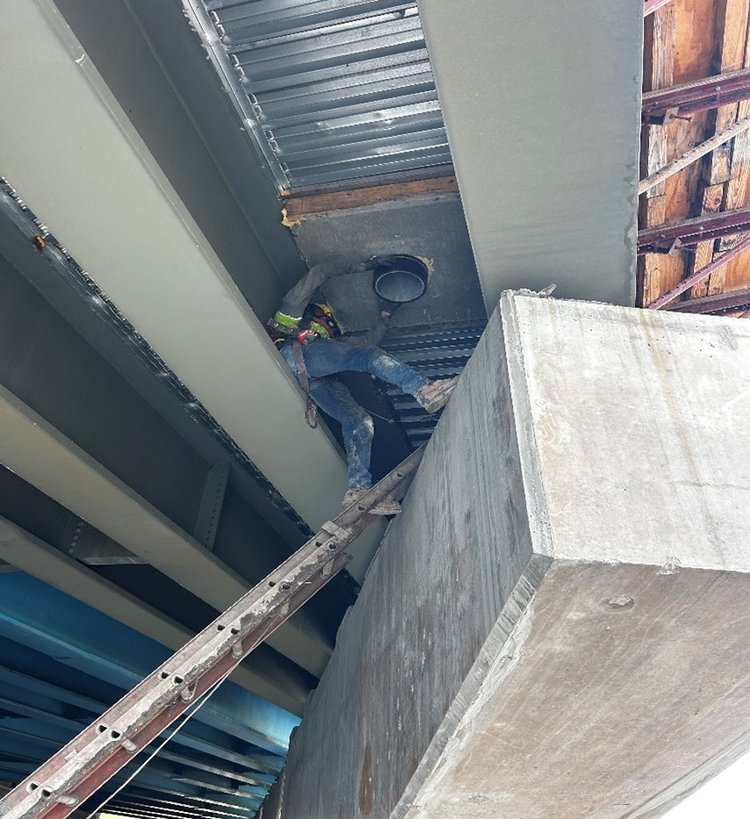

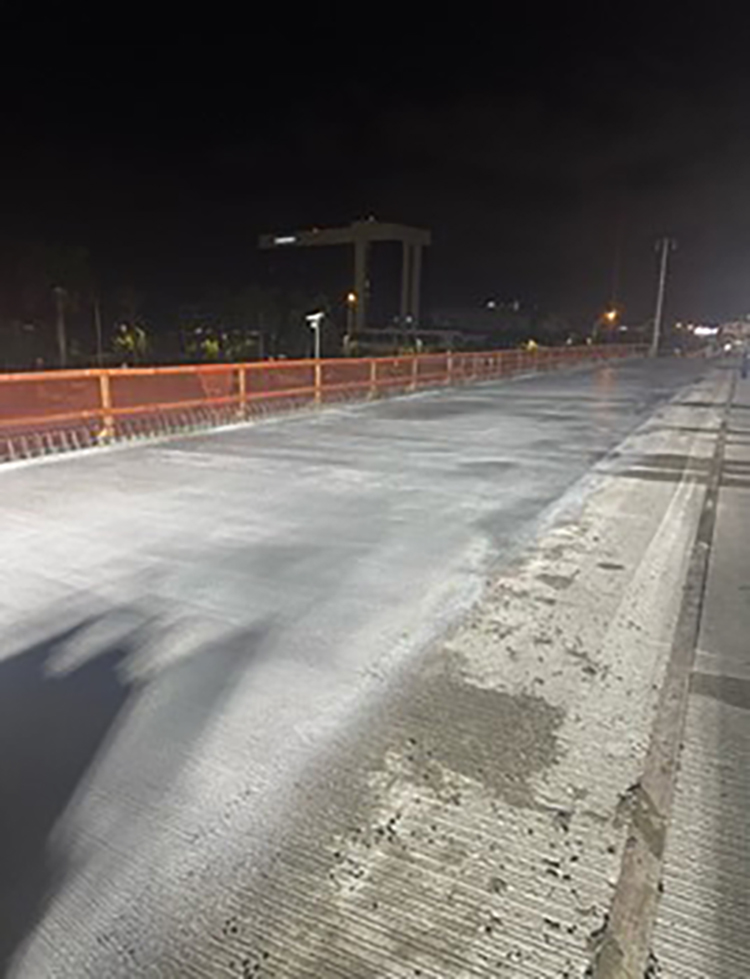

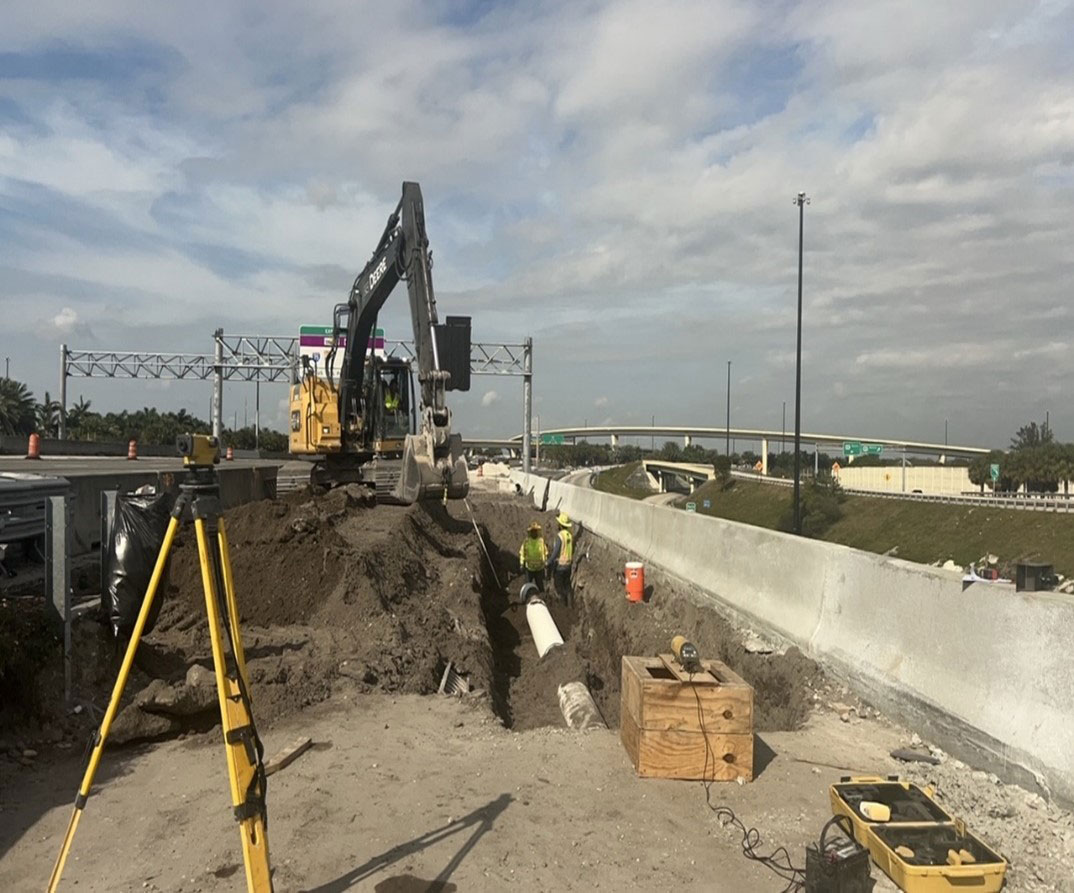

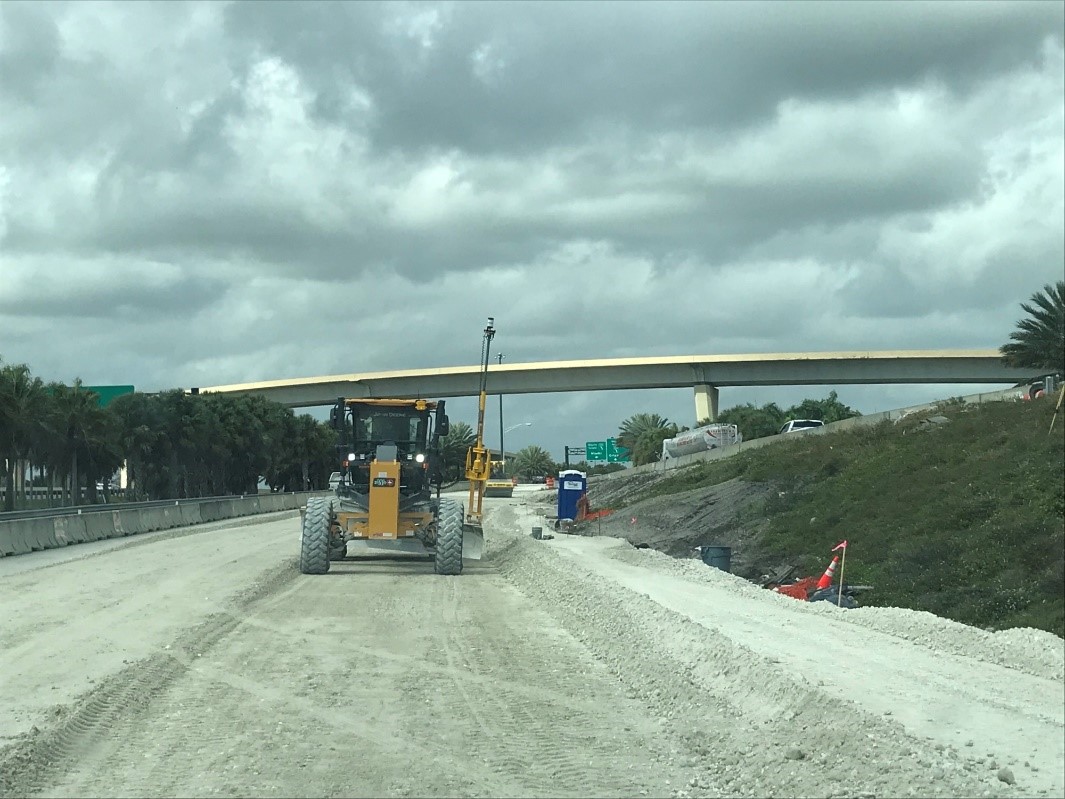

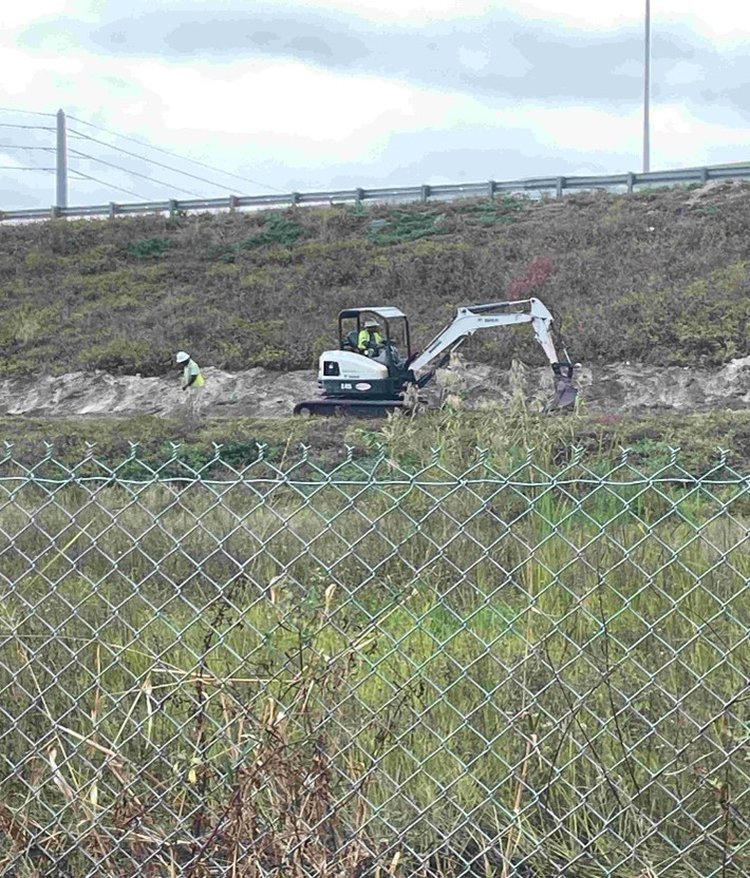

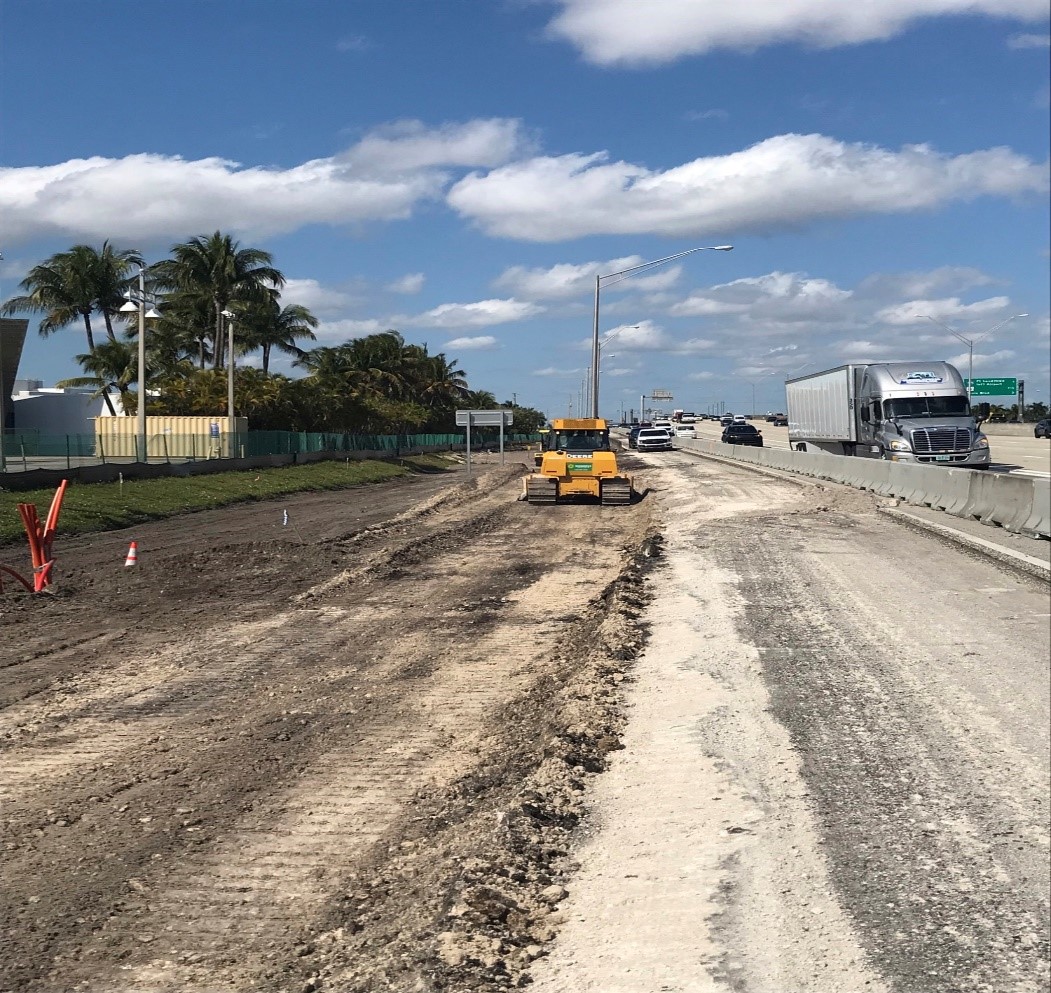

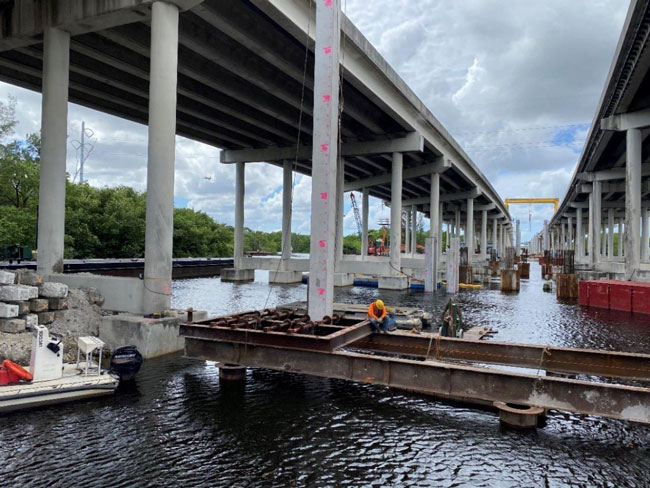

Earthwork Operations on I 595 and SR 84 eastbound   February 2024 Bridge 14 Traffic Railing Construction   February 2024 Overhead sign structure installation along I 95 southbound   February 2024

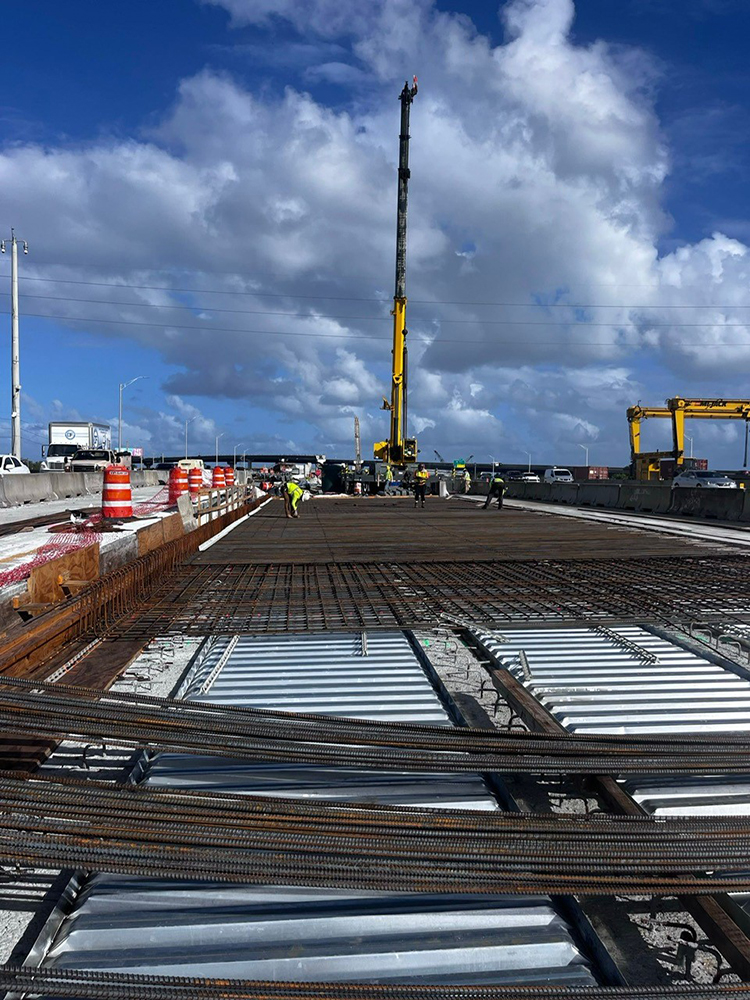

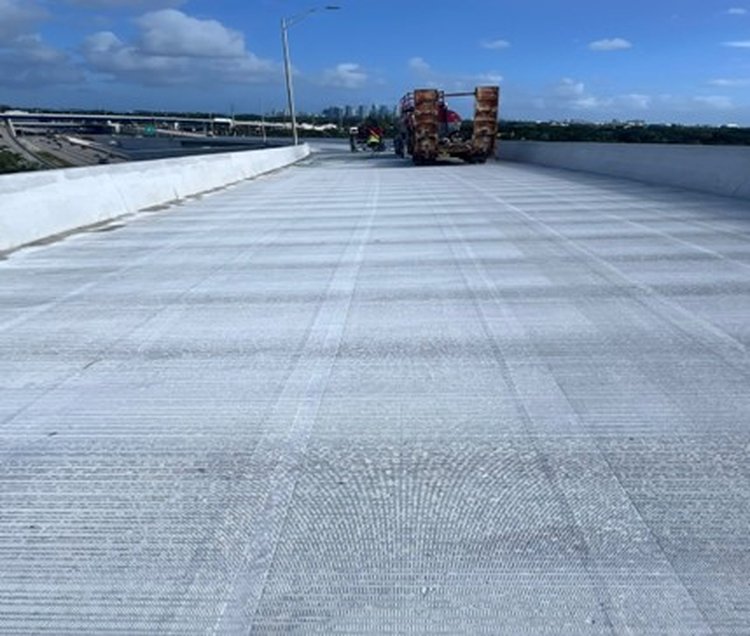

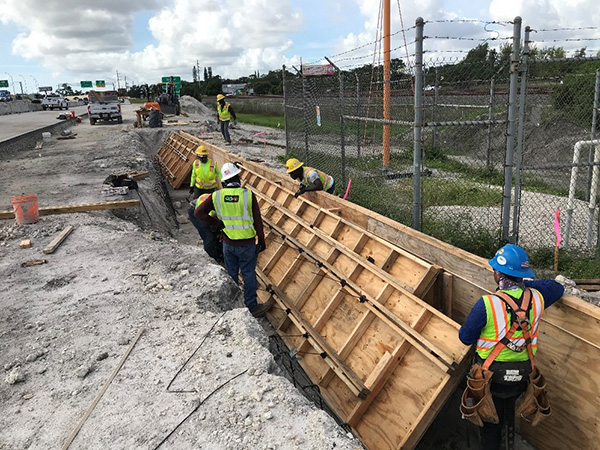

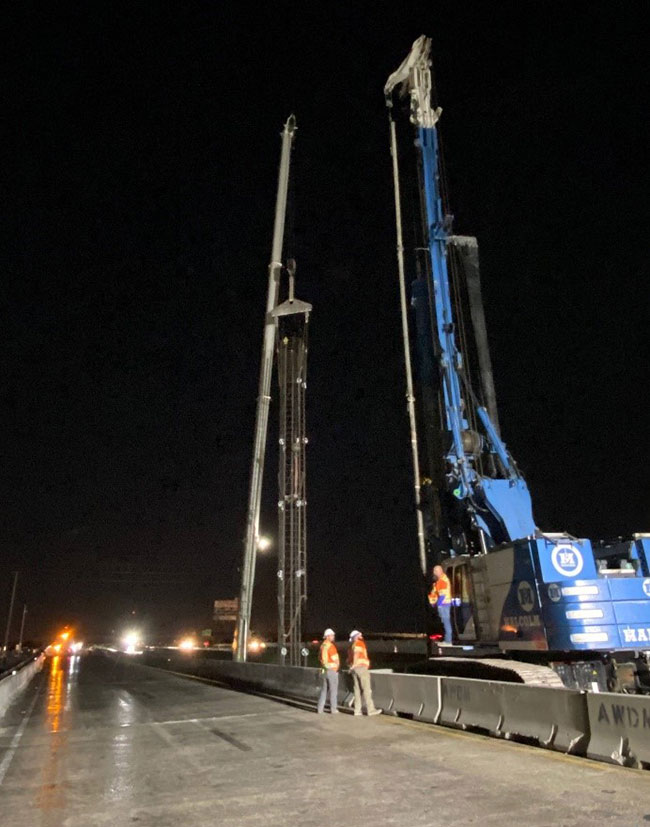

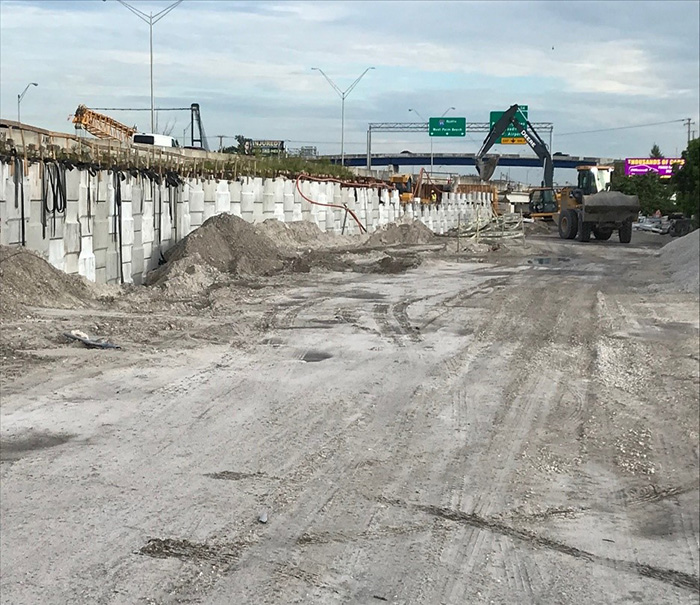

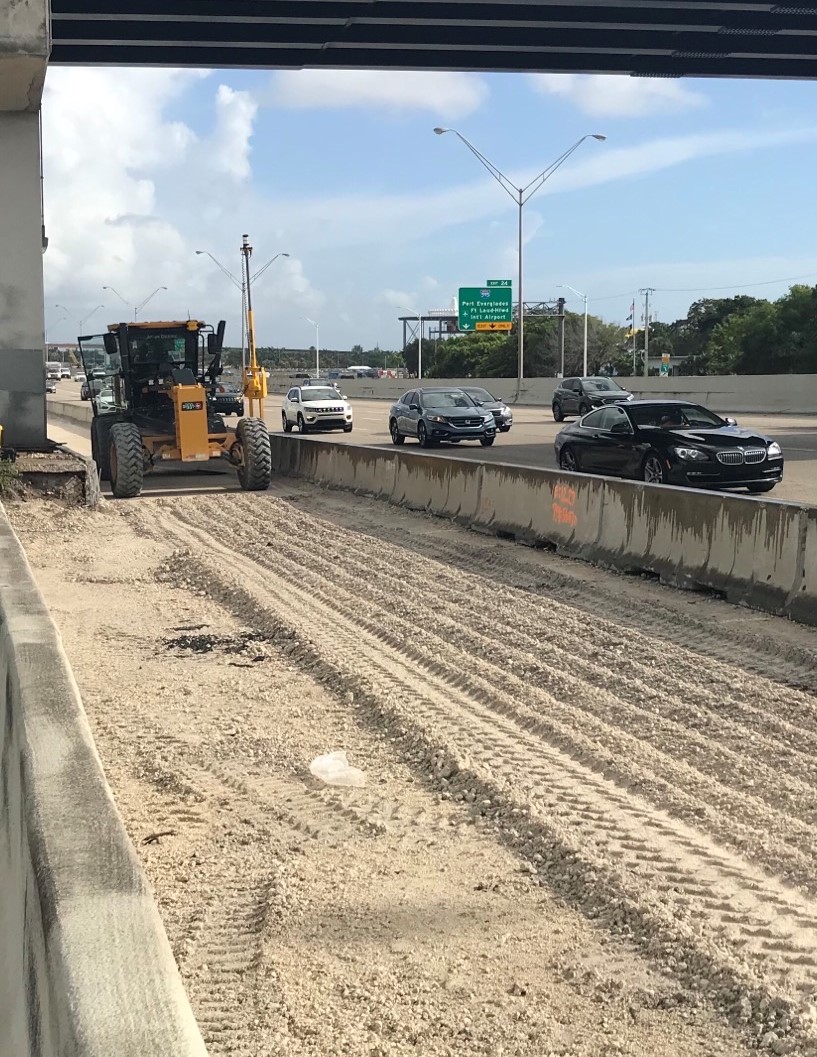

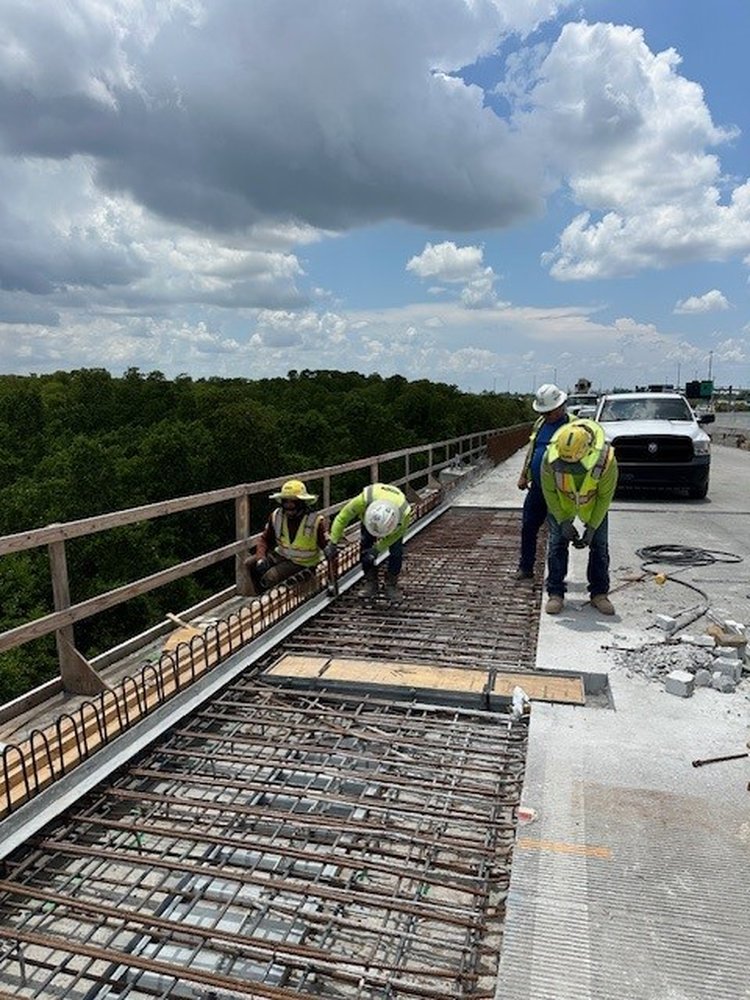

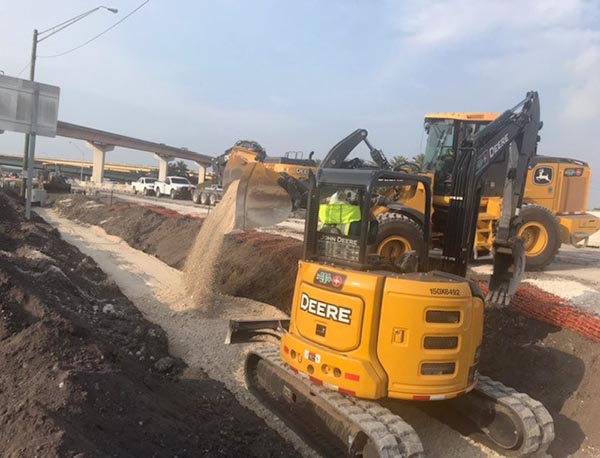

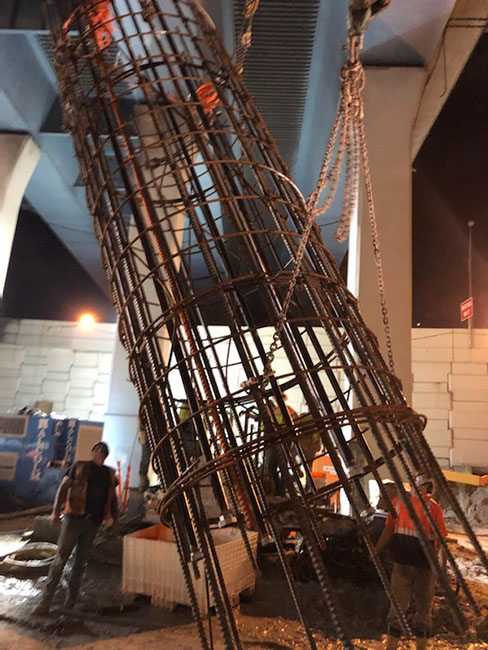

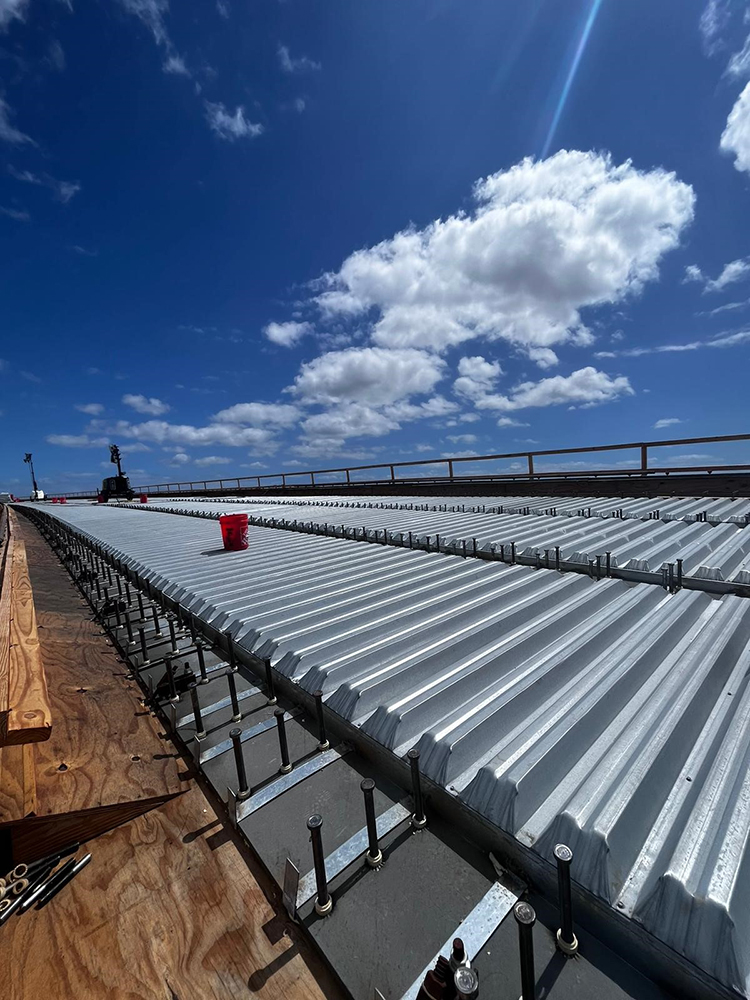

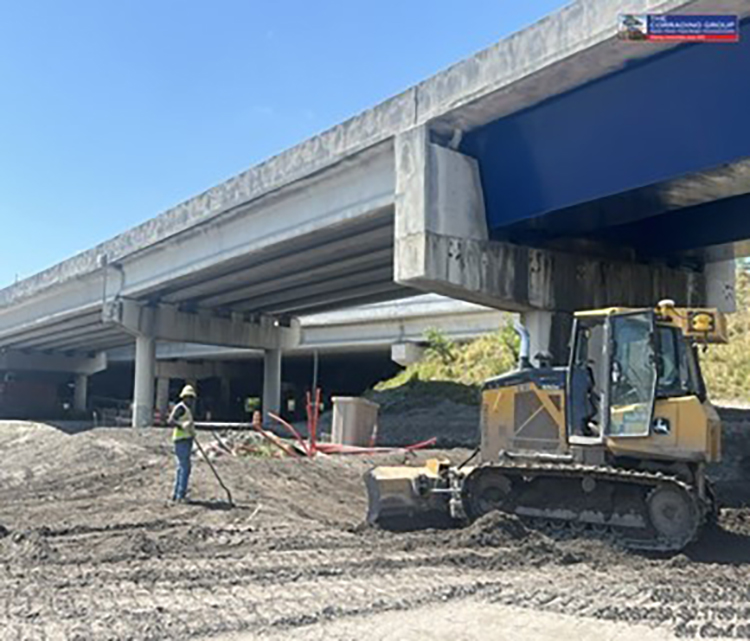

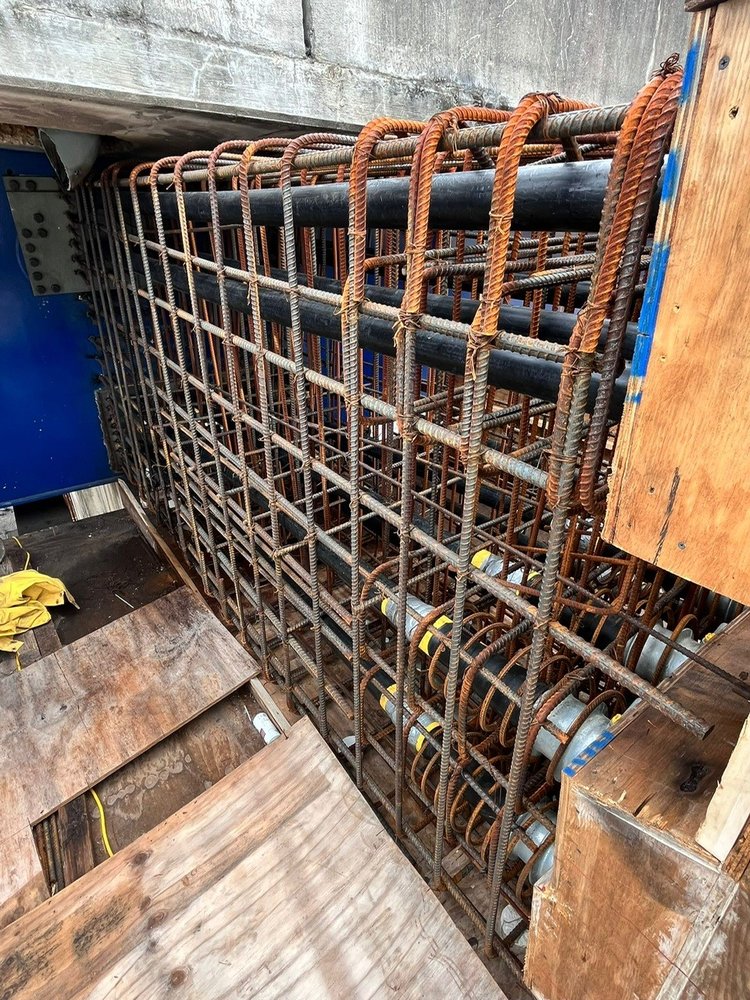

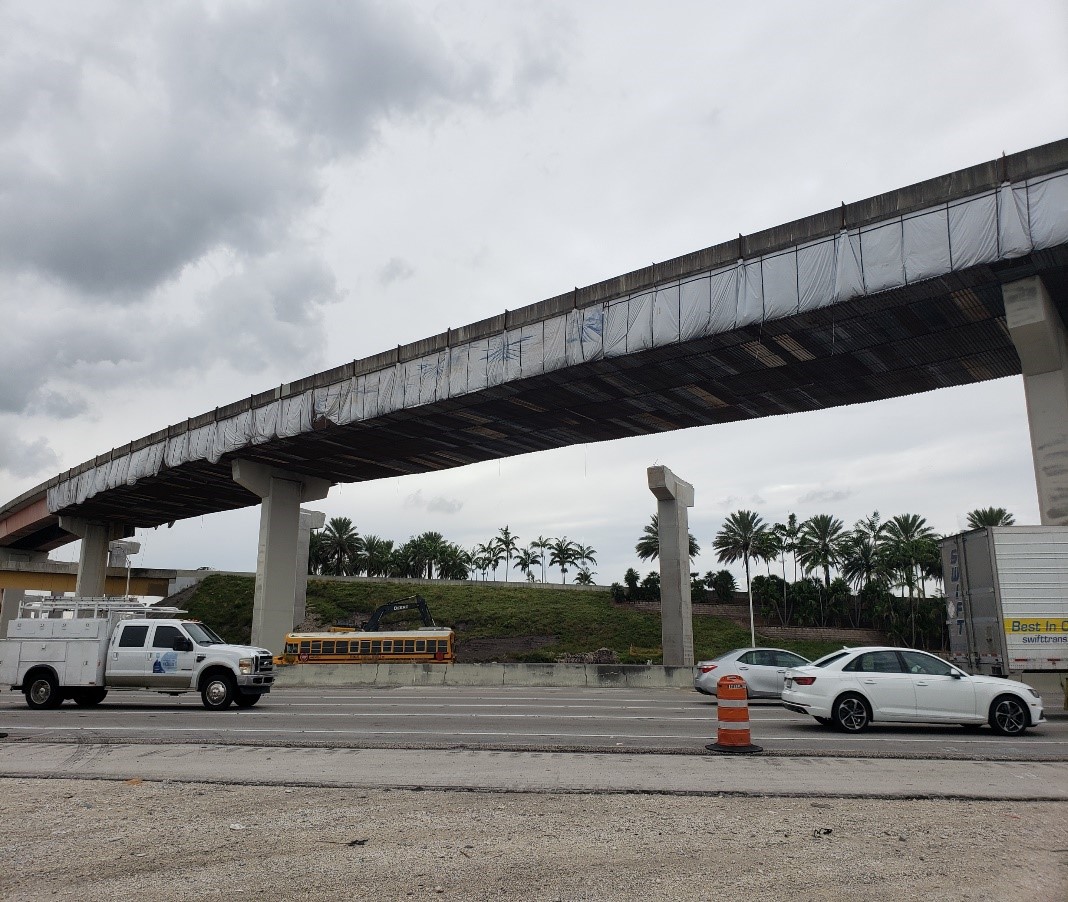

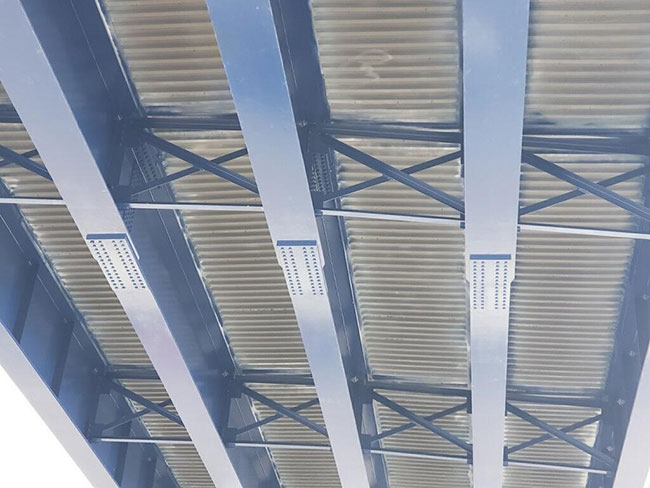

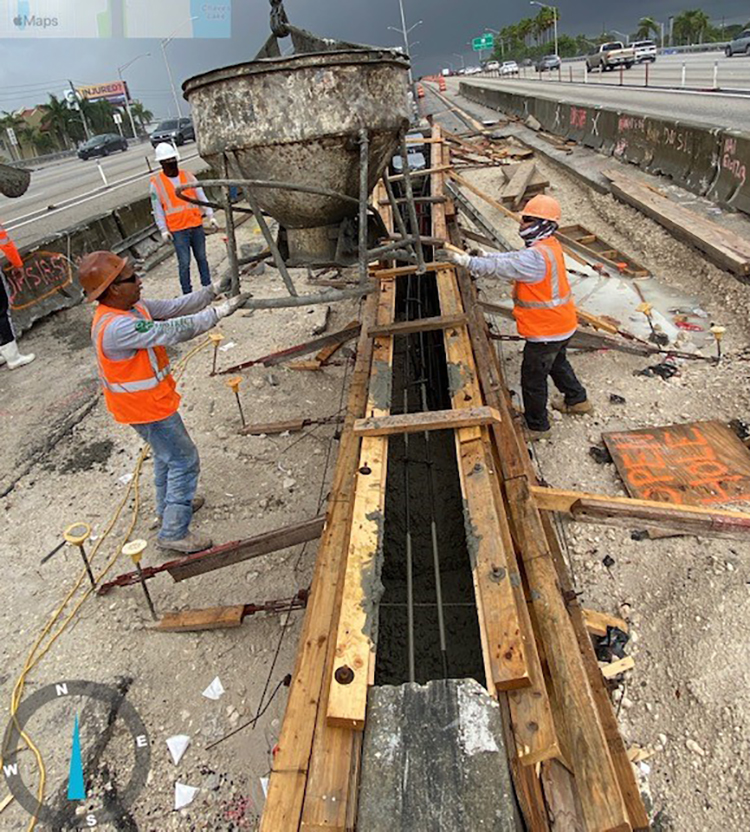

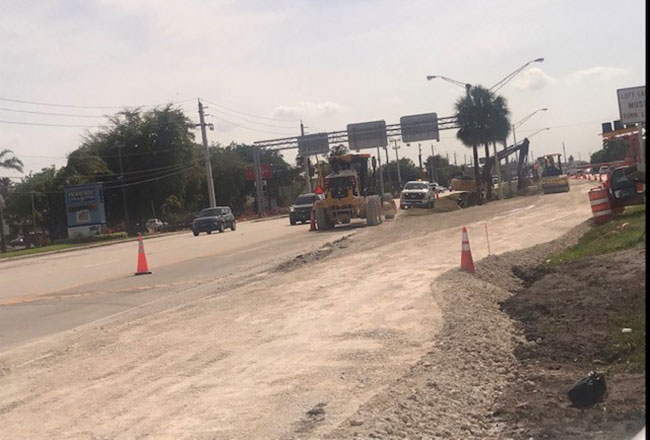

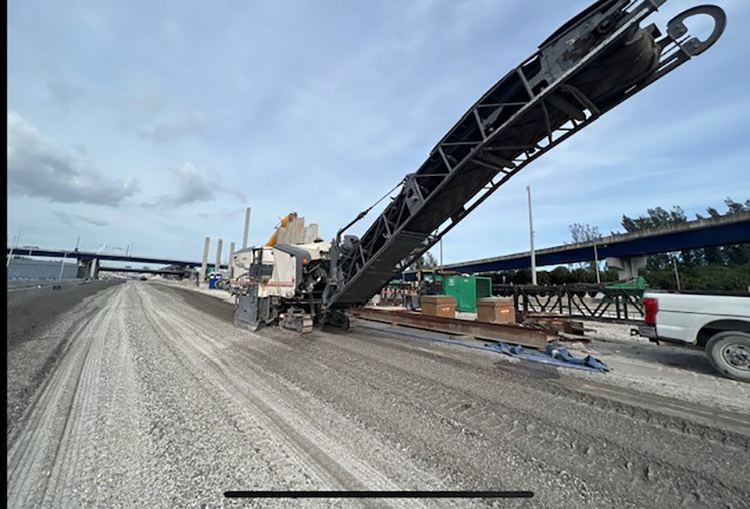

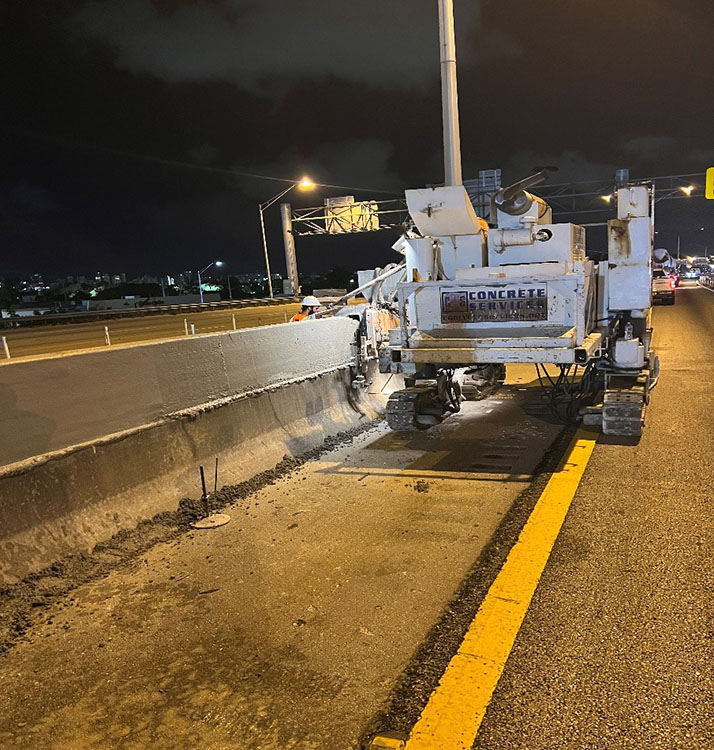

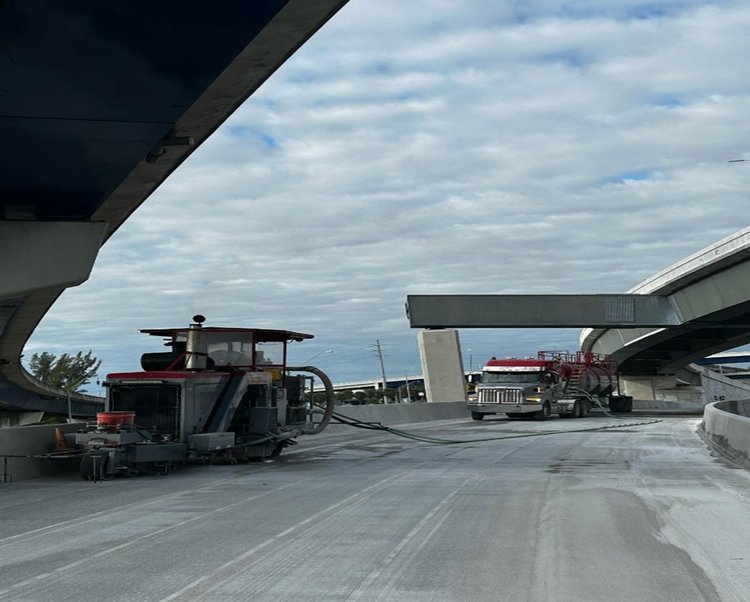

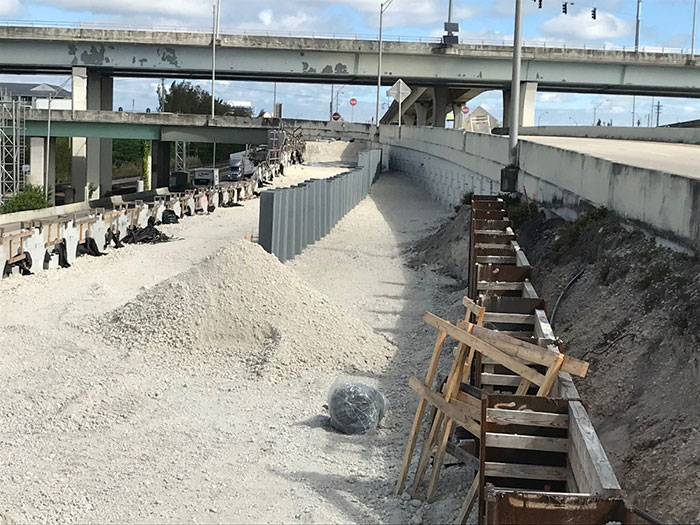

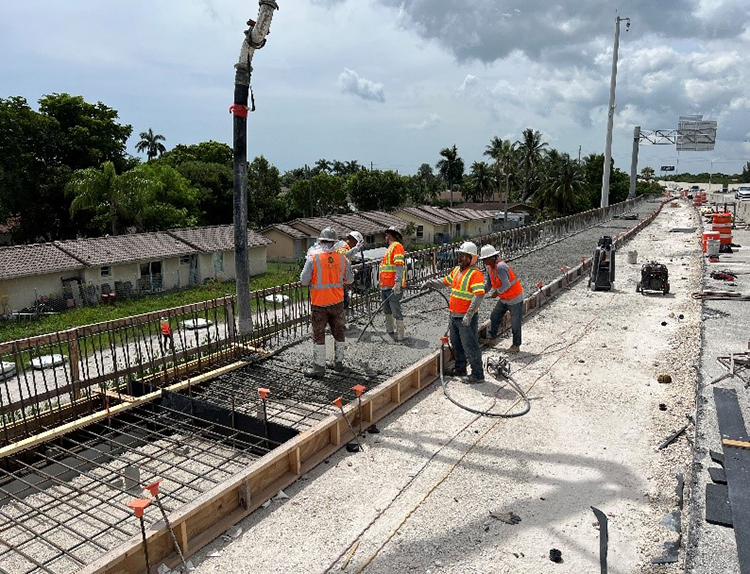

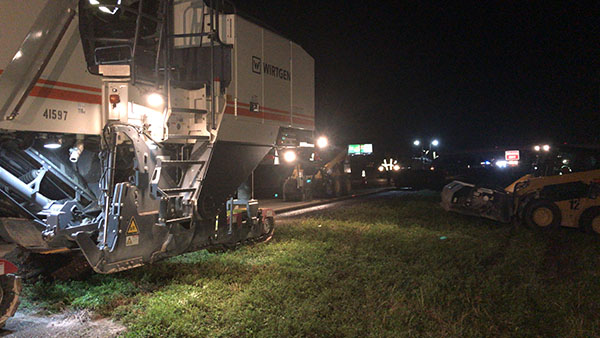

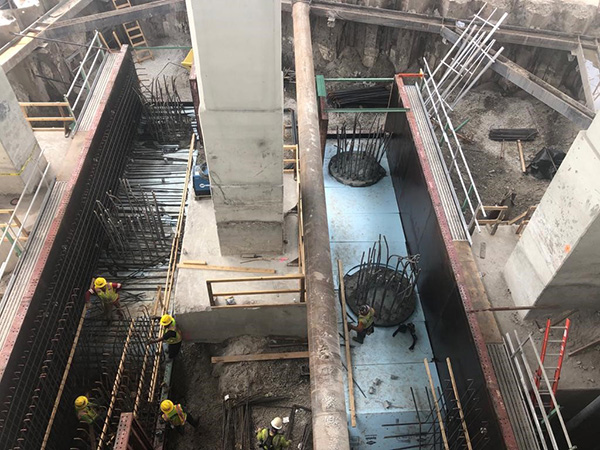

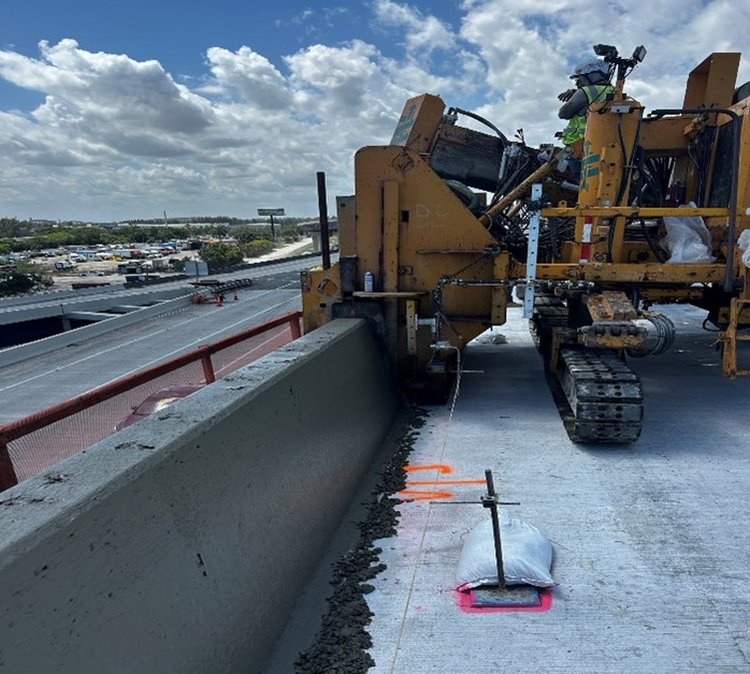

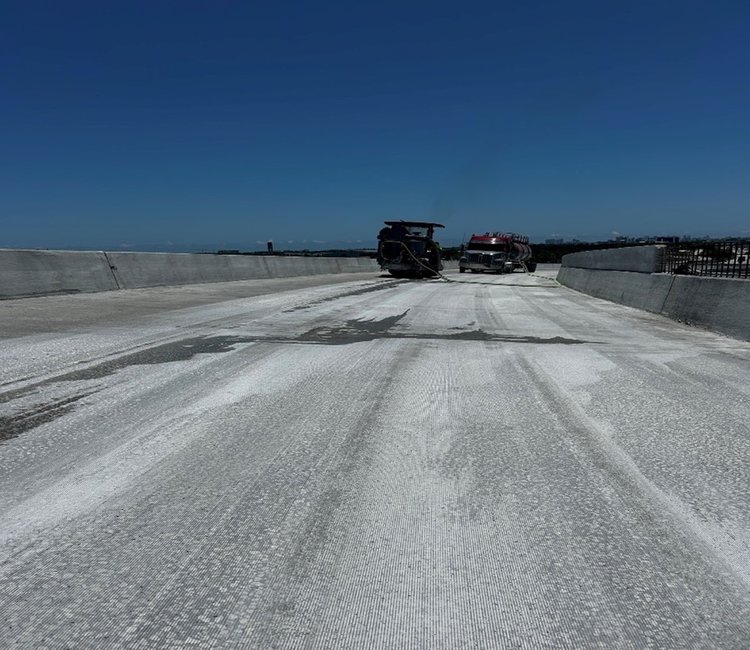

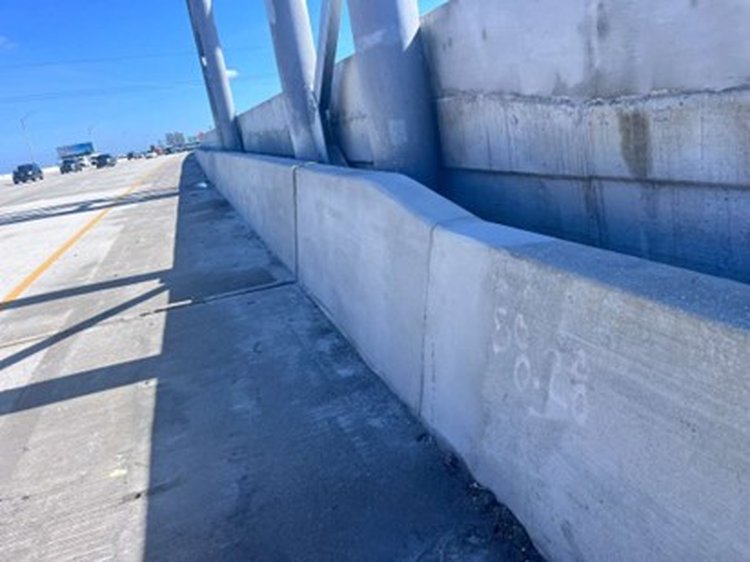

Retaining Wall 1 Construction on I 95 northbound at Hollywood Boulevard   February 2024 Bridge 26 (Pier 9 L) Column Construction   February 2024 Drilled shaft OH 85 construction for pro posed overhead signs – February 2024 Milling and resurfacing operations along I 95   February 2024

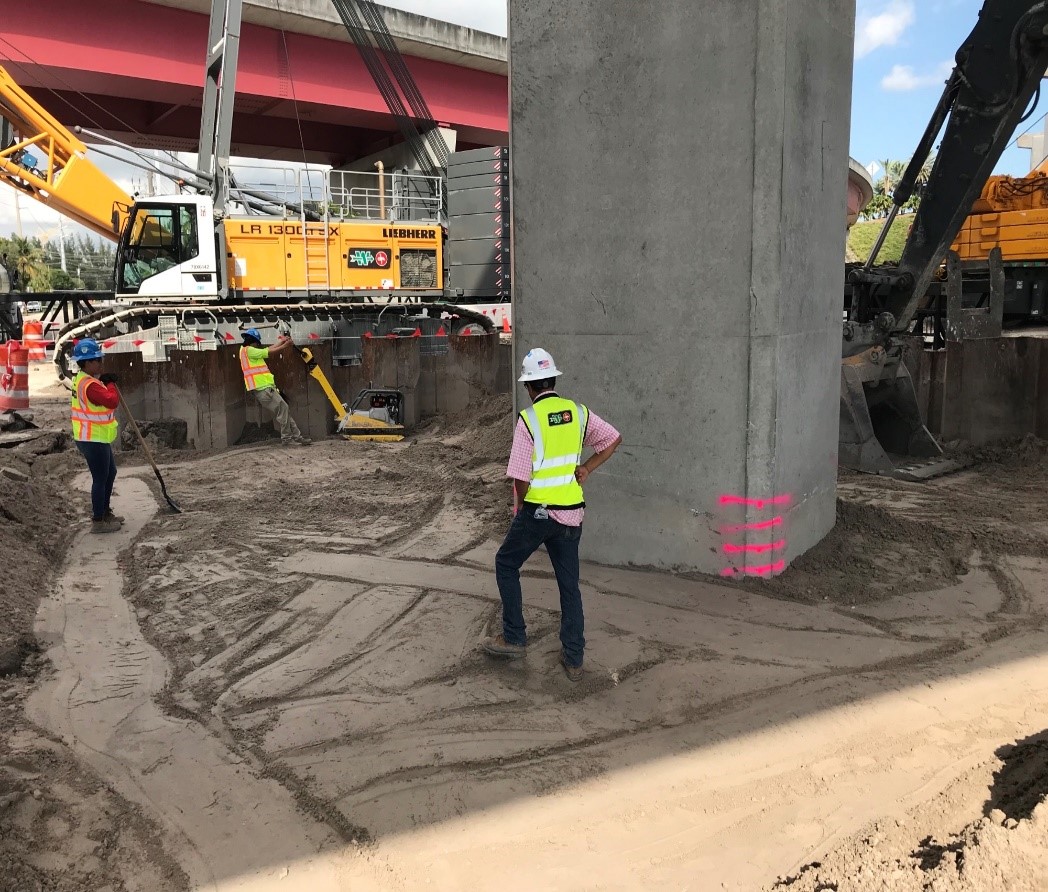

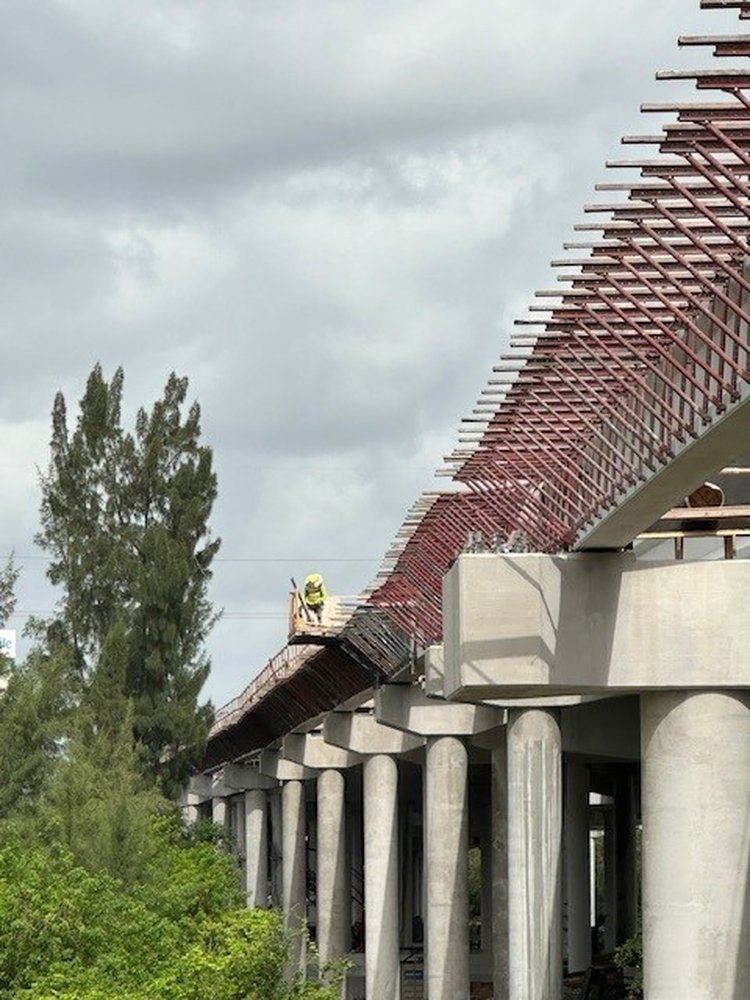

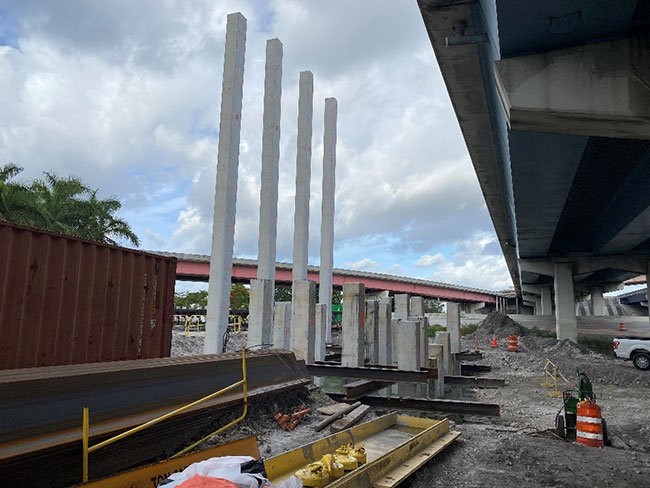

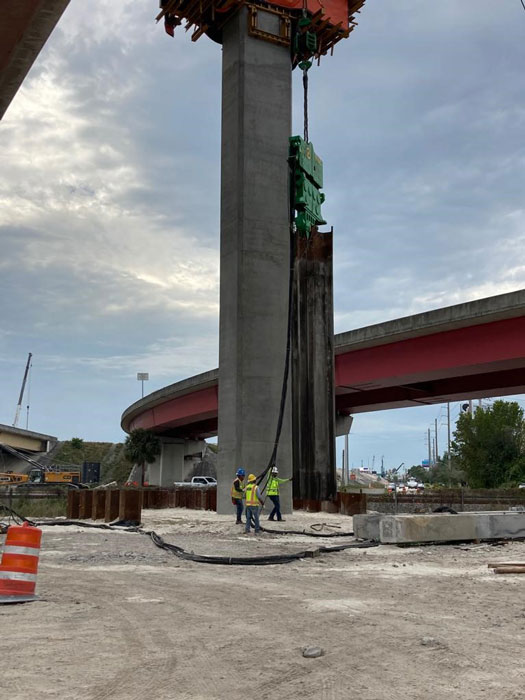

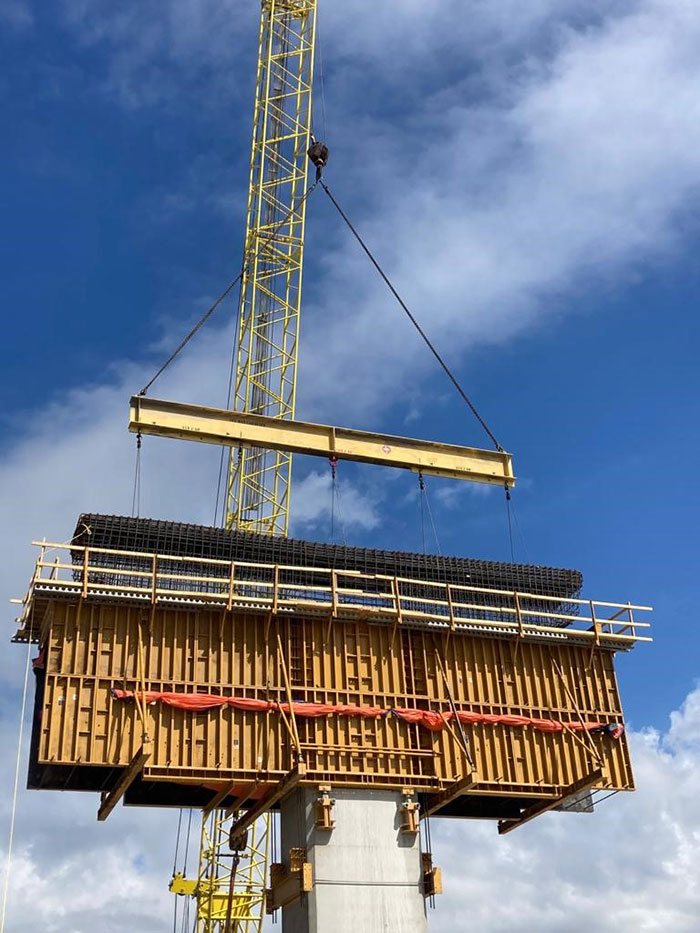

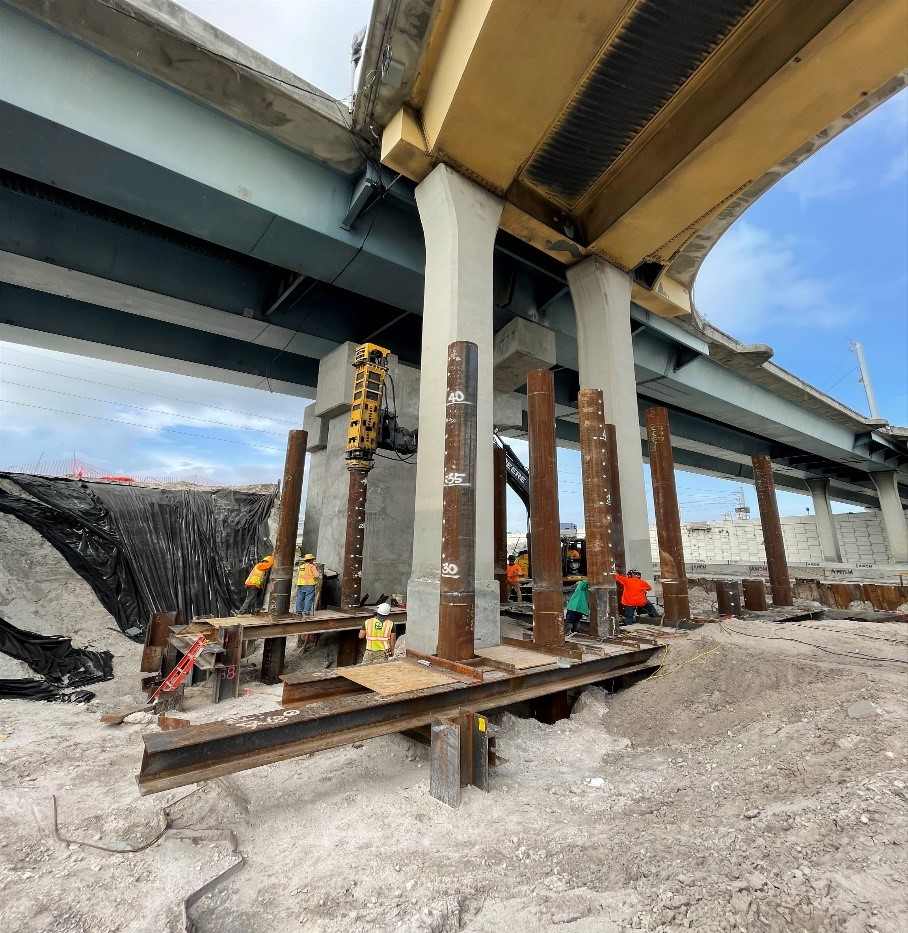

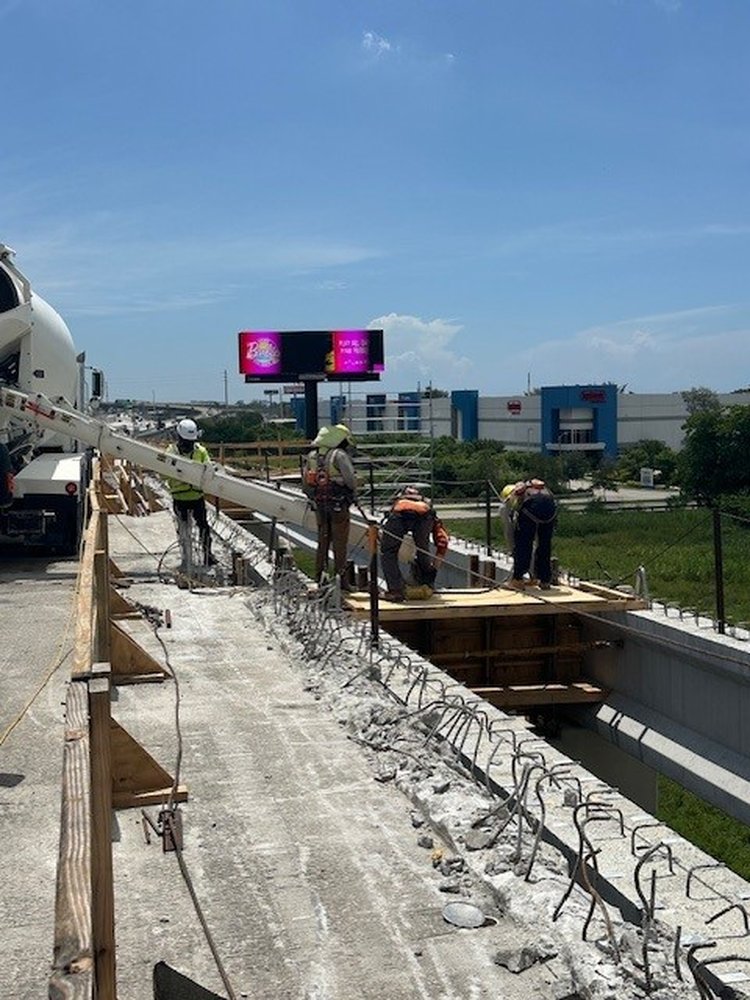

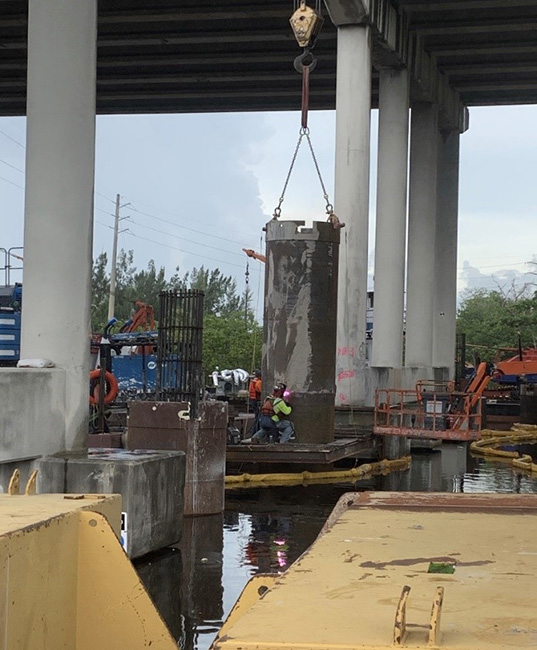

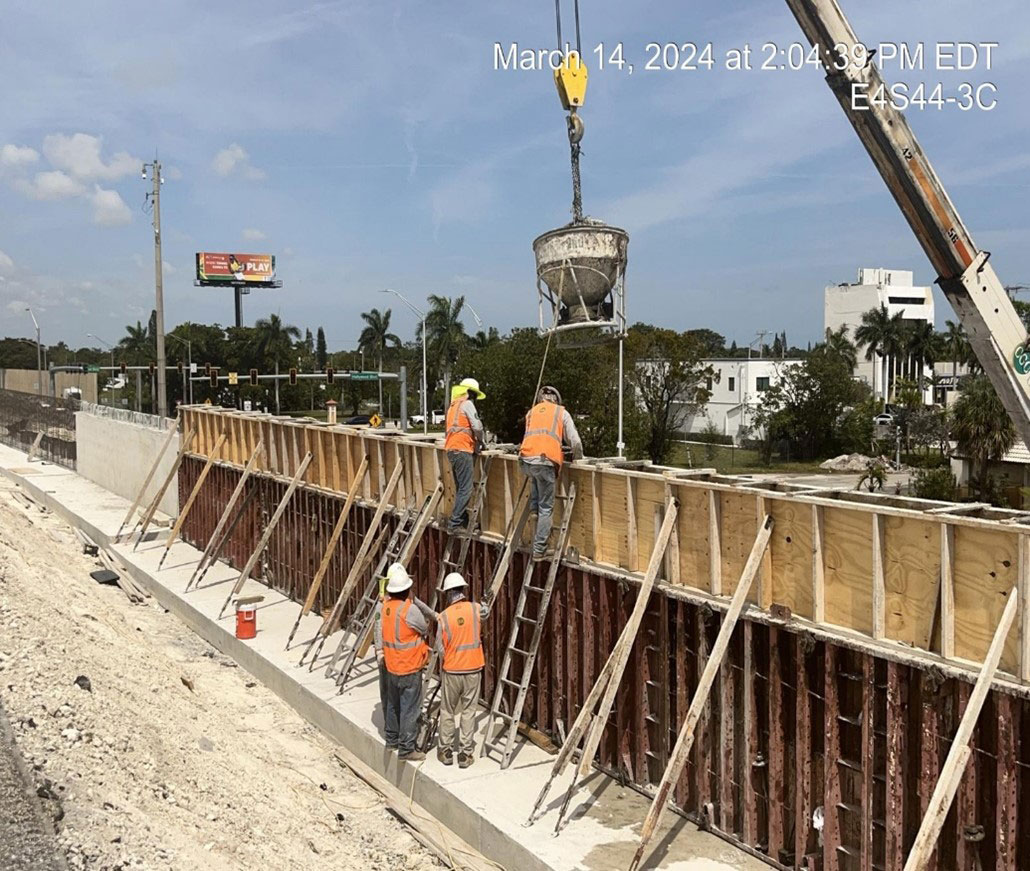

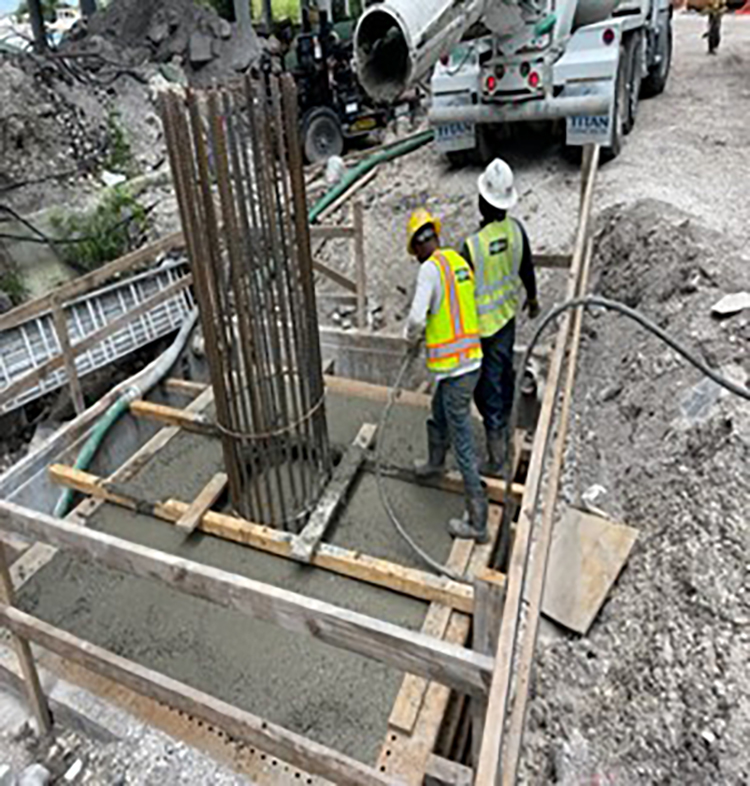

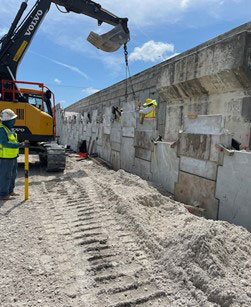

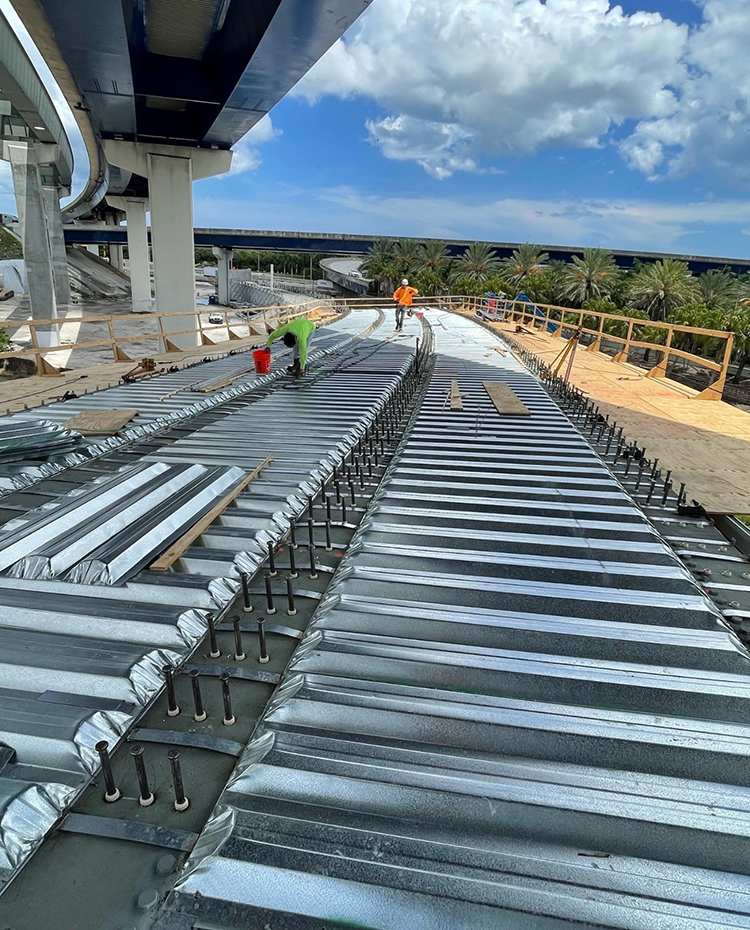

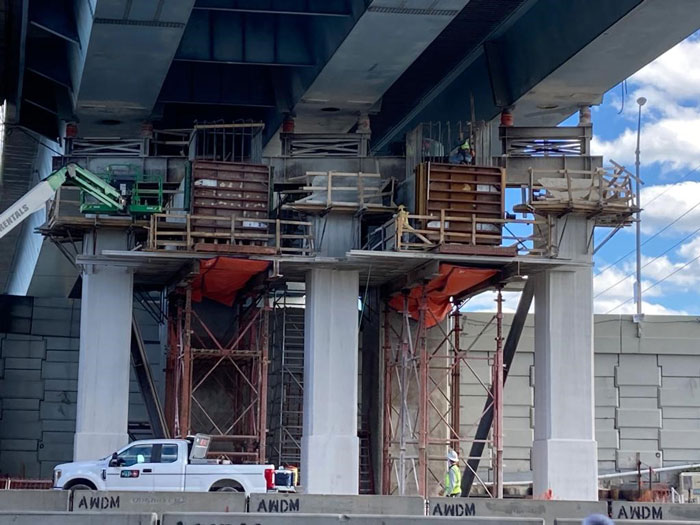

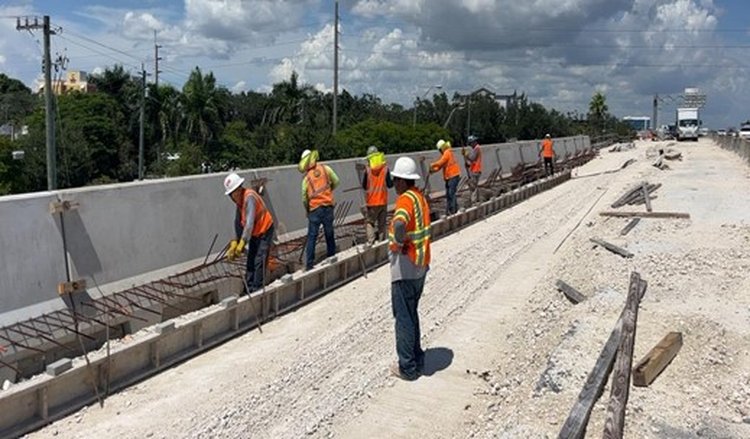

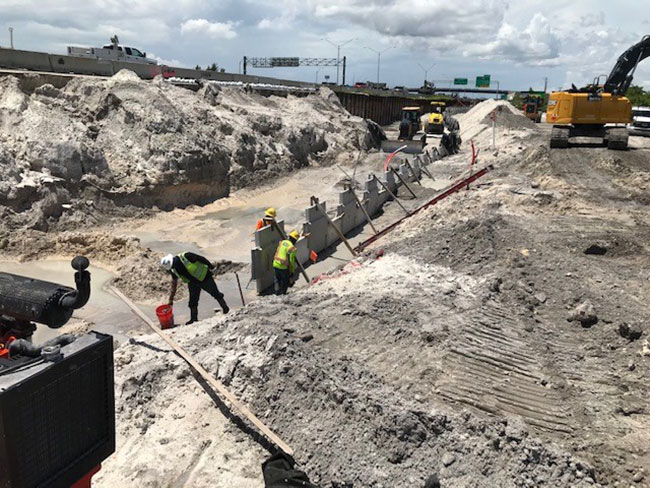

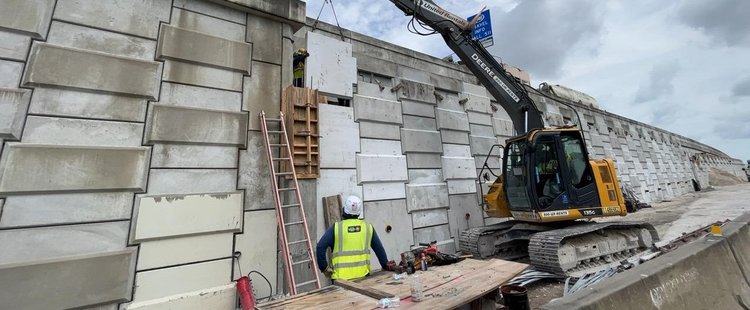

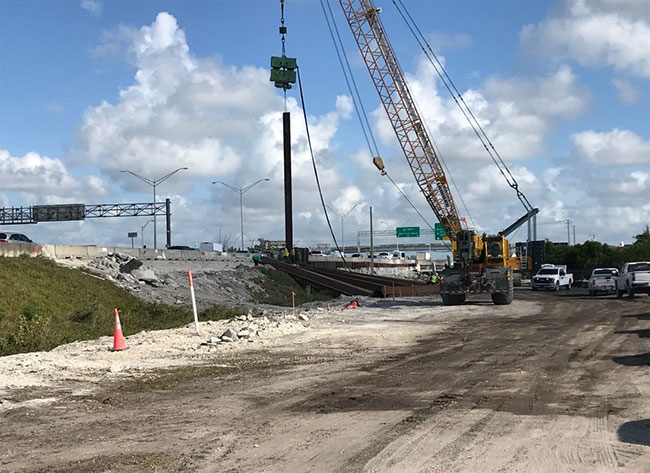

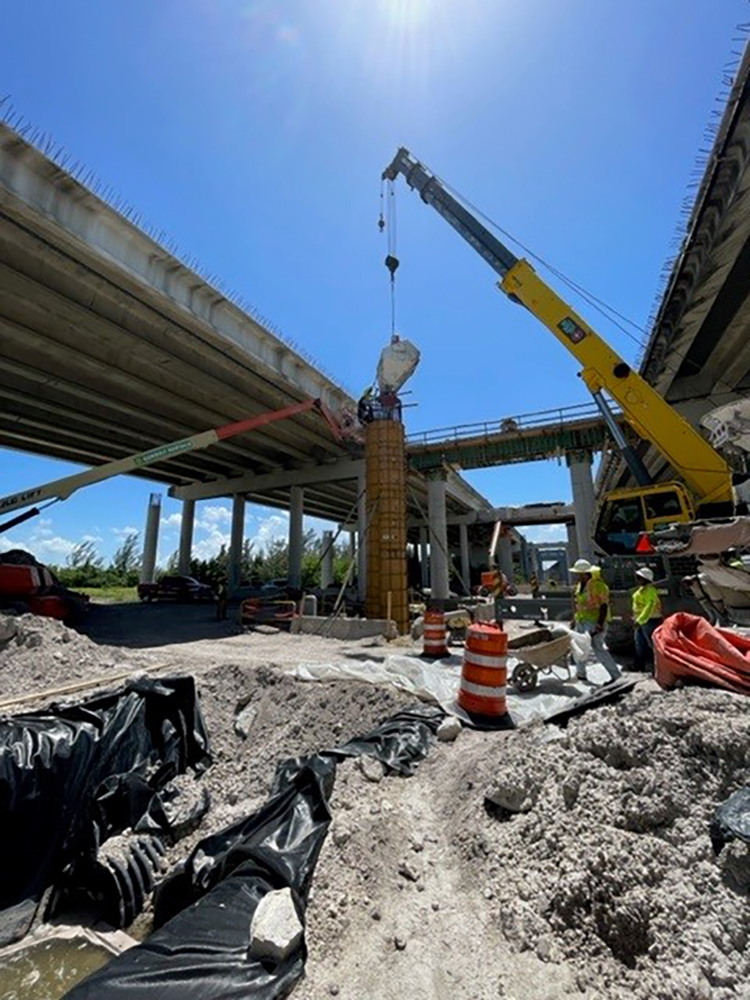

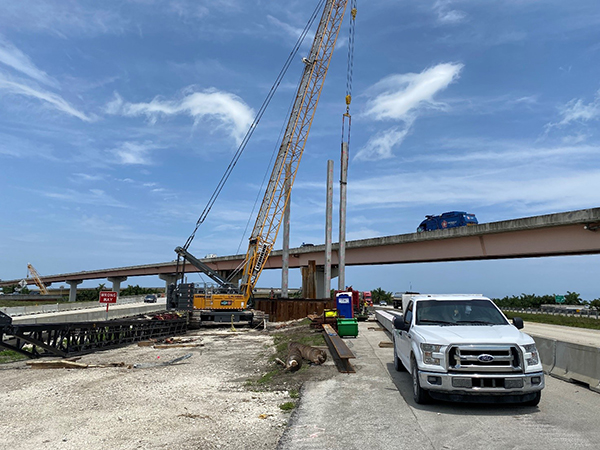

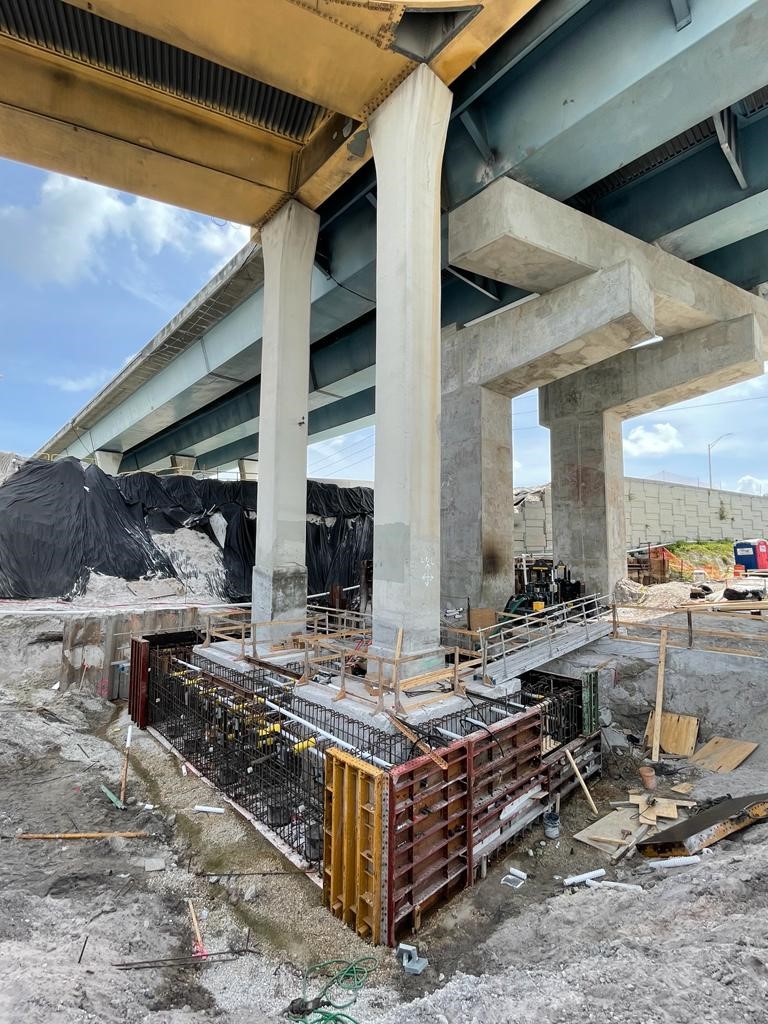

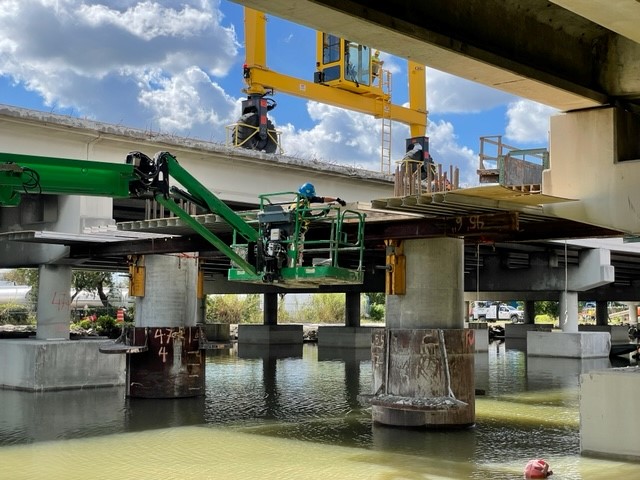

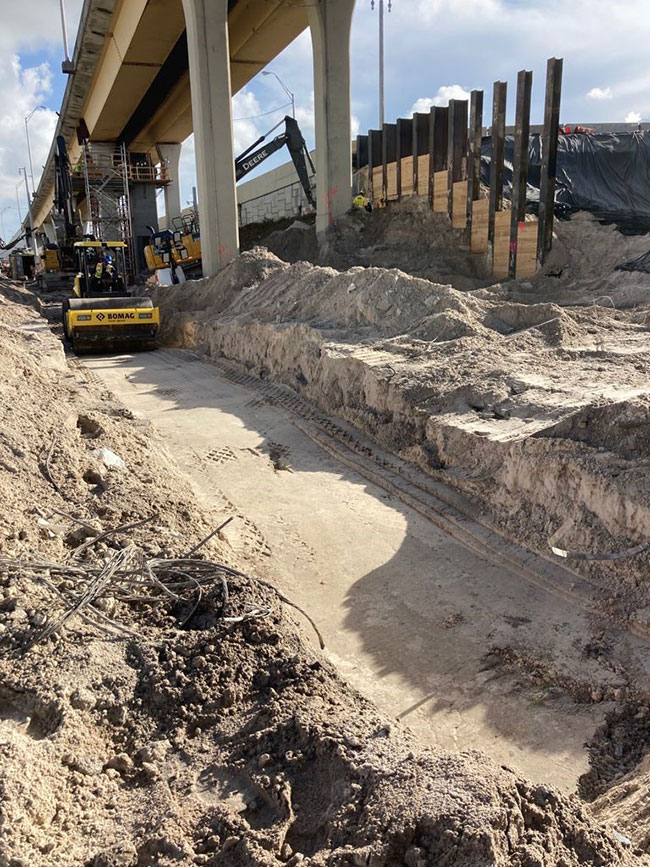

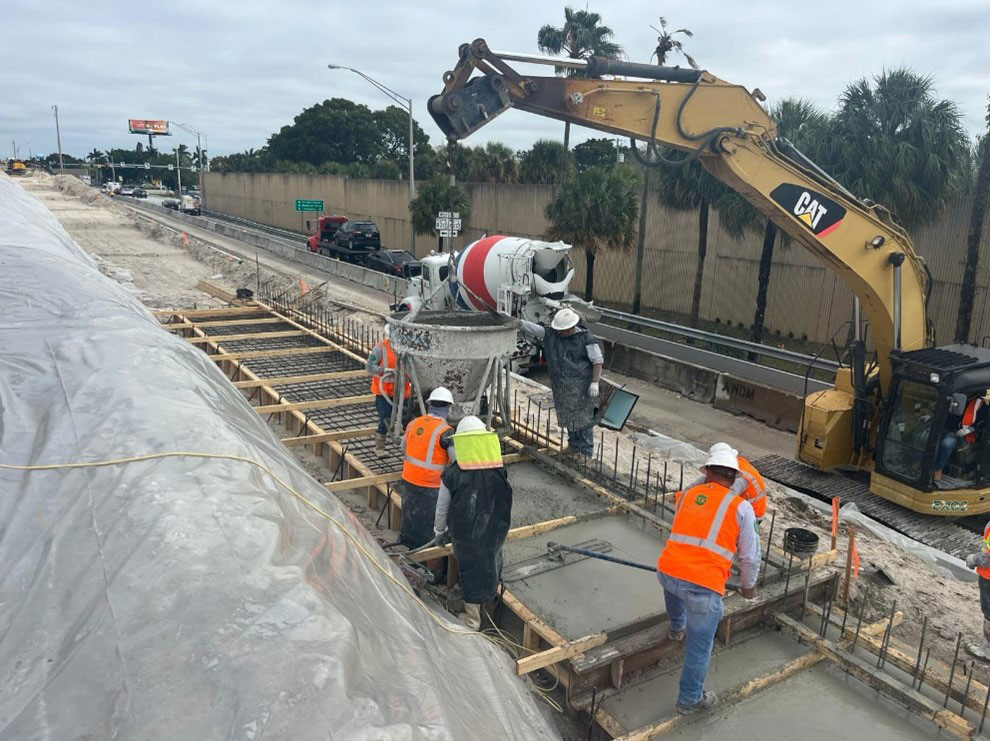

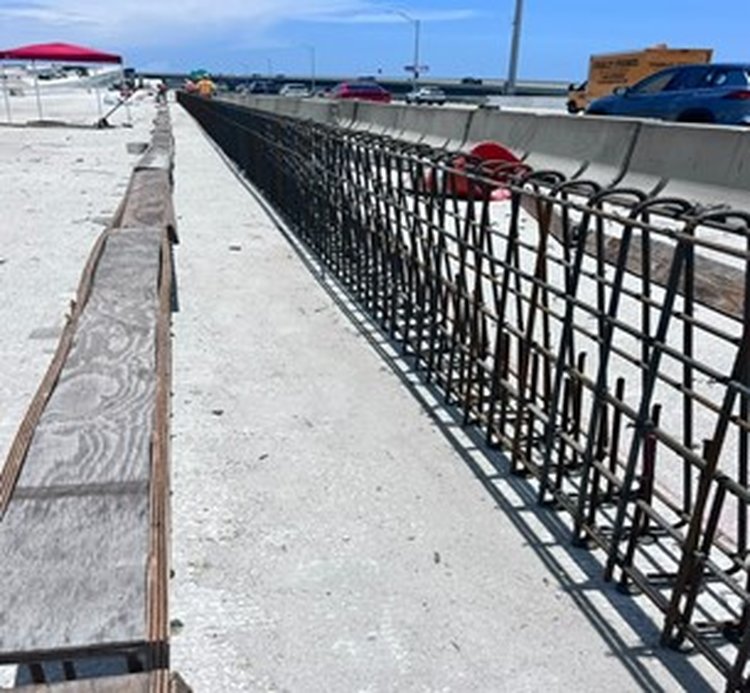

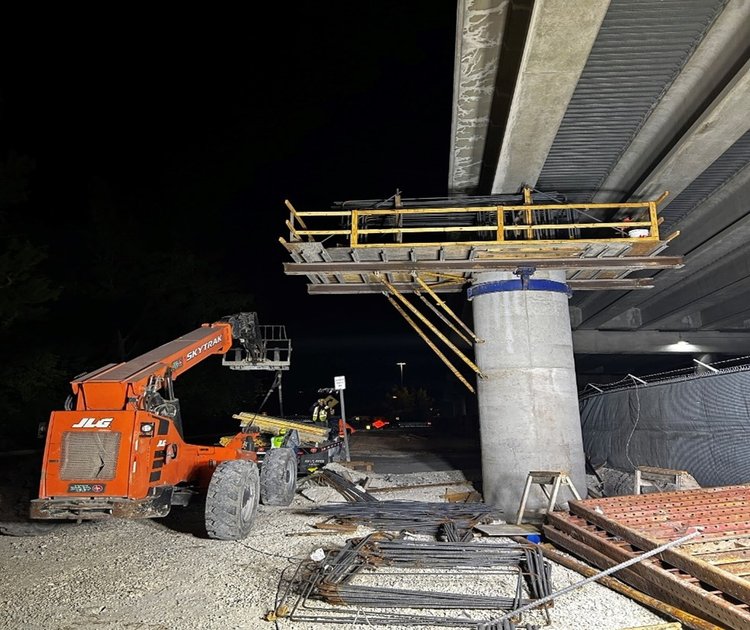

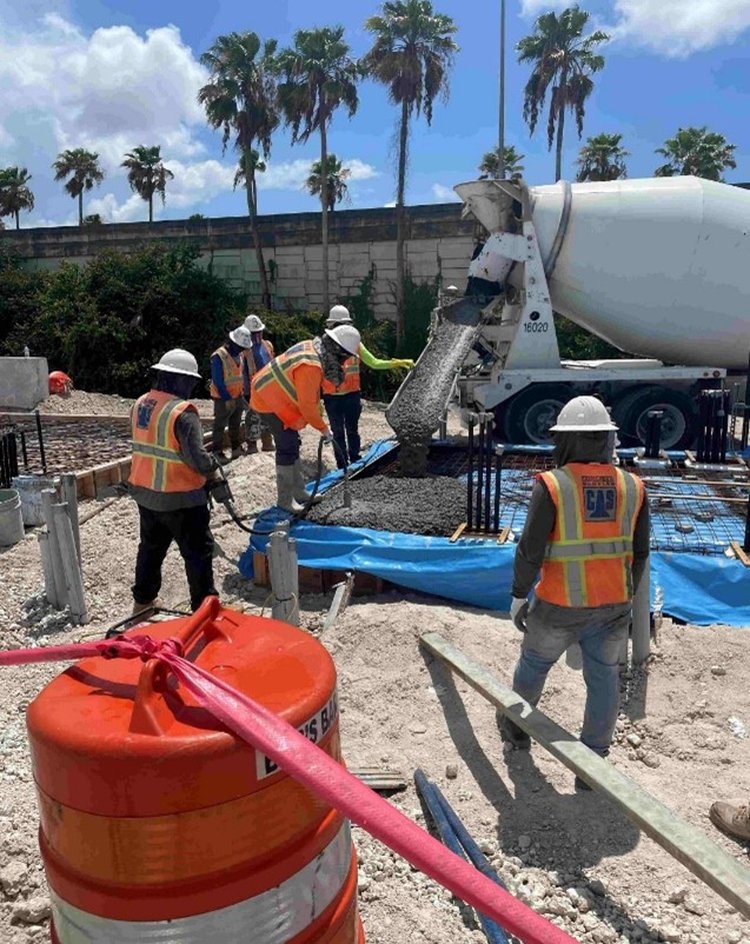

Bridge 13A structural steel installation along I 595   February 2024 I 95 Median Excavation for Barrier Wall Construction   March 2024 Bridge 13A Structural Steel Erection   March 2024 Retaining Wall No.1 Construction at Hollywood Blvd   March 2024

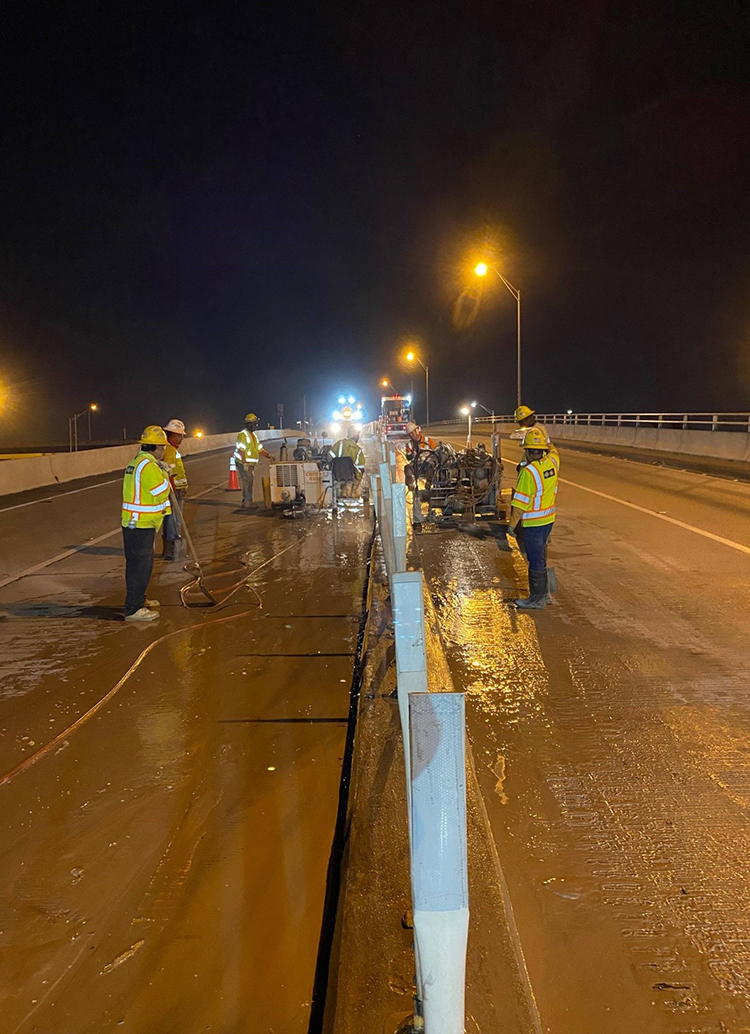

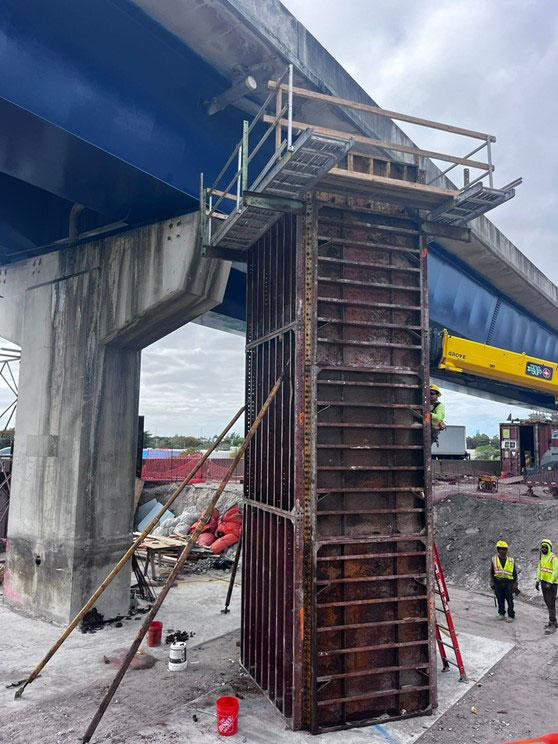

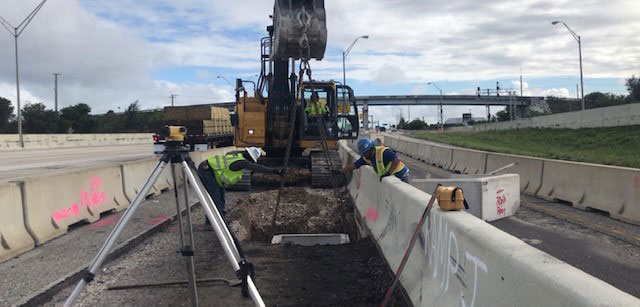

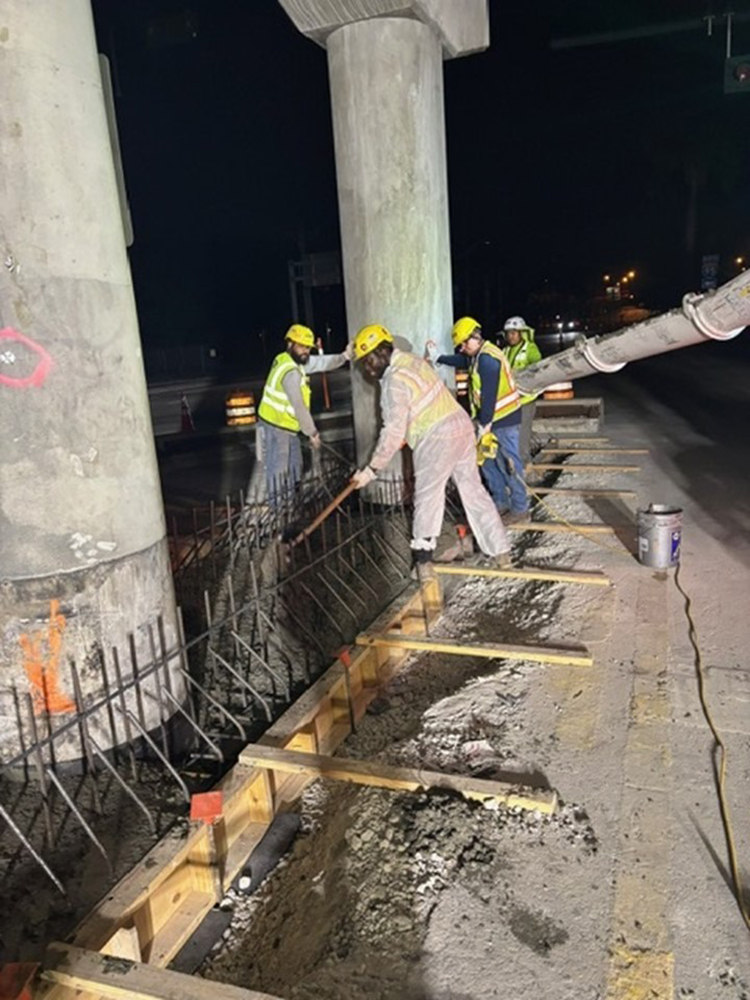

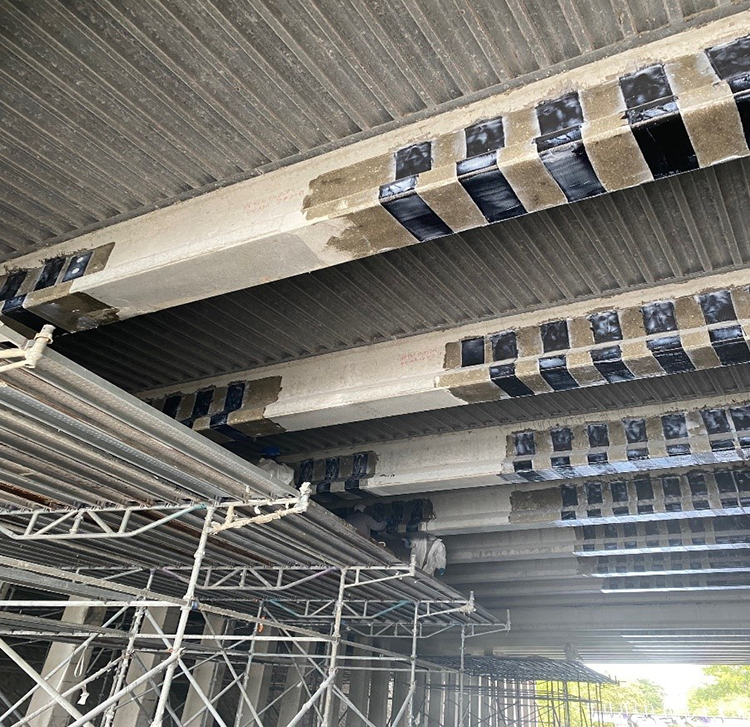

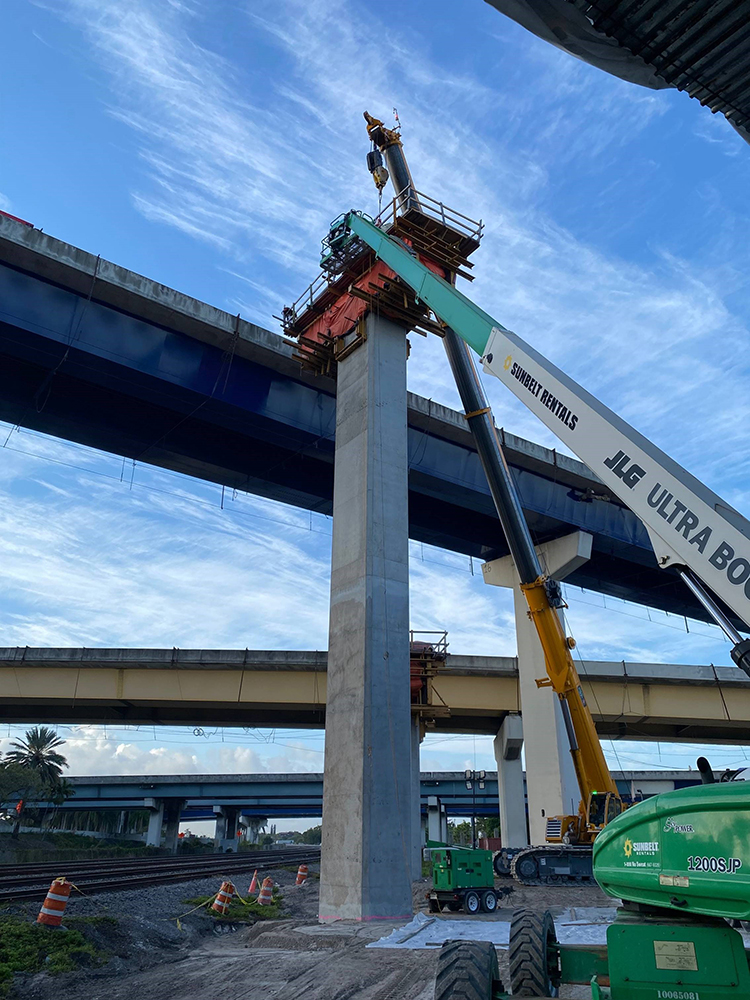

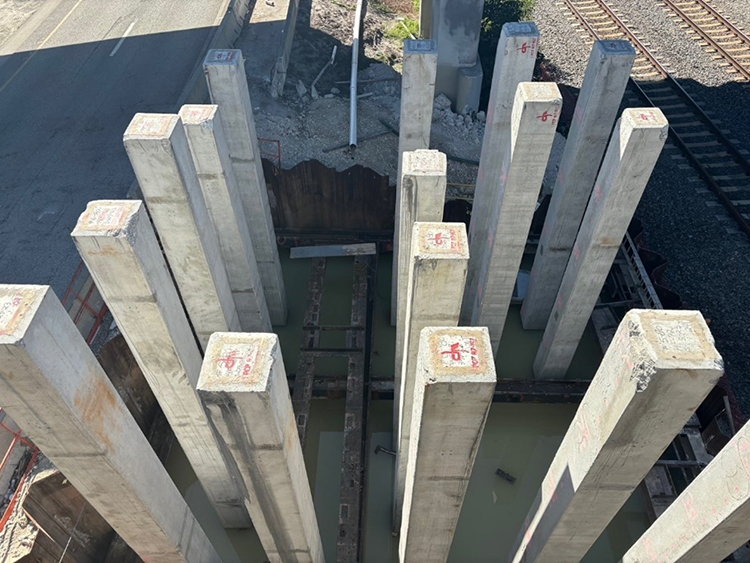

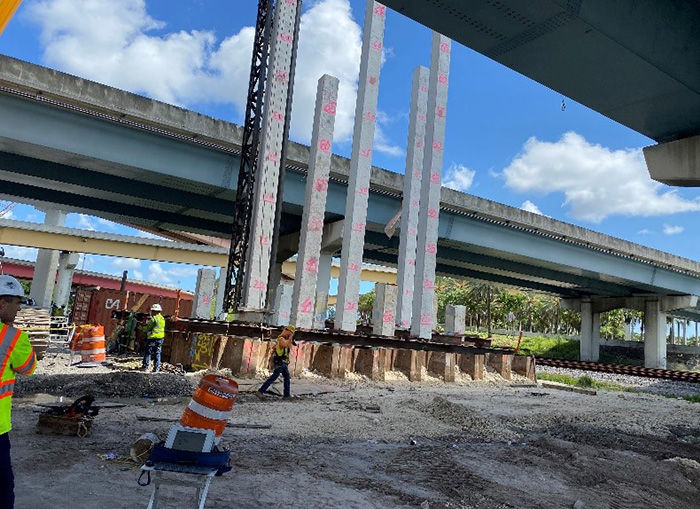

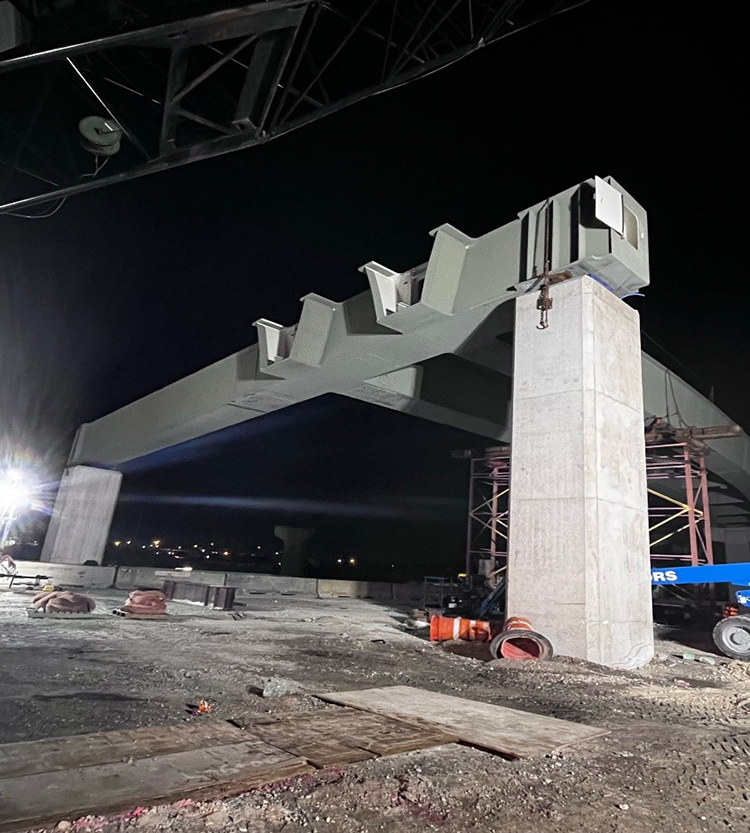

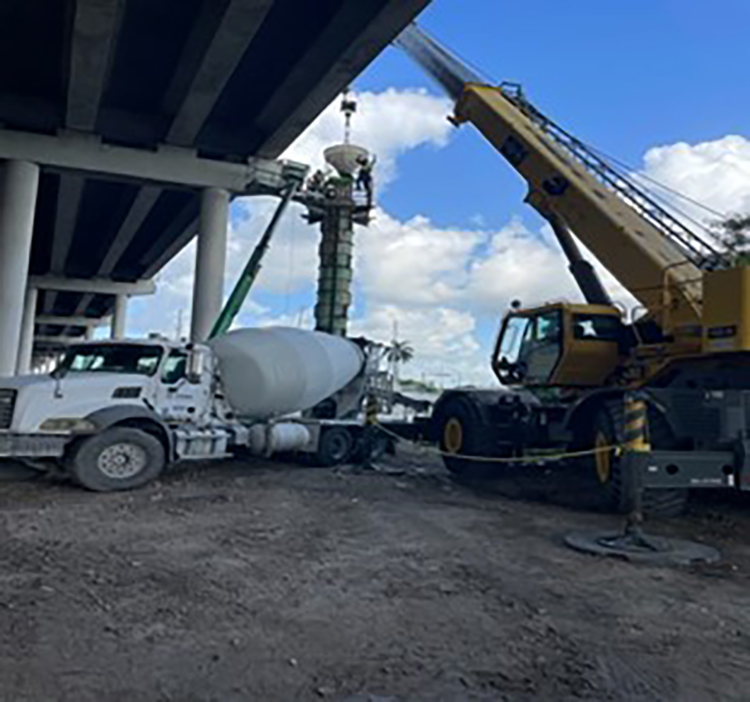

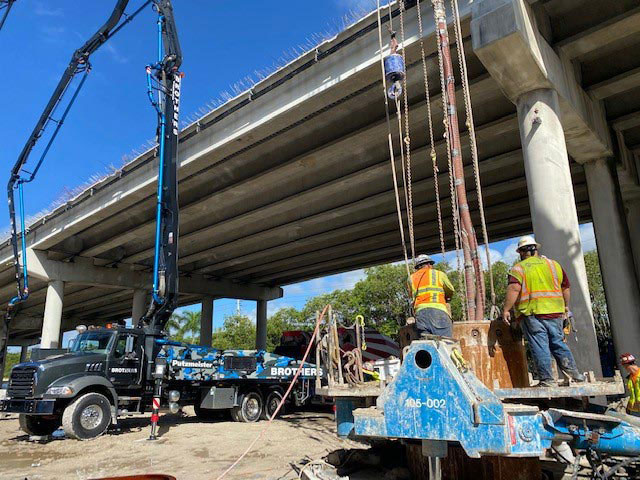

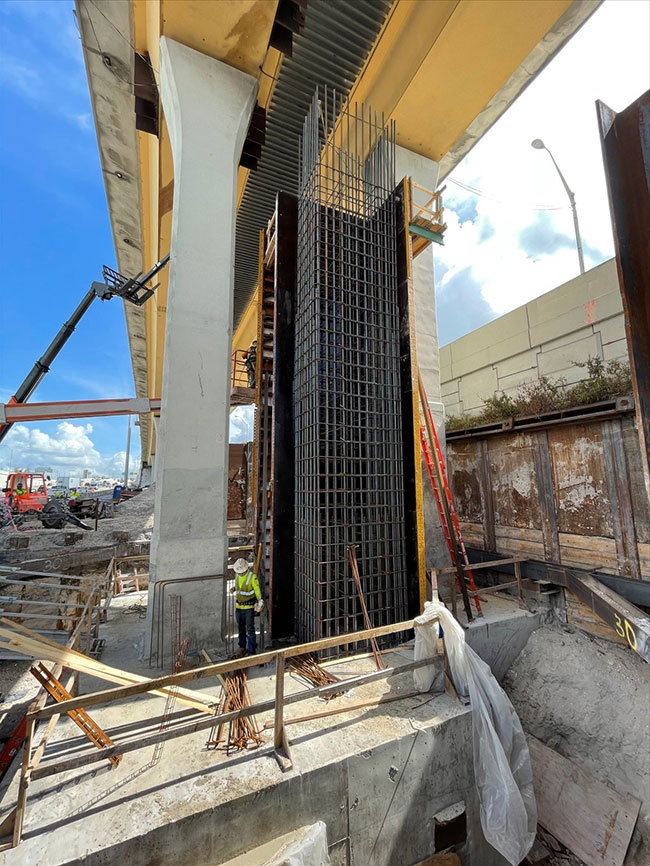

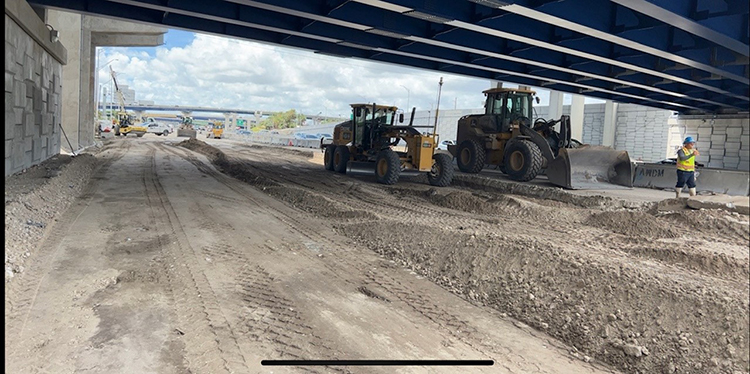

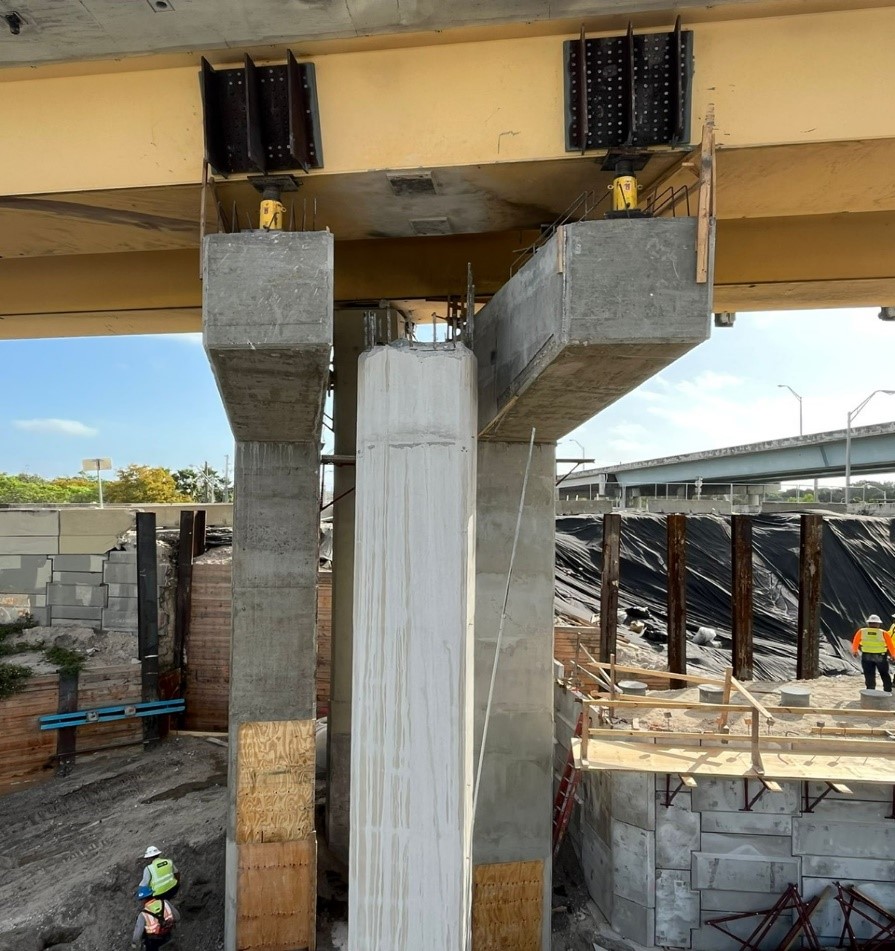

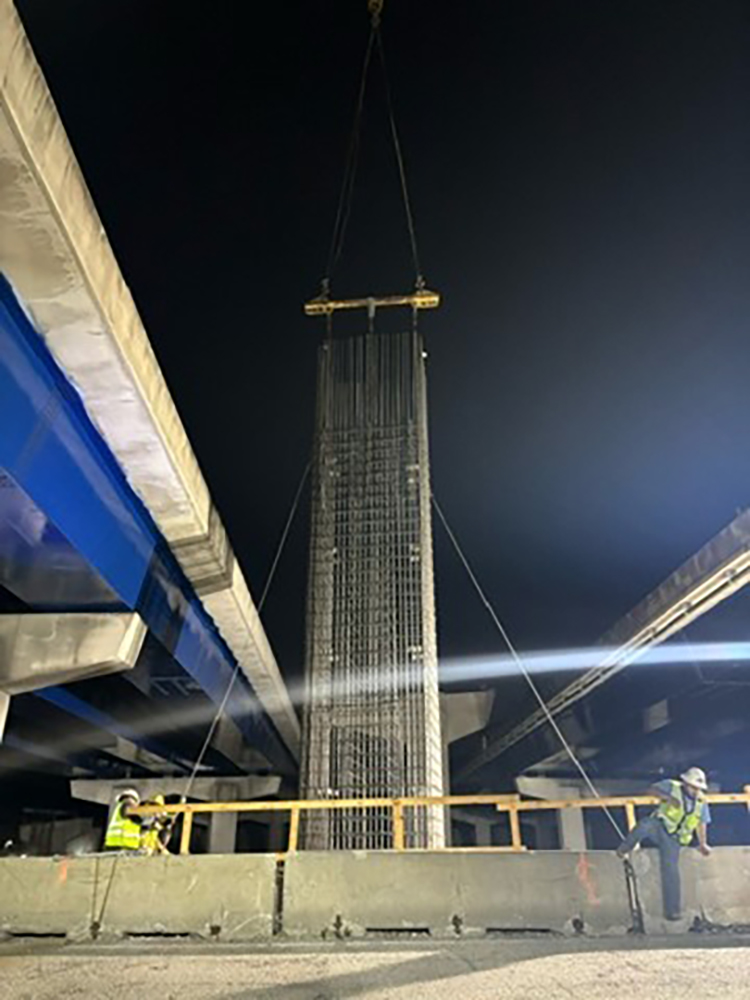

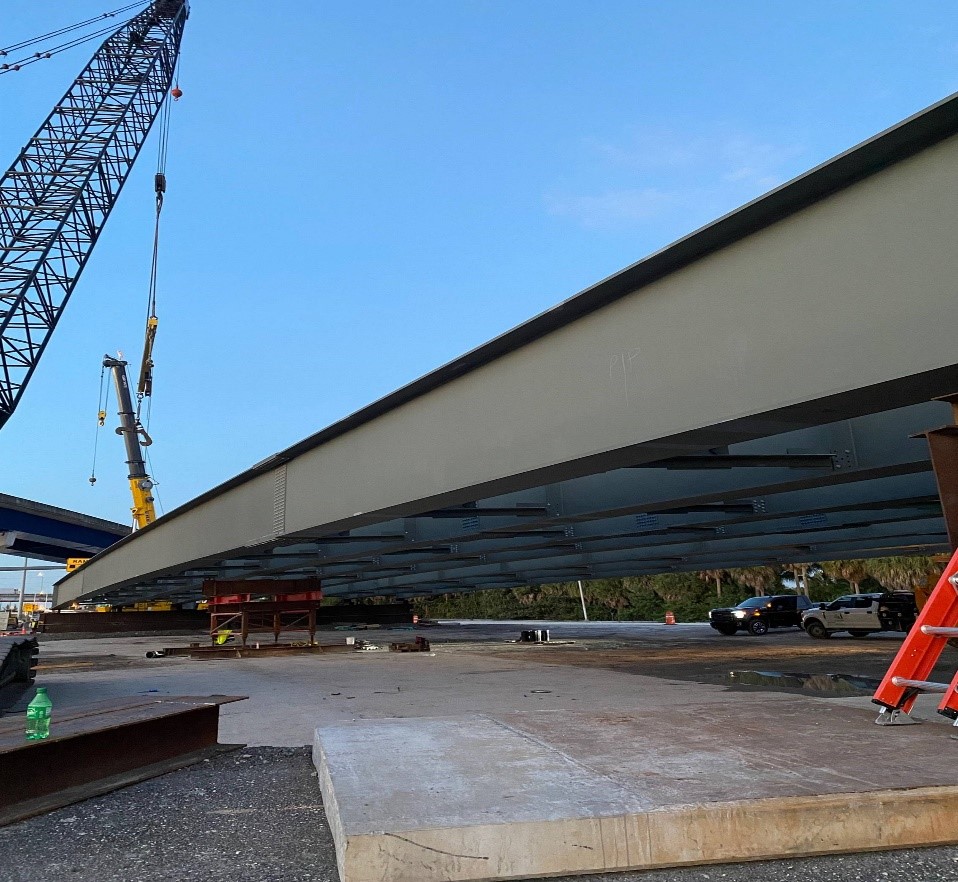

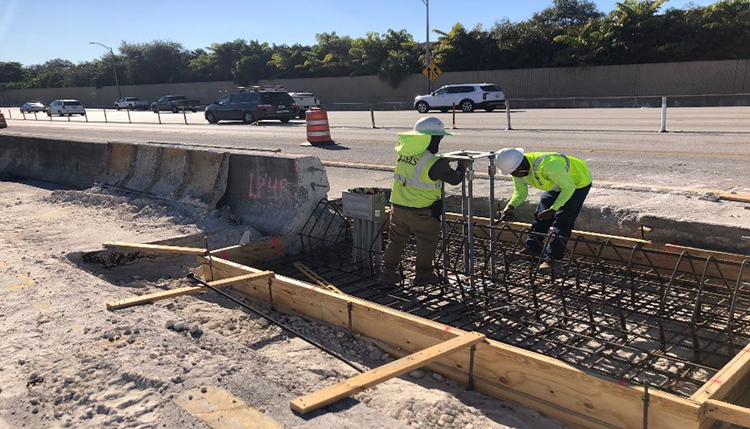

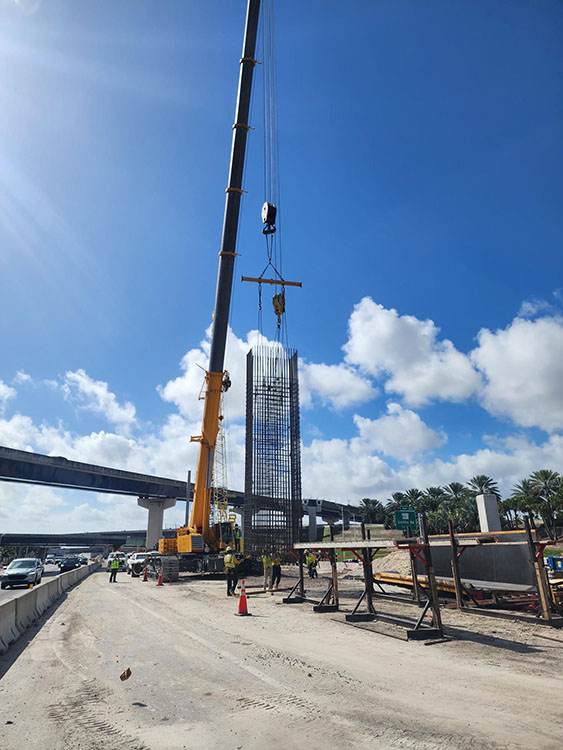

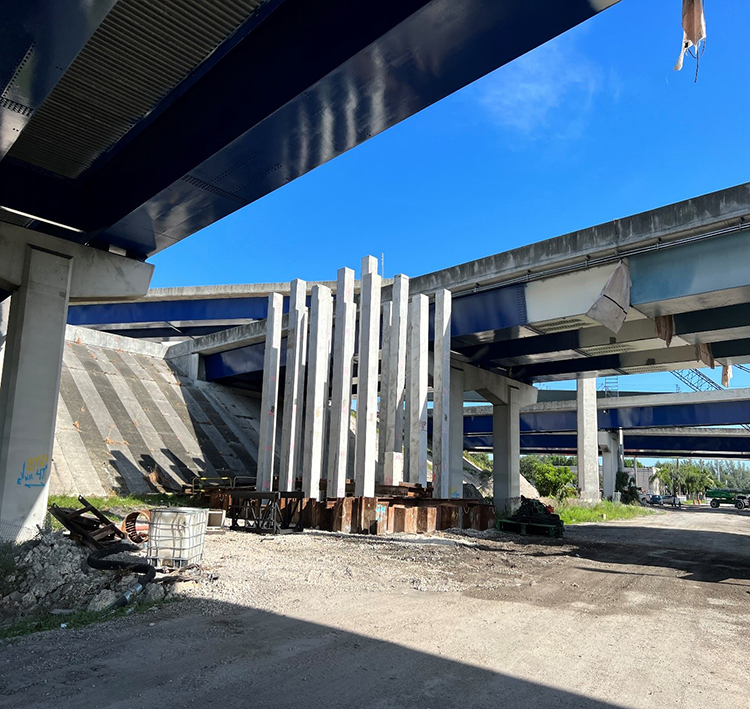

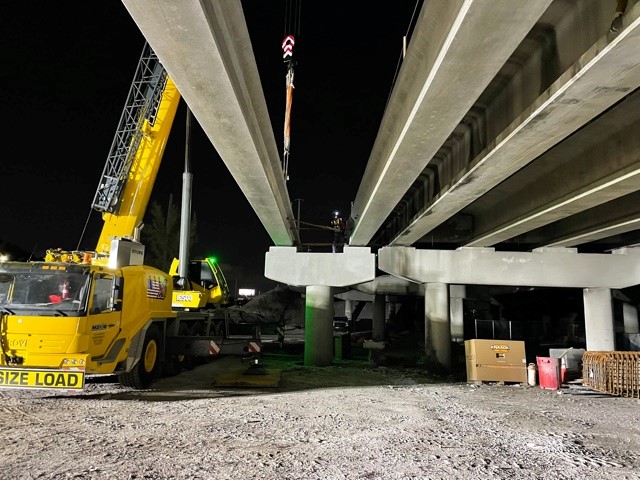

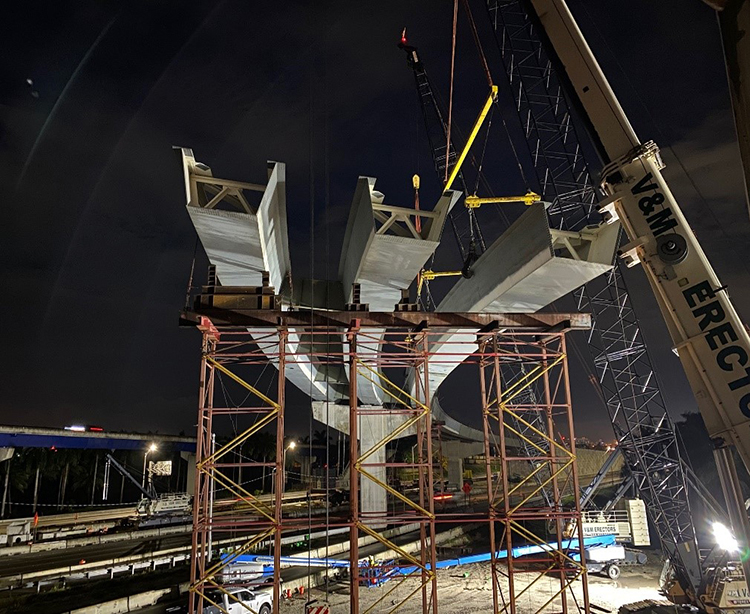

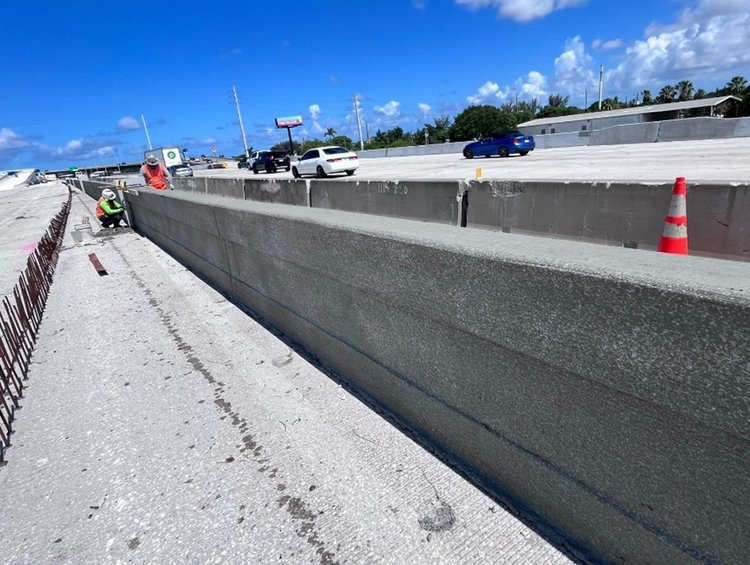

Bridge 14 Pier 5   Footing Construction   March 2024 Bridge 8 NB beams   March 2024 Bridge 13A  Structural Steel Erection   March 2024 MSE Wall Construction Along I 95   March 2024

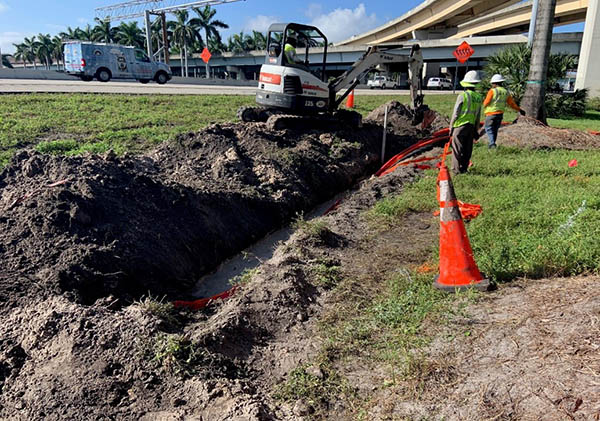

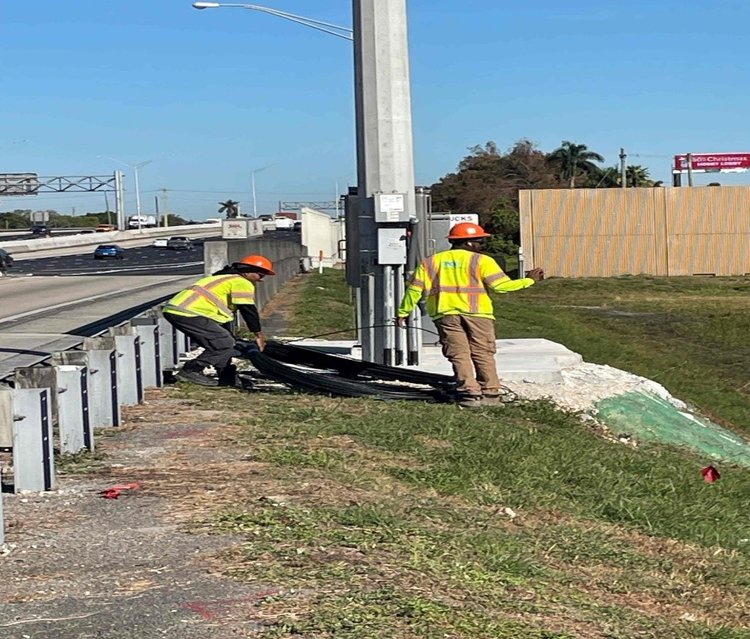

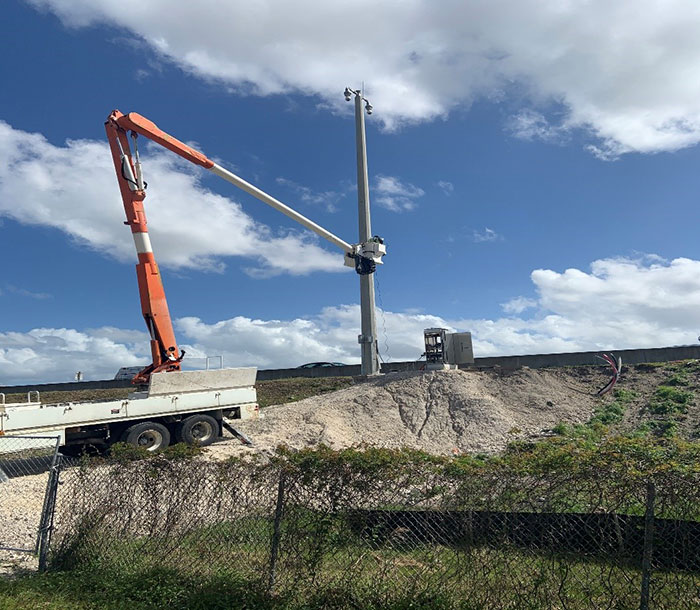

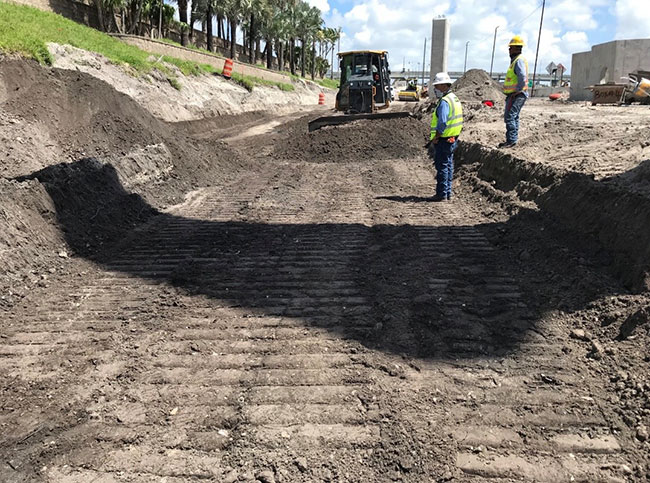

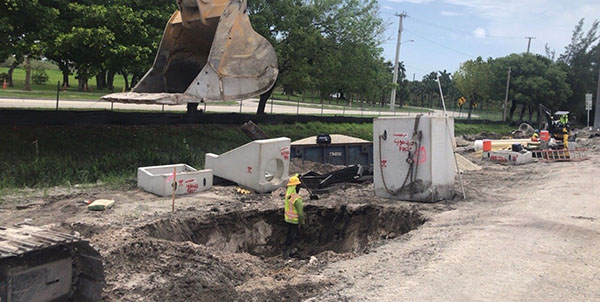

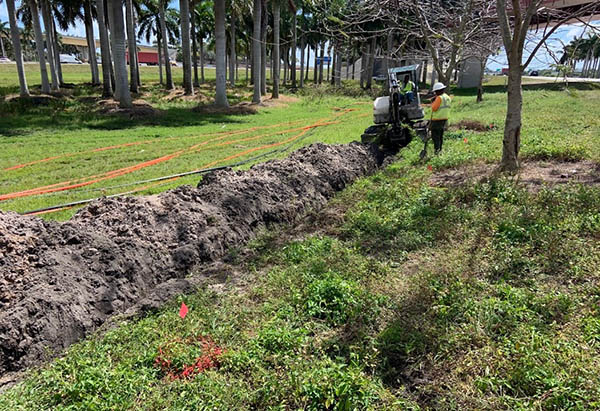

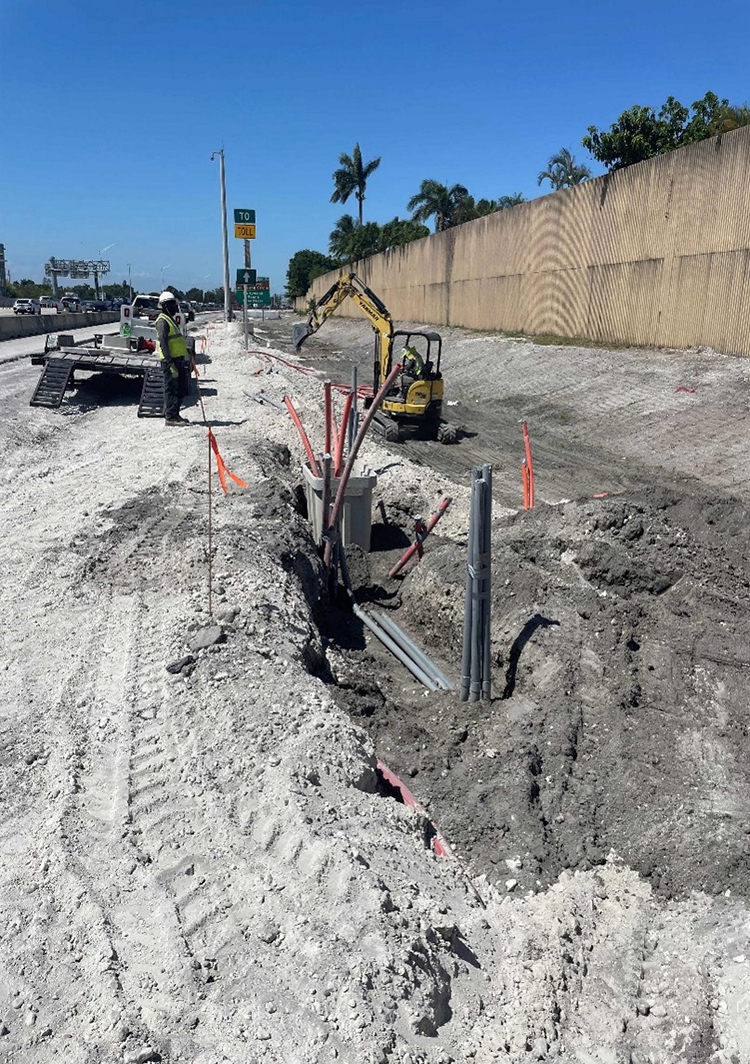

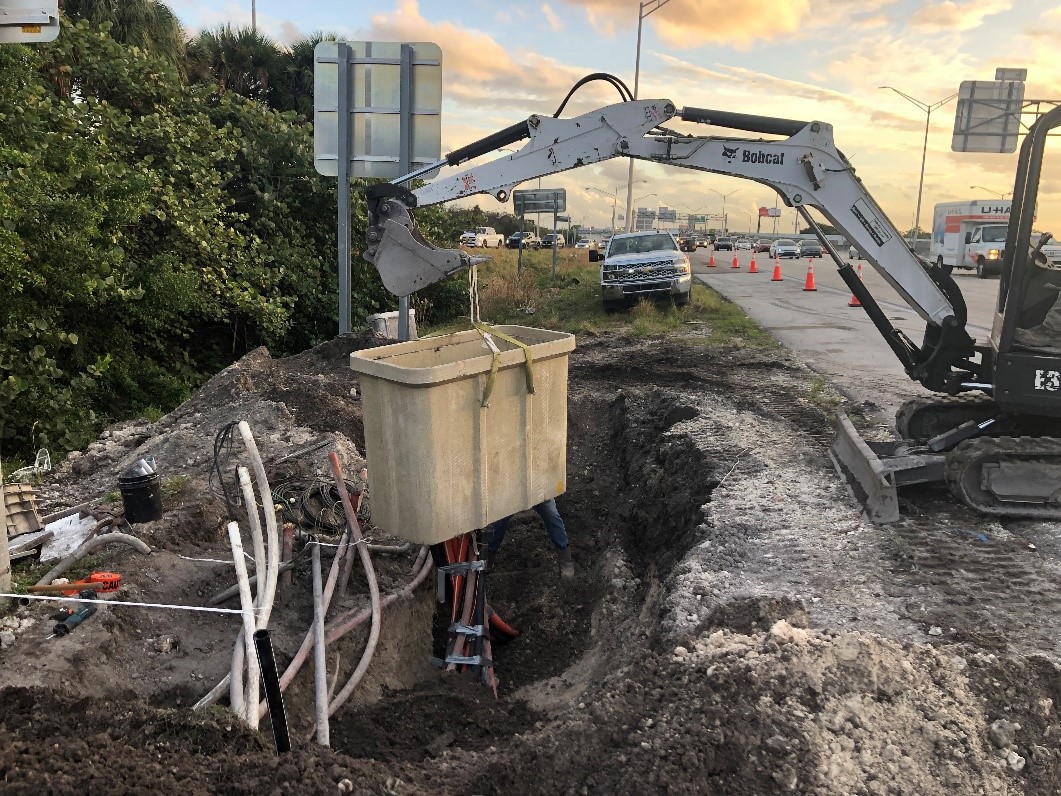

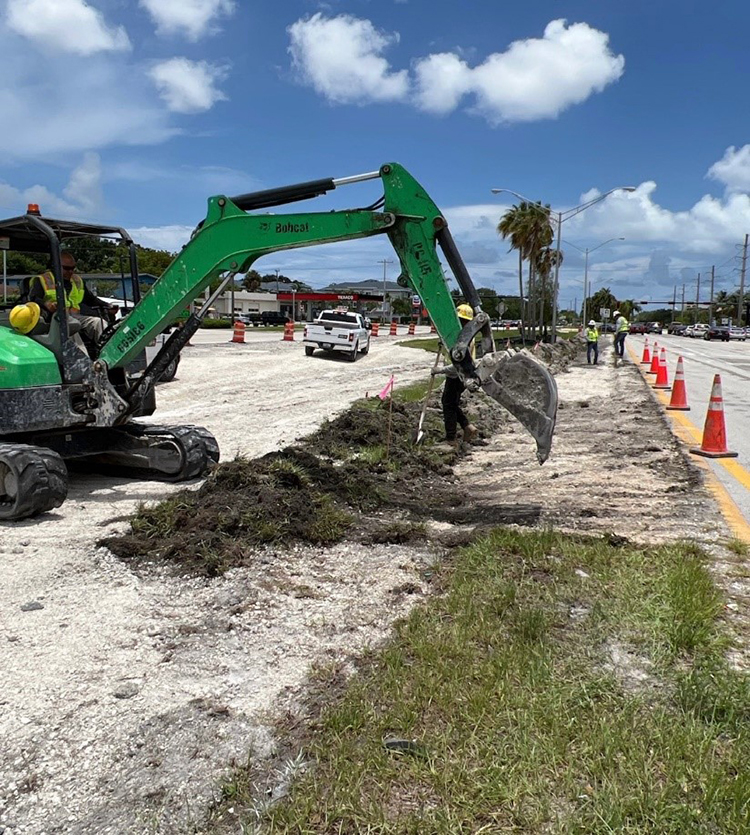

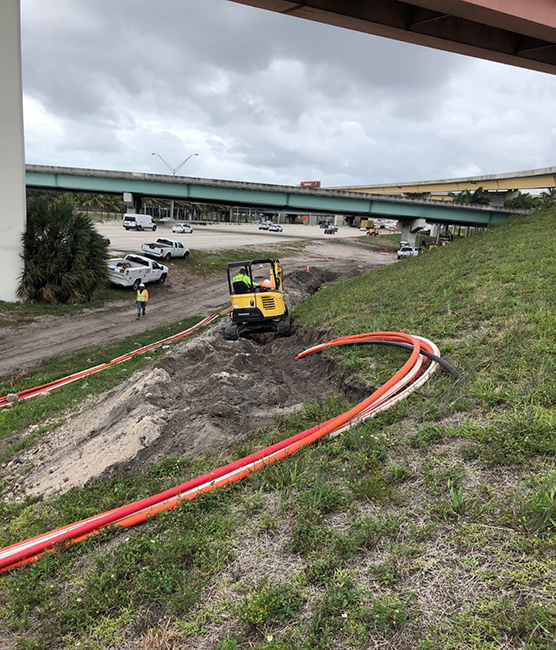

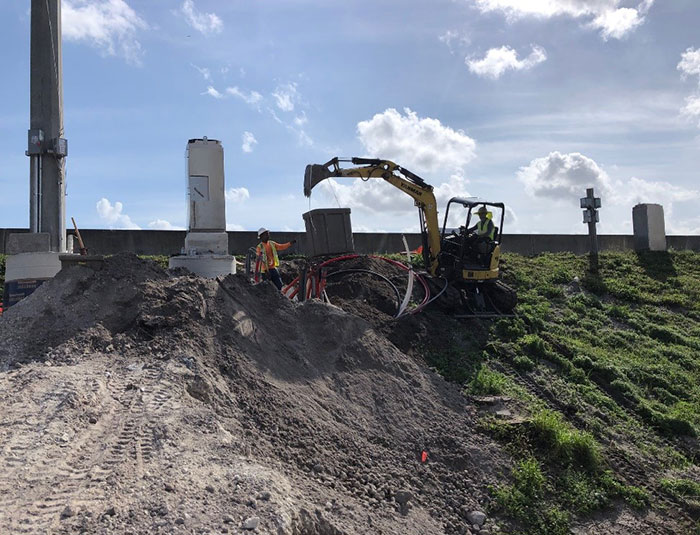

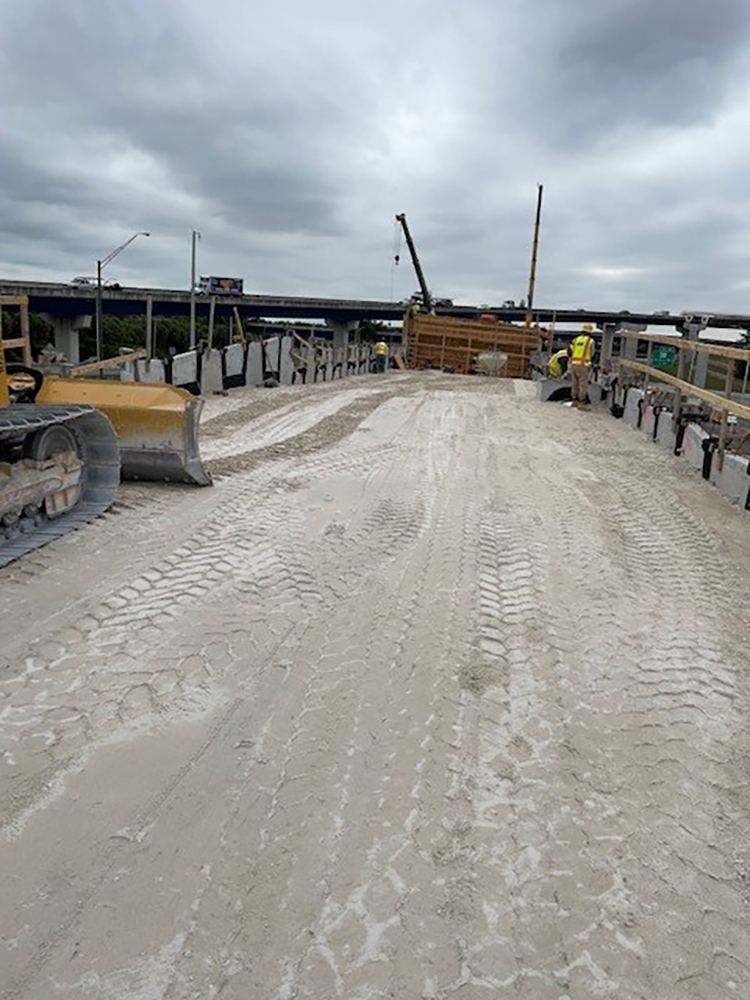

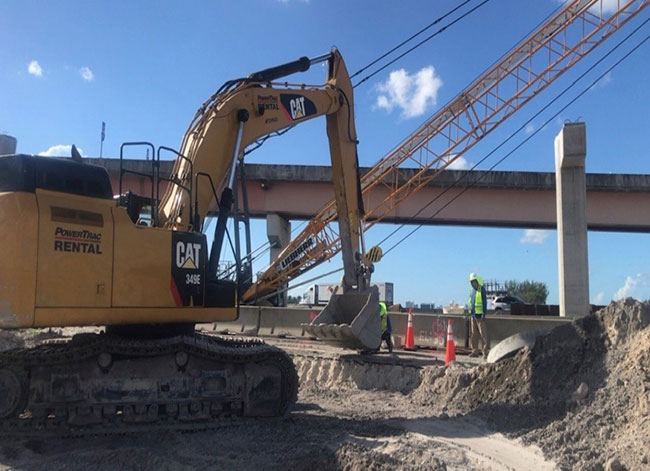

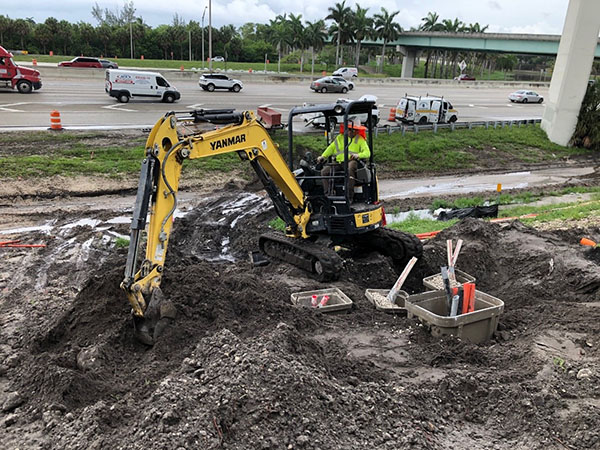

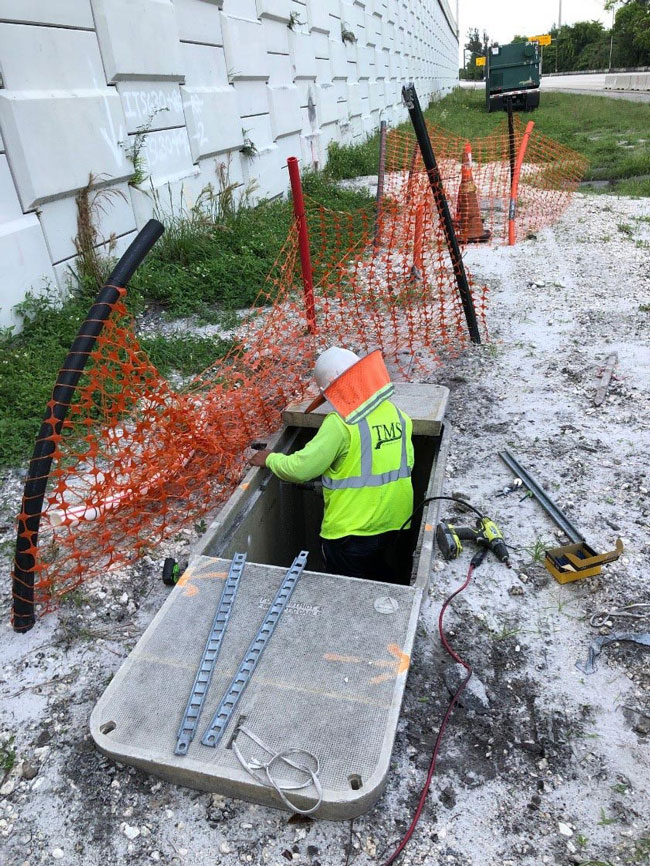

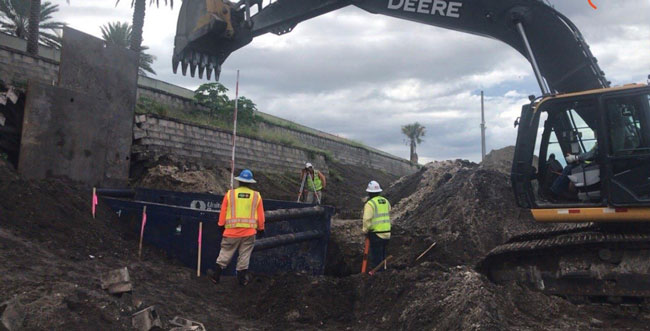

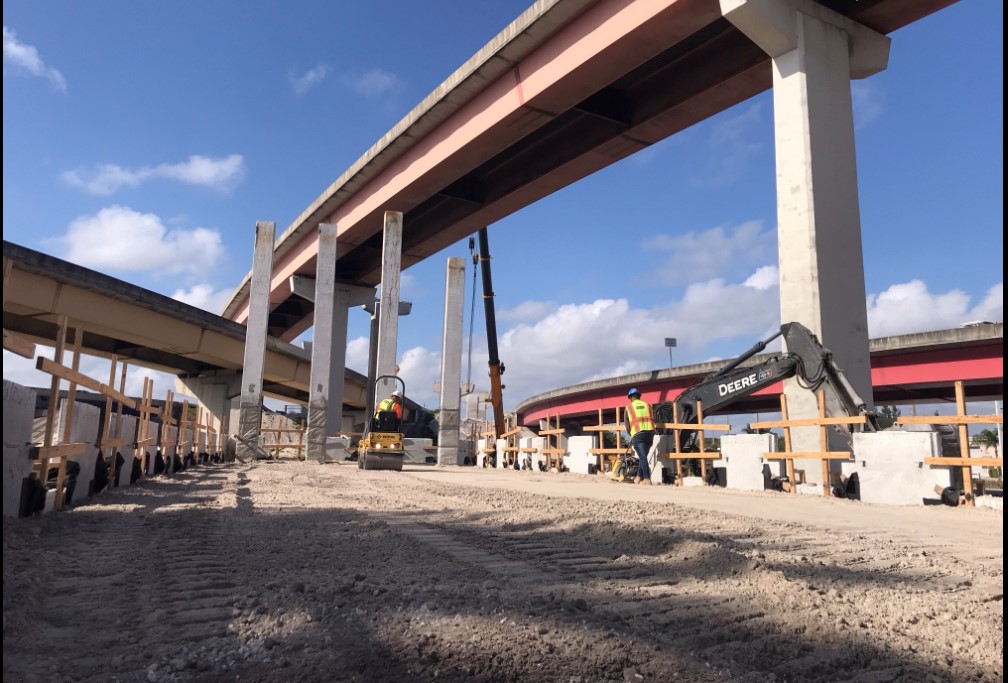

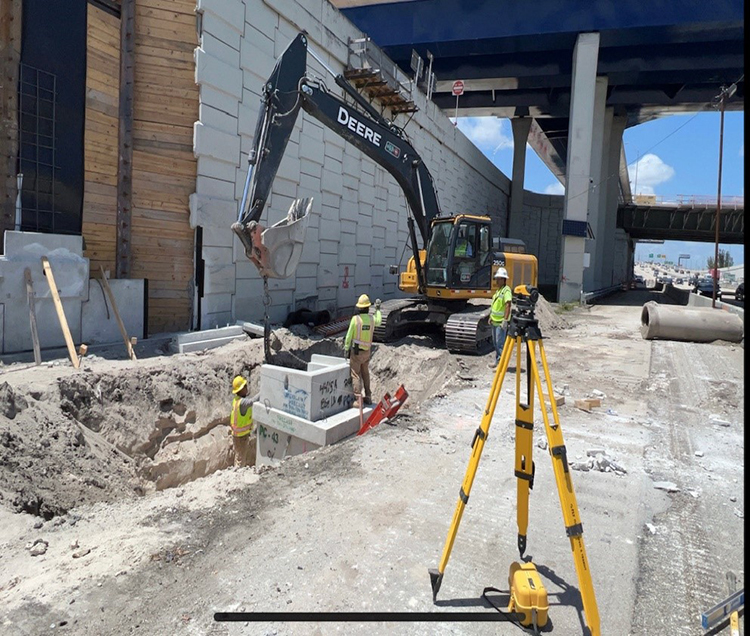

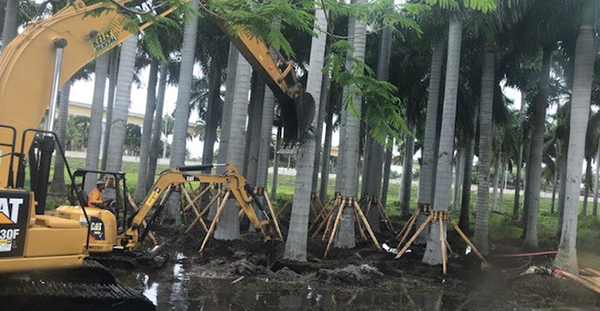

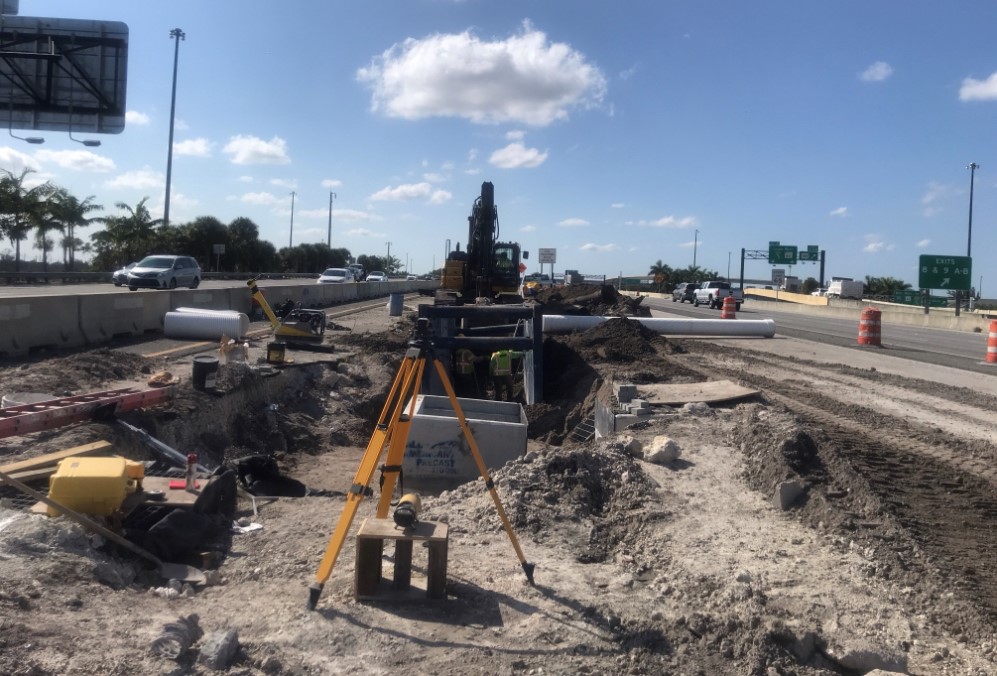

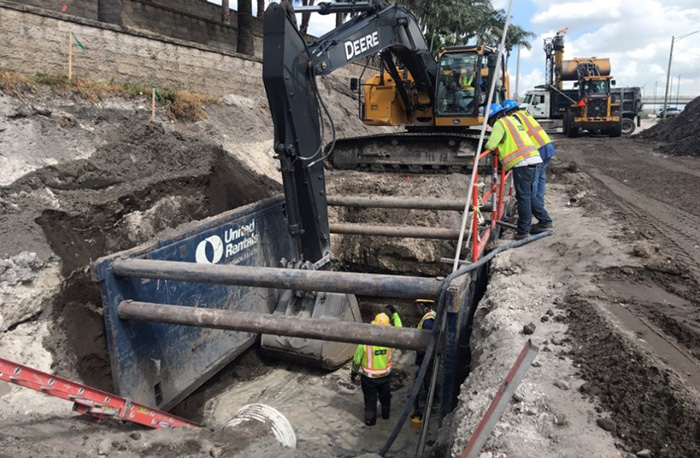

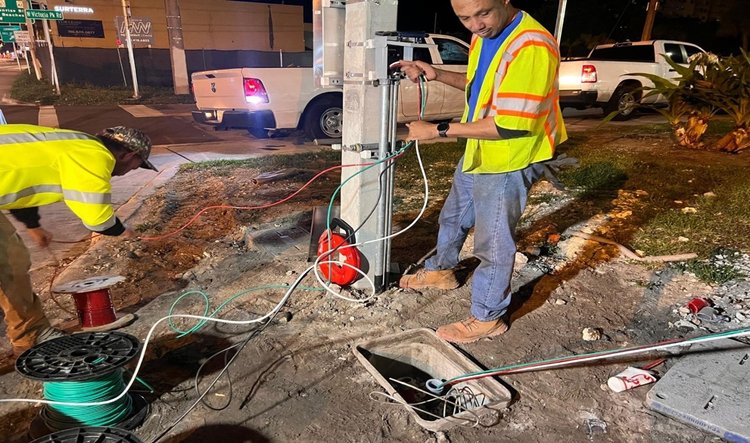

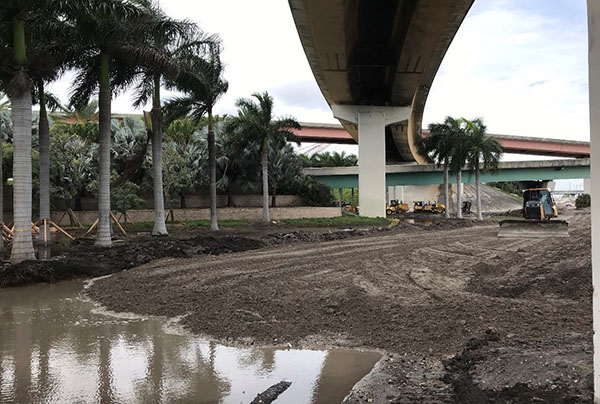

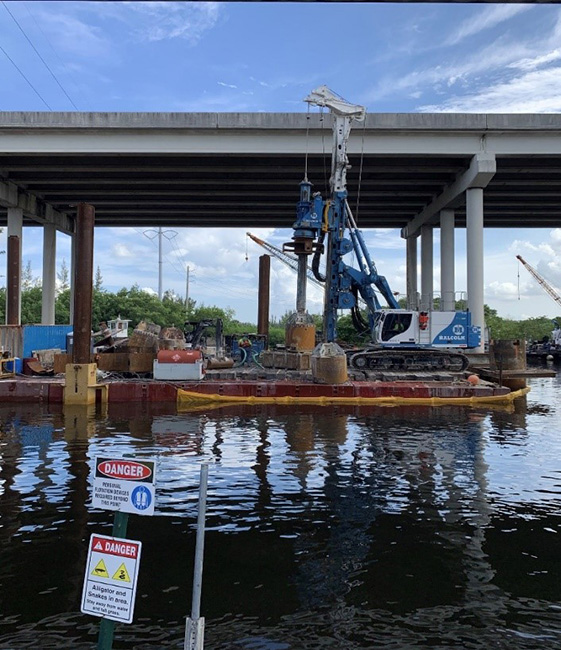

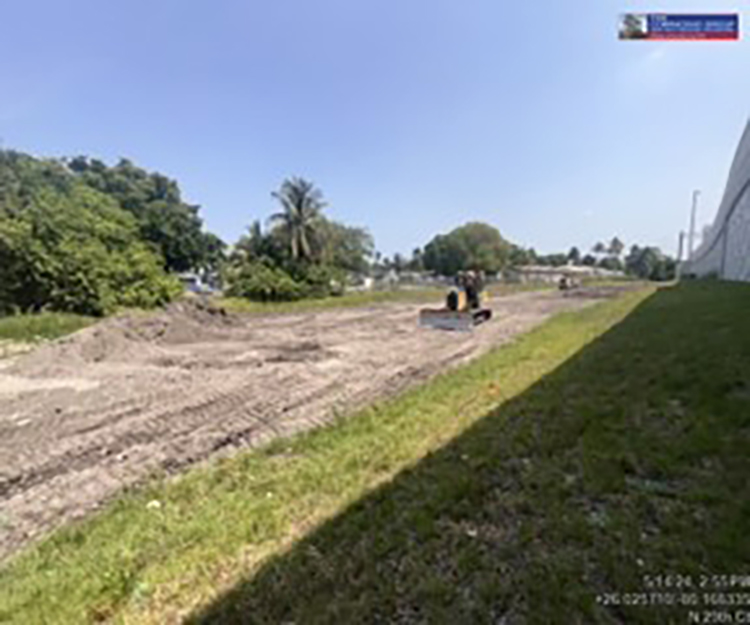

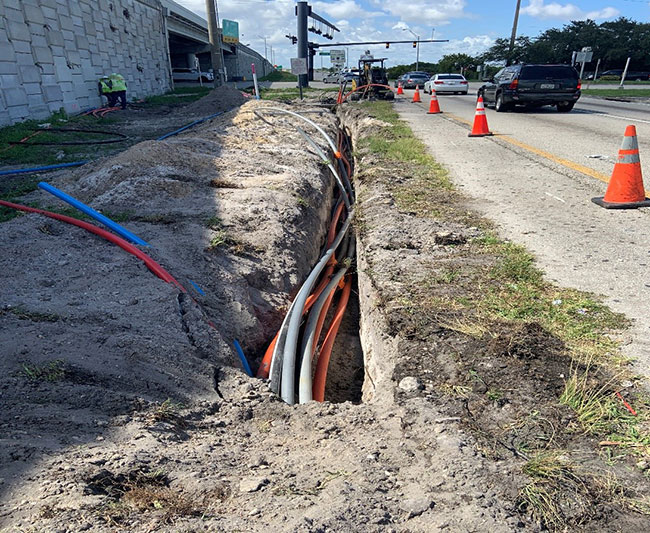

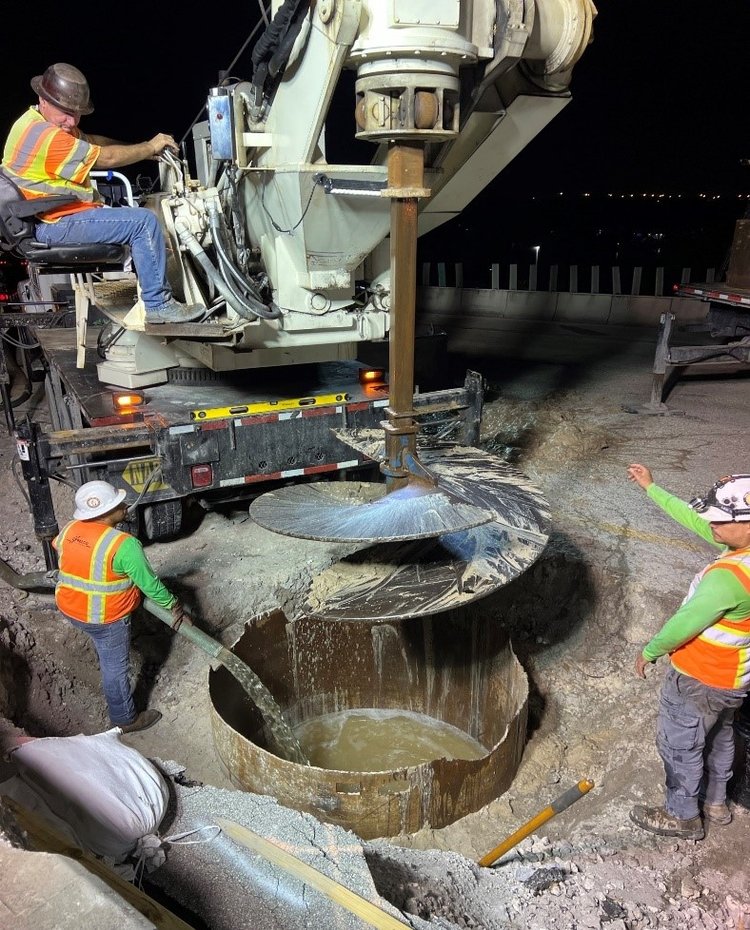

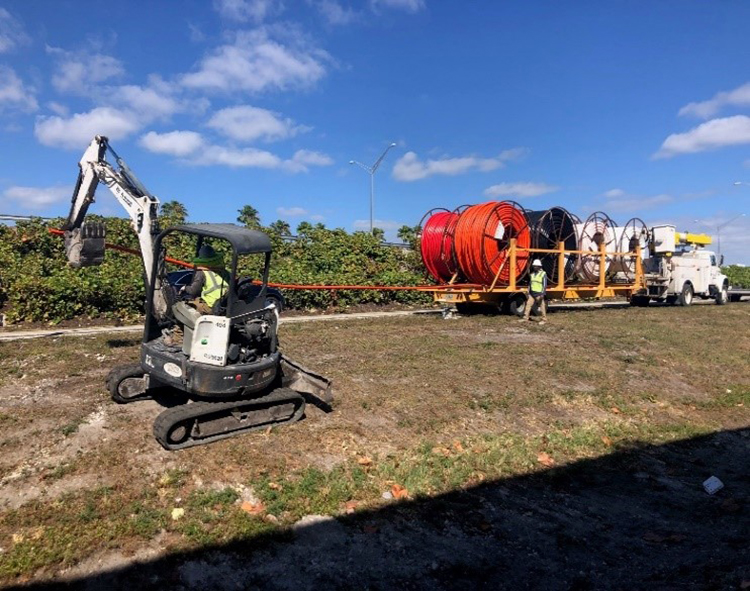

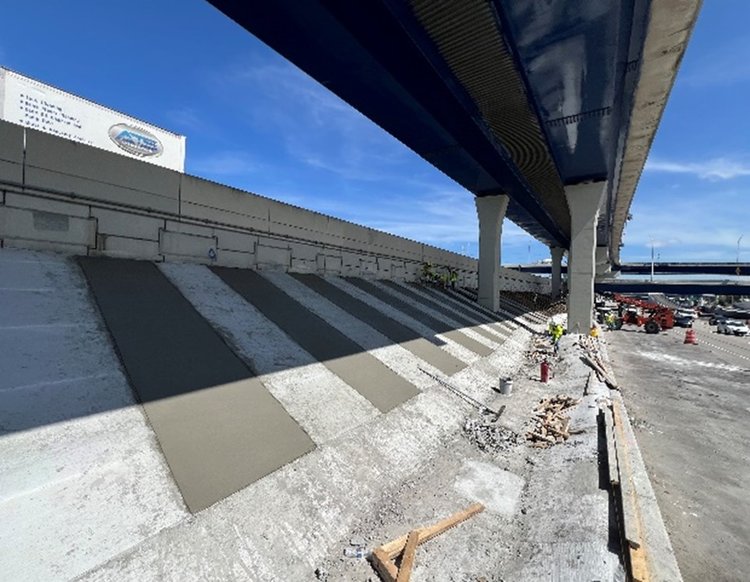

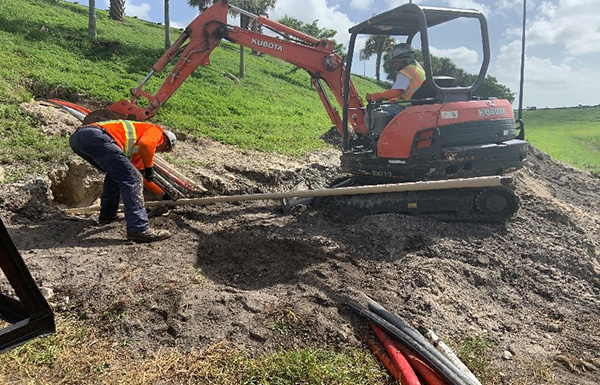

Swale Grading at SW 26th Terrace   March 2024 ITS activities at proposed Toll Site 1   April 2024 (2) Bridge 11 (I 595 westbound) outside widening demolition   April 2024 ITS activities at proposed Toll Site 1   April 2024 (3)

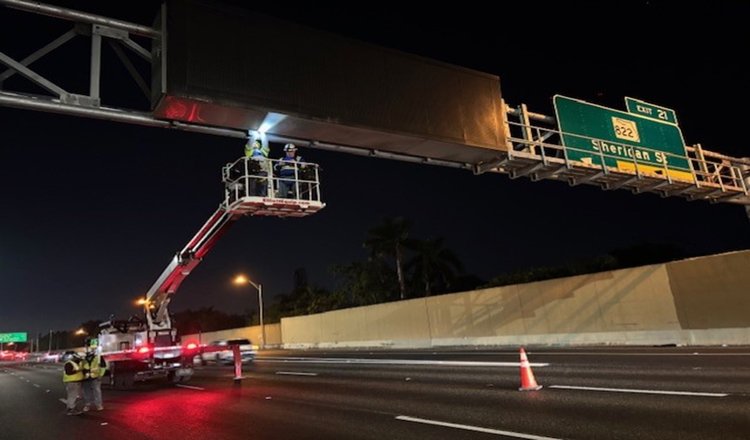

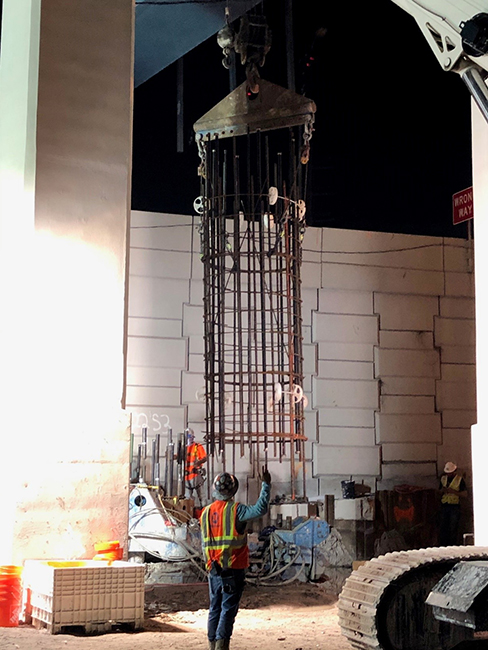

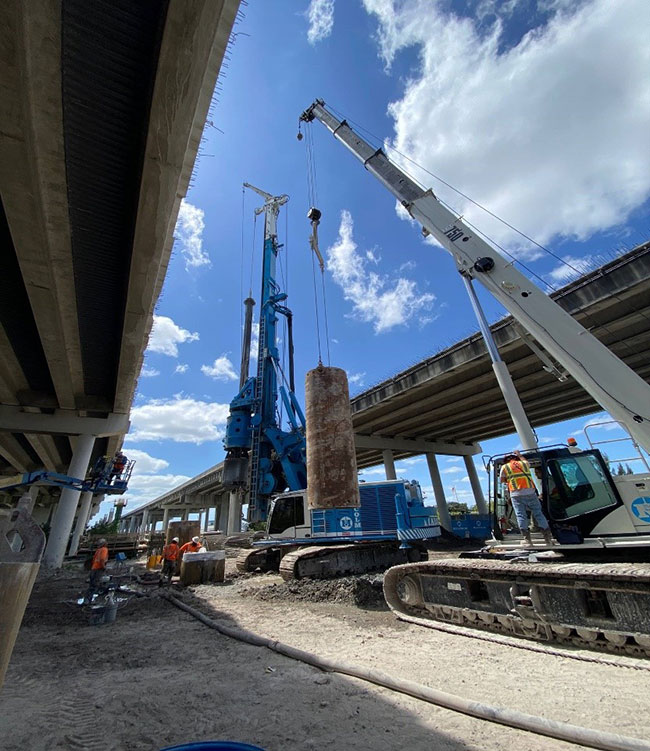

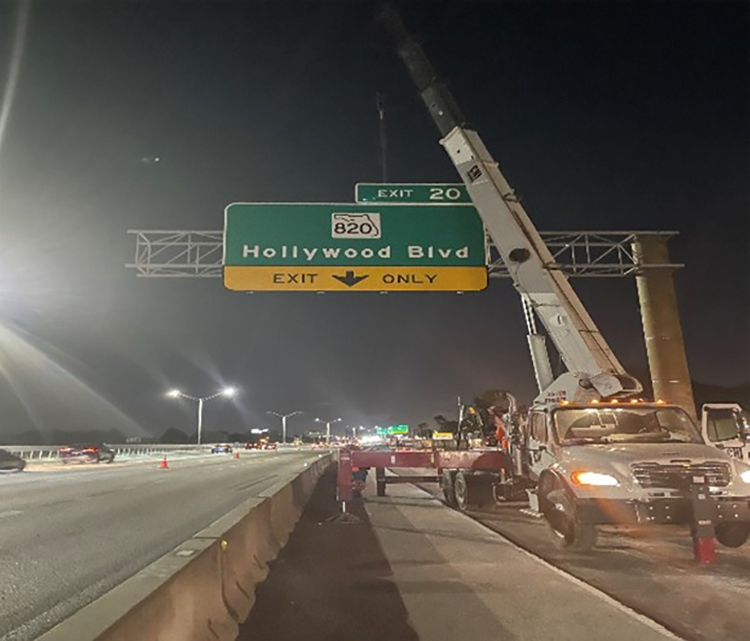

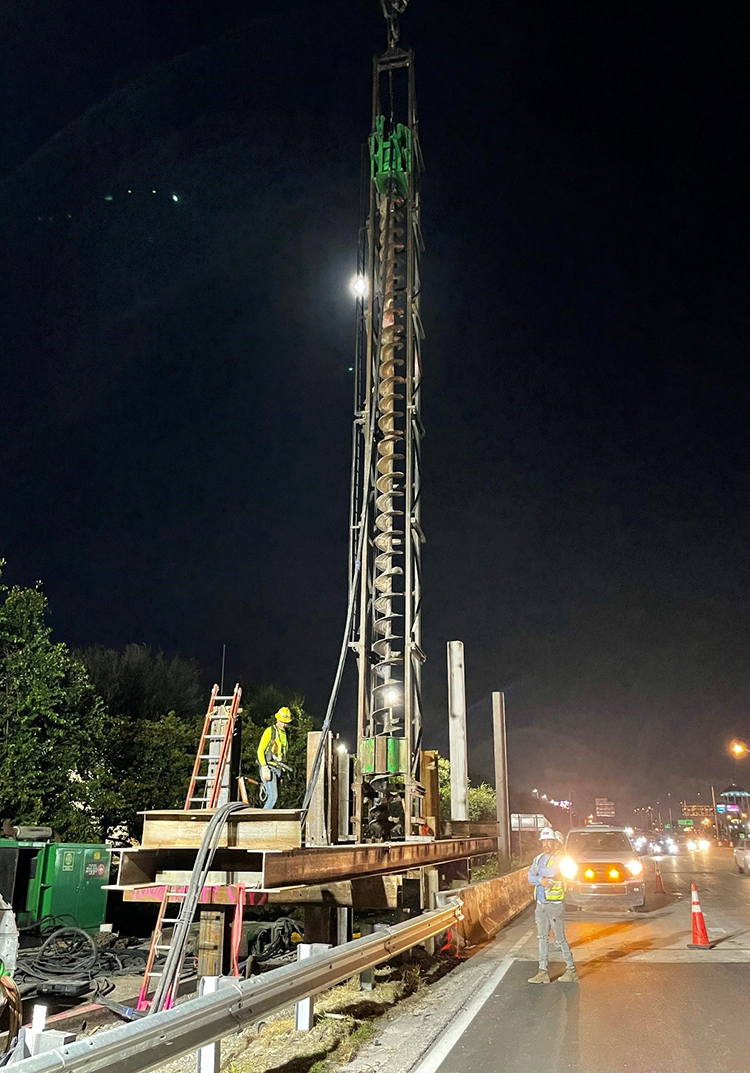

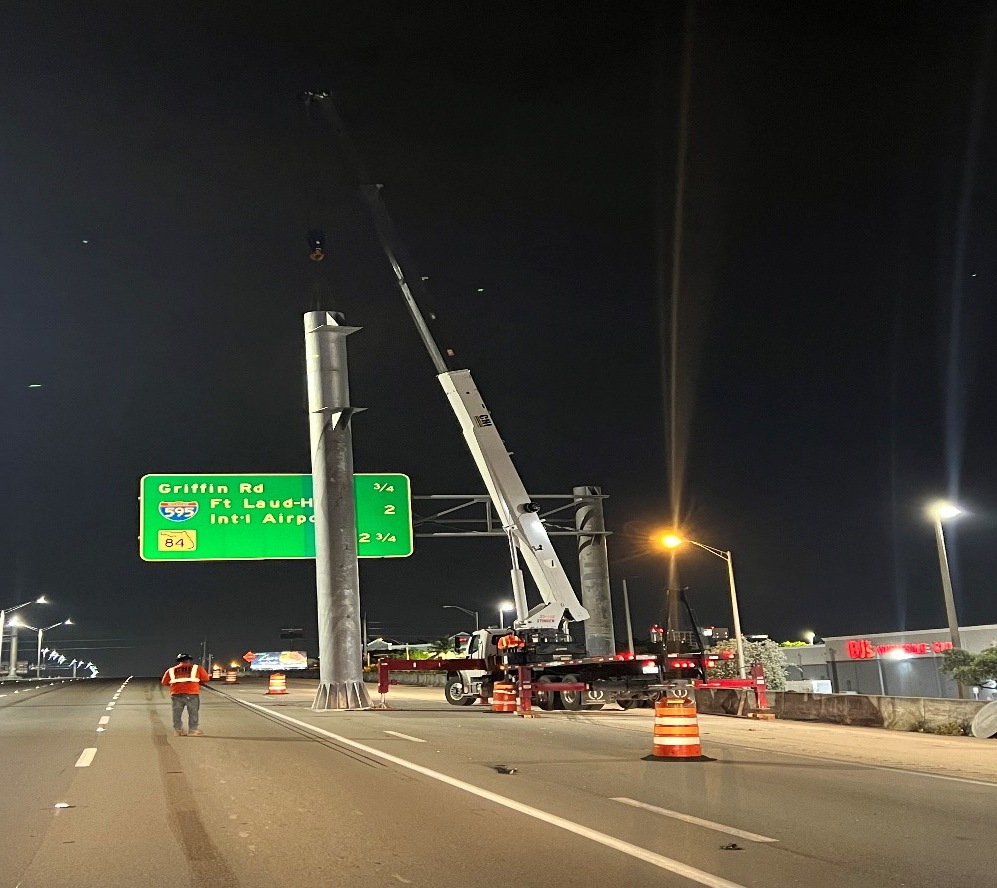

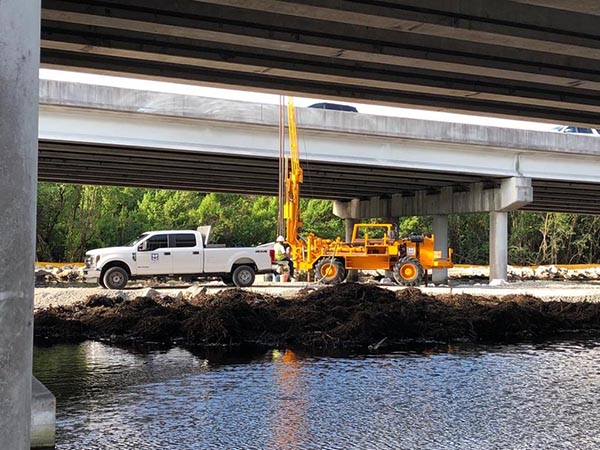

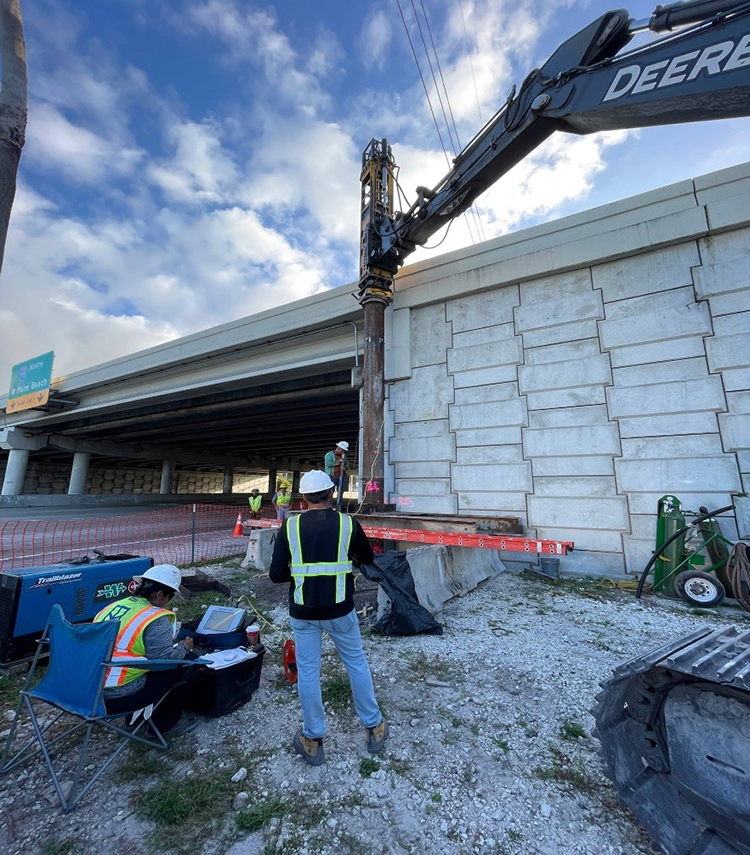

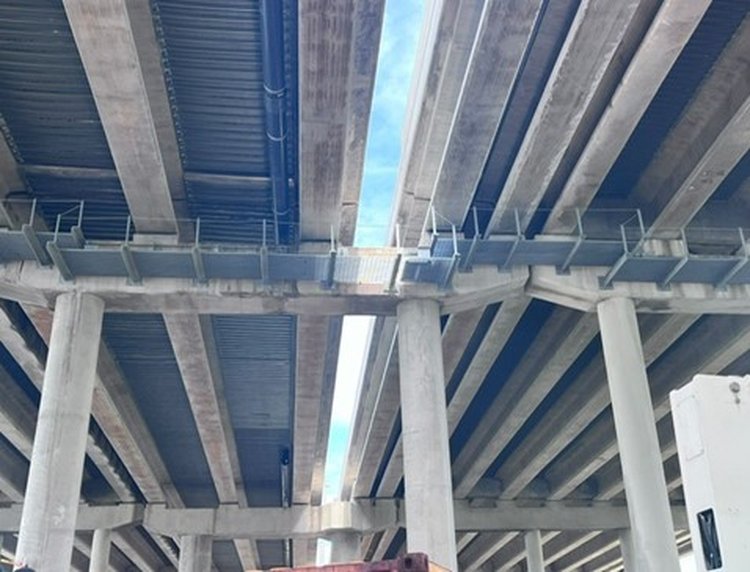

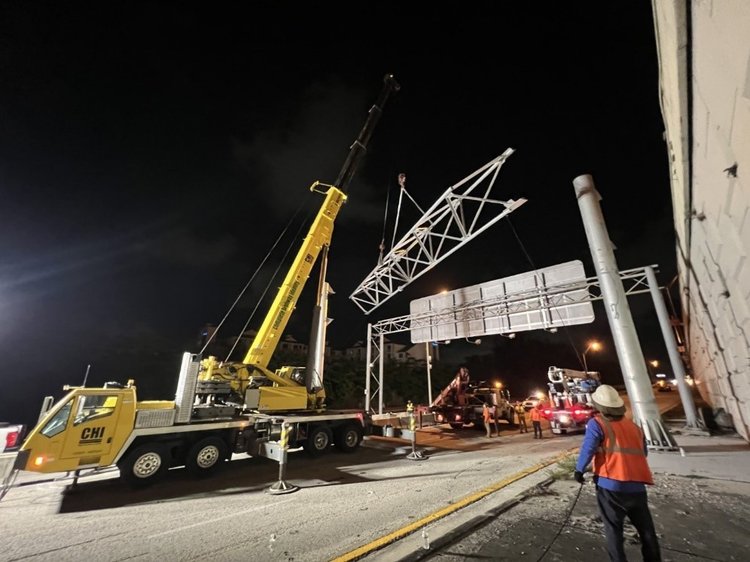

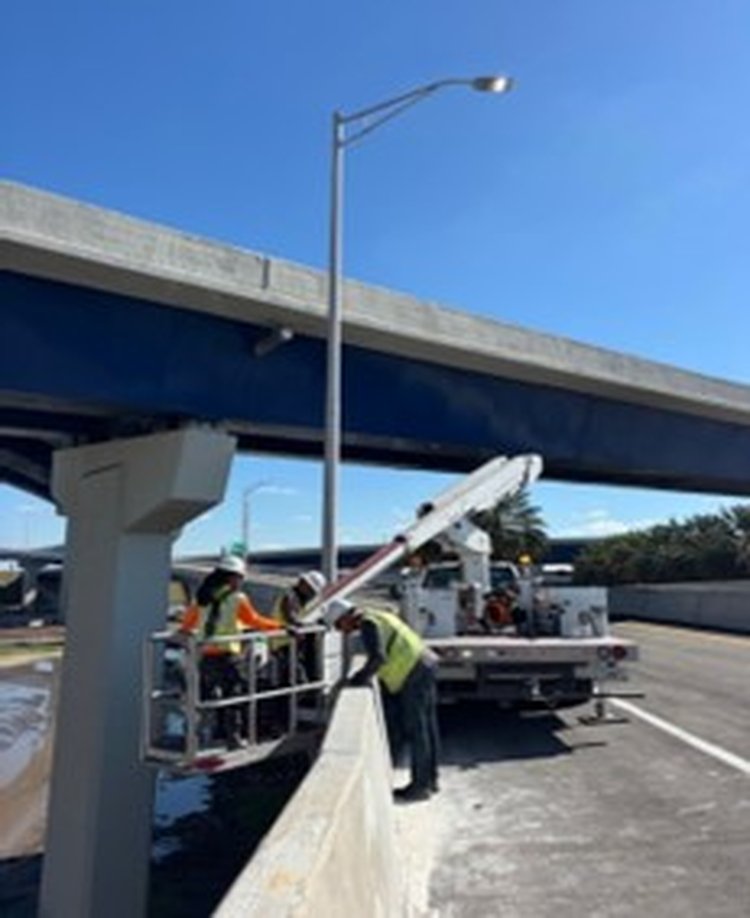

ITS activities at proposed Toll Site 1   April 2024 (4) Bridge 14 Pier 5 (Proposed Direct Connect) Column Construction   April 2024 Bridge 8 (Griffin Road) I 95 northbound deck widening   April 2024 Removal of existing sign structure at I 95 northbound exit ramp near Hollywood Boulevard   April 2024

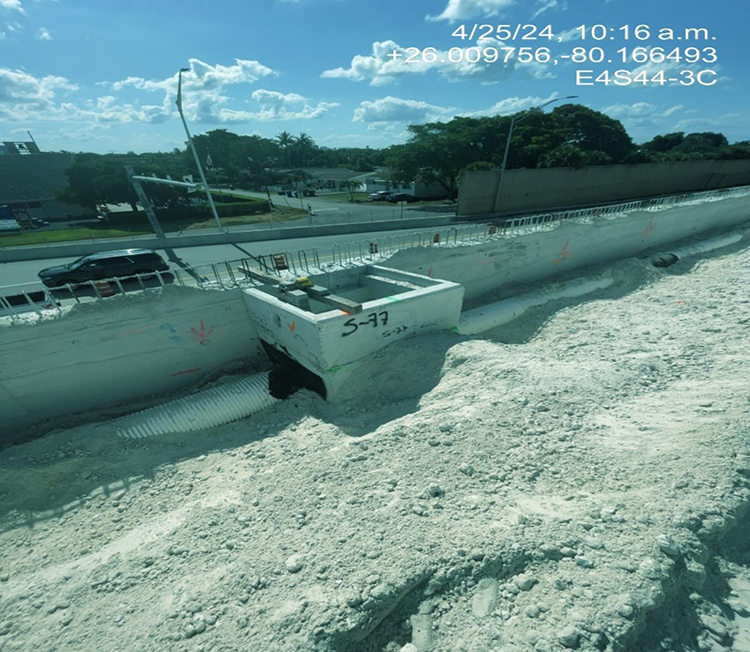

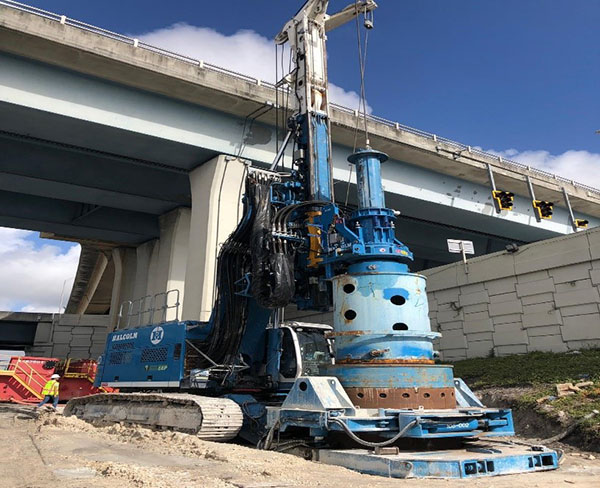

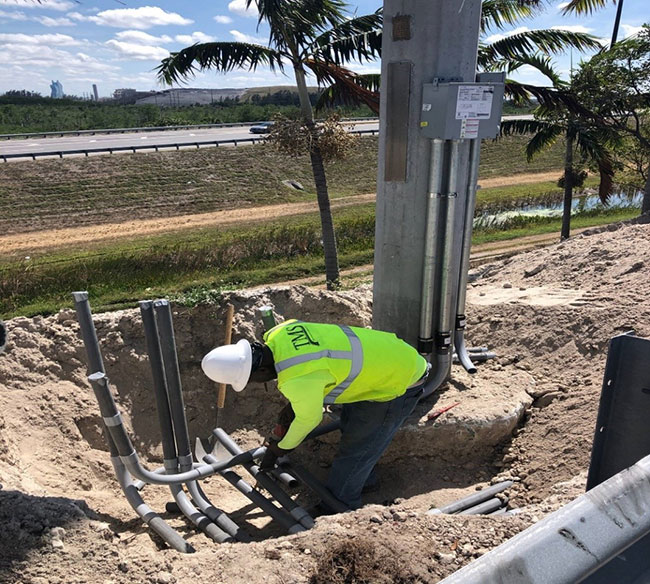

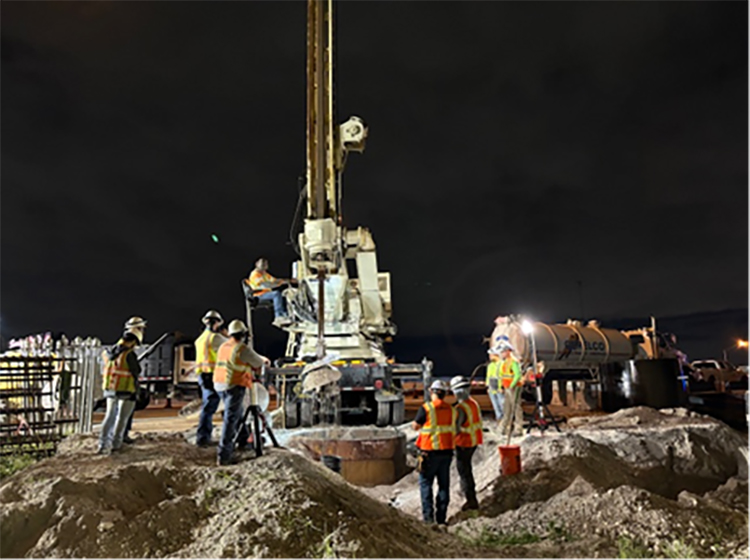

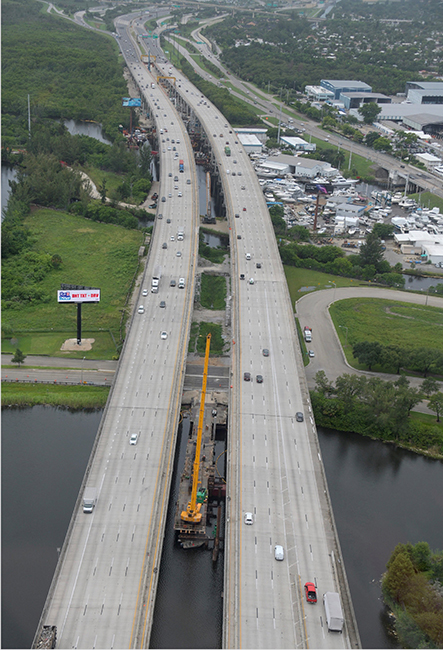

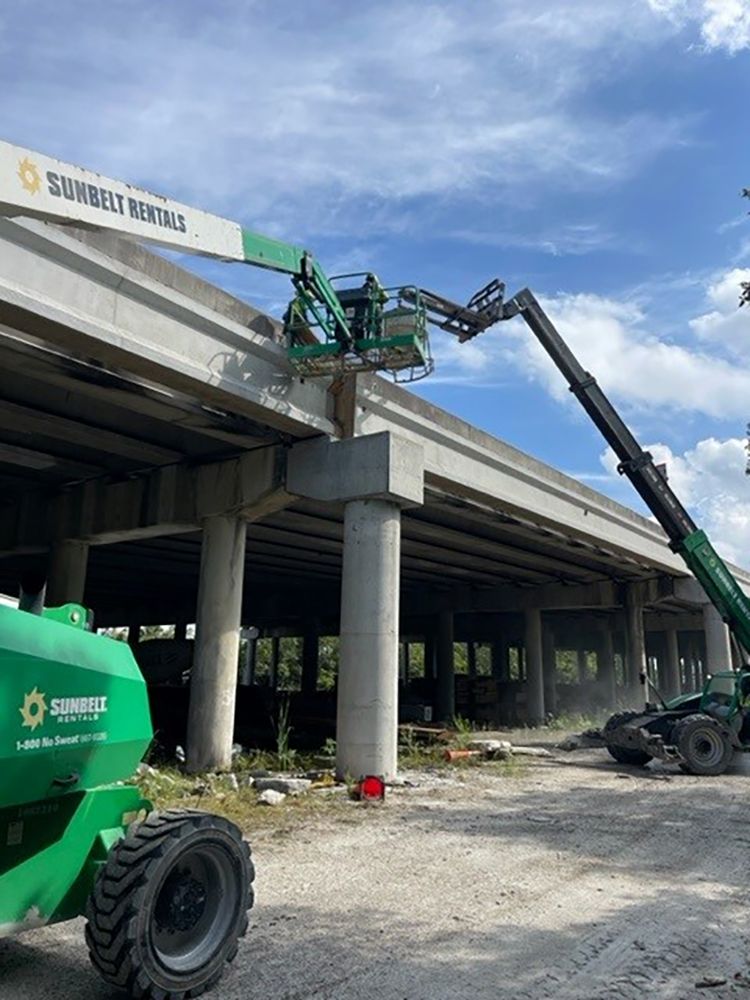

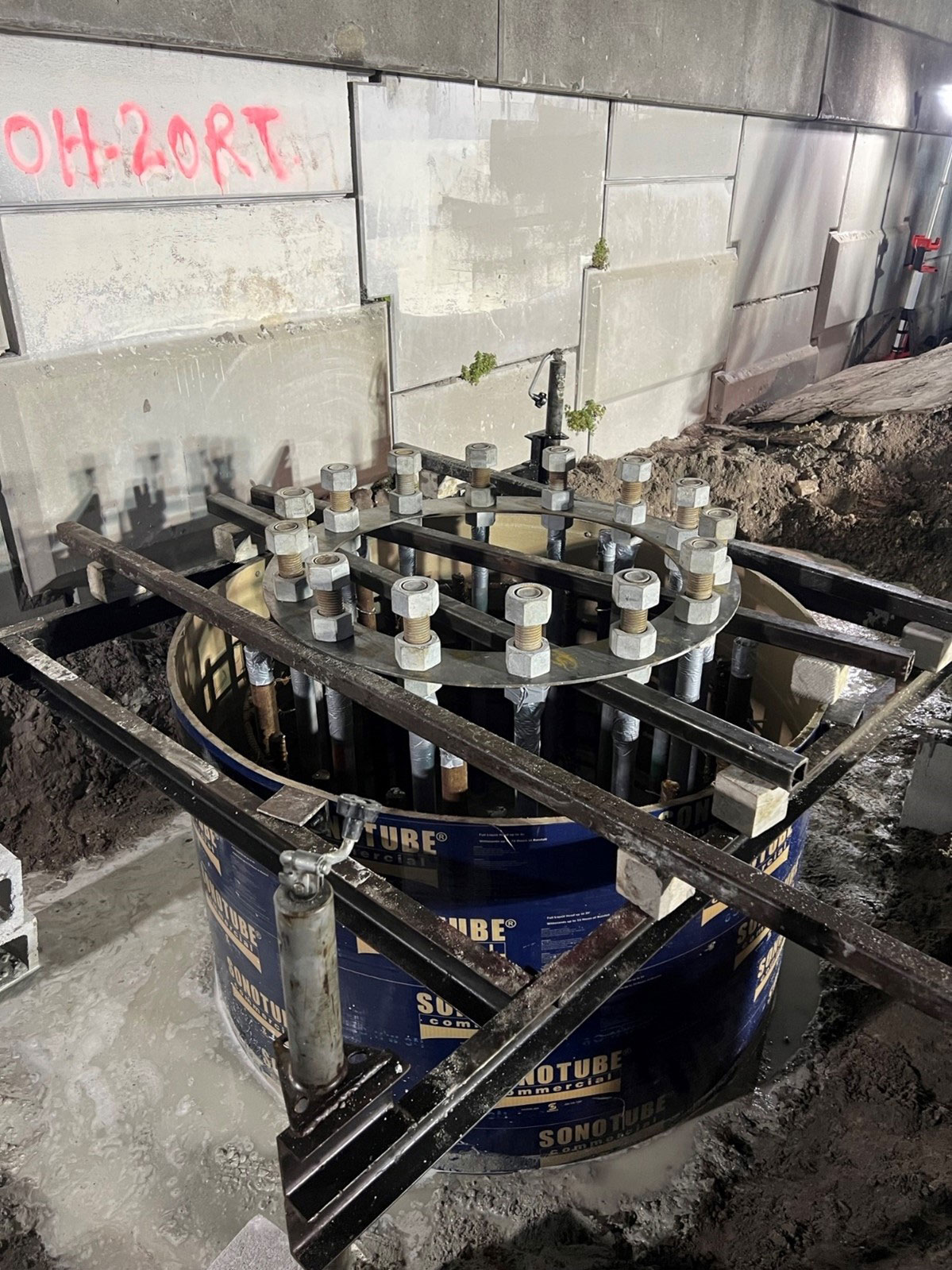

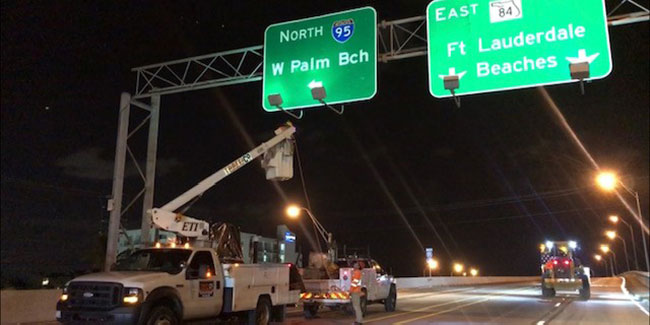

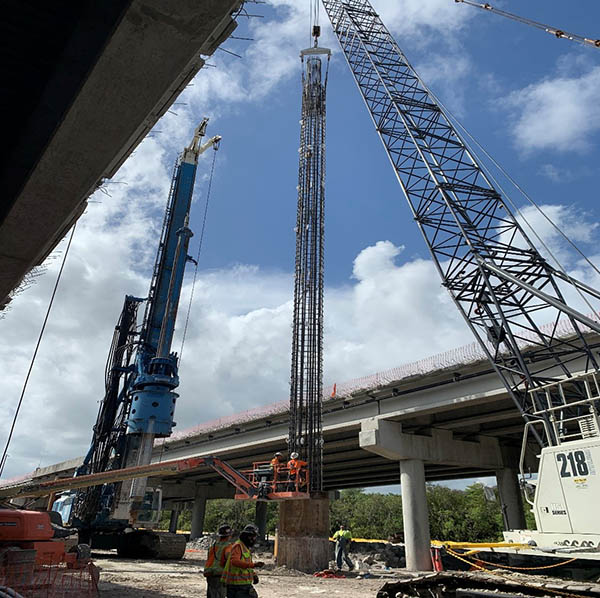

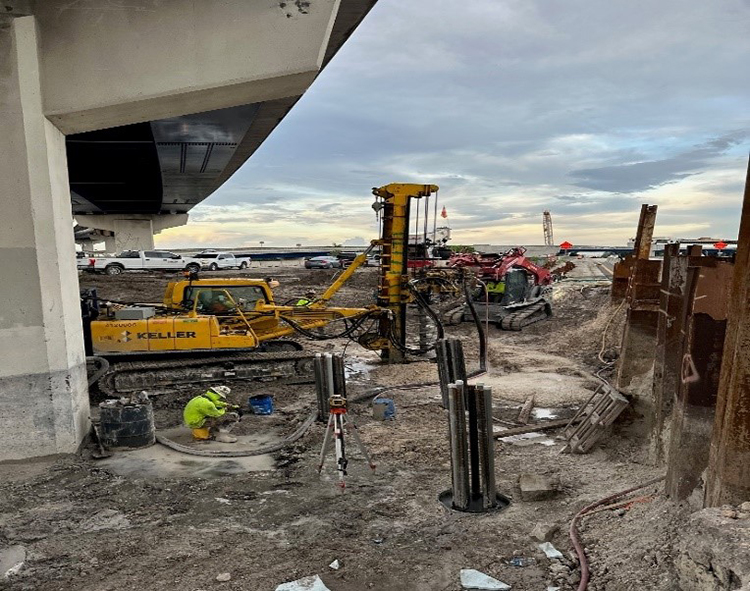

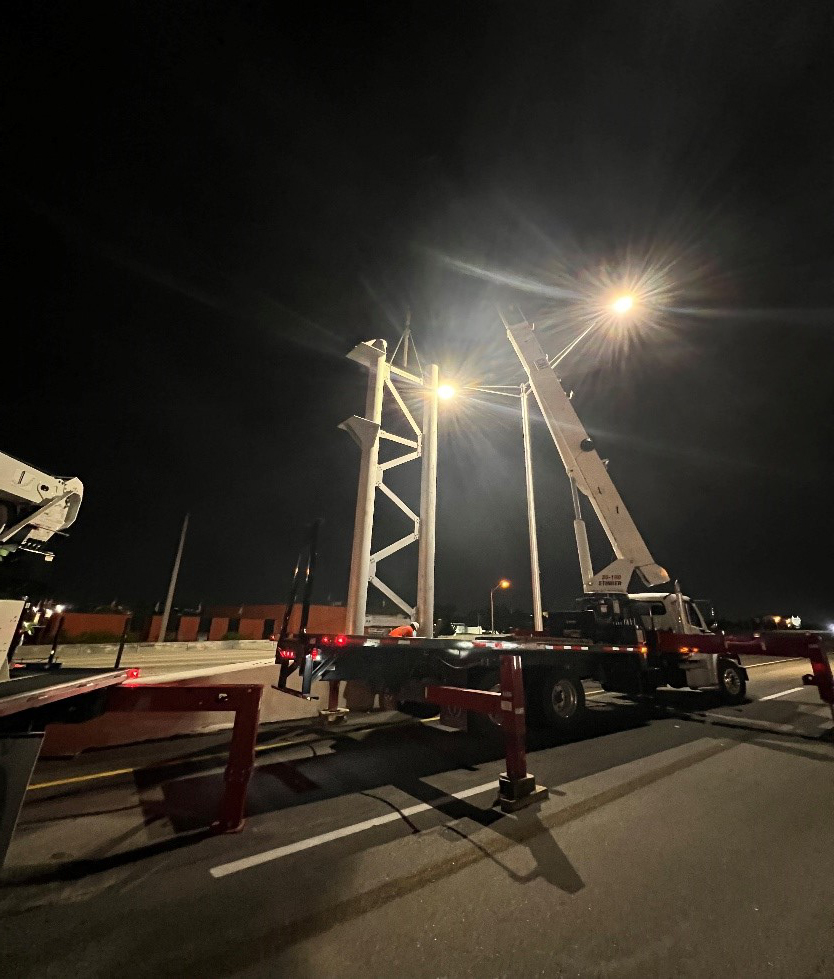

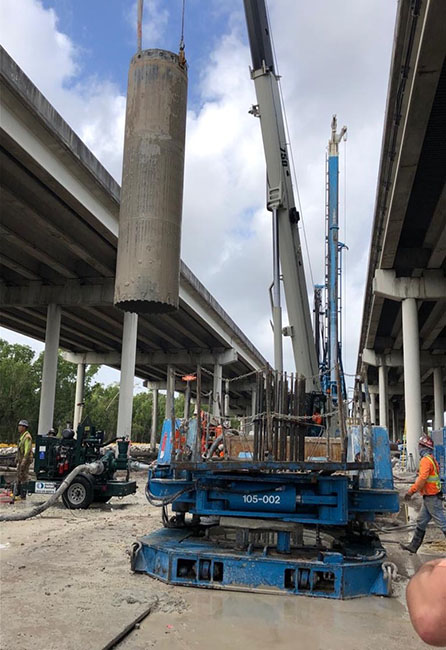

ITS activities at proposed Toll Site 1   April 2024 (5) Drilled shaft installation (OH 24RT) along I 95   April 2024 Bridge 8 (Griffin Road)   I 95 north bound deck widening   April 2024 Removal of existing sign structure at I 95 northbound exit ramp near Hollywood Boulevard   April 2024 (2)

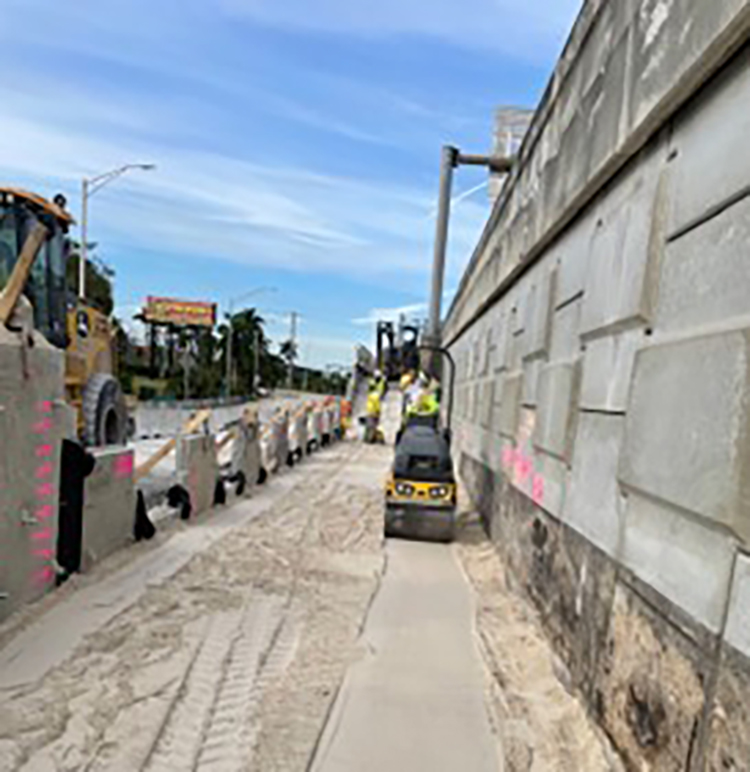

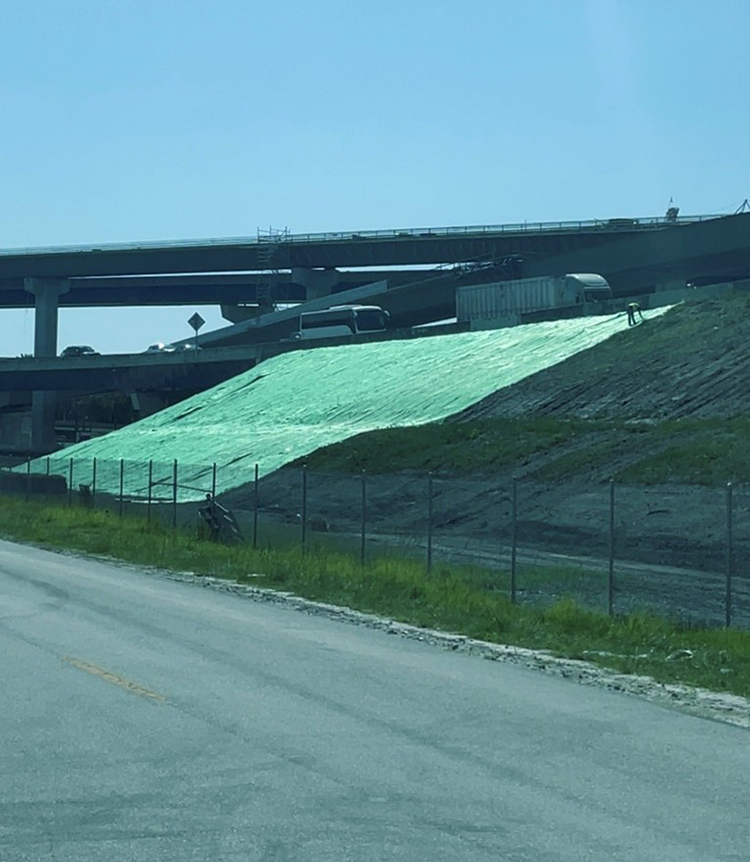

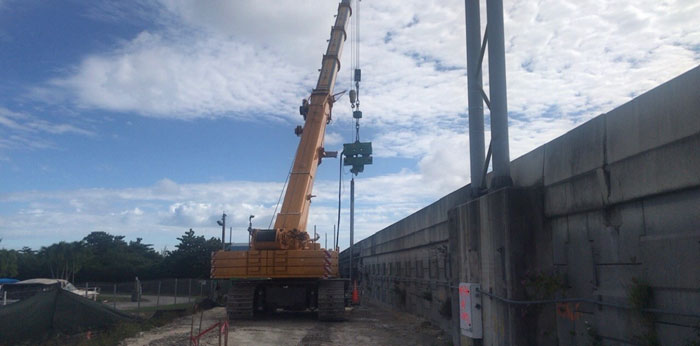

Barrier wall construction along I 95 median just south of I 595   April 2024 Erosion protection (SOD) placement along I 595 westbound outside slopes   April 2024 I 95 widening   MSE Wall constructi on at Stirling Road   April 2024 ITS activities at proposed Toll Site 1   April 2024
I 95 widening   MSE Wall construction  at Stirling Road   April 2024 (2) Retaining Wall No.1 Construction   April 2024 Nightly opaque visual barrier construction along I 95 median   April 2024 Bridge 11 (I 595 westbound) outside widening nightly precast beams erection   April 2024

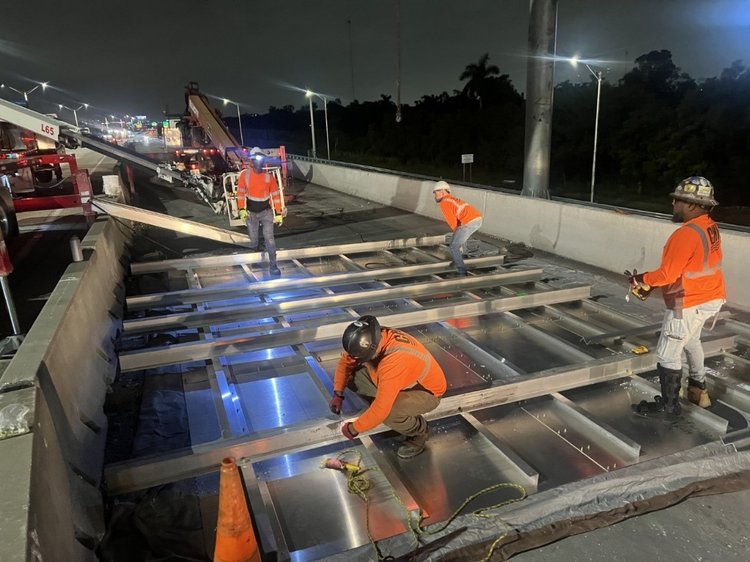

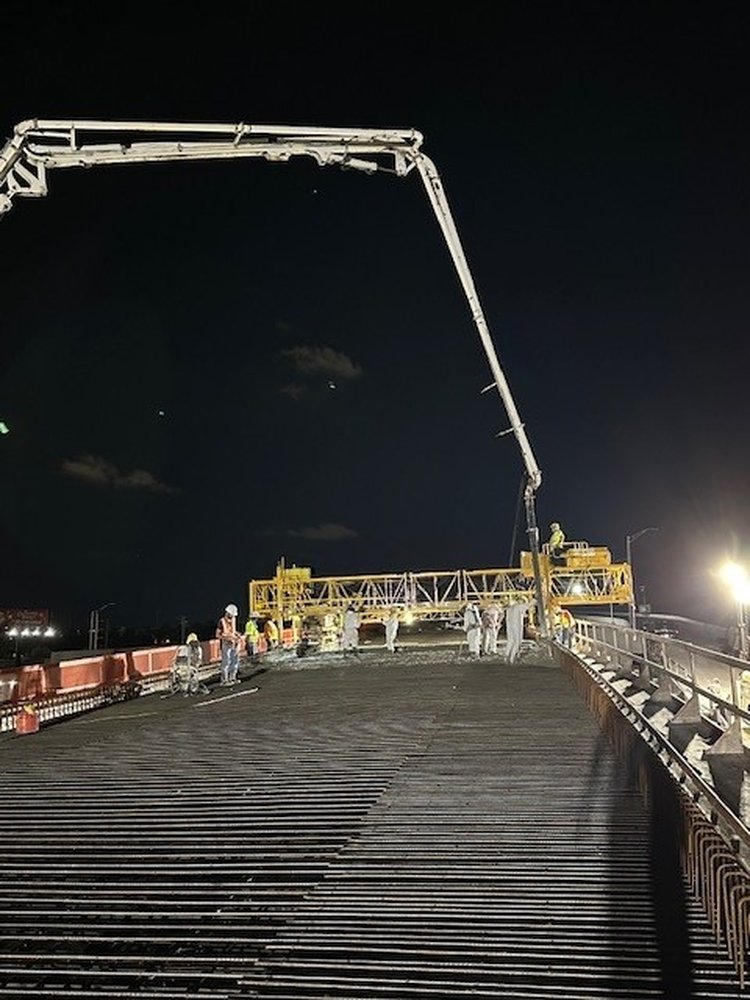

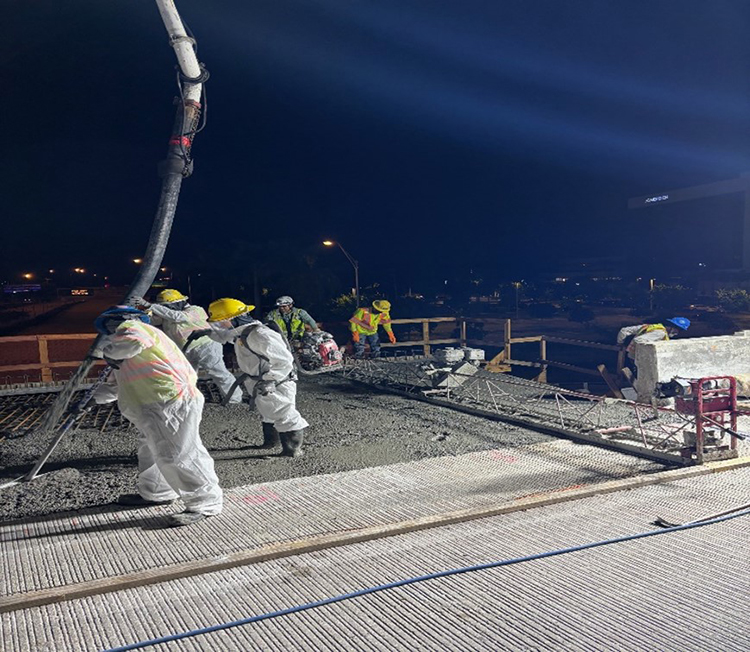

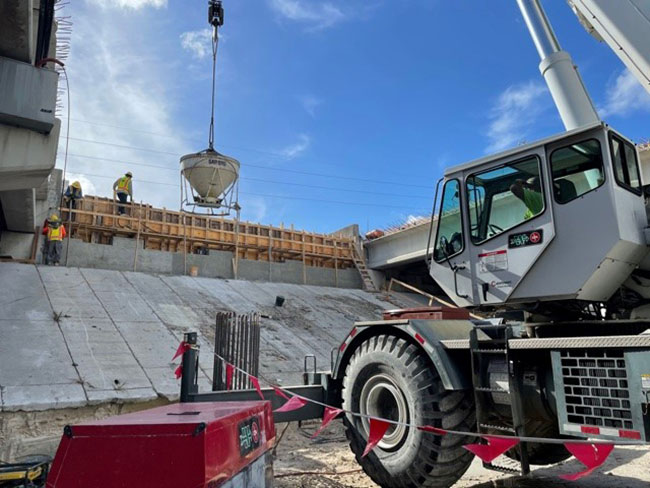

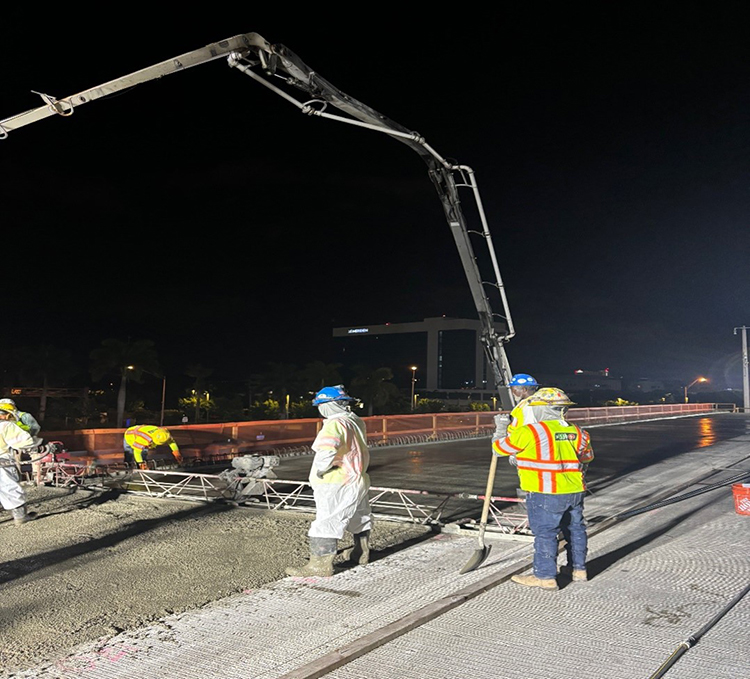

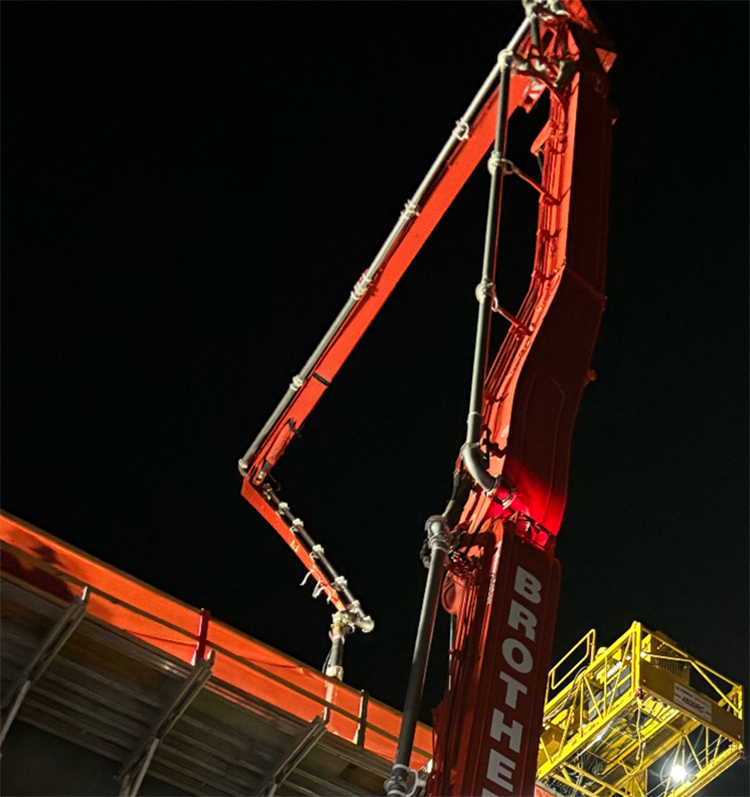

Retaining Wall No.1 Construction   April 2024 (2) Bridge 12 (Proposed Direct Connect) Traffic Railing Construction   May 2024 (2) Bridge 13A (Proposed Direct Connect) SIP & Shear Studs Placement   May 2024 Bridge 12 (Proposed Direct Connect) Nightly Deck Pours

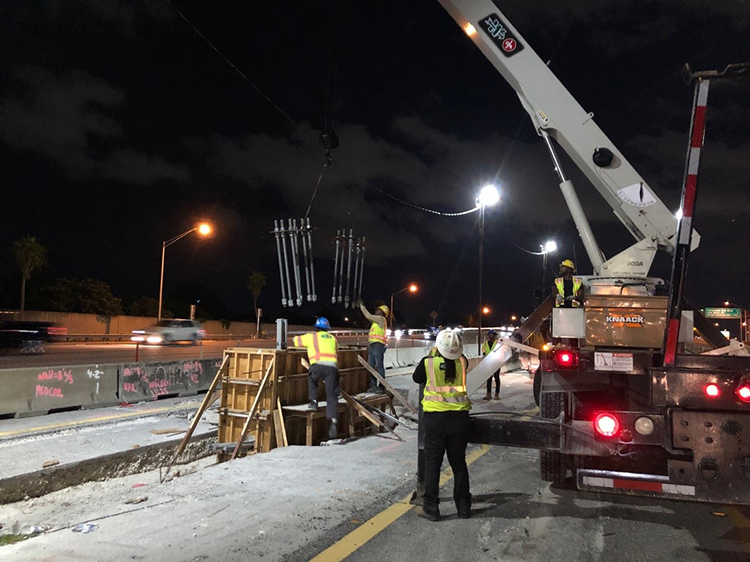

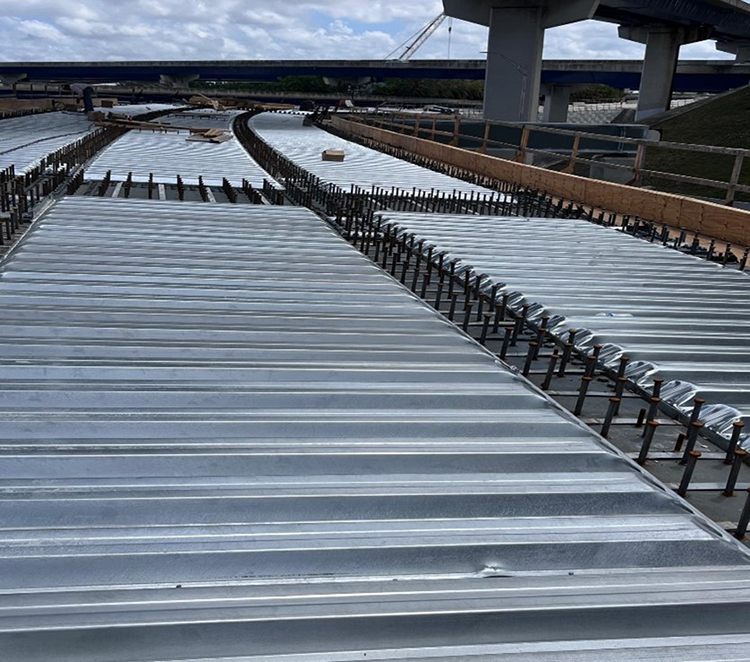

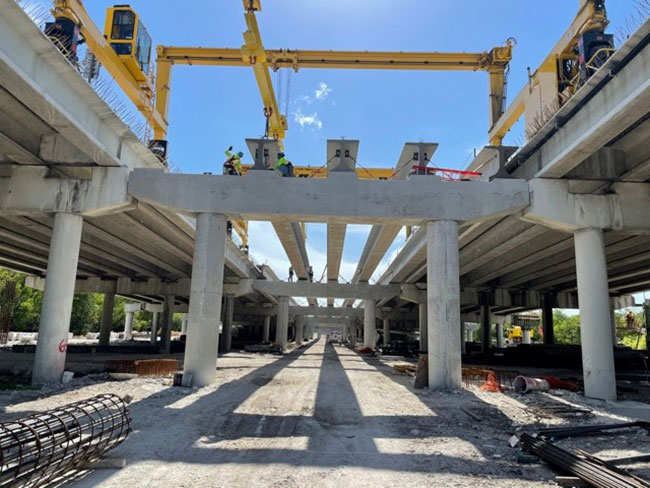

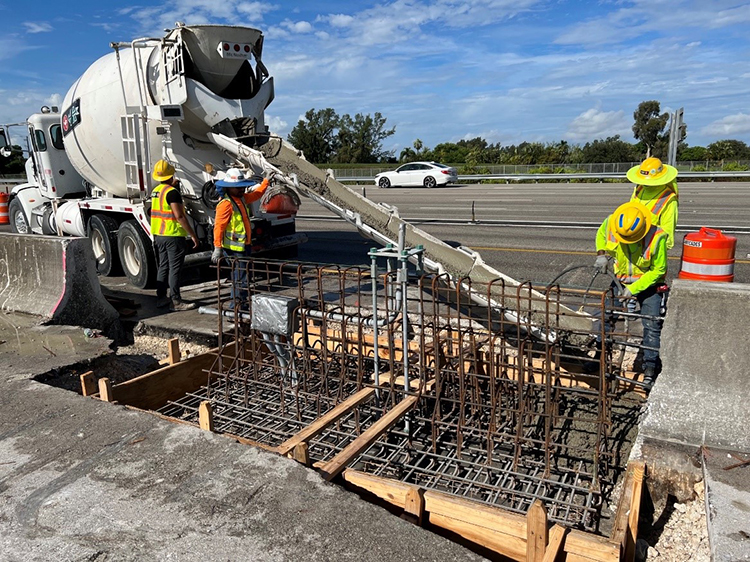

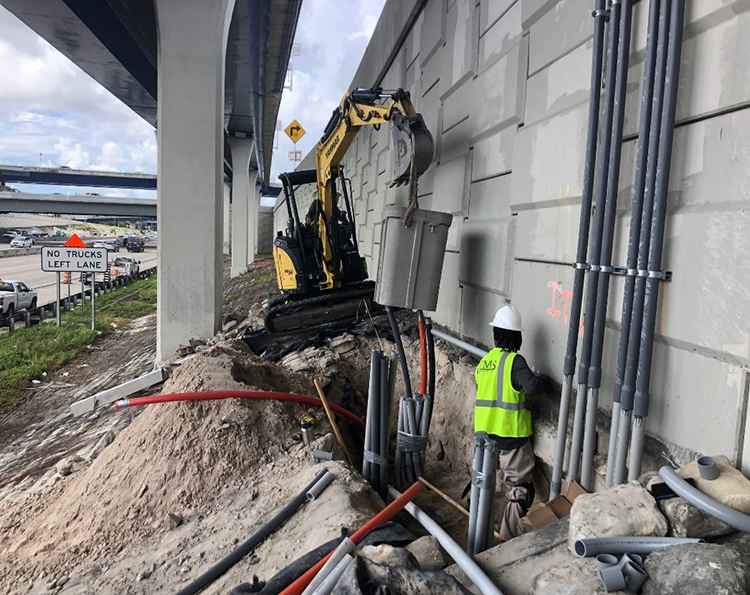

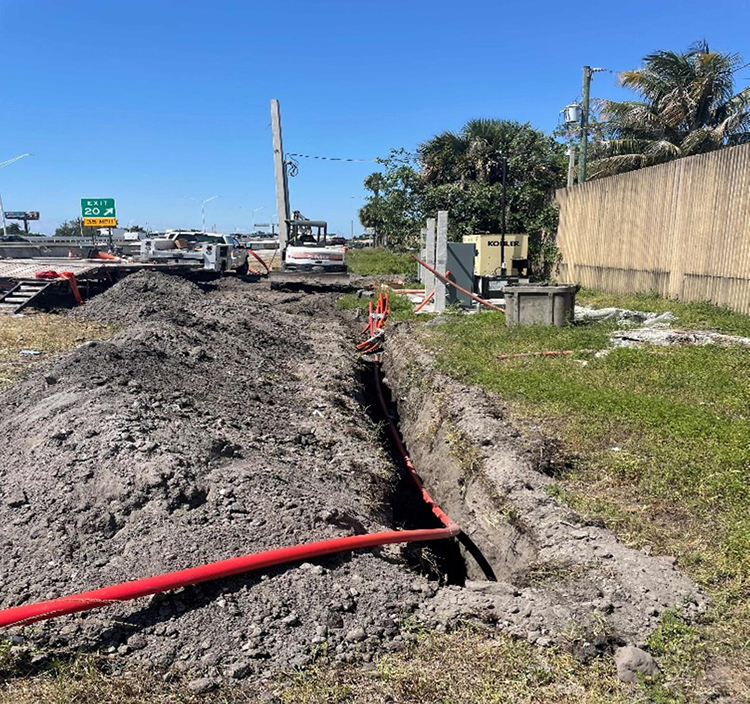

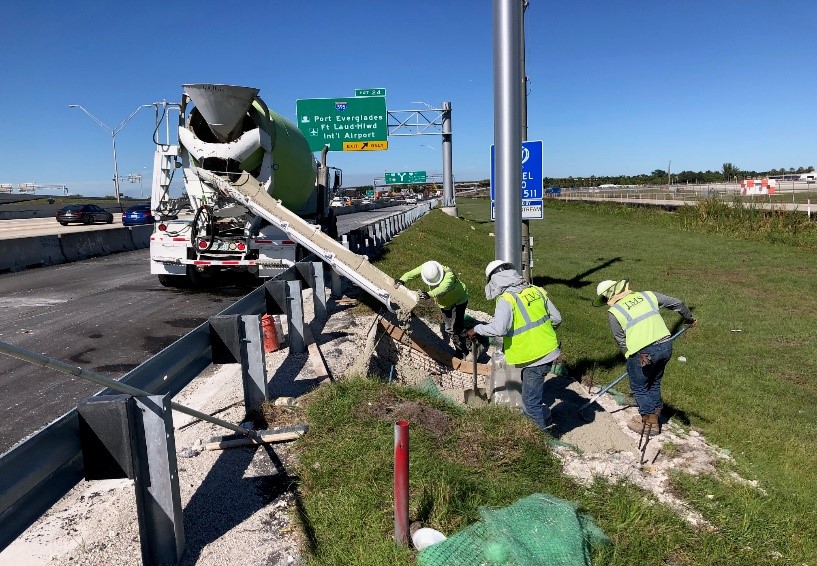

Installation of conduits and expansion fittings with the traffic railings at Bridge 12 for lighting   May 2024 Installation of Toll Building at Toll Site 1   May 2024 Bridge 12 (Proposed Direct Connect) Traffic Railing Construction   May 2024 Bridge 8 (Griffin Road) Pier Protection   May 2024

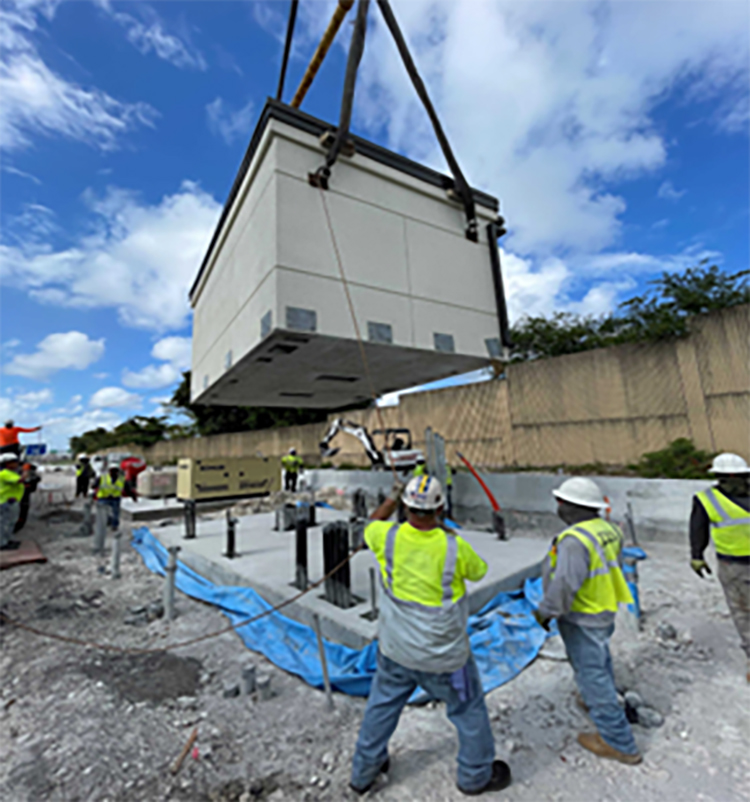

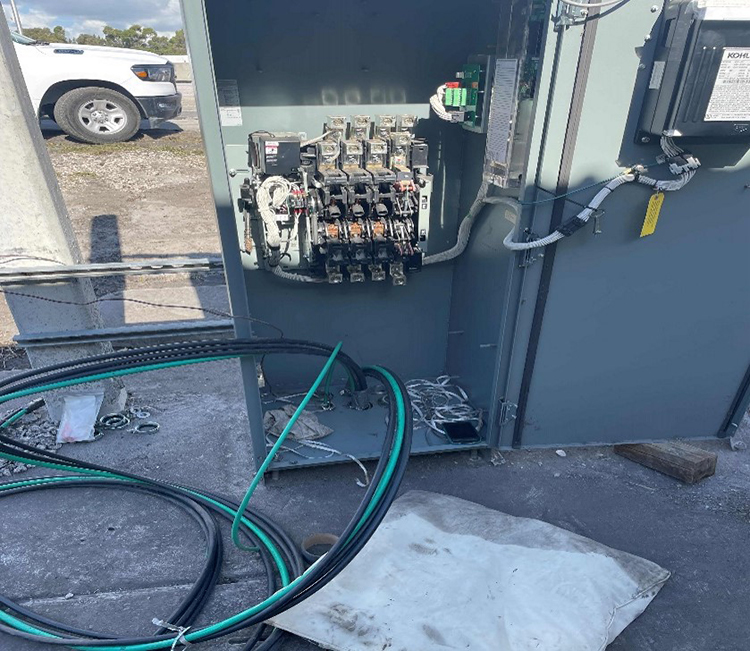

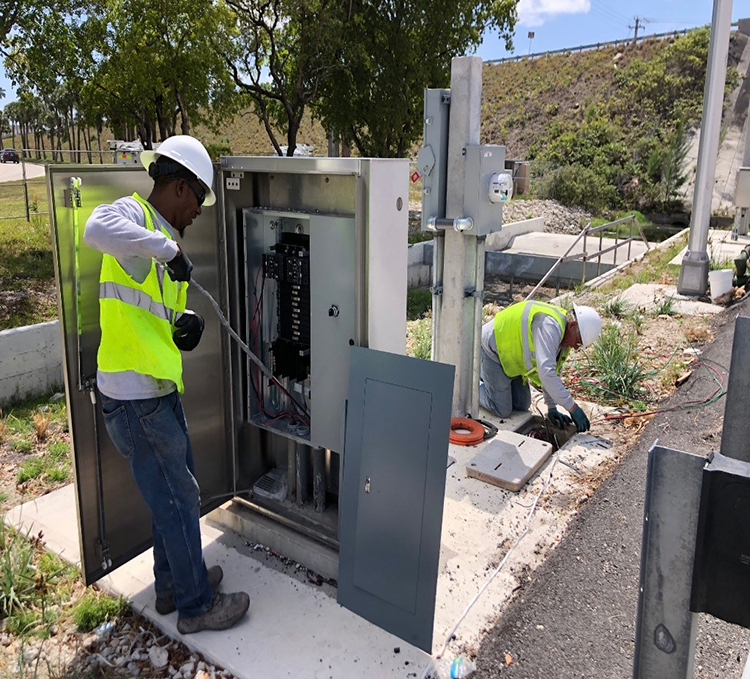

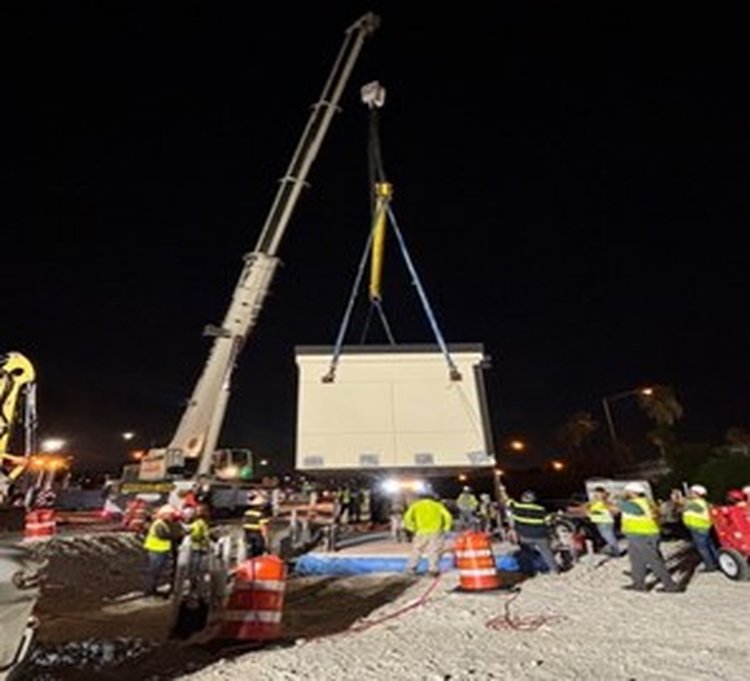

Installation of power conductors at Automatic Transfer Switch   May 2024 Bridge 8 (Griffin Road)   I 95 Sout hbound Deck Widening   May 2024 Installation of camera lowering devices for maintenance access on news ITS Poles   May 2024 Preparation of cast in place concrete slab foundation for Toll Building at Toll Site 1   May 2024

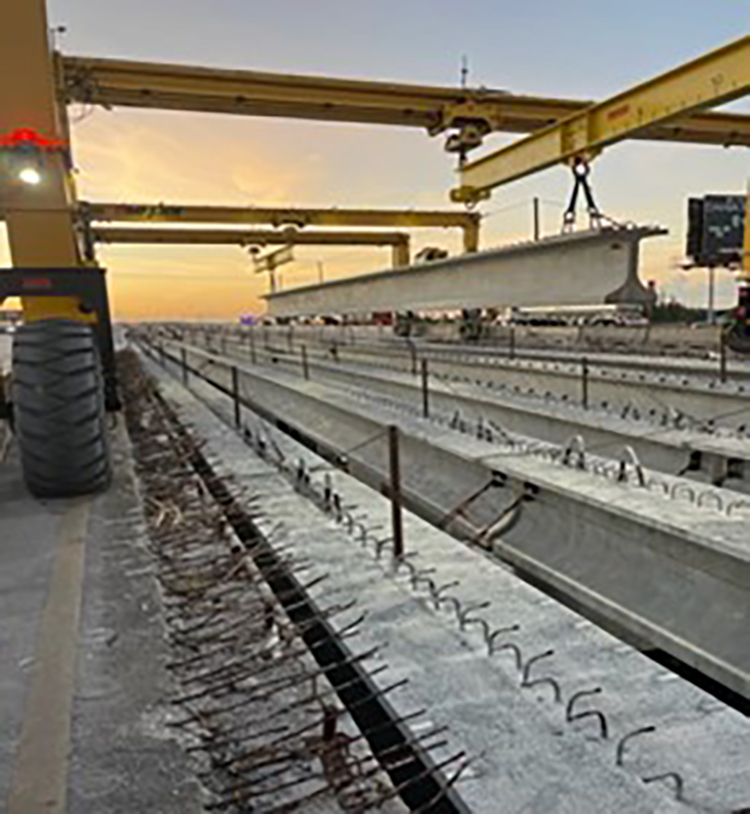

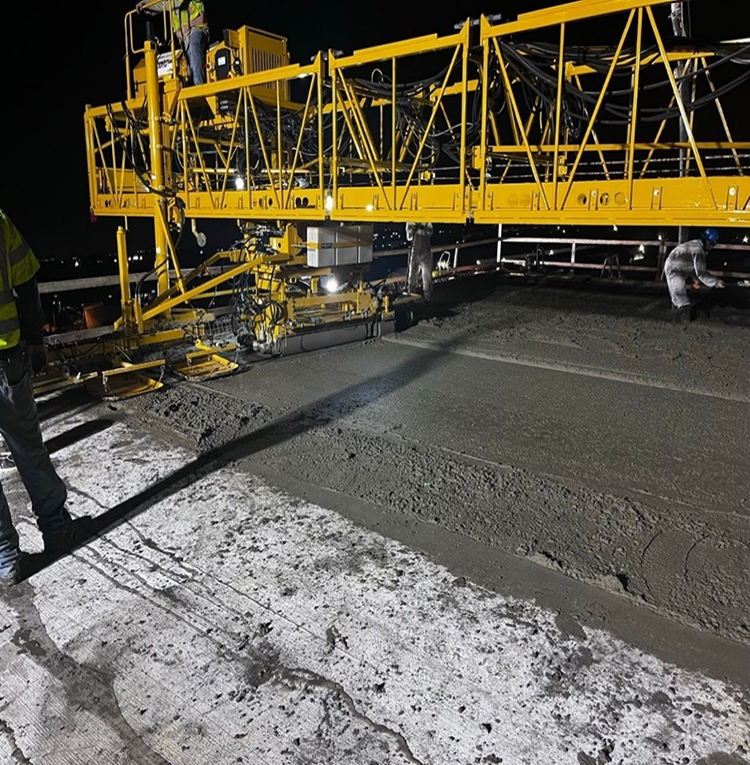

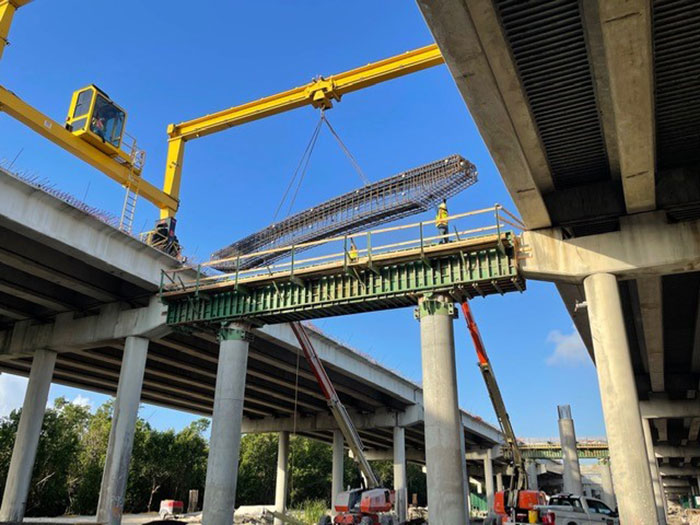

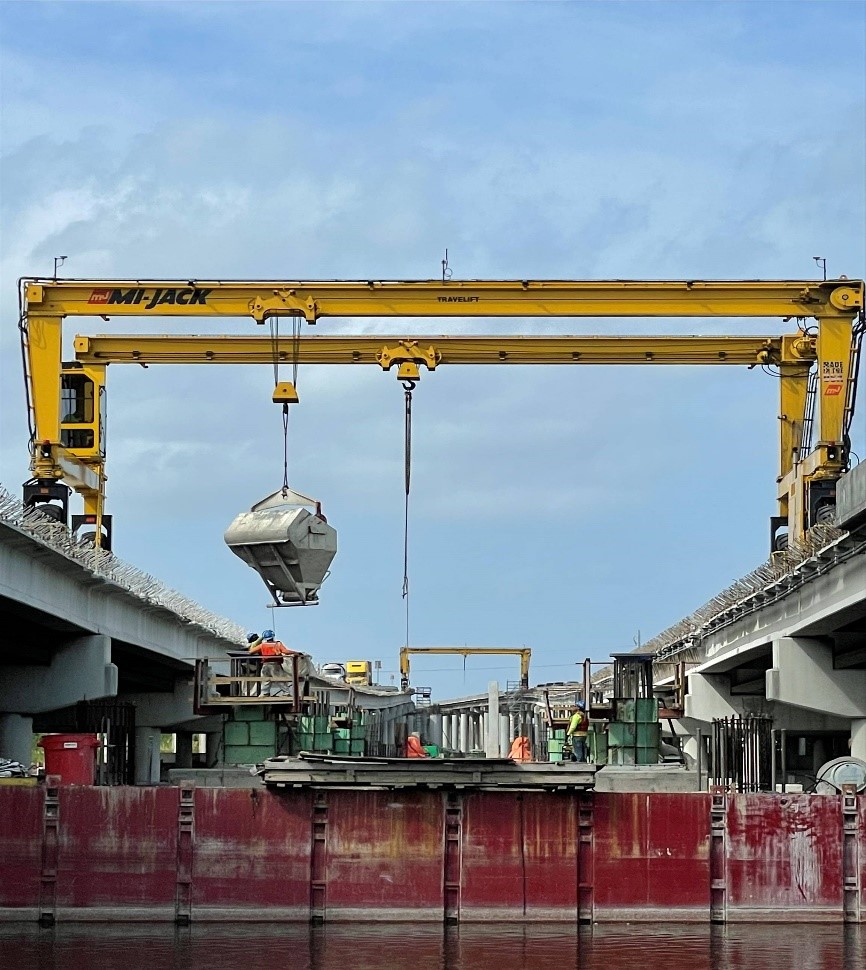

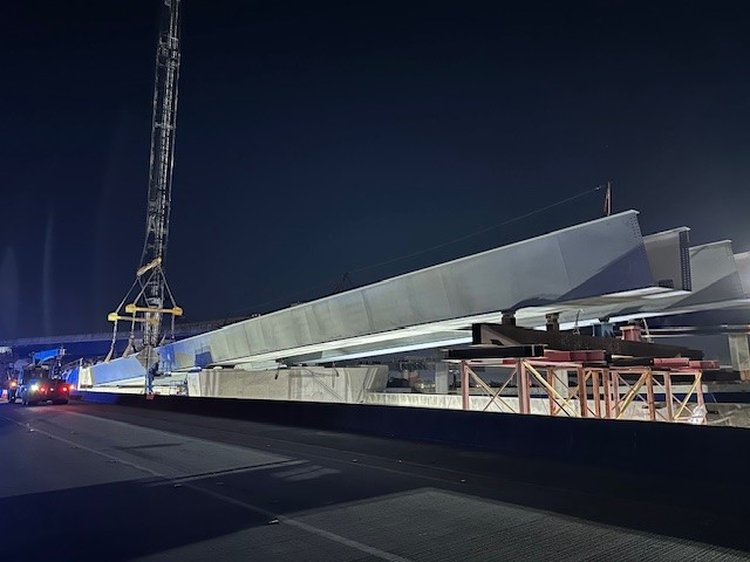

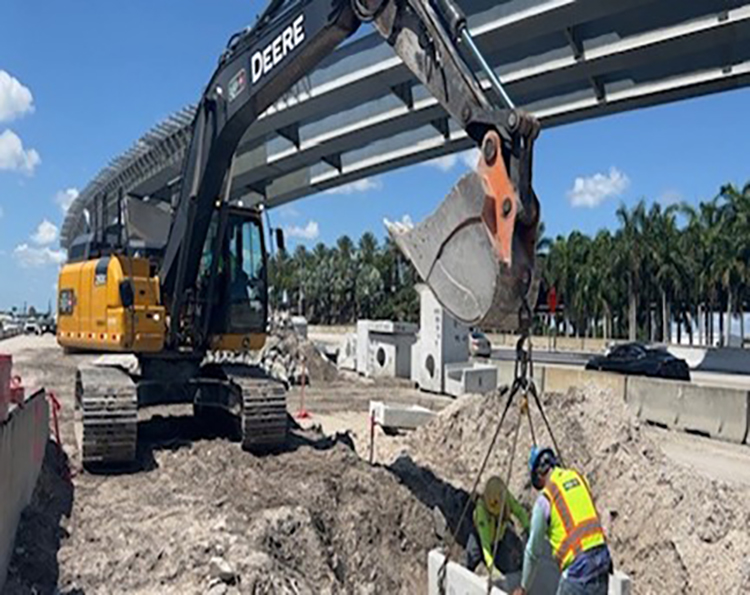

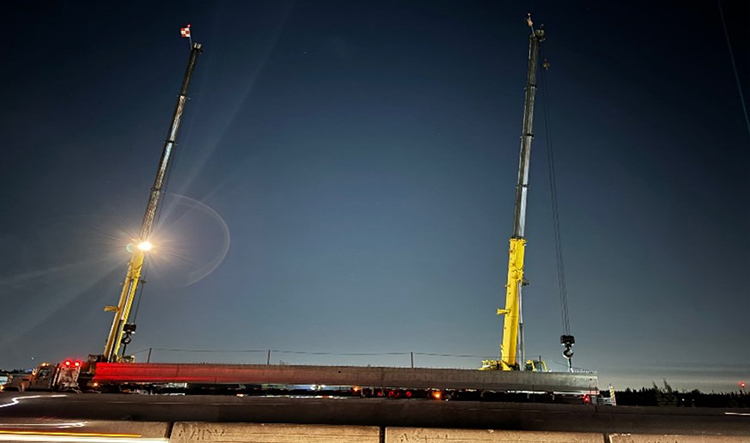

Bridge 11 (I 595 eastbound) Outside Precast Beams Erection   May 2024 Bridge 8 (Griffin Road)   I 95 Southb ound Deck Widening   May 2024 (2) Bridge 12 (Proposed Direct Connect) Nightly Deck Pours   May 2024 Grading swale at Taft Street SE corner   May 2024

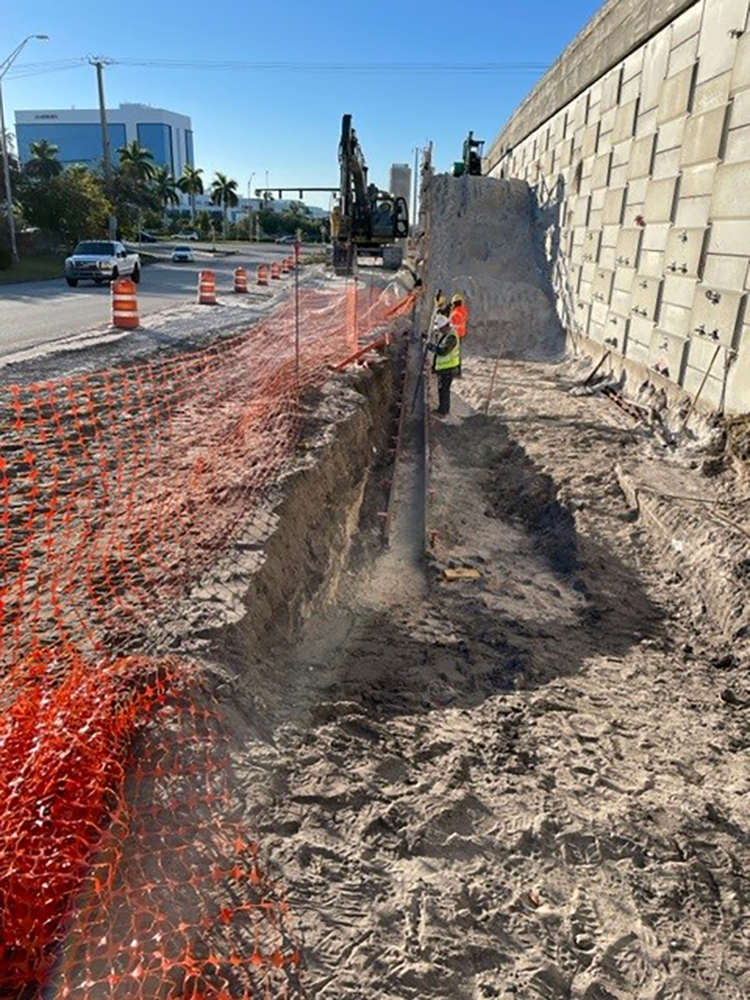

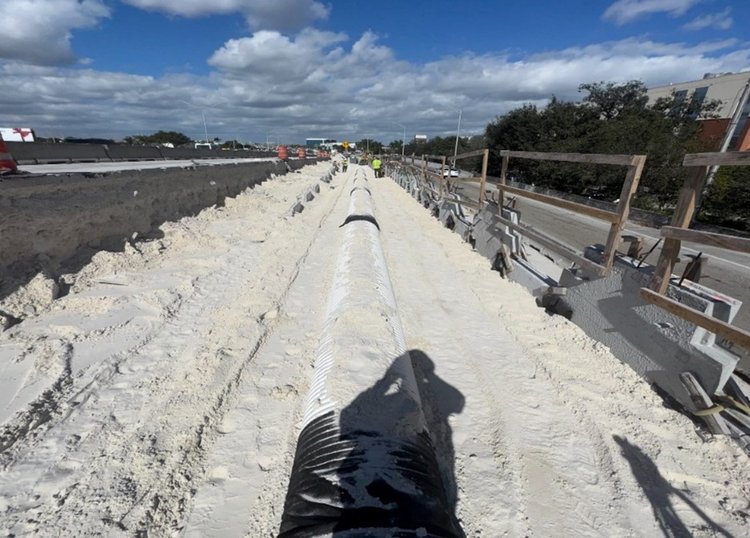

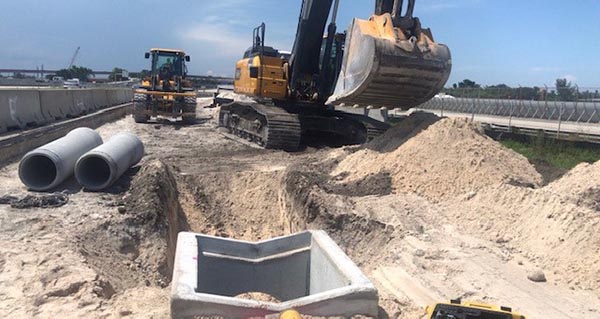

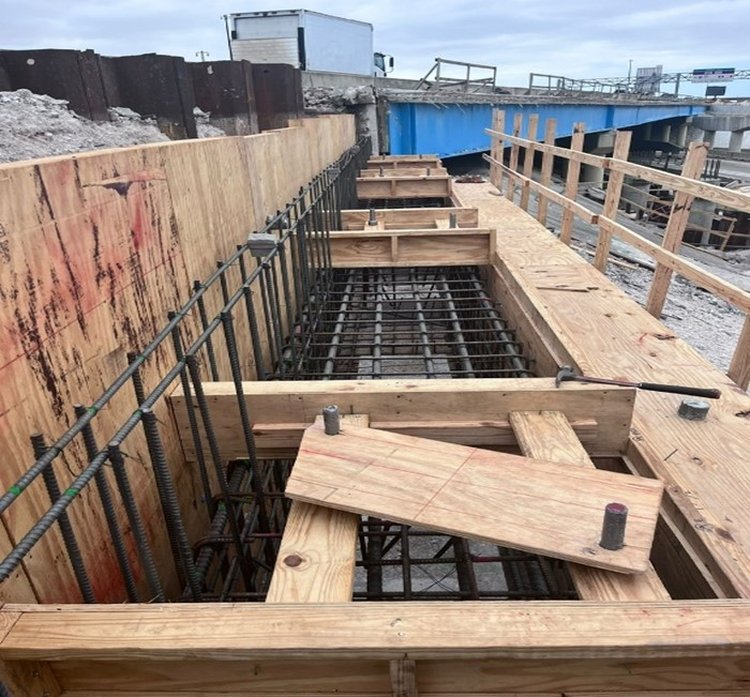

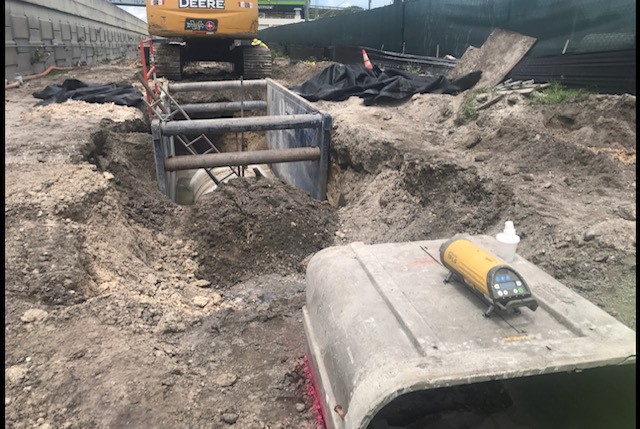

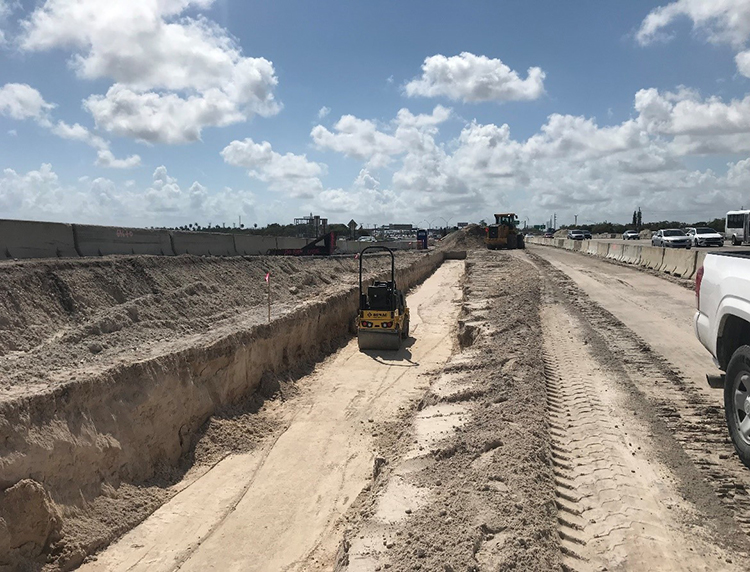

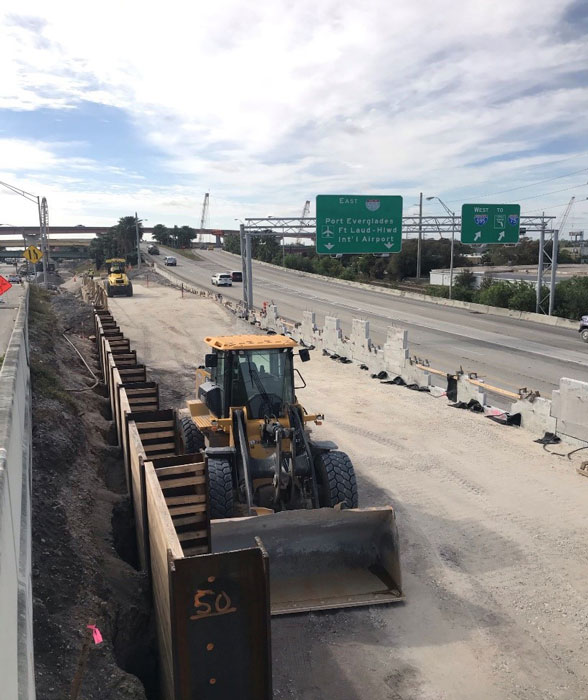

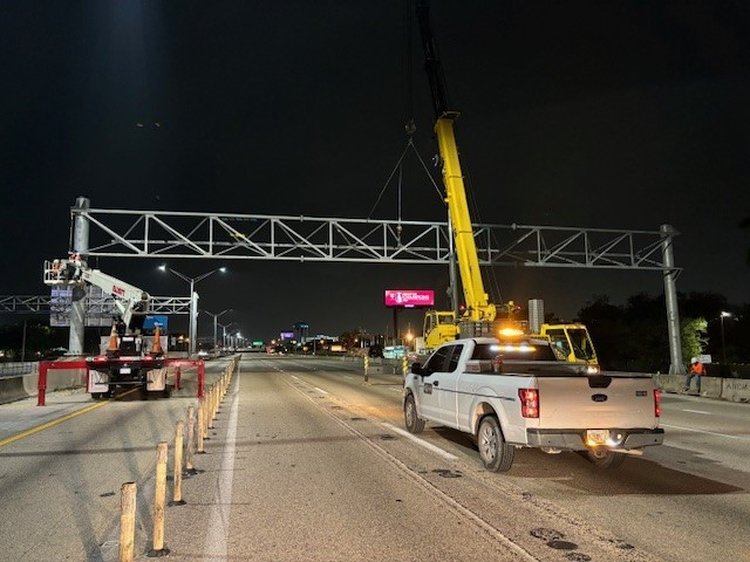

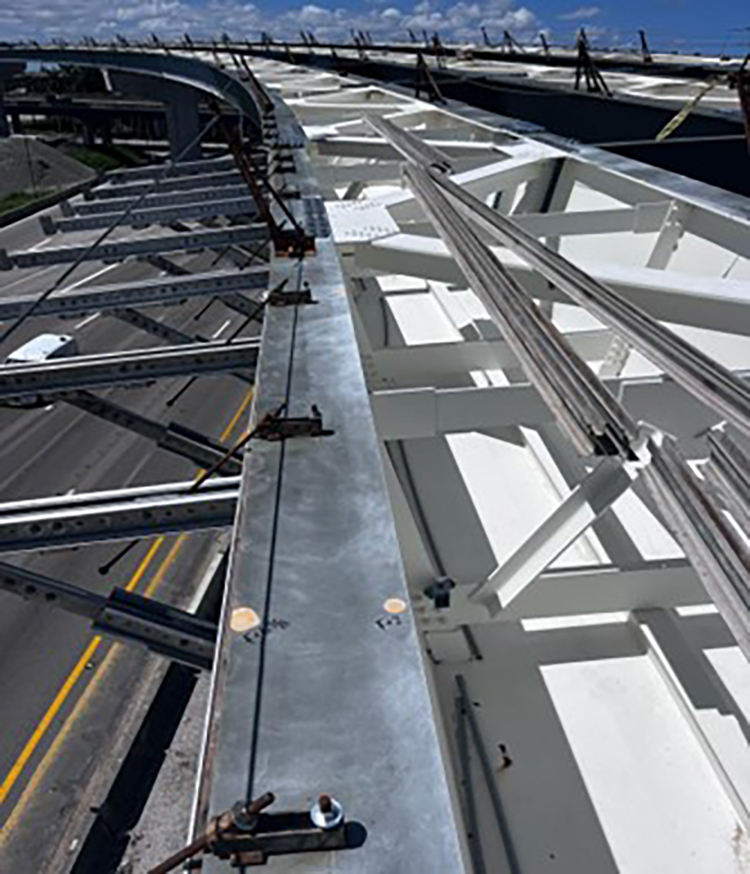

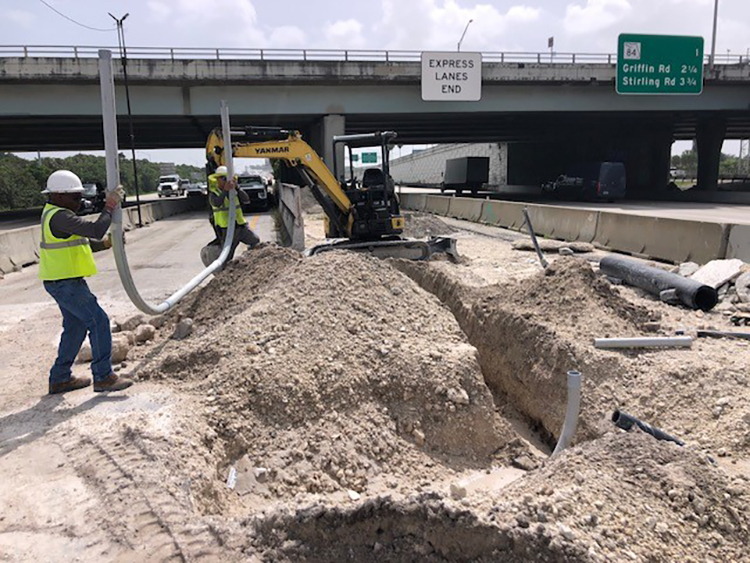

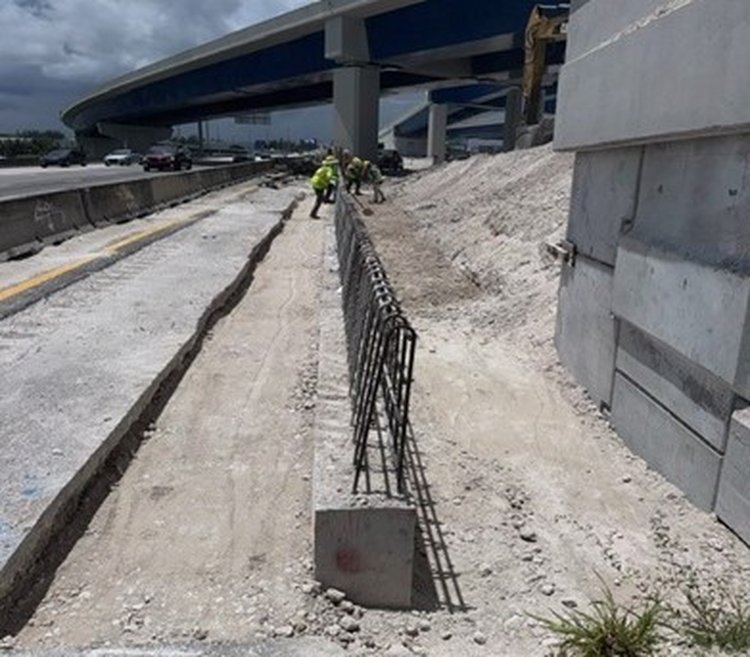

Assembly and Installation of sign panels on overhead structures   May 2024 Placing select fill at MSE Wall on I 95 Southbound Ramp to Stirling Road   May 2024 Grading swale and slope at SW 32nd Street   May 2024 Backfilling inlet and pipe I 95 Northbound off Ramp to Hollywood Boulevard   May 2024

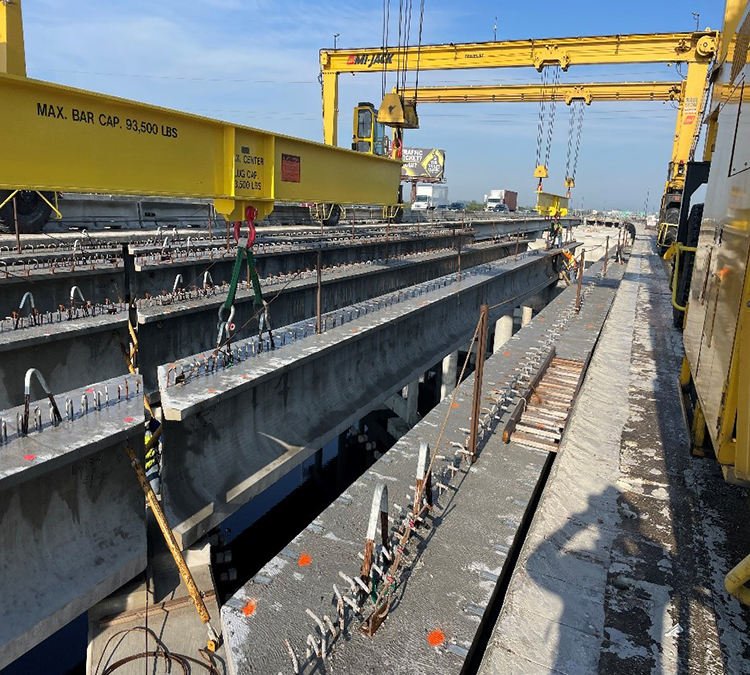

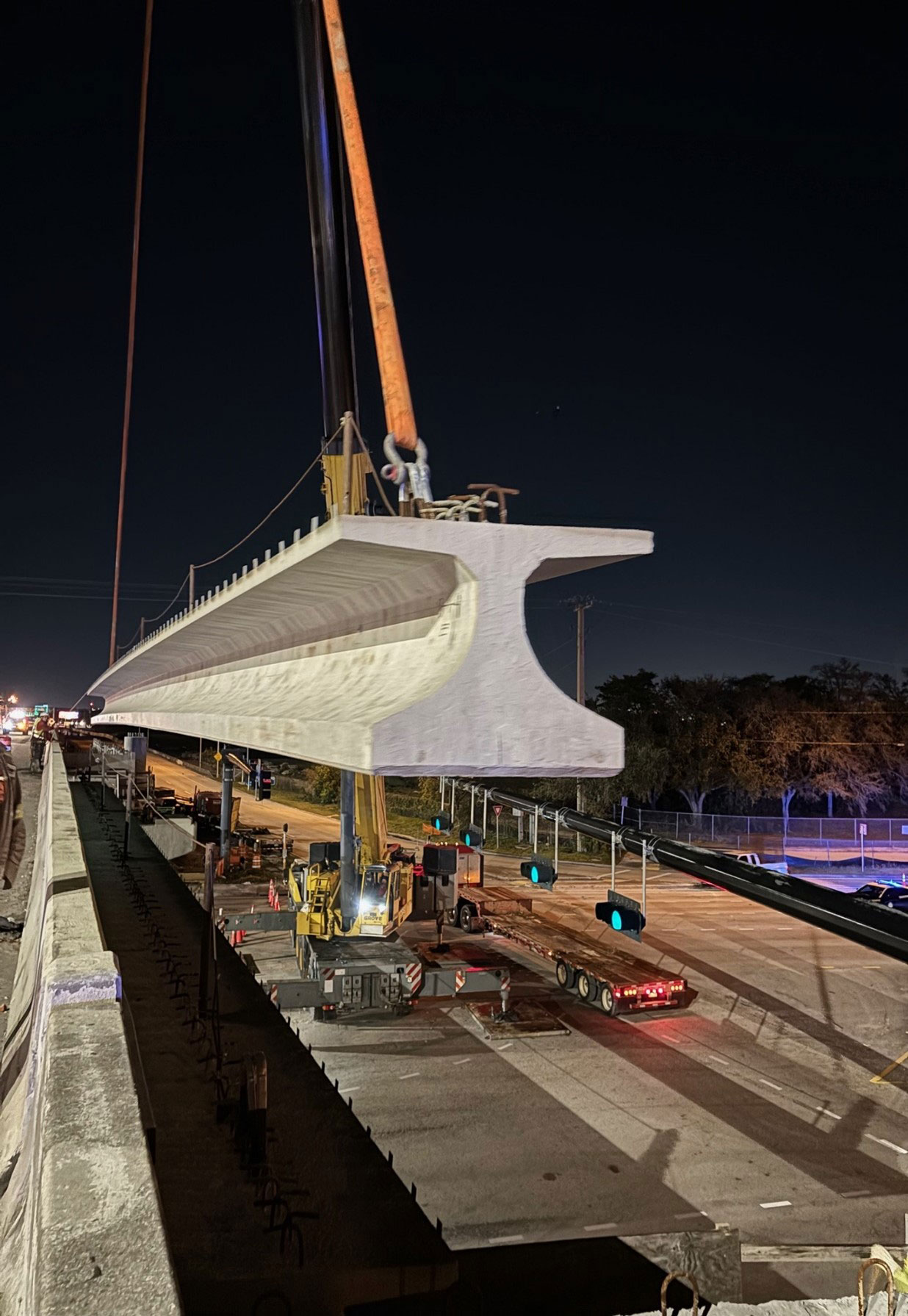

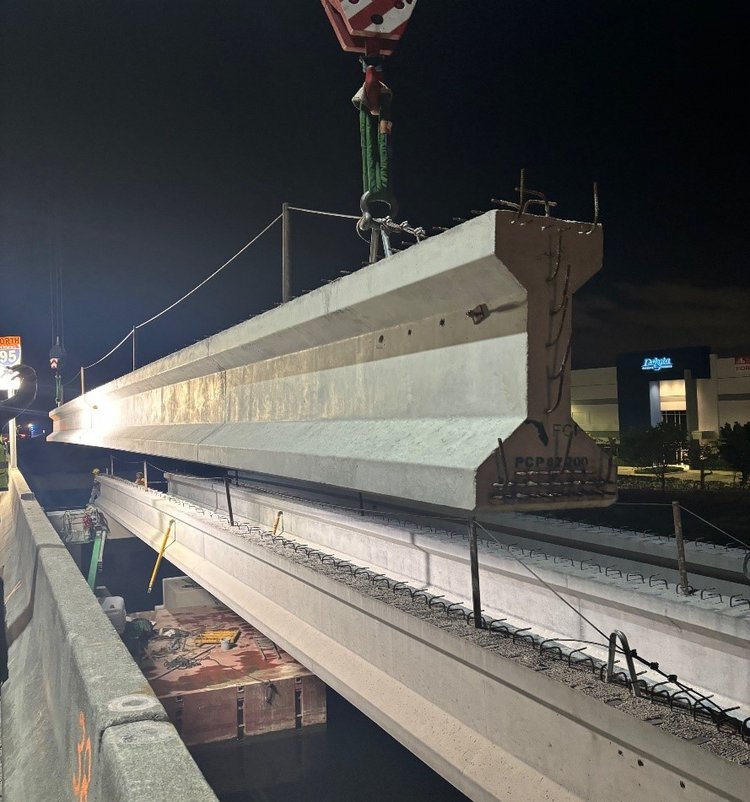

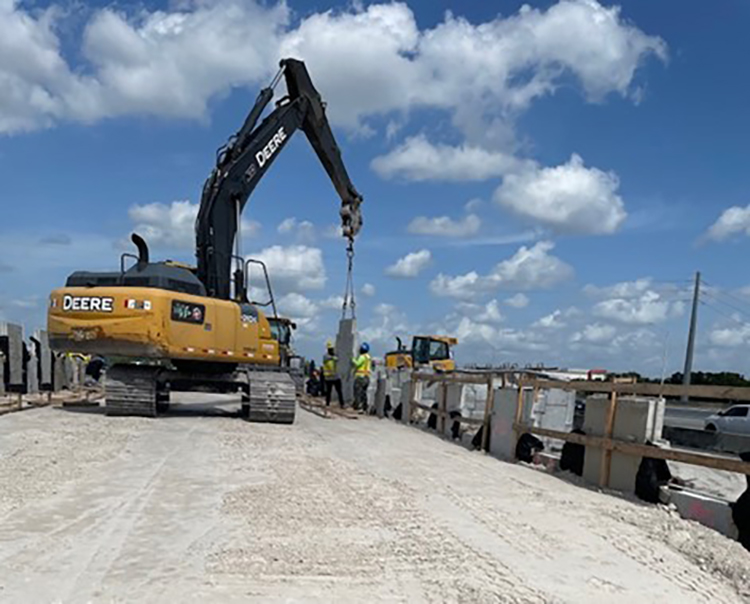

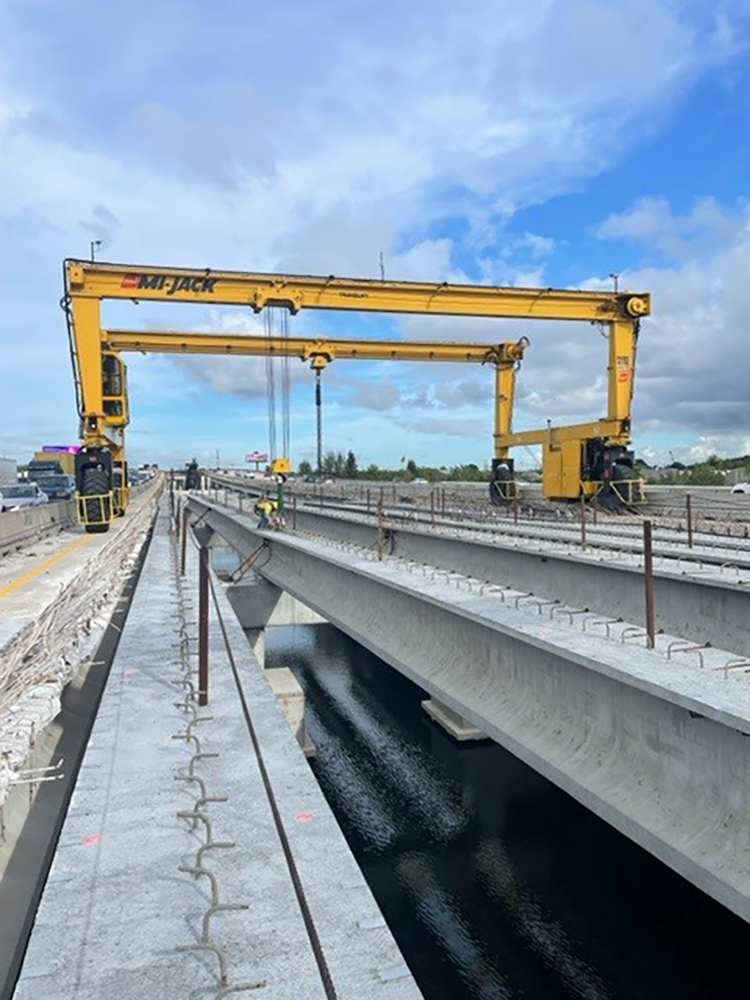

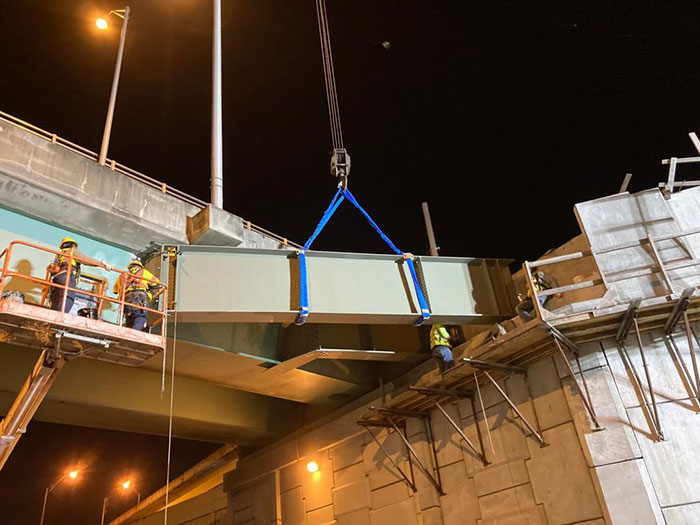

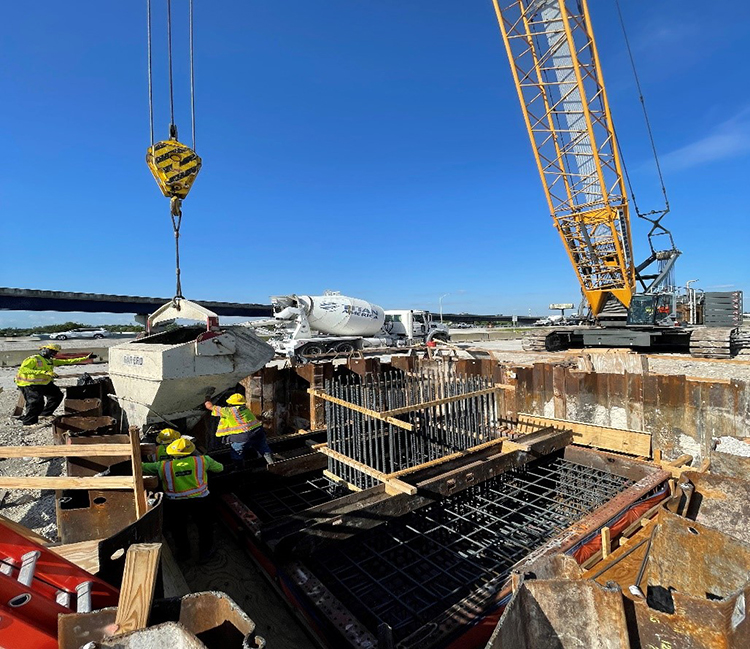

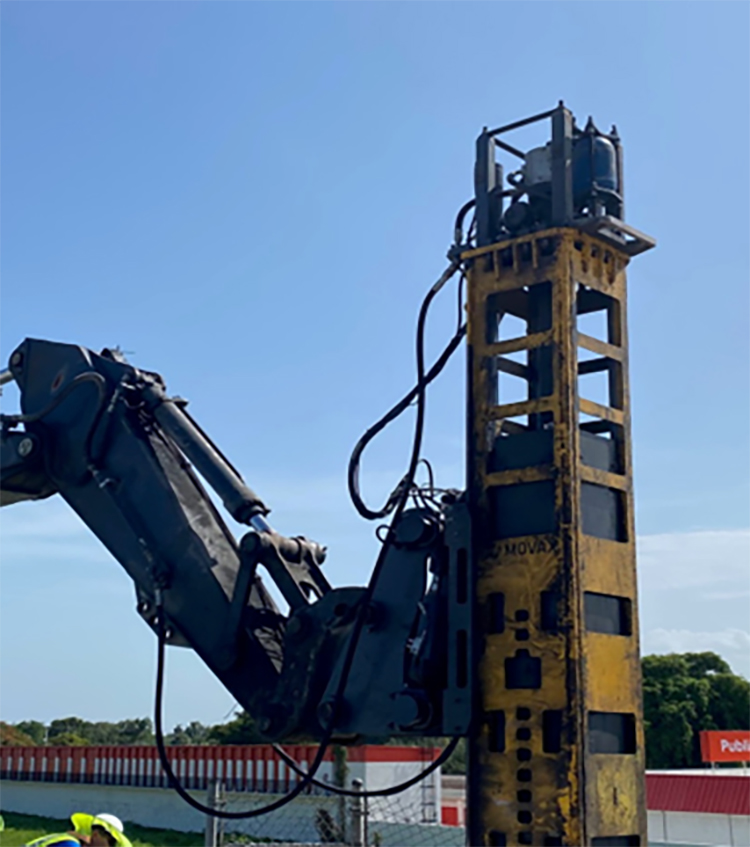

Bridge 11 (I 595 eastbound) Outside Precast Beams Erection   May 2024 (3) Bridge 14 (Proposed Direct Connect) Pier 5 Column construction   May 2024 Bridge 13A (Proposed Direct Connect) SIP & Shear Studs Placement   May 2024 (2) Finishing lime rock base on I 95 Southbound between Taft Street and Johnson Street   May 2024

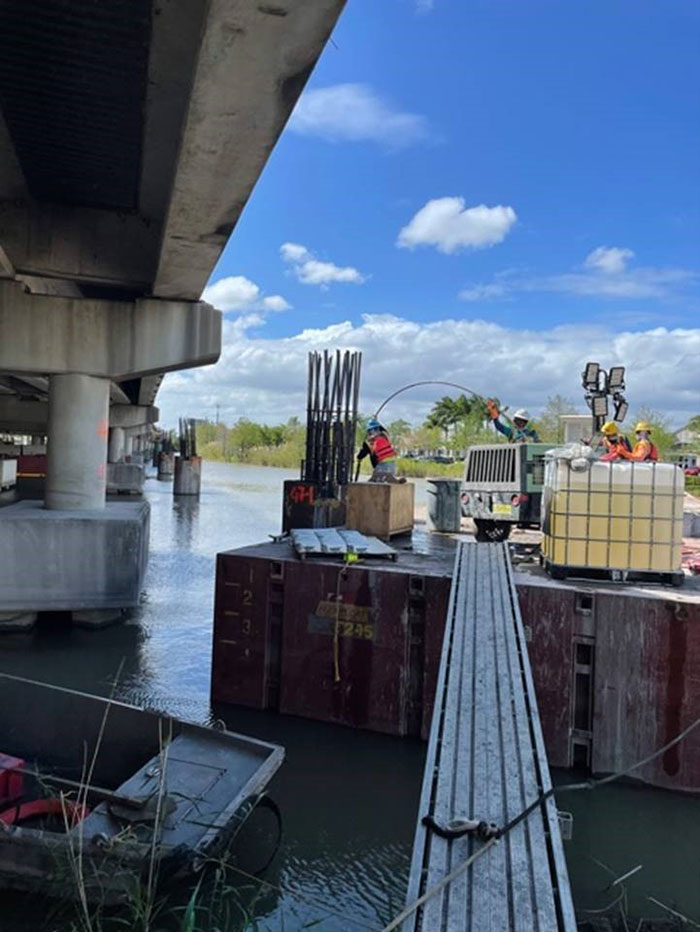

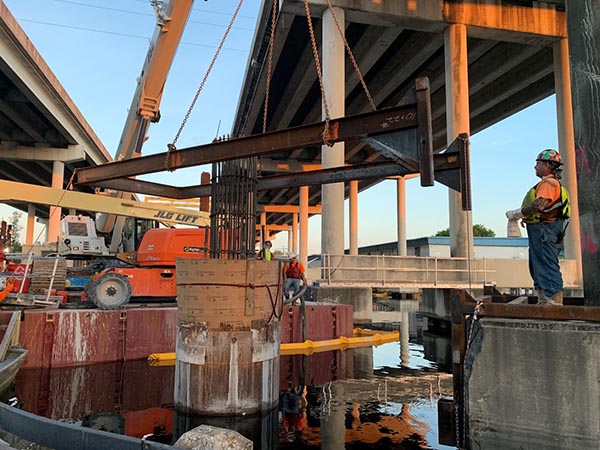

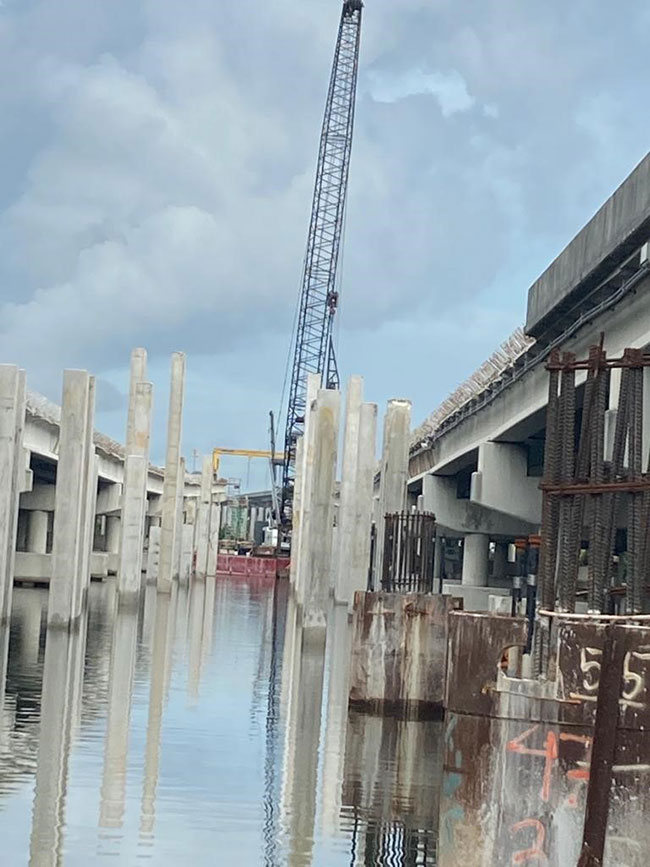

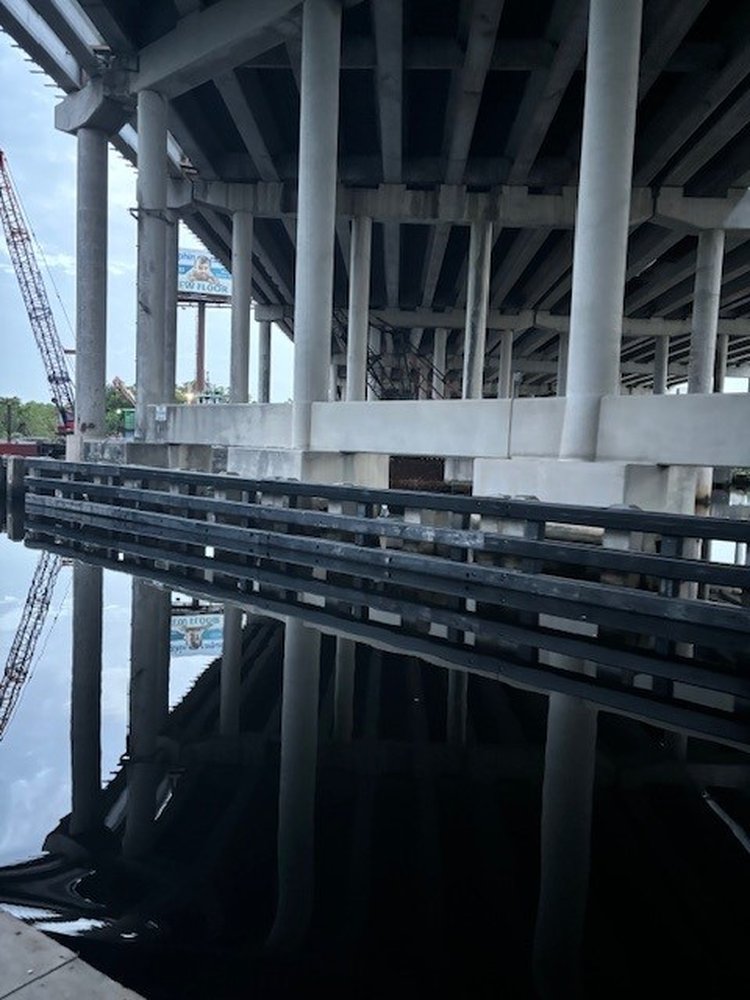

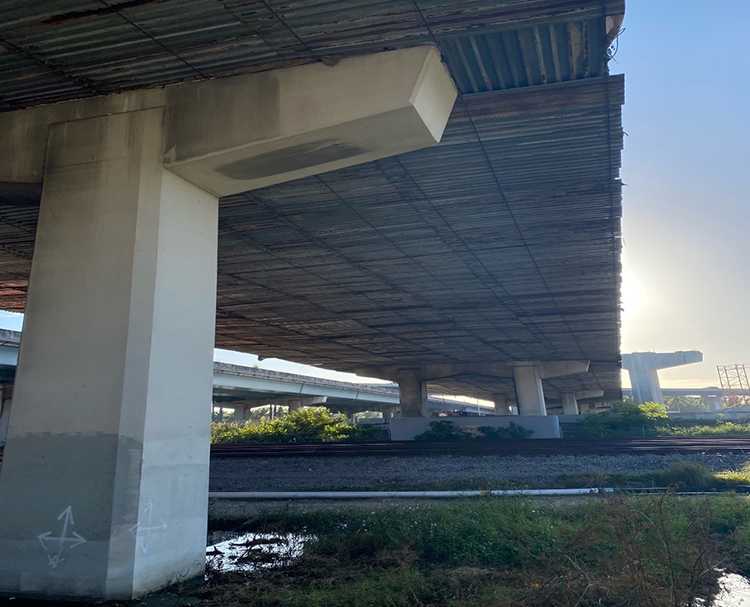

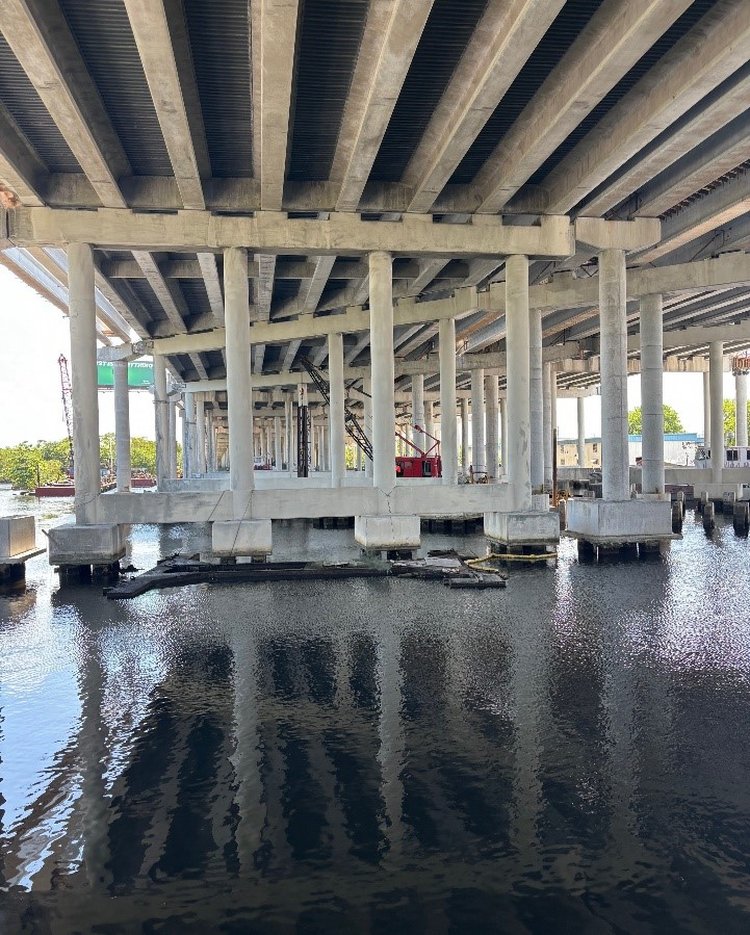

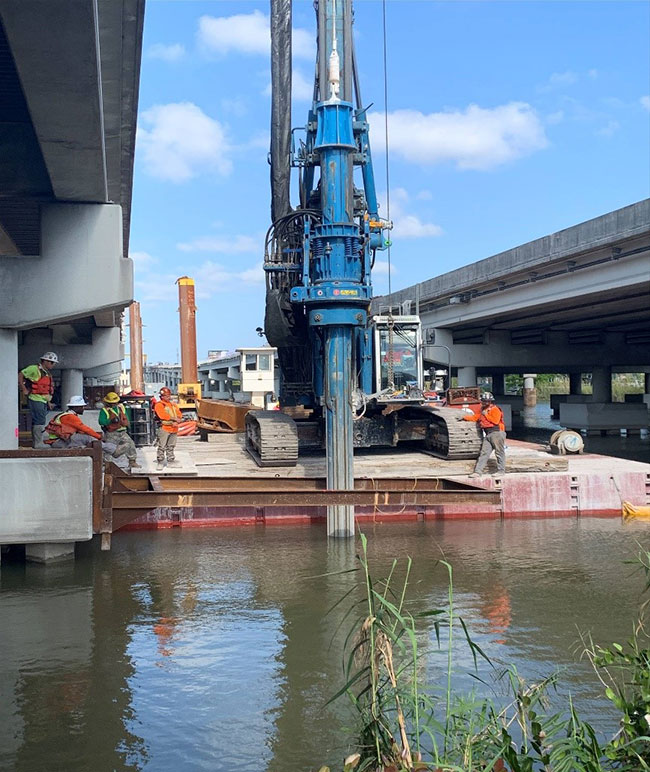

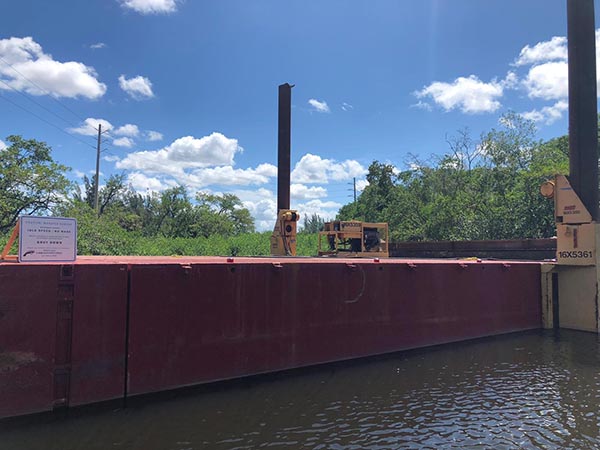

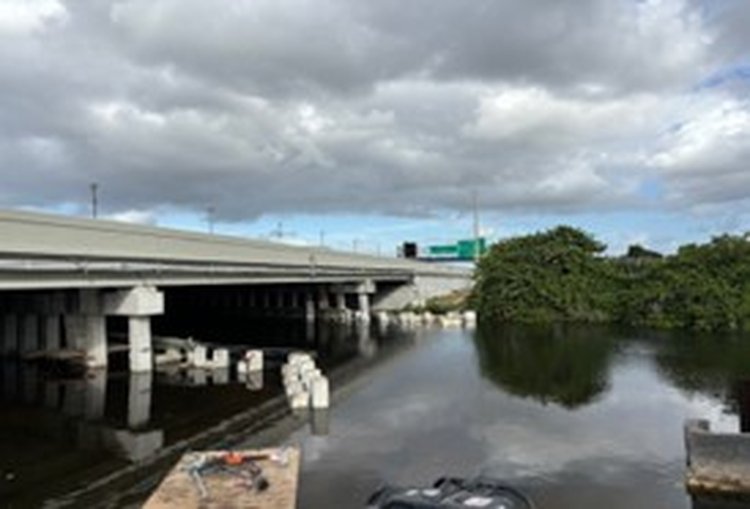

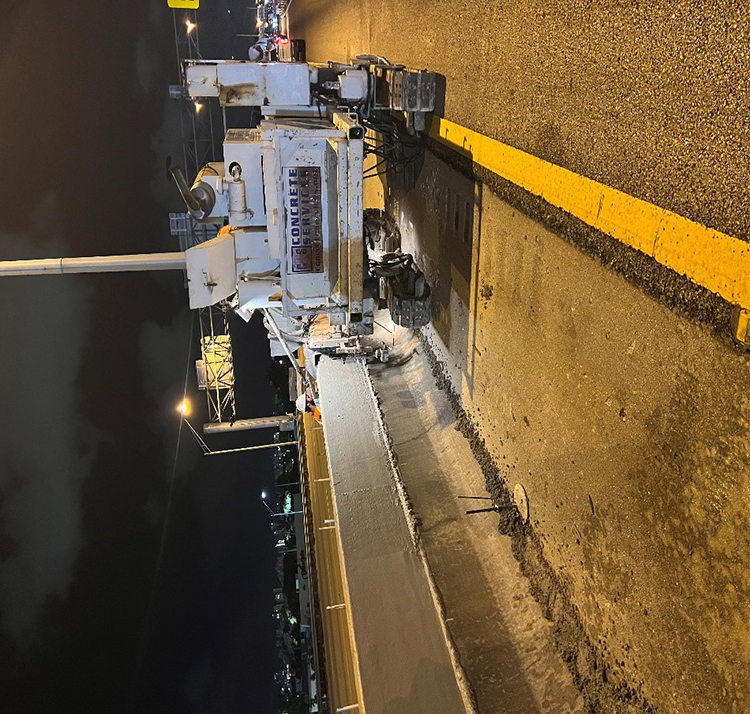

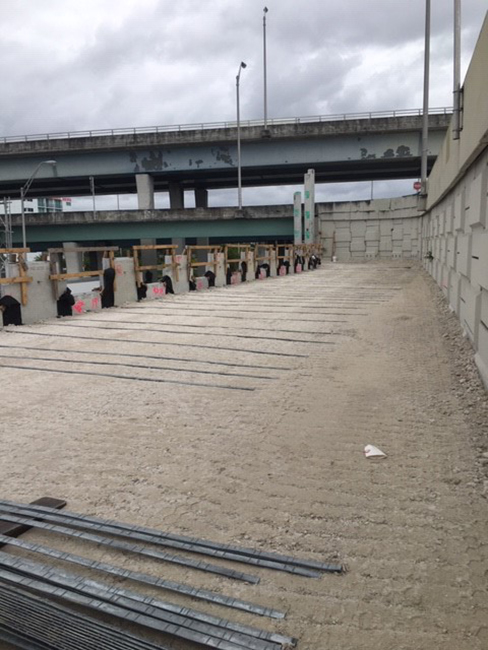

Removing existing MSE Wall and installing temporary railing I 95 northbound to Griffin Road   May 2024 Pouring concrete for Toll Building at Toll Site 1   May 2024 Bridge 11 (I 595 eastbound) Outside Precast Beams Erection   May 2024 (2) Pond Apple Slough at I 595_June 2024

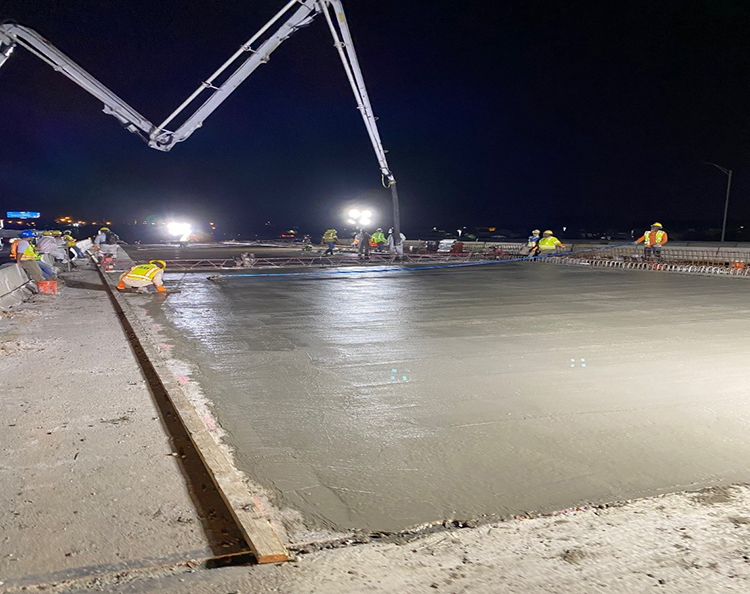

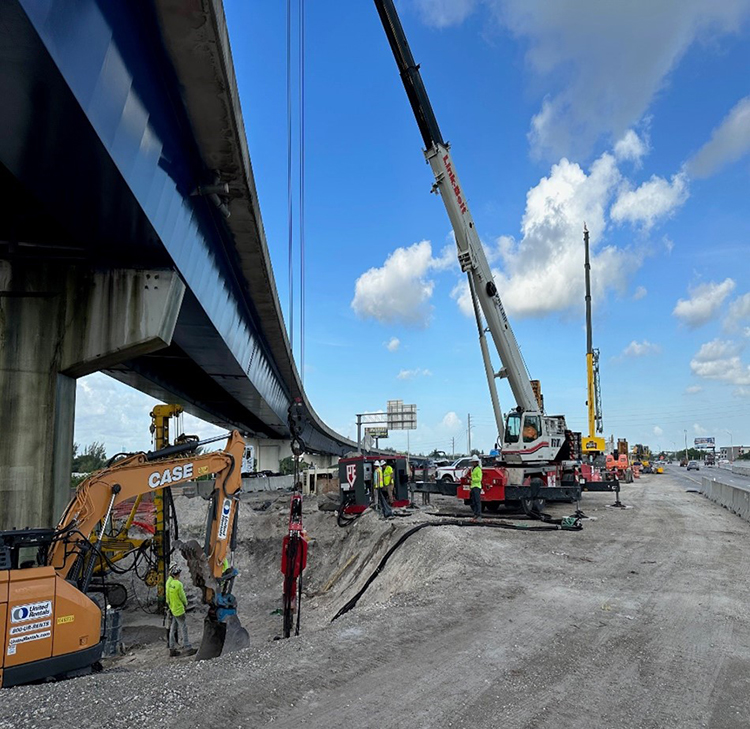

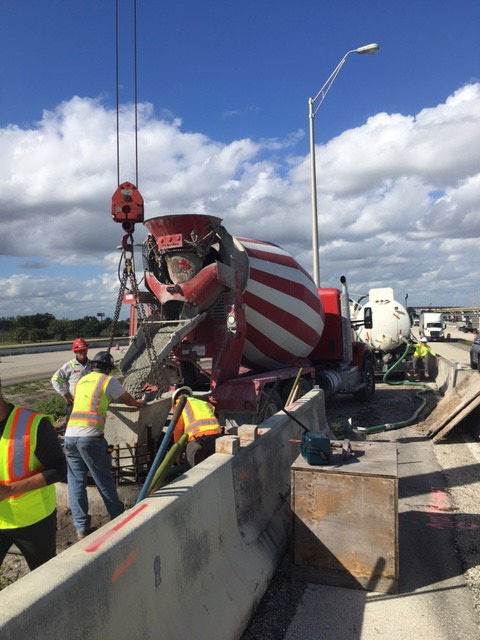

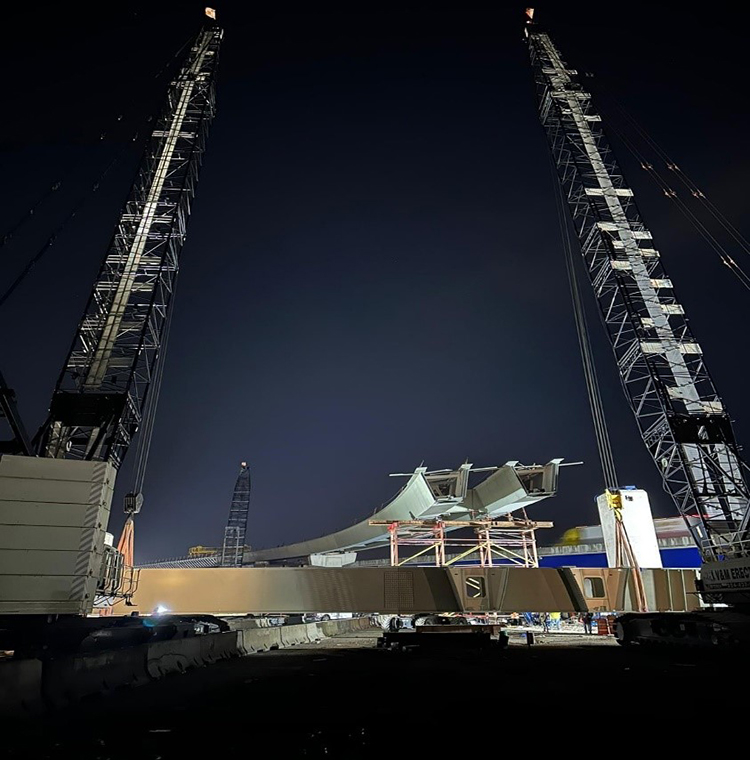

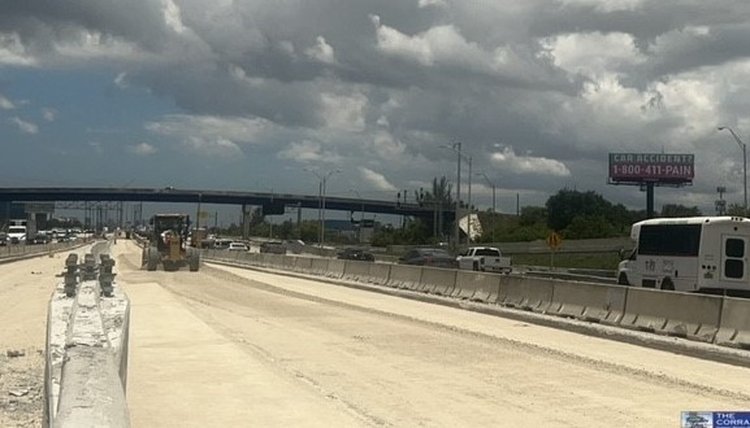

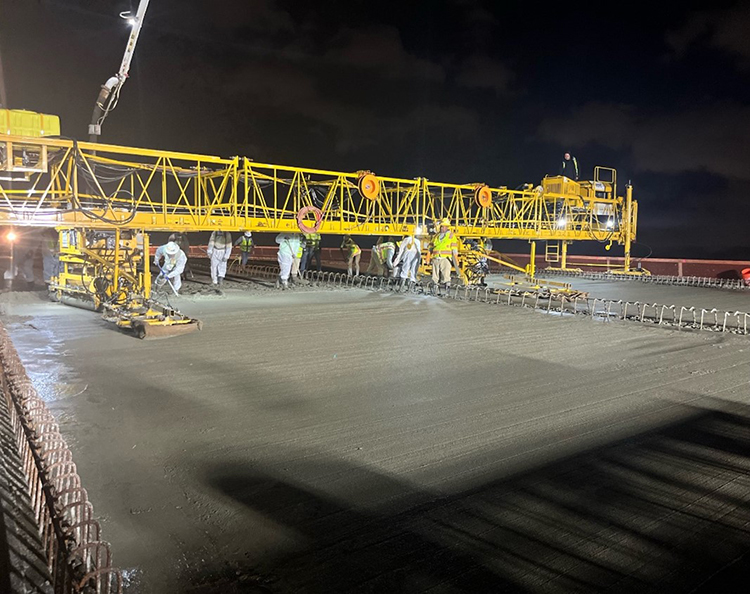

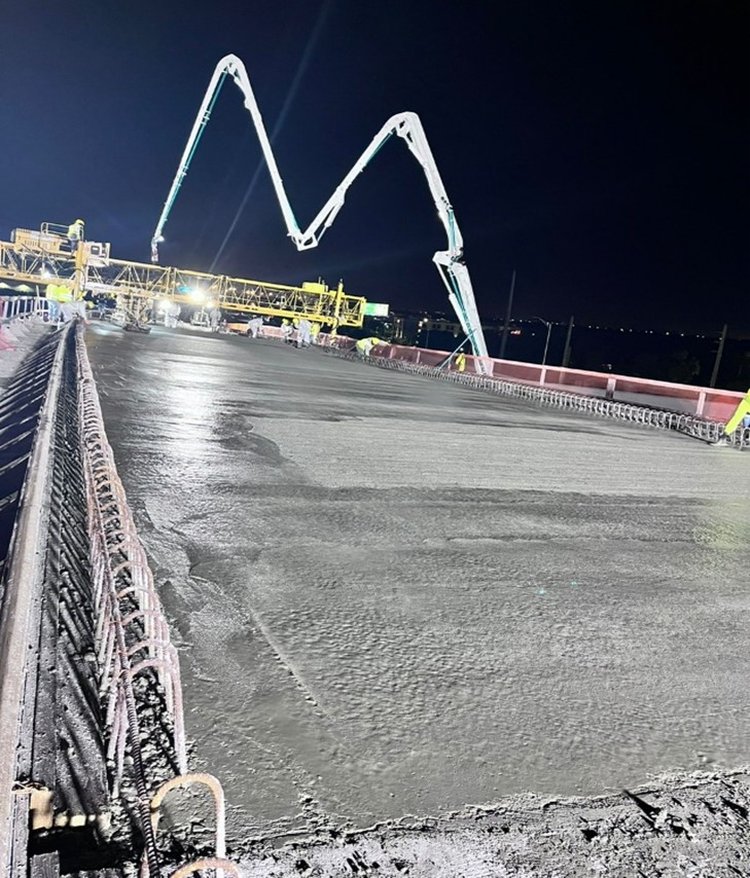

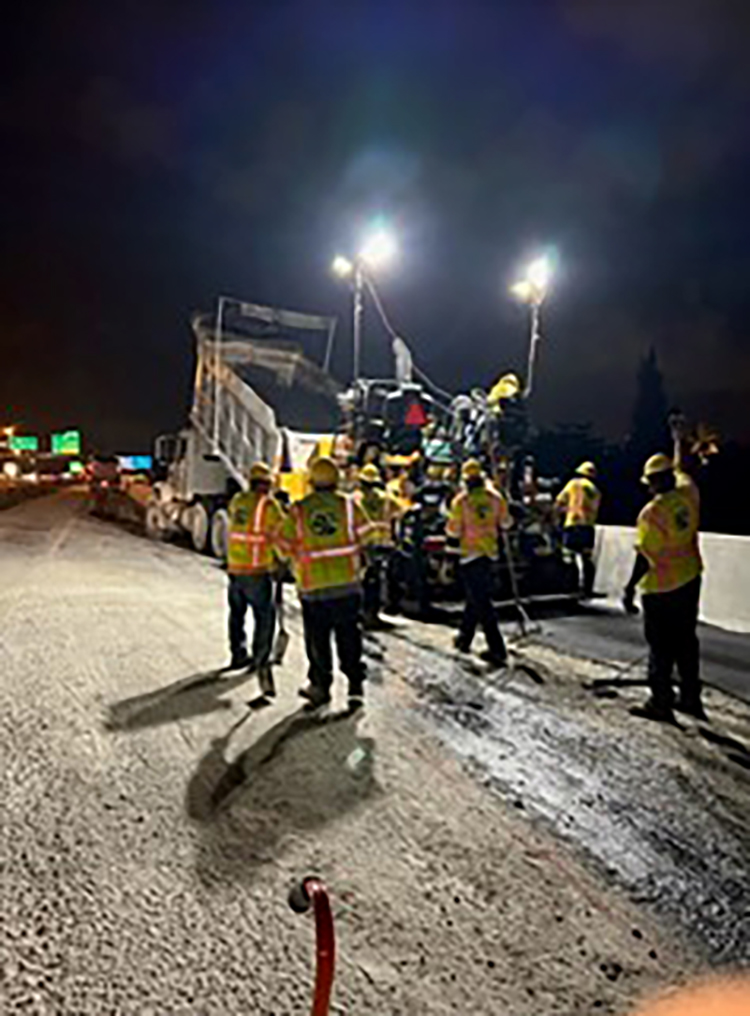

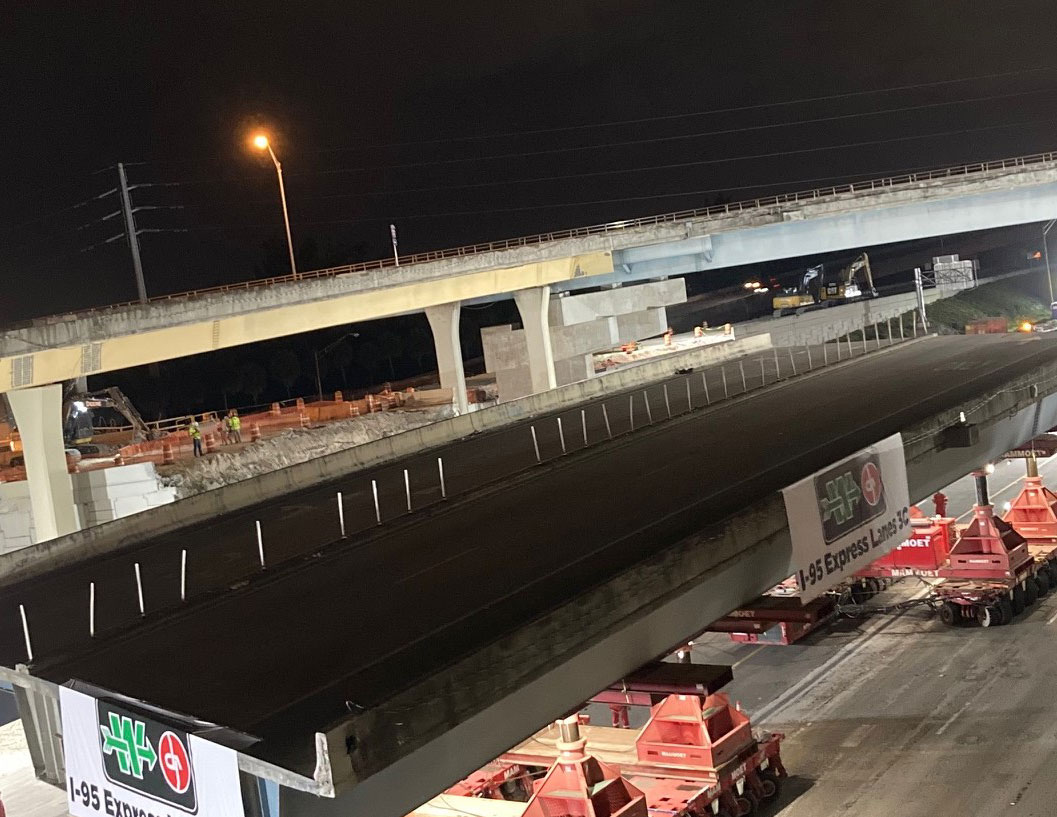

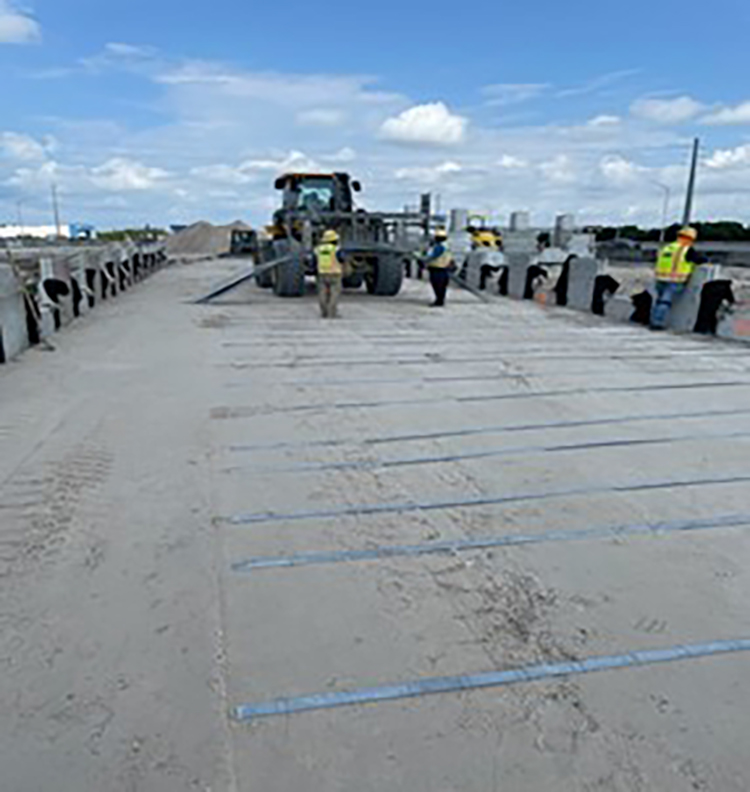

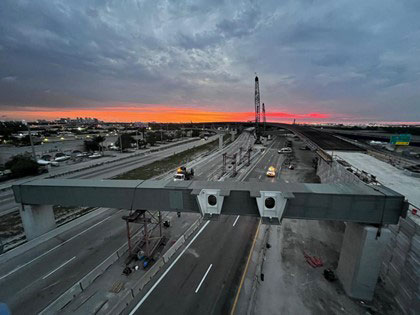

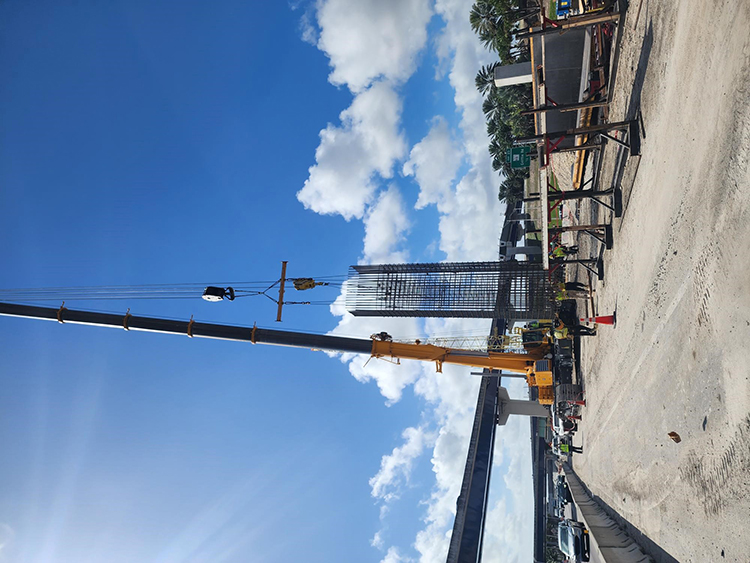

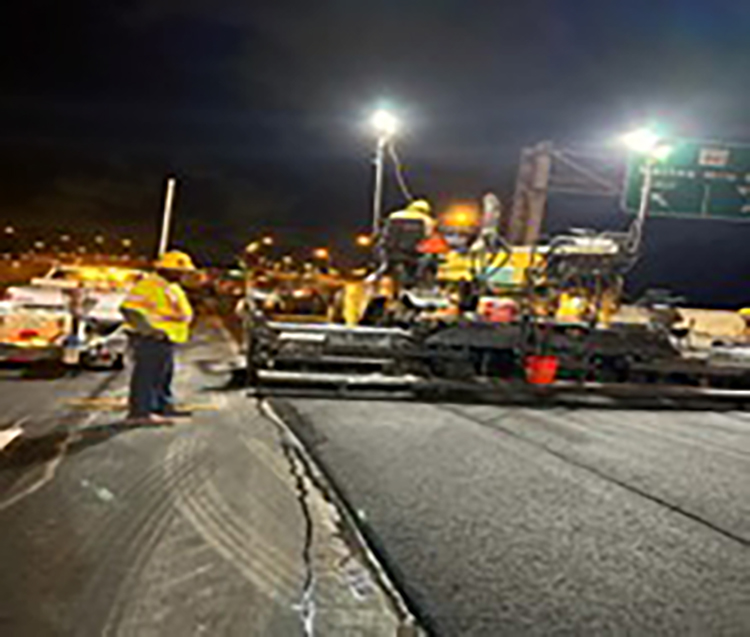

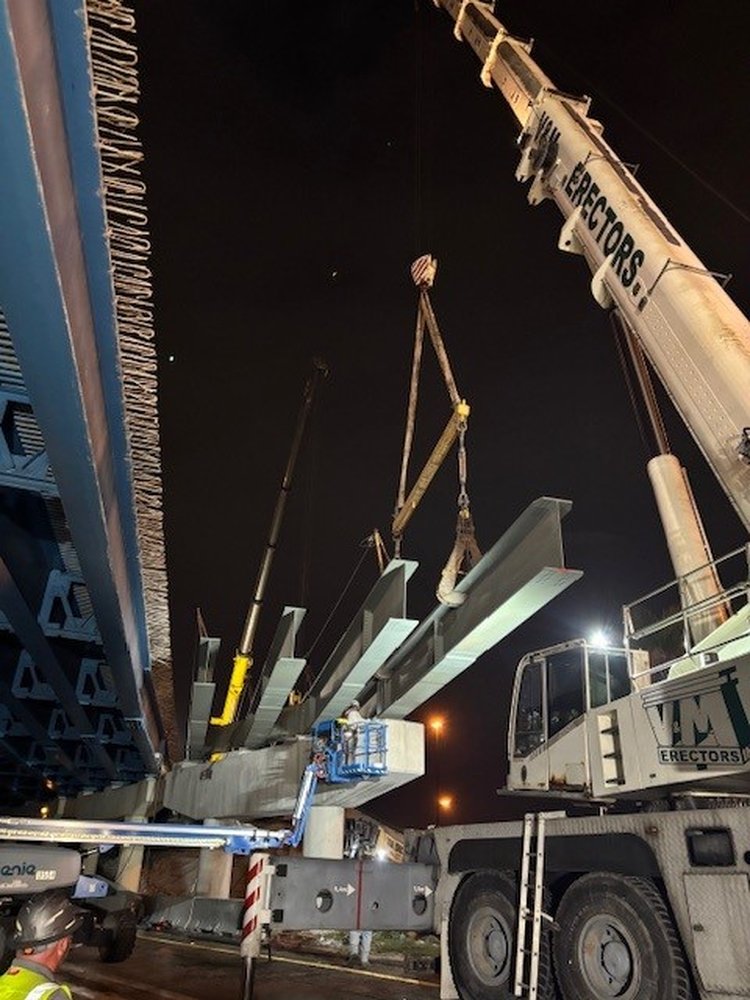

Bridge 12 proposed Direct Connector deck construction_ June 2024 I 95 NB Paving operations_June 2024 MSE wall construction_June 2024 Overhead DMS Installation at I 95 NB_ June 2024

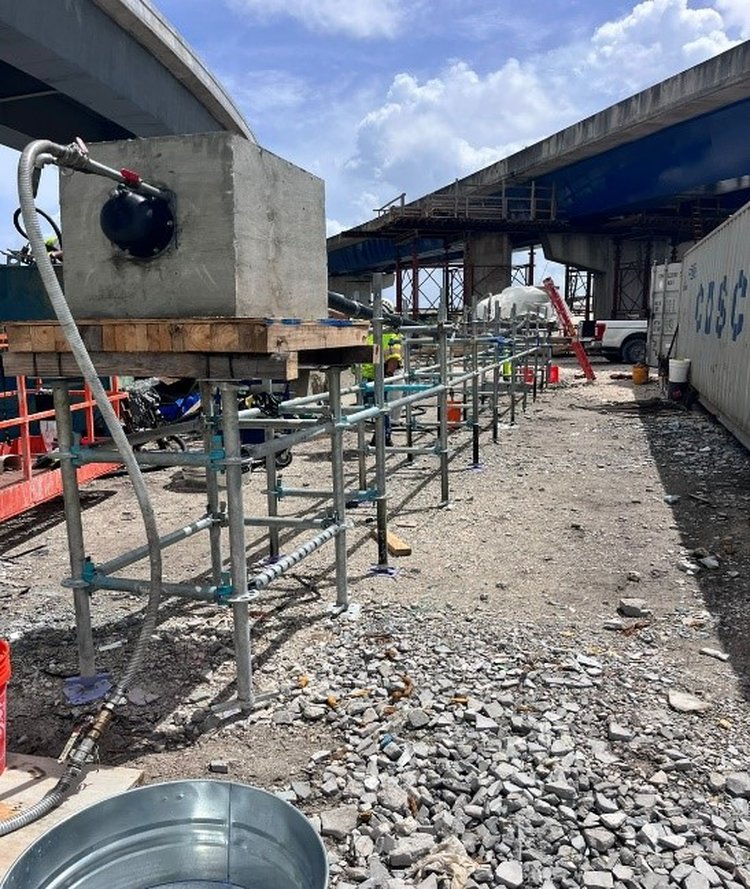

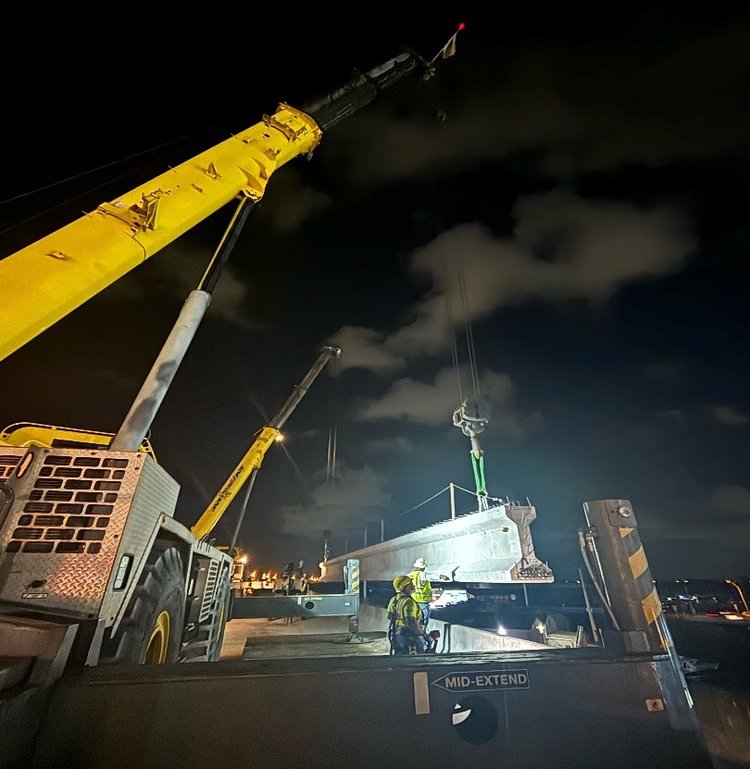

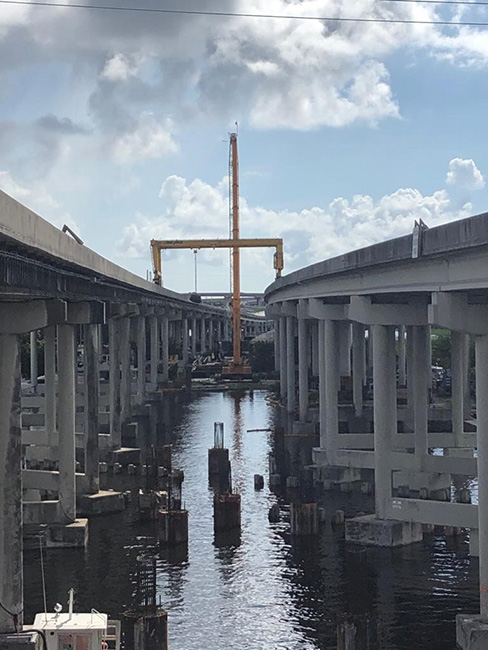

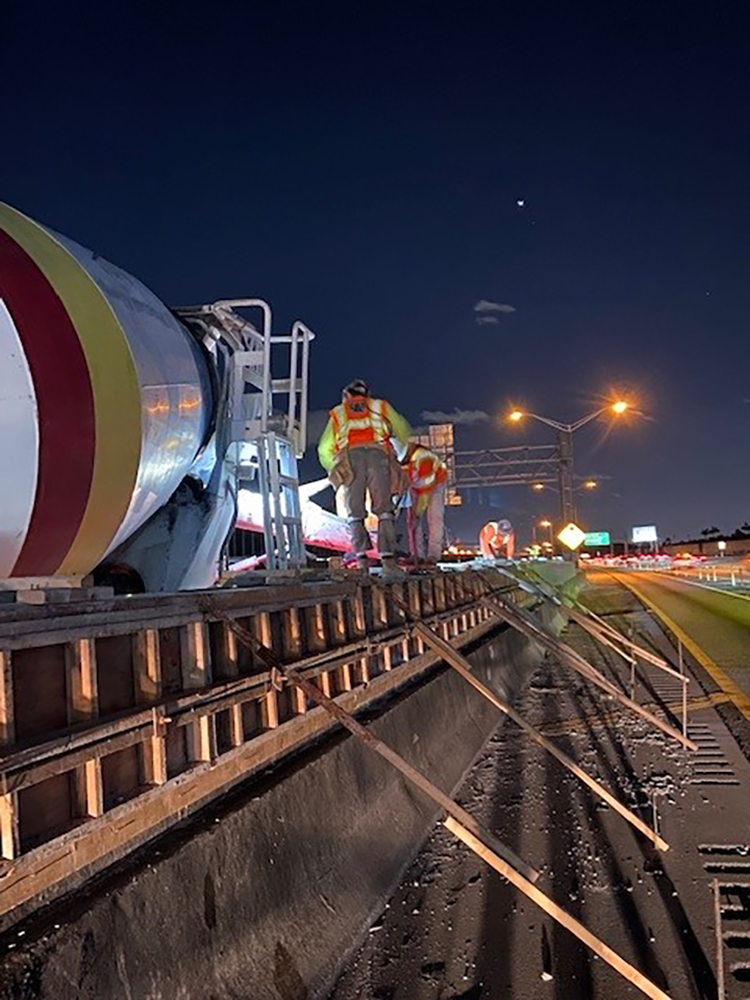

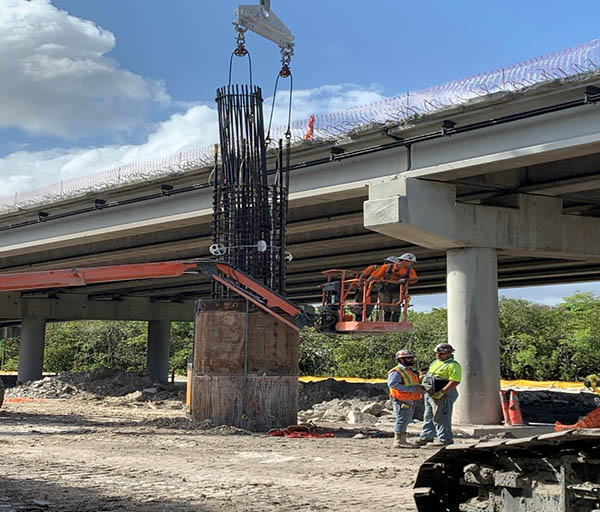

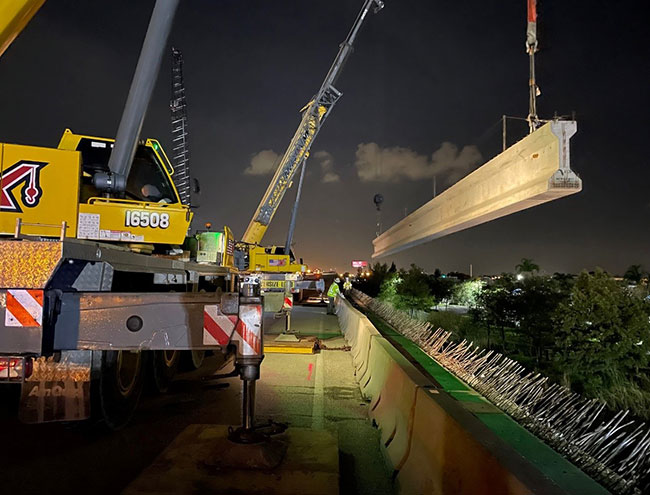

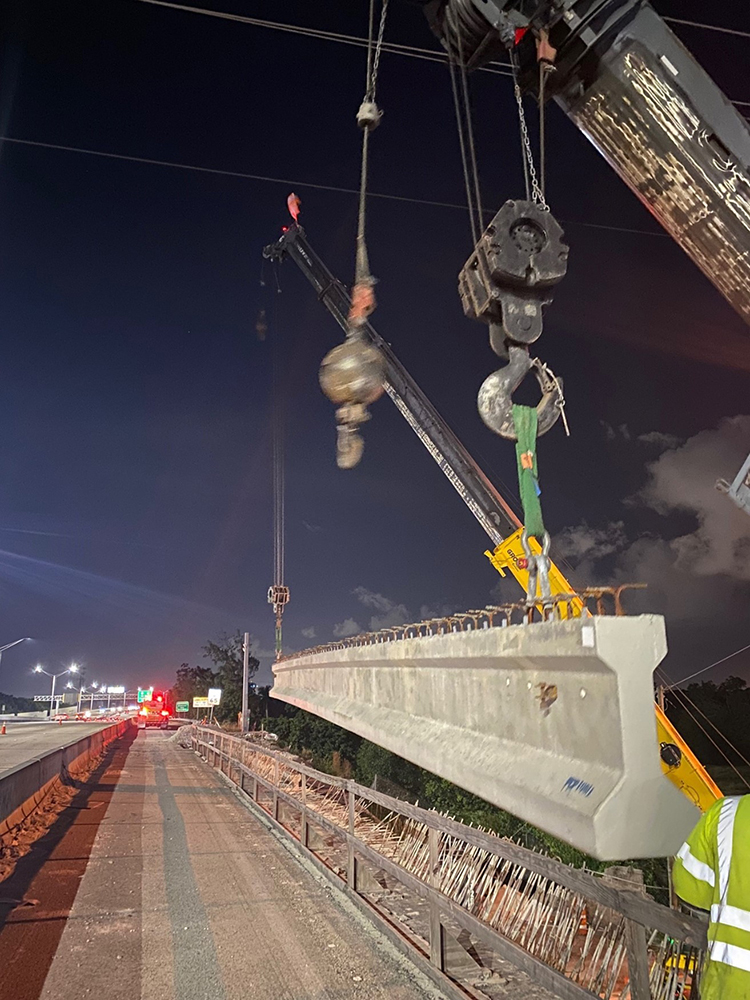

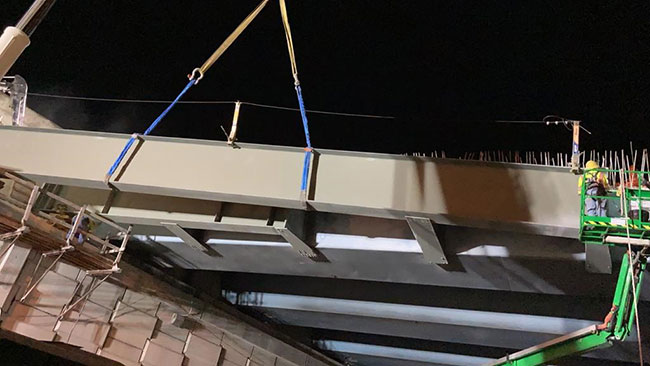

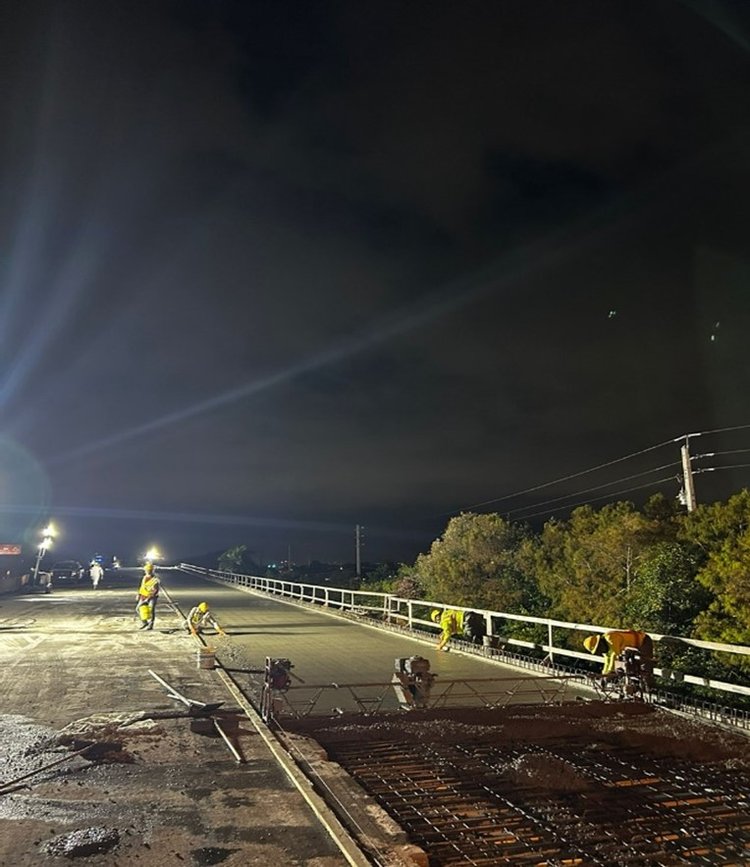

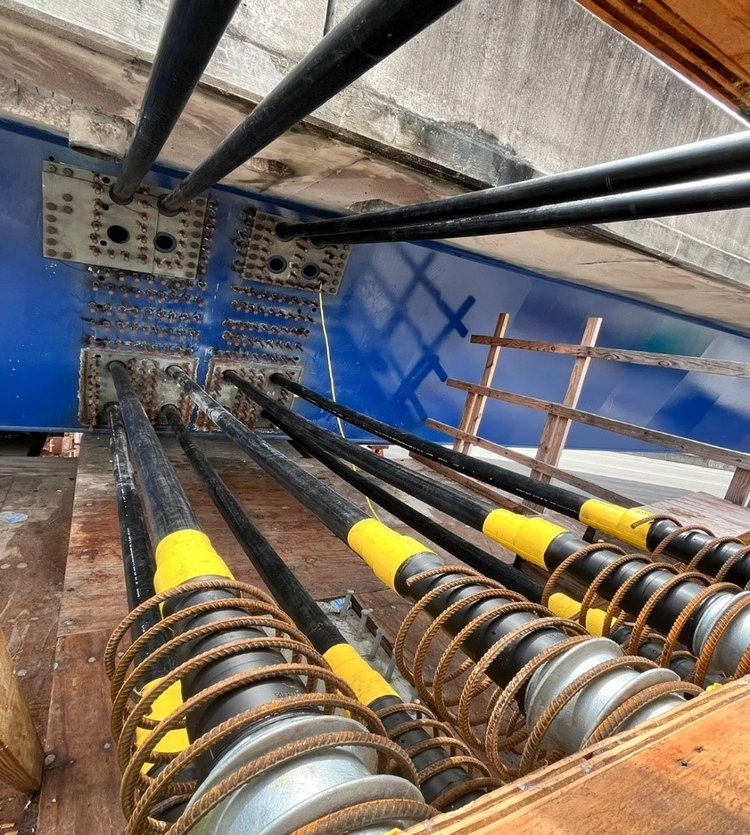

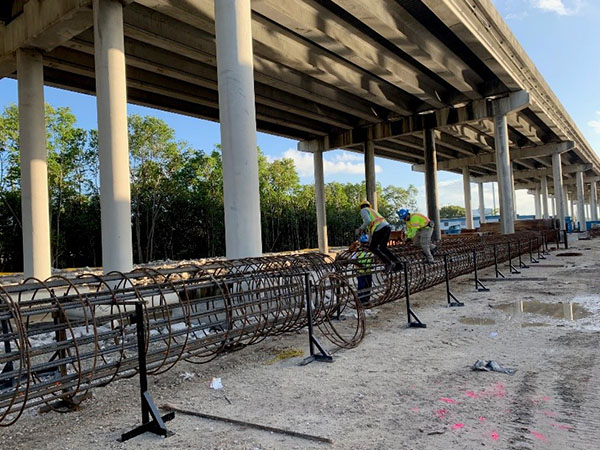

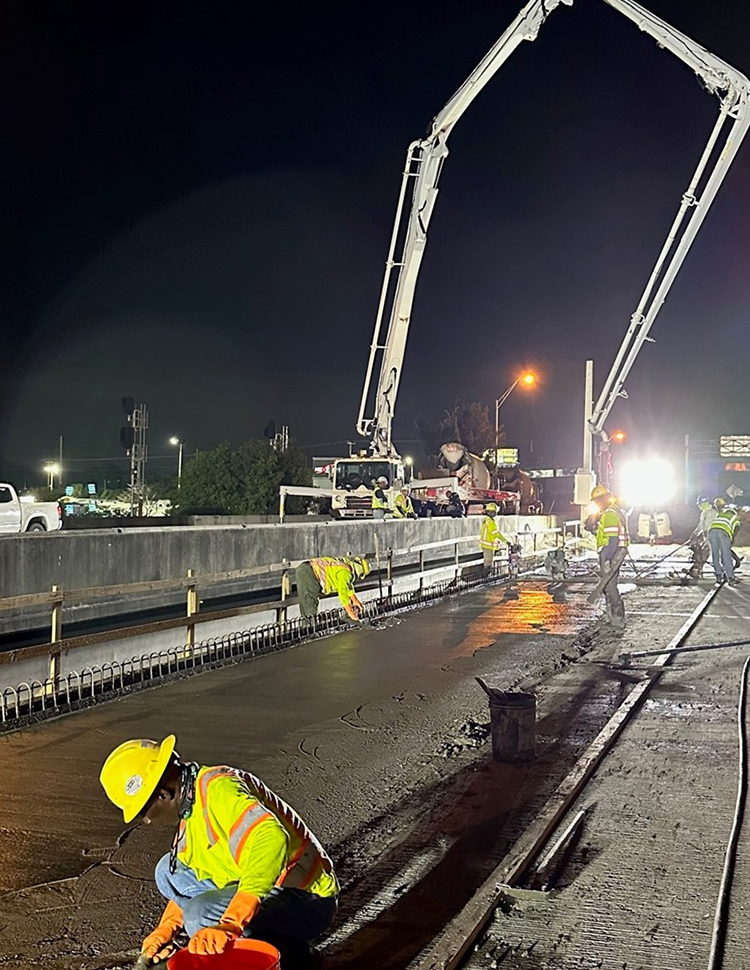

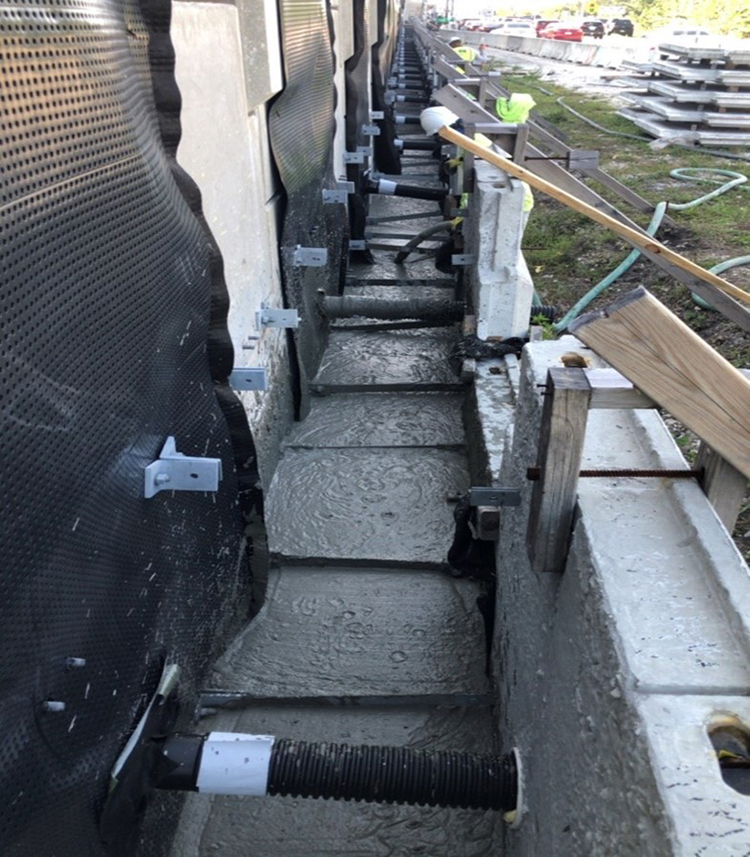

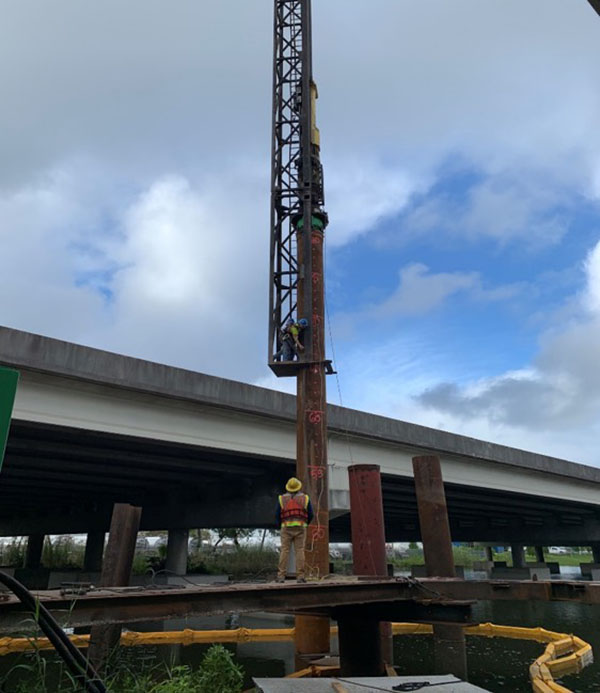

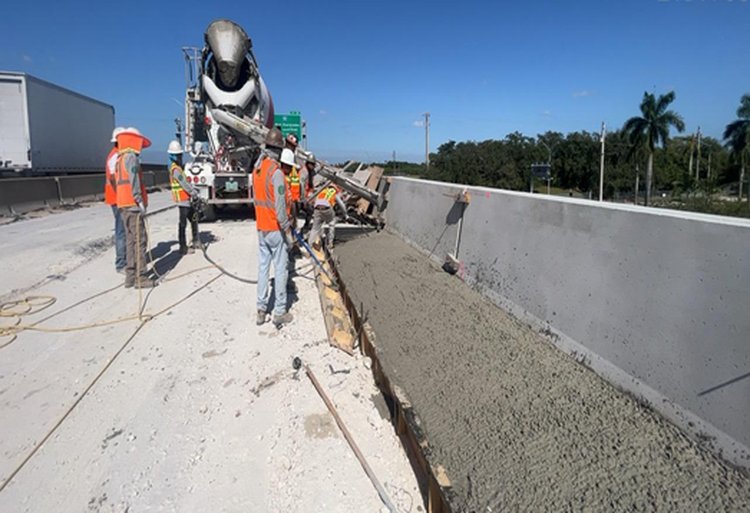

Finger joint installation_June 2024 Diaphragm and fender system restoration_June 2024 Pond Apple Slough at I 595 pre cast beam erection _June 2024 Proposed Direct Connecctor end bent construction_June 2024

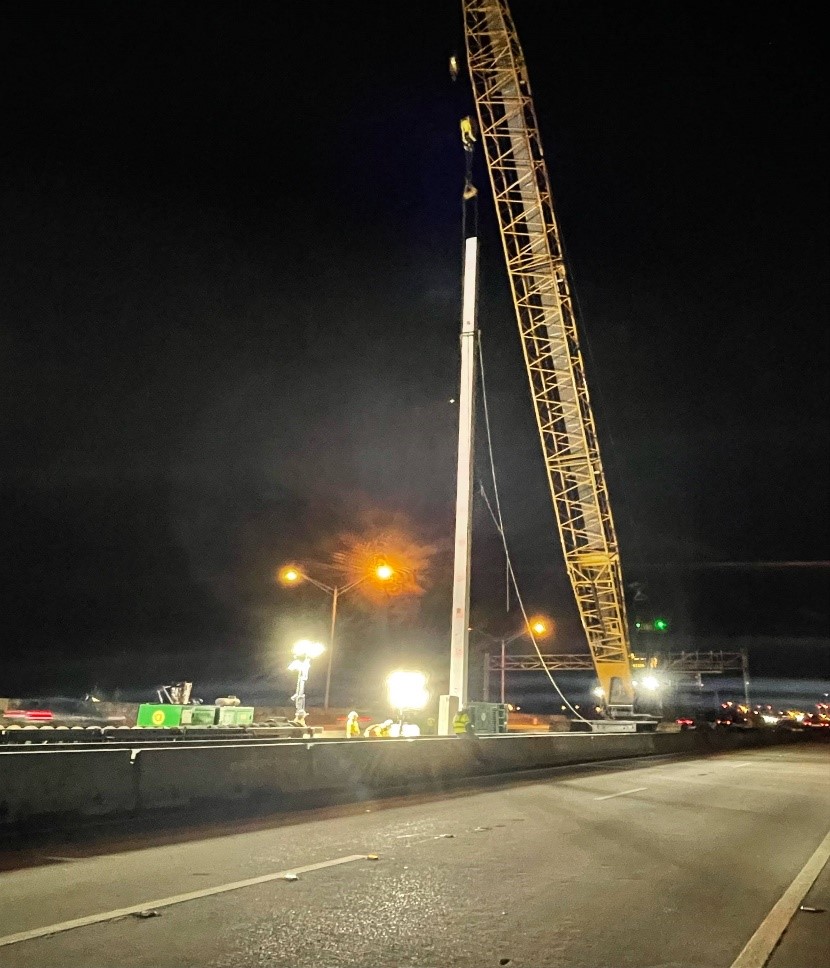

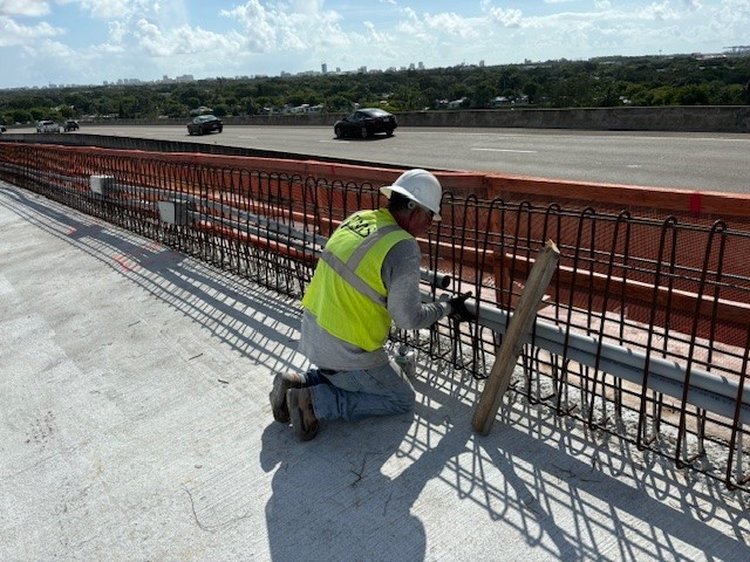

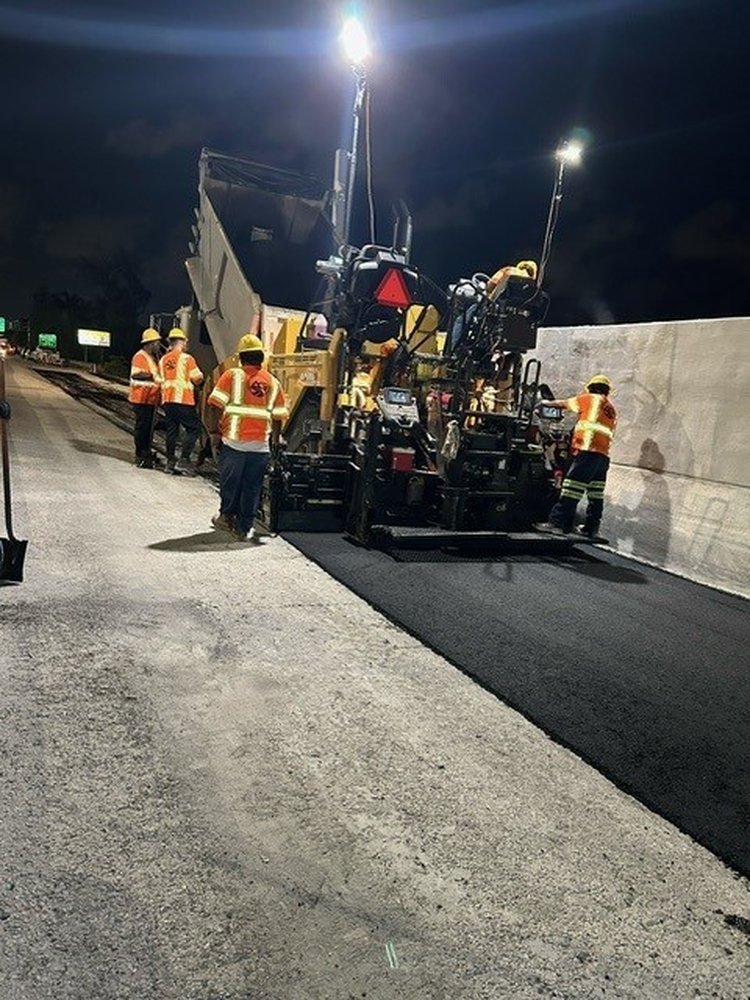

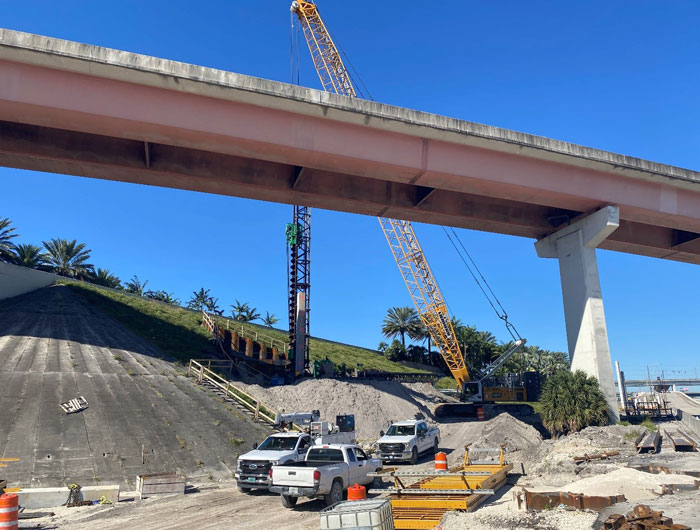

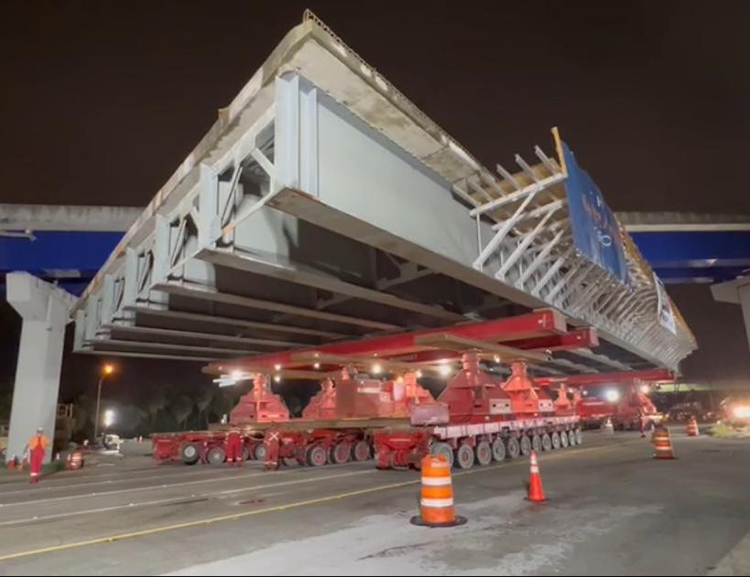

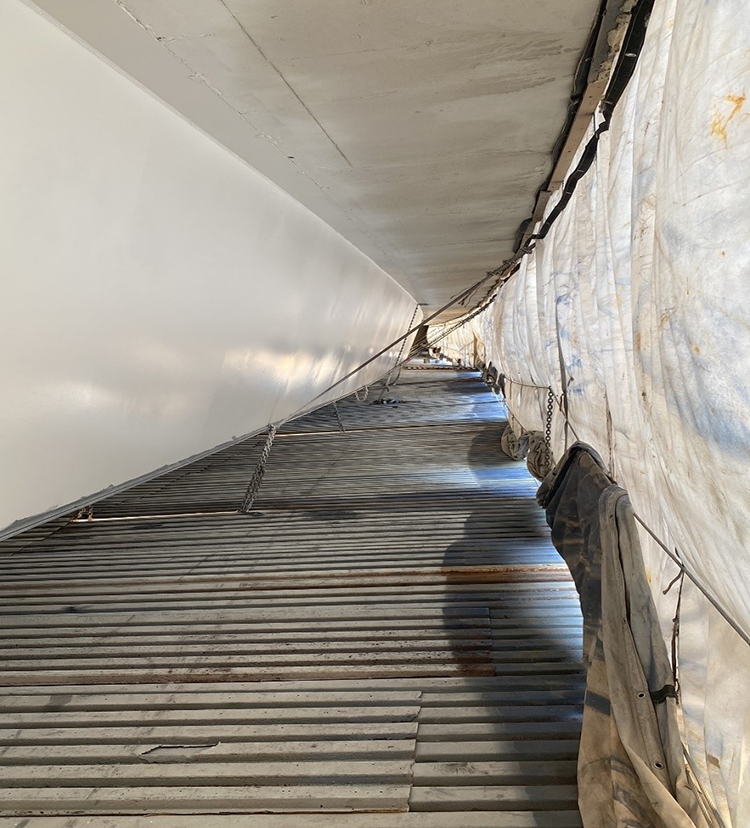

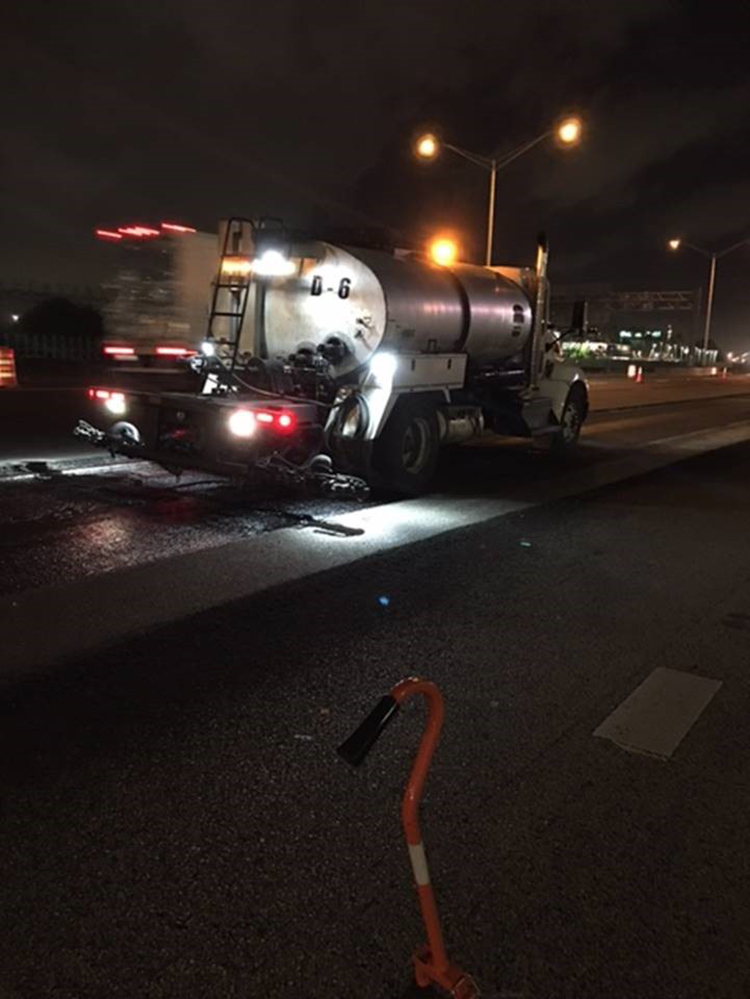

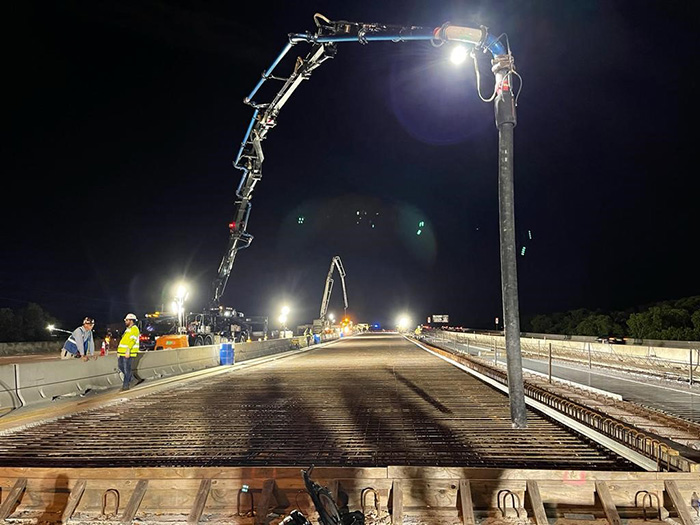

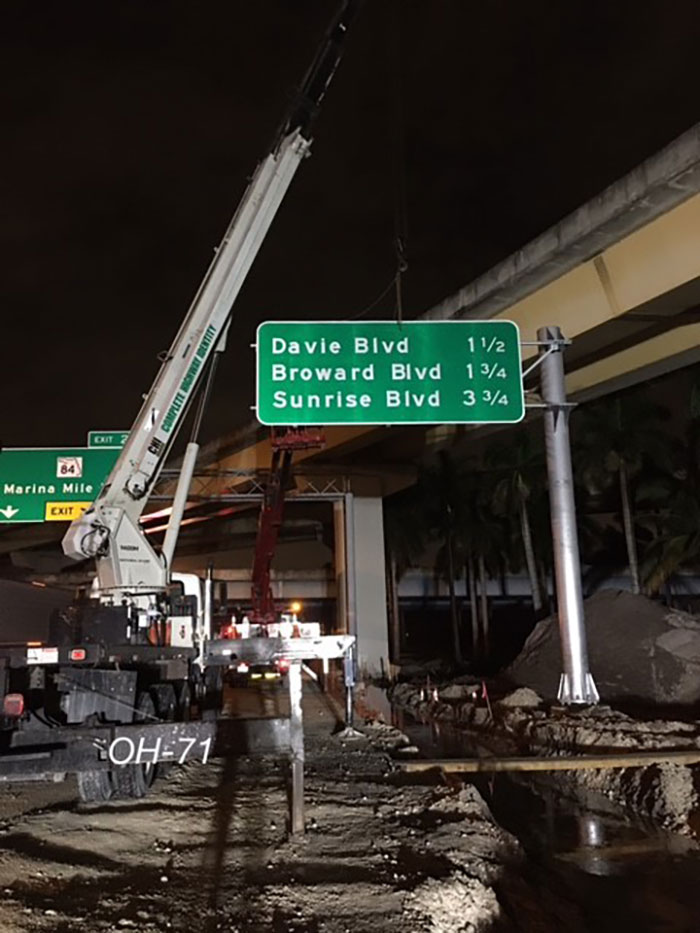

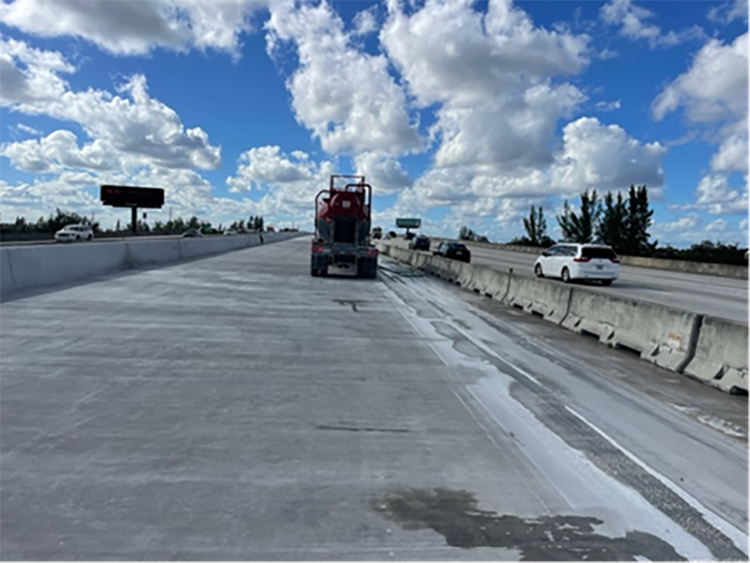

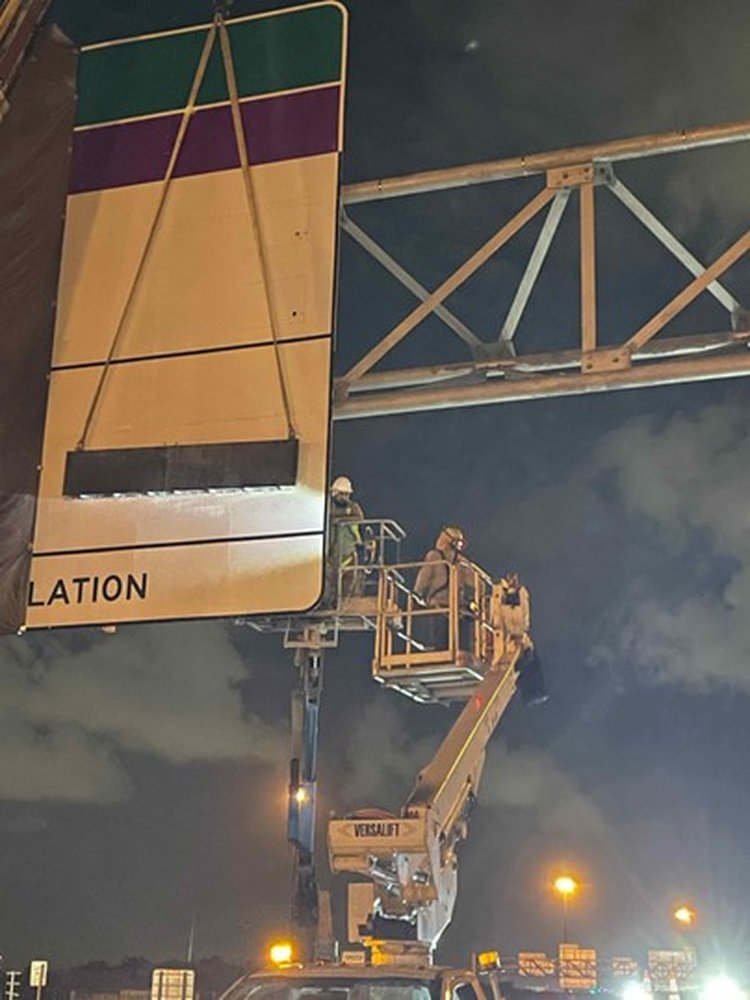

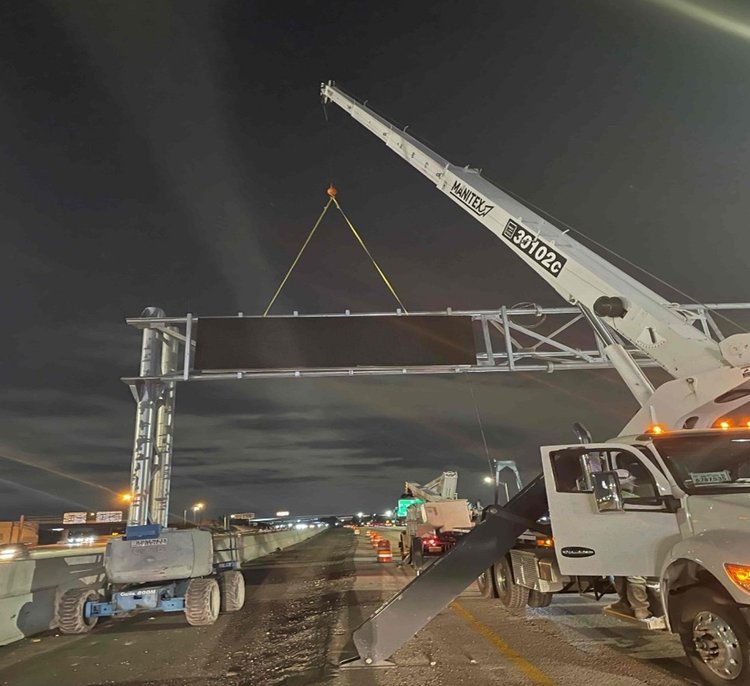

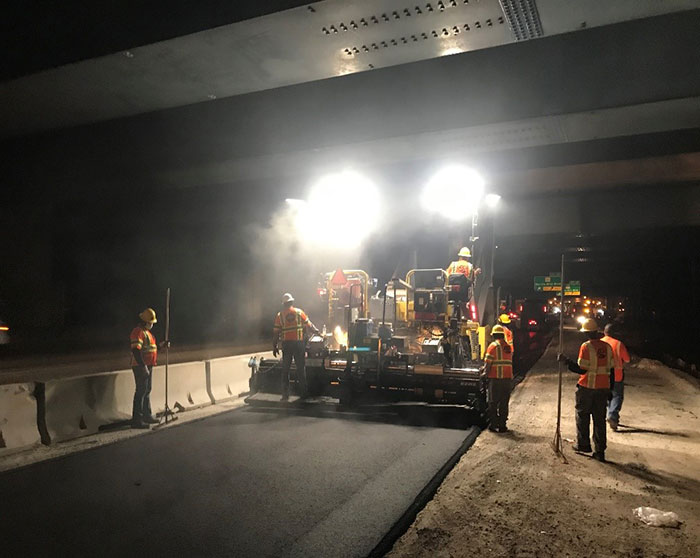

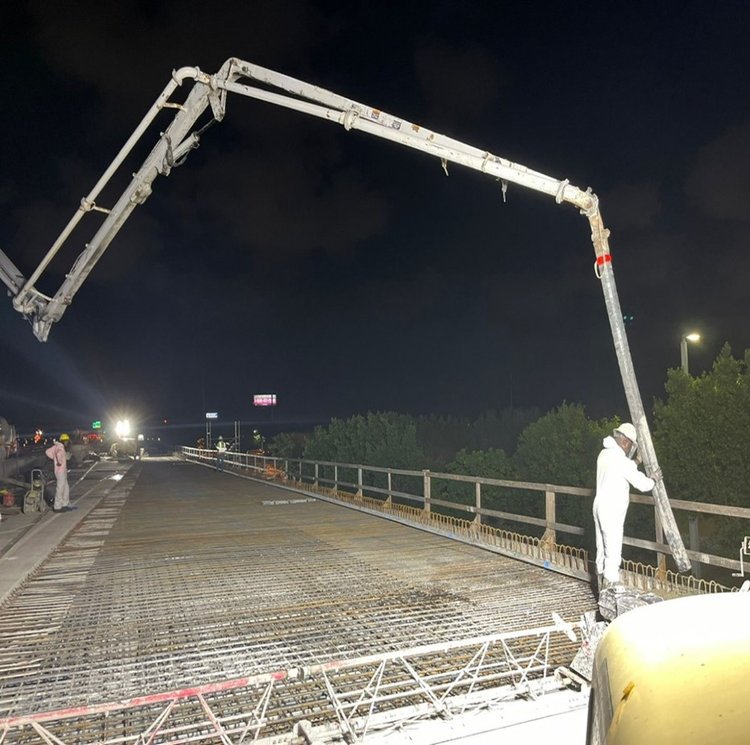

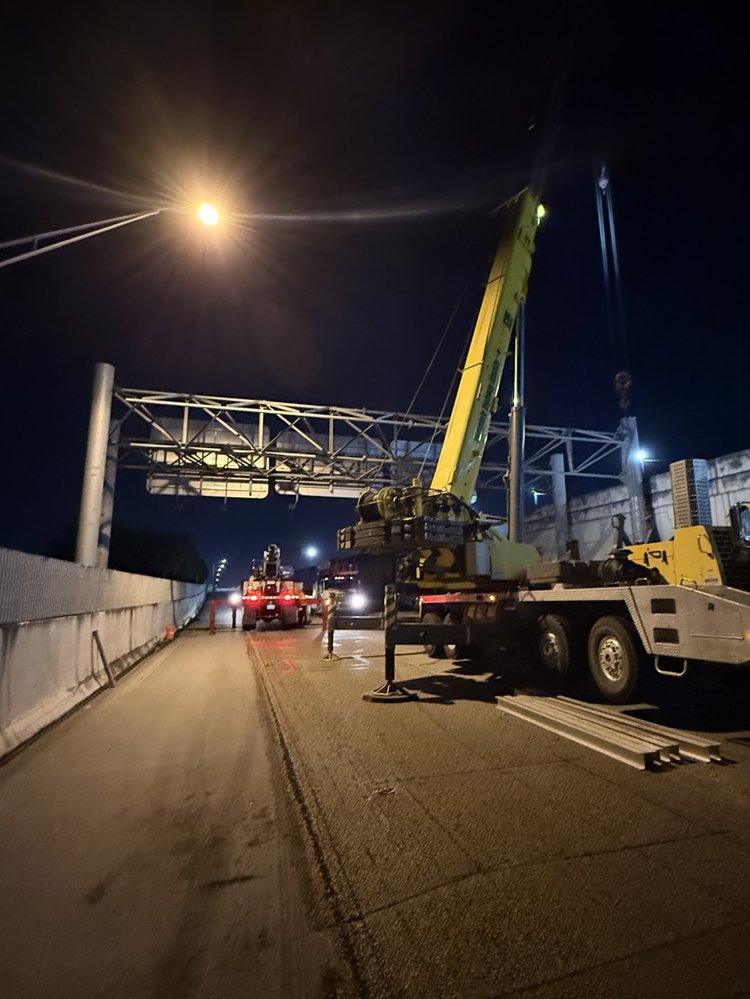

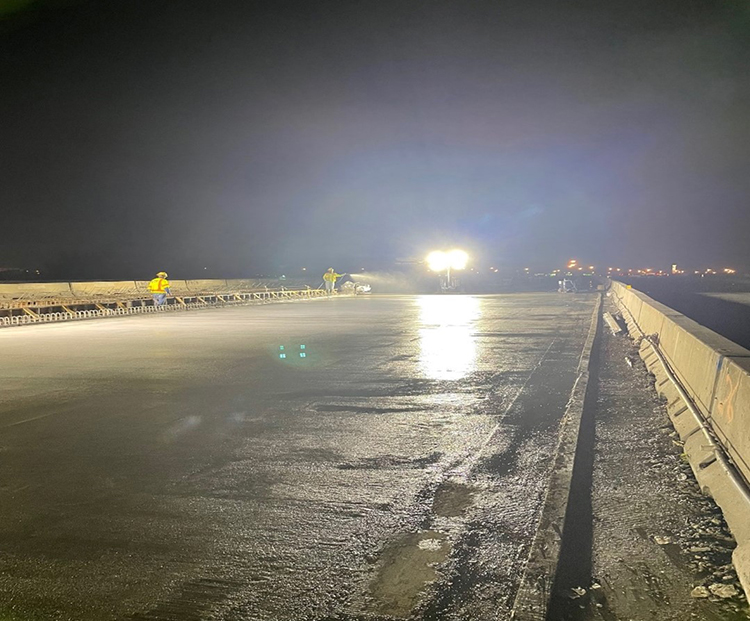

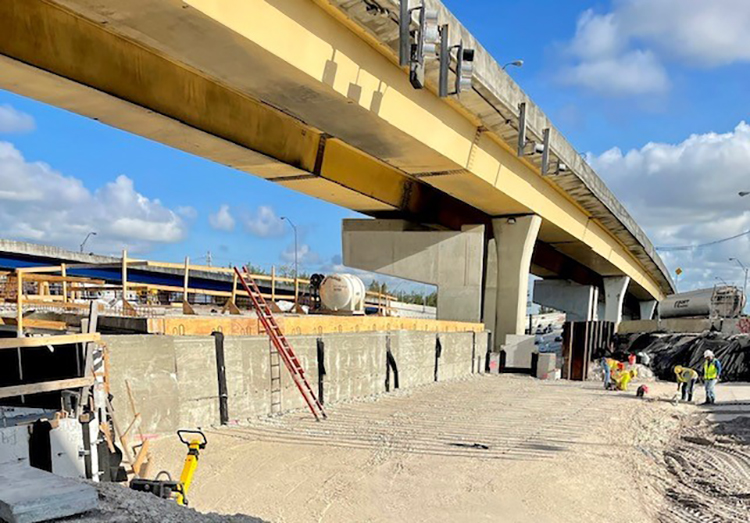

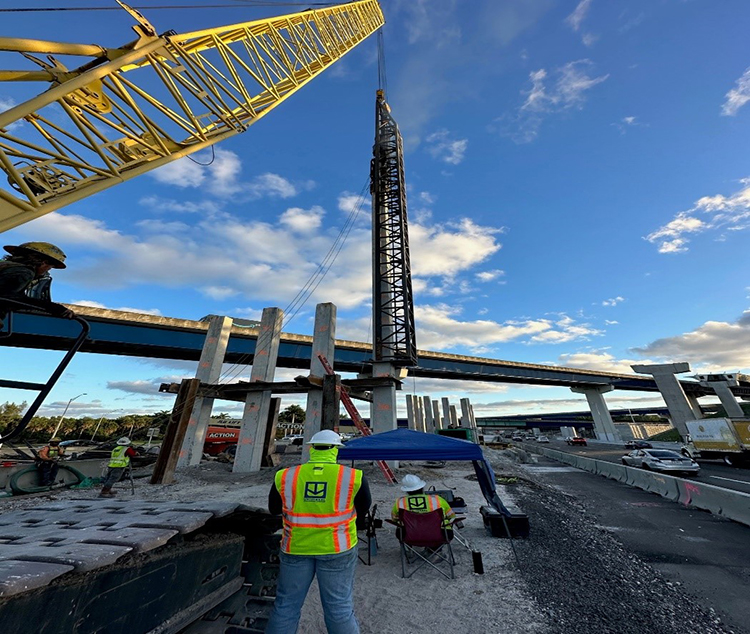

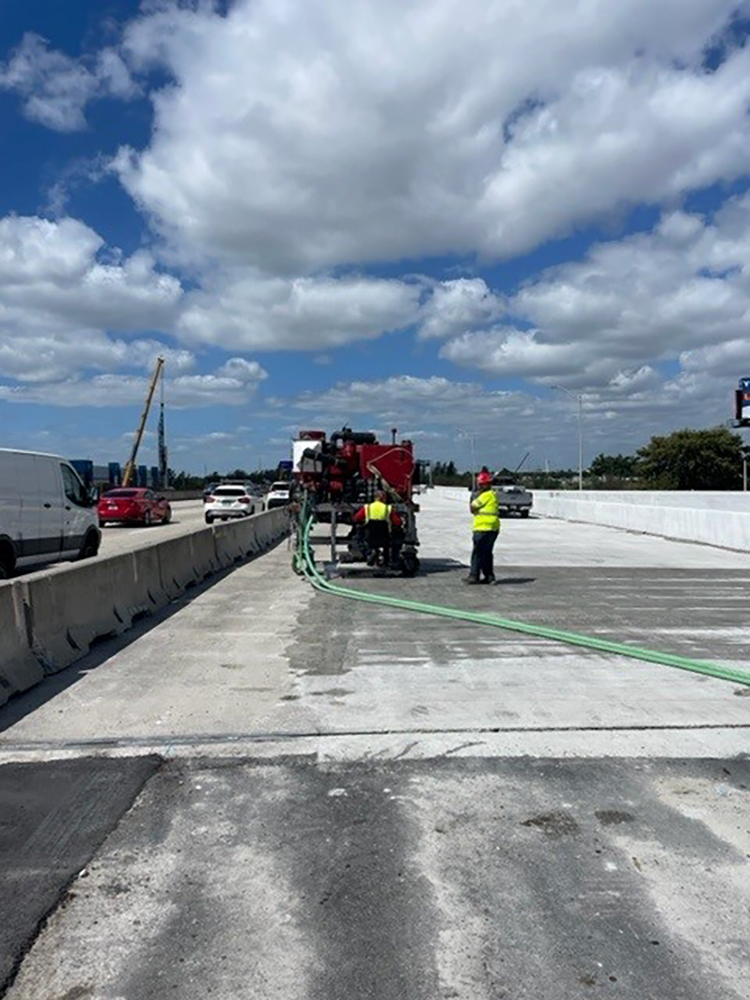

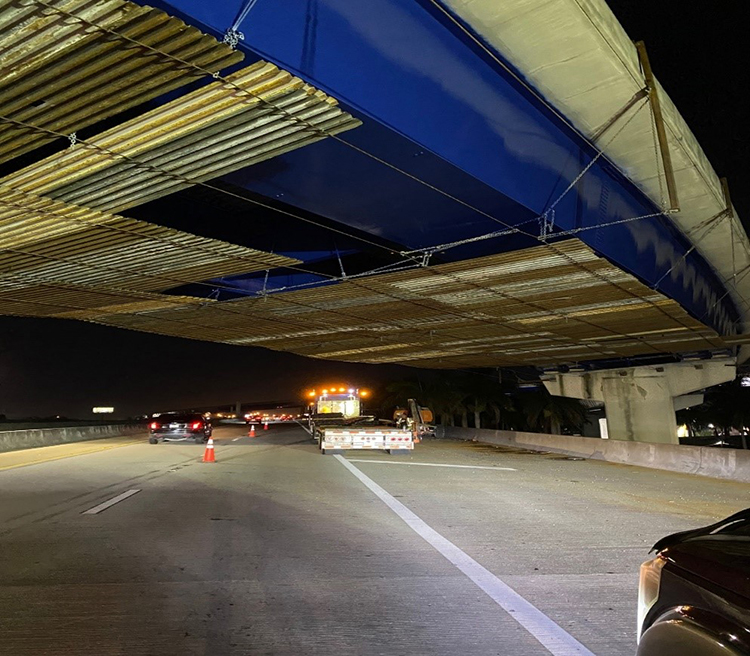

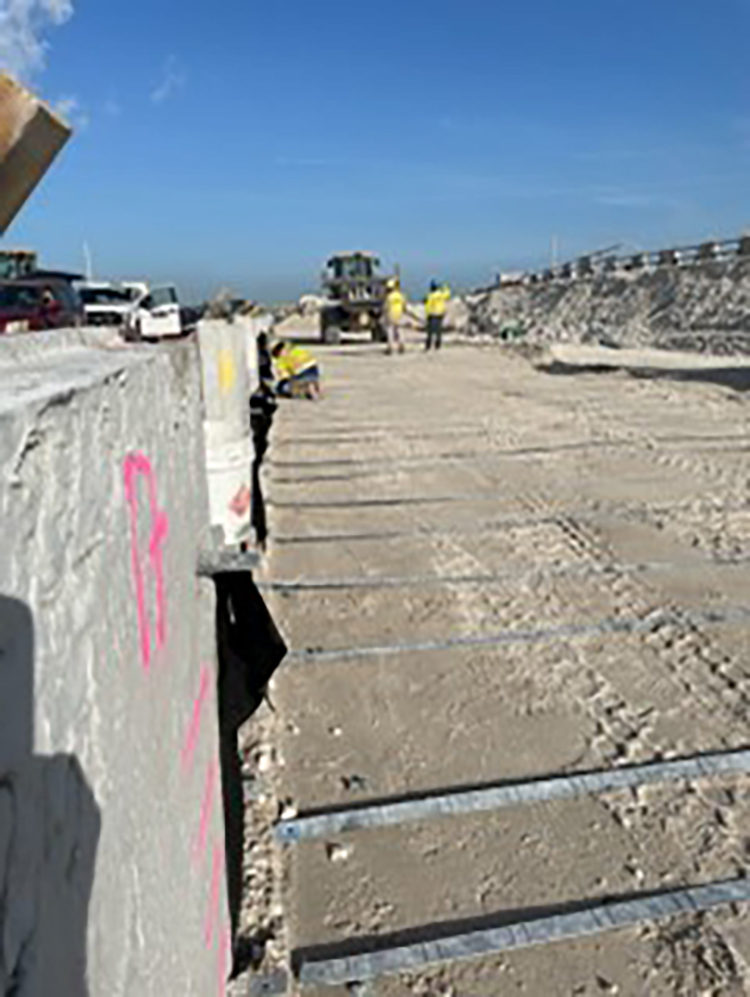

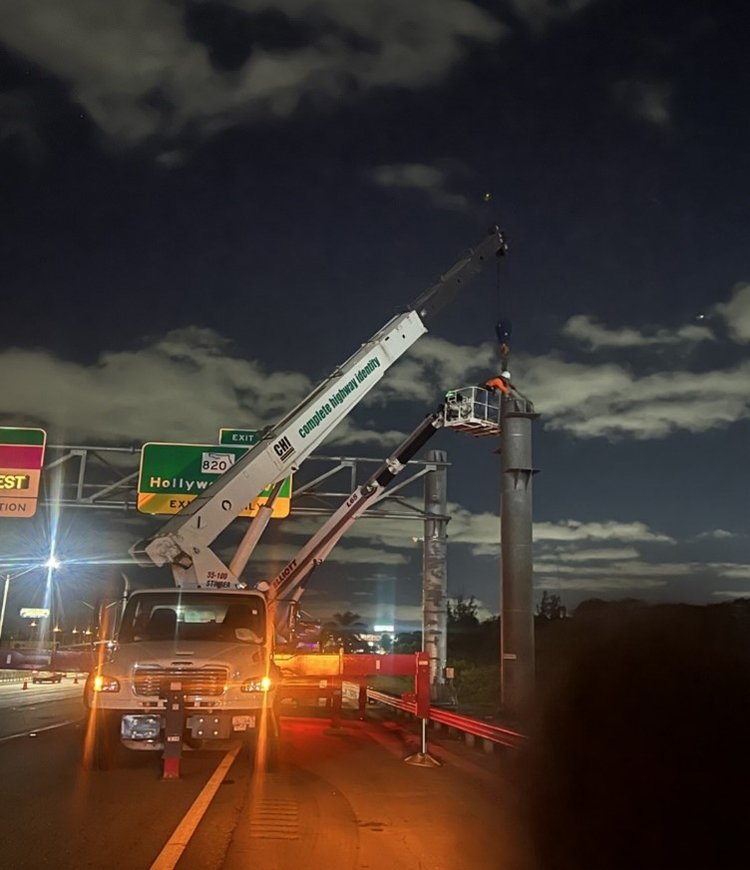

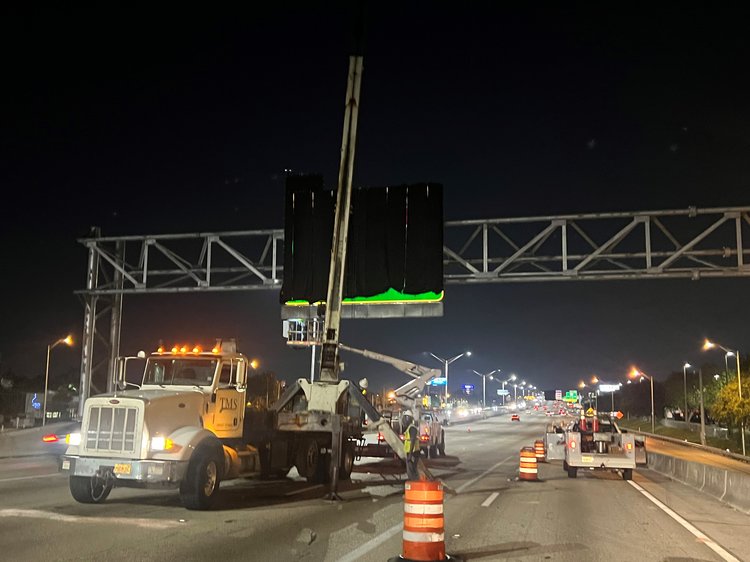

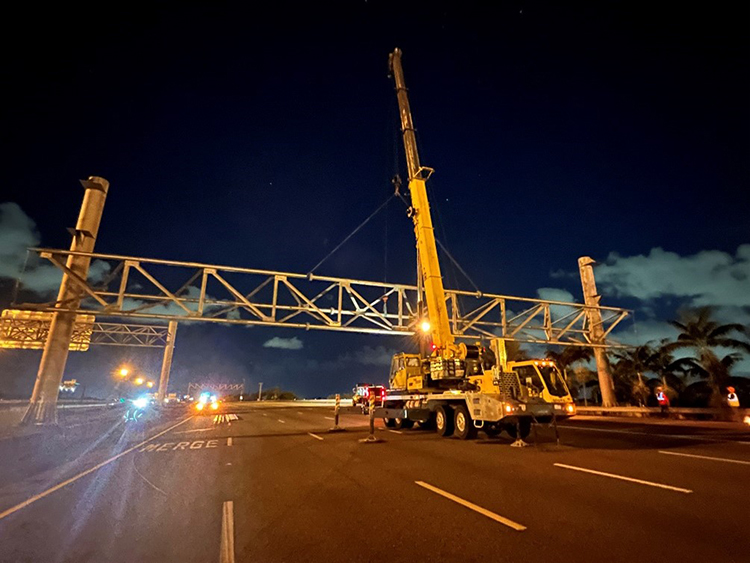

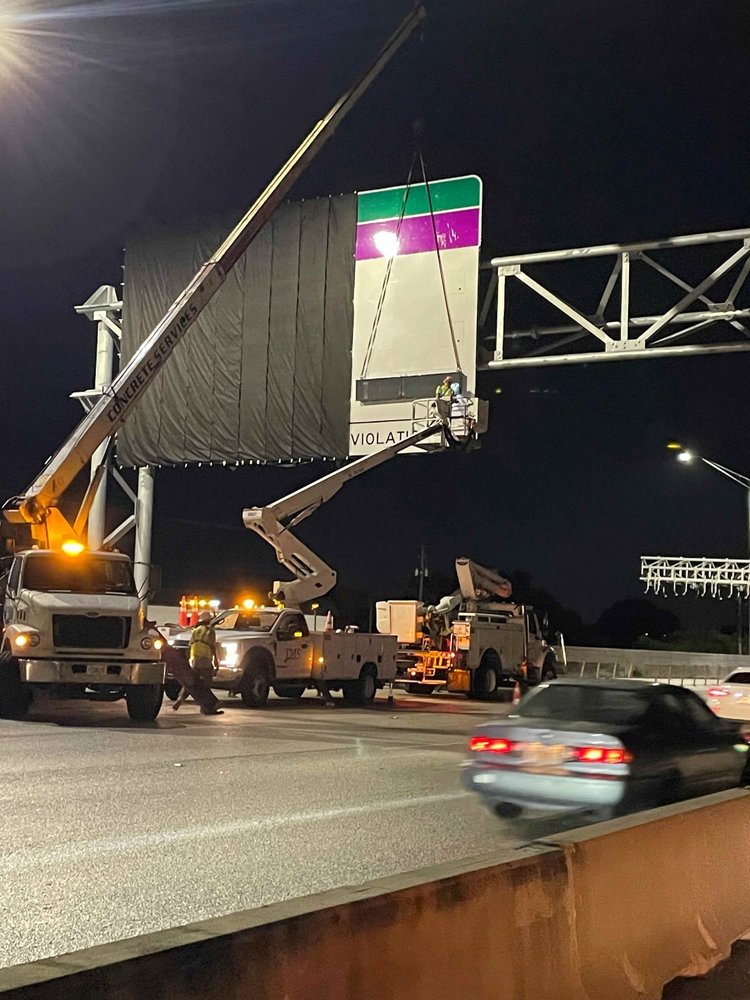

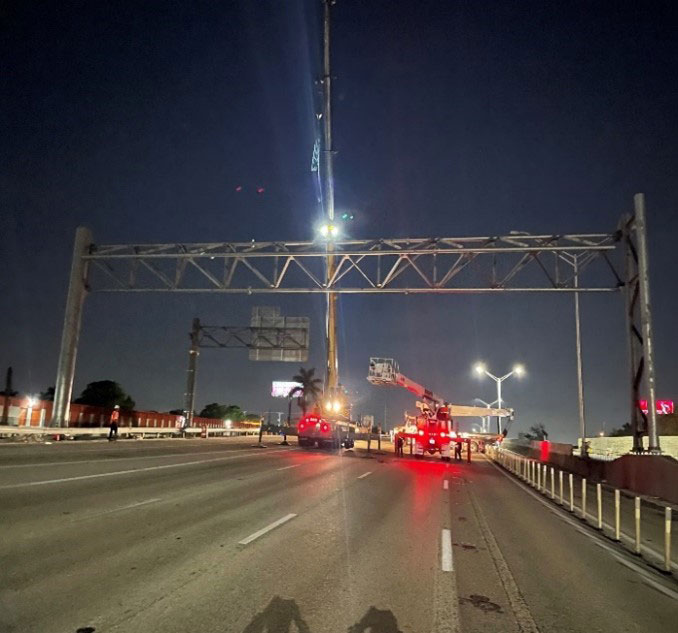

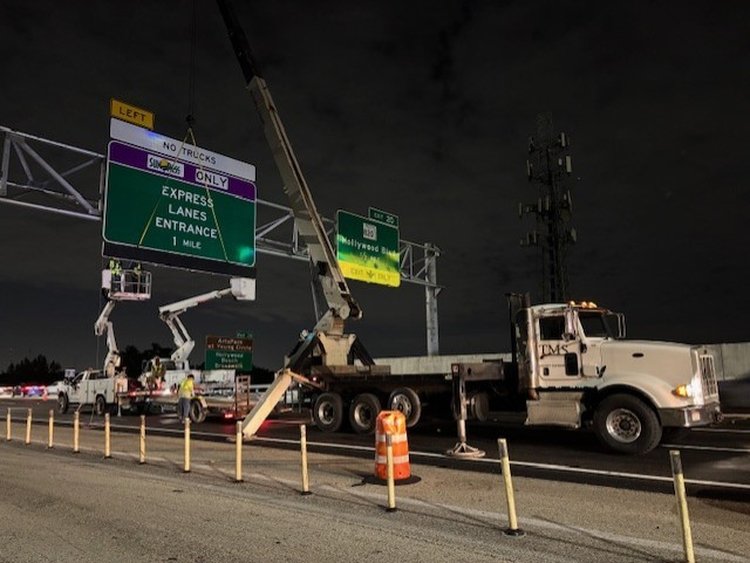

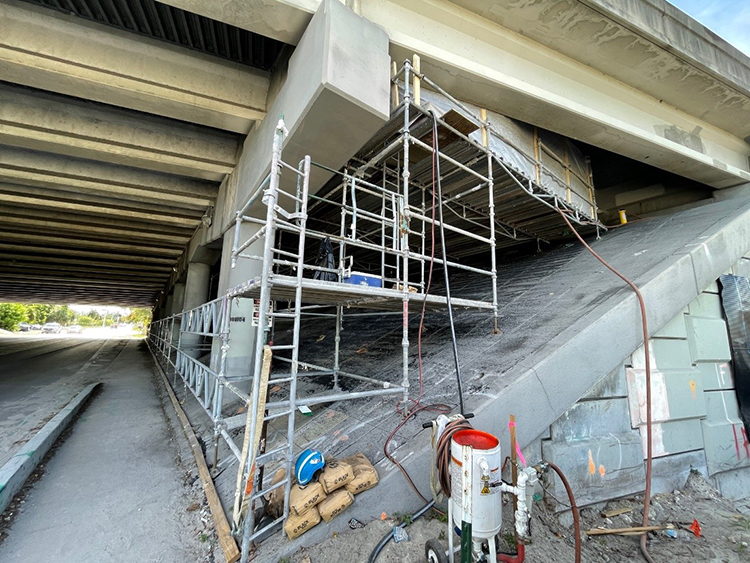

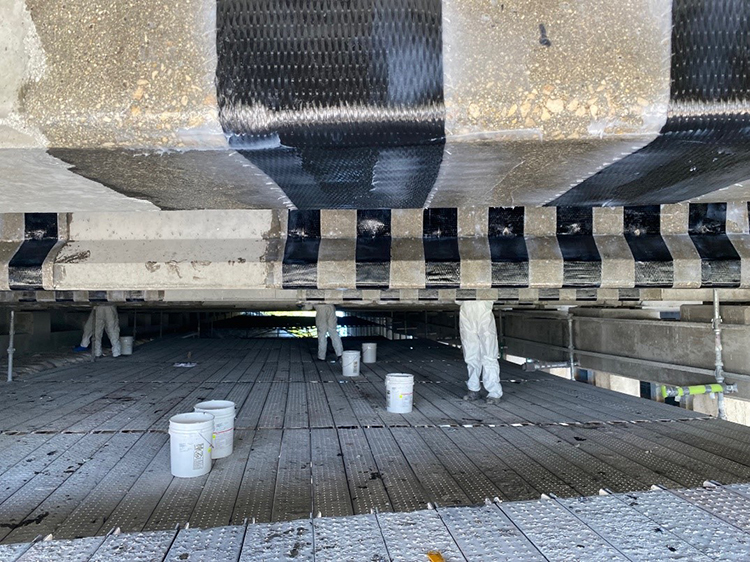

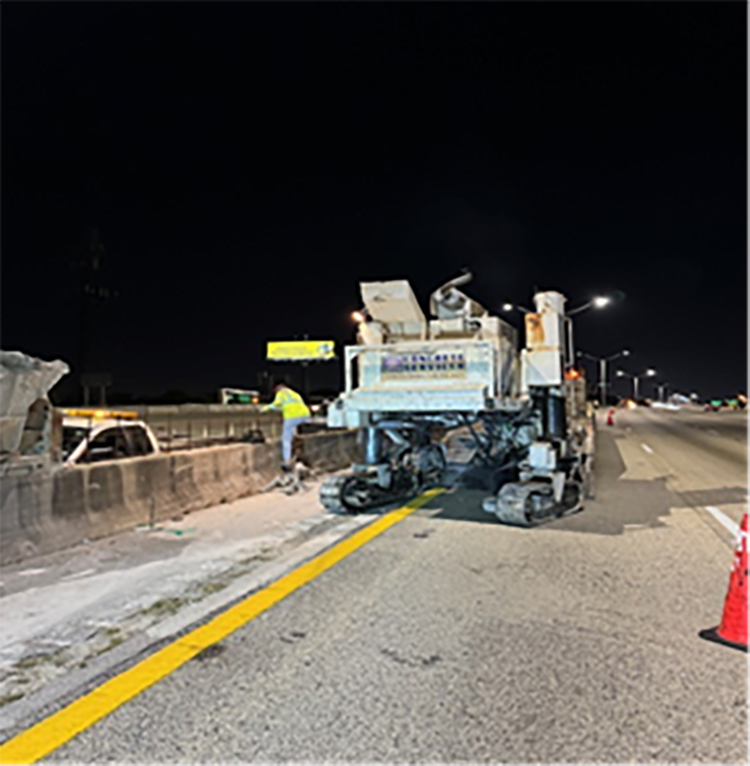

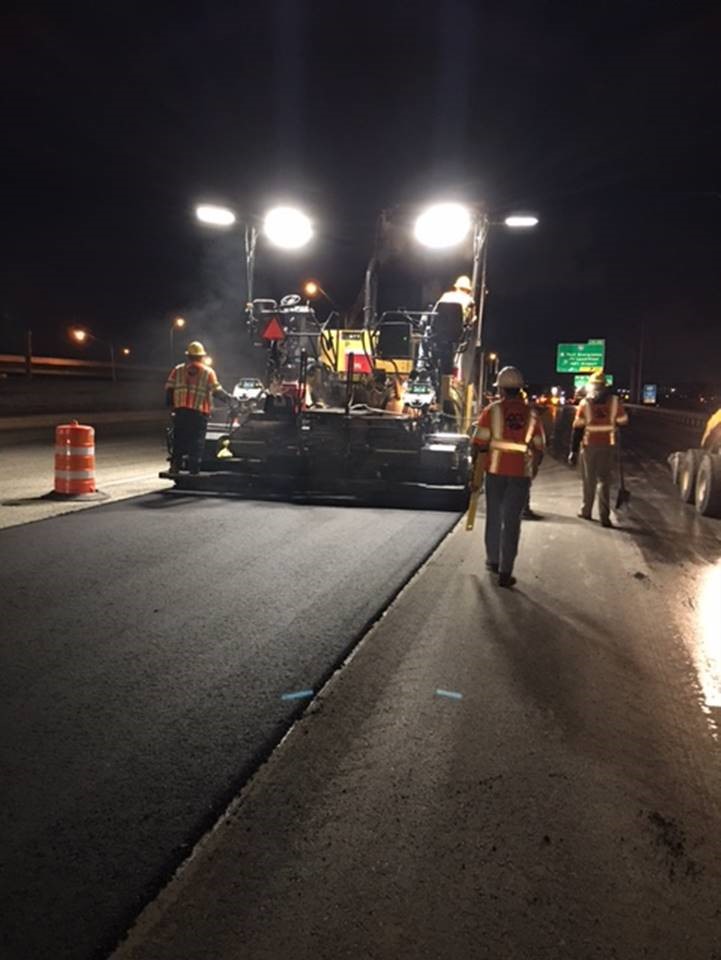

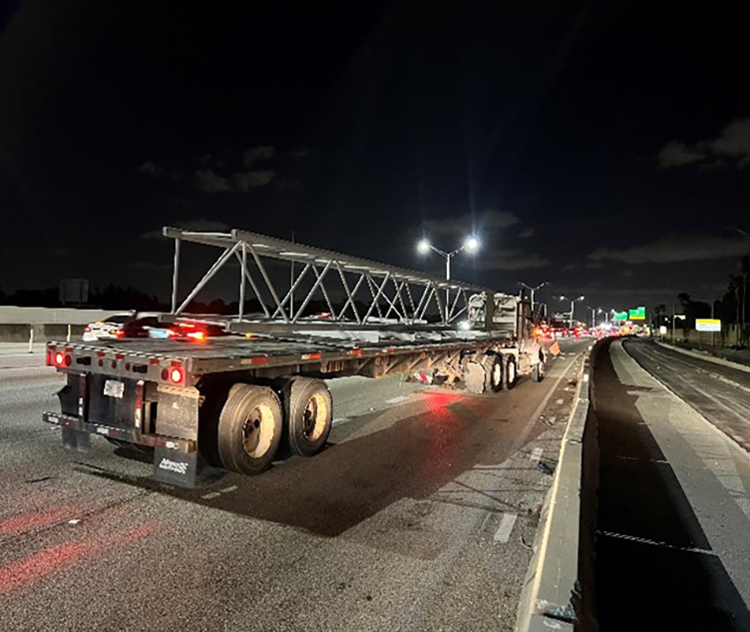

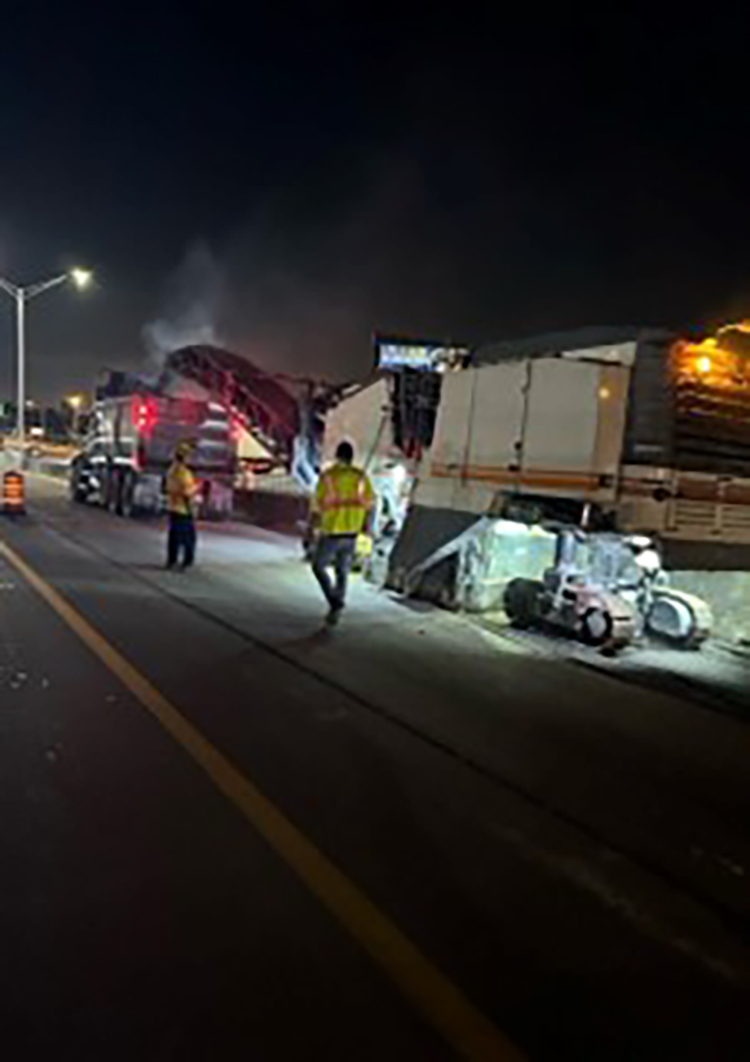

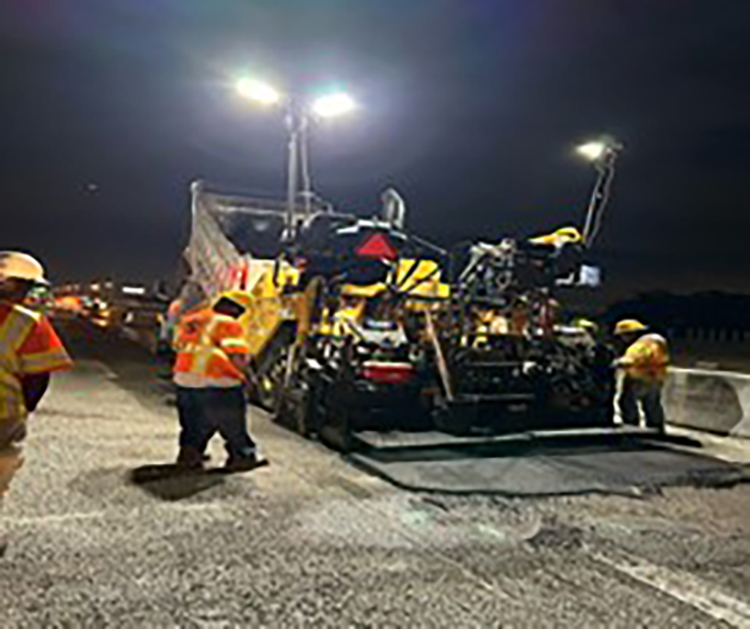

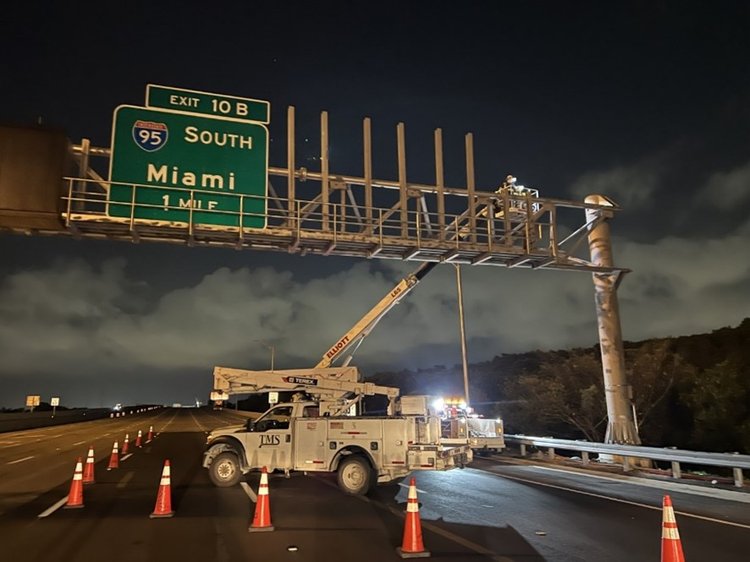

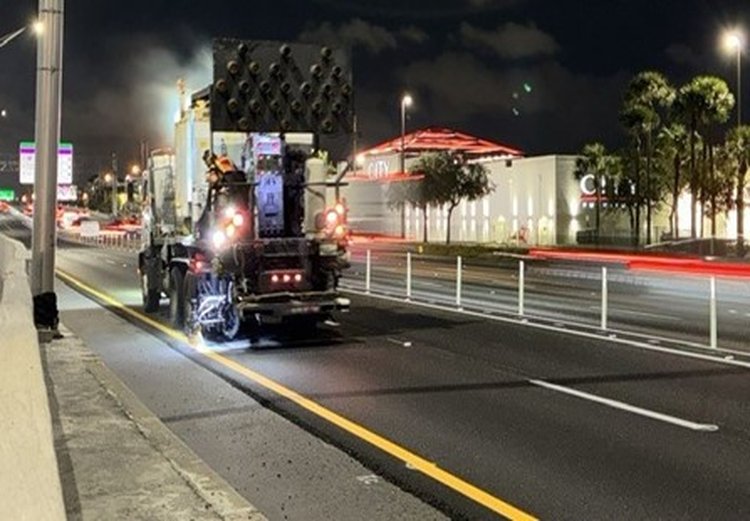

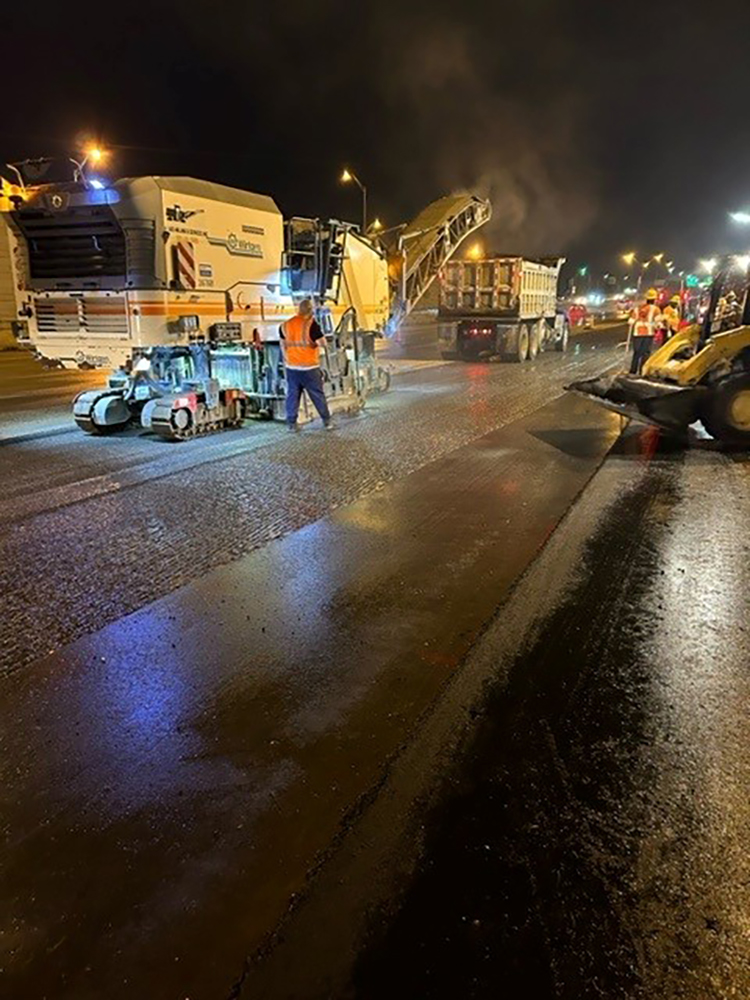

Installation of overhead sign structure along I 95 SB south of Stirling Road July 2024 Bridge 13B nightly deck pours July 2024 Restoration of fender system July 2024 Grading base material on I 95 median  July 2024

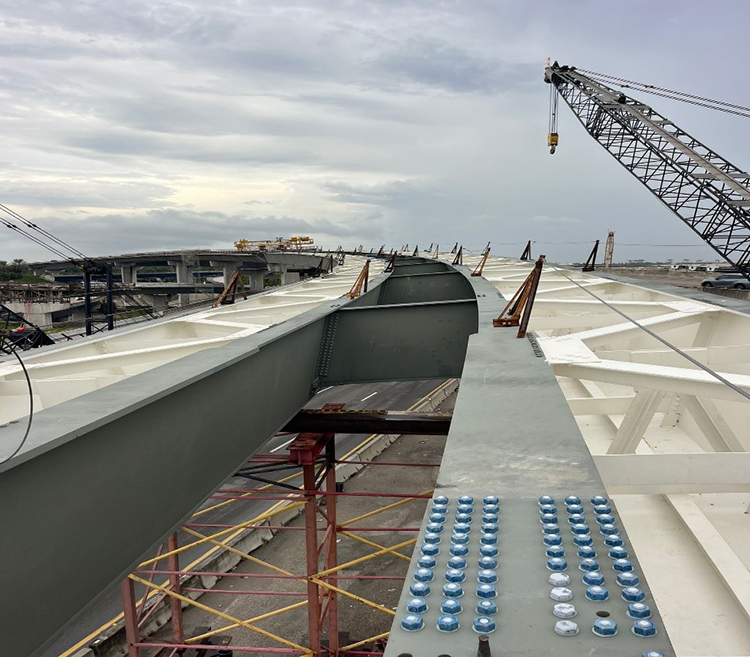

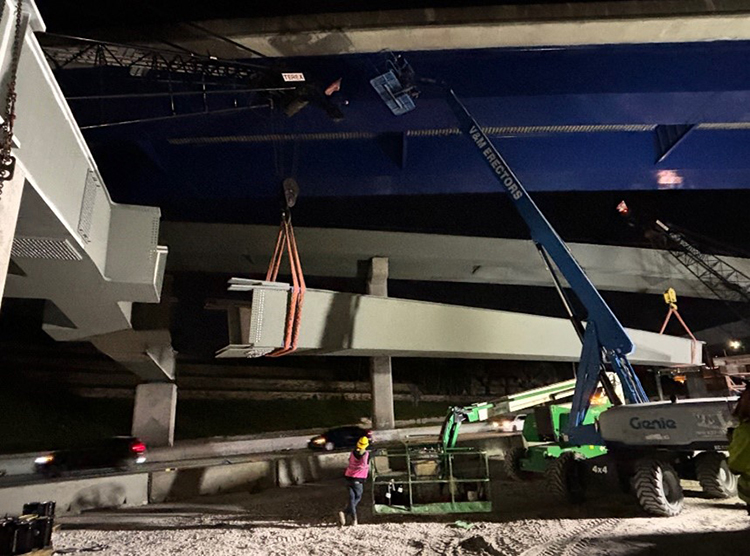

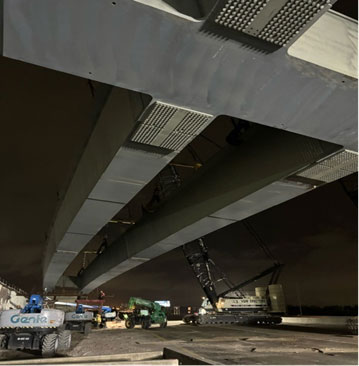

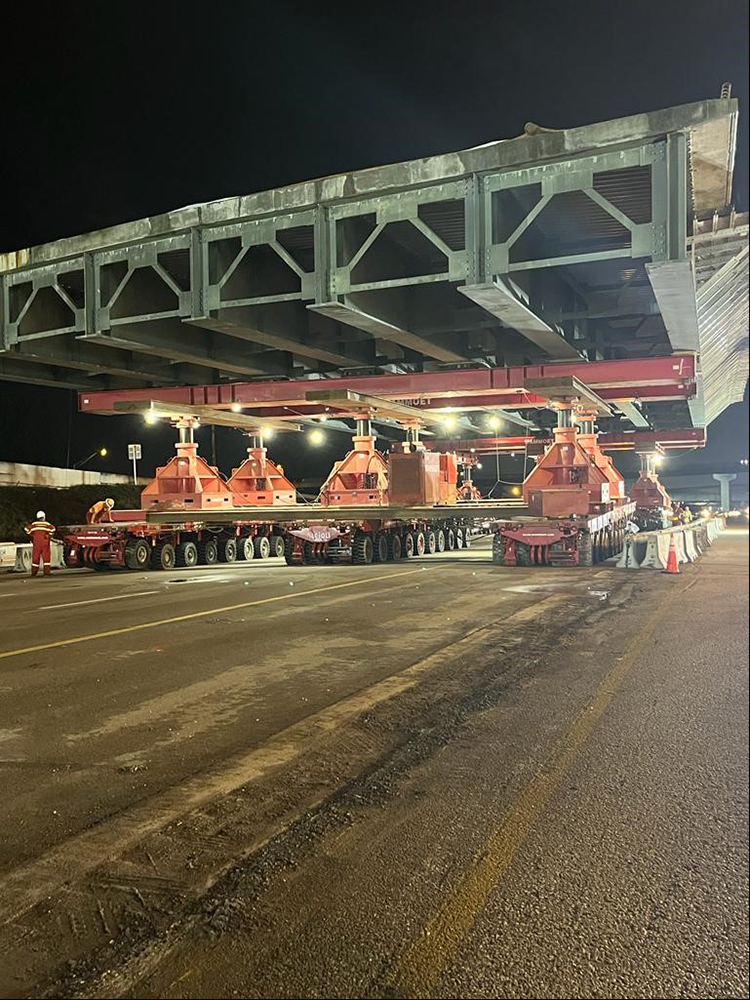

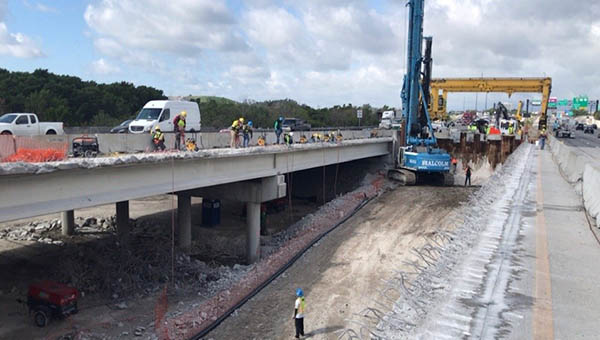

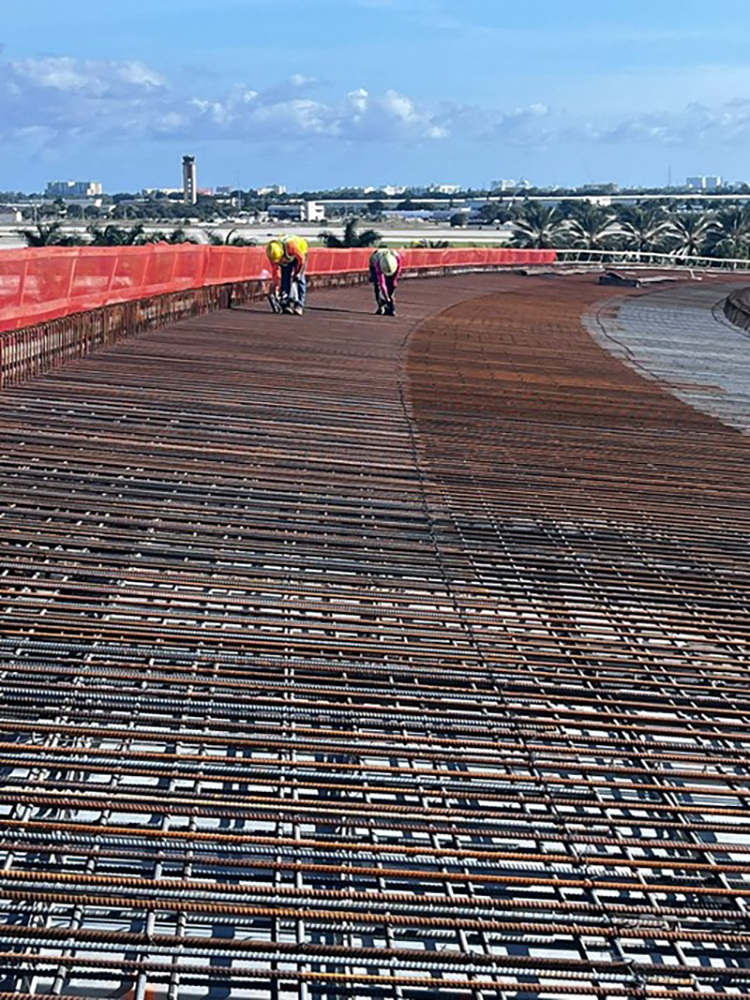

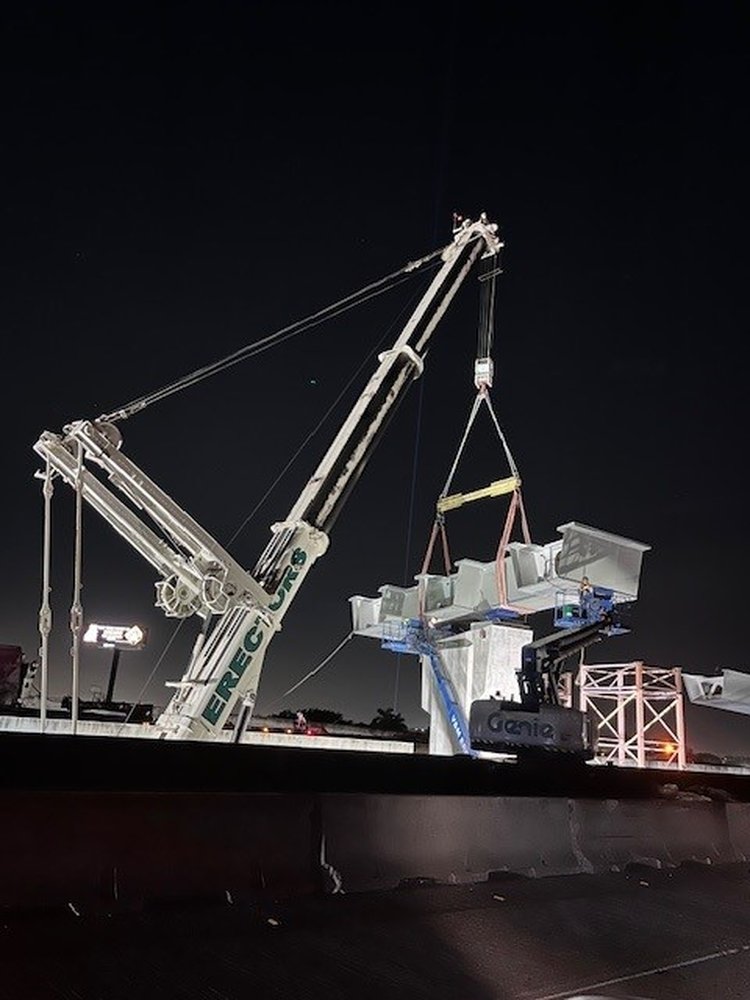

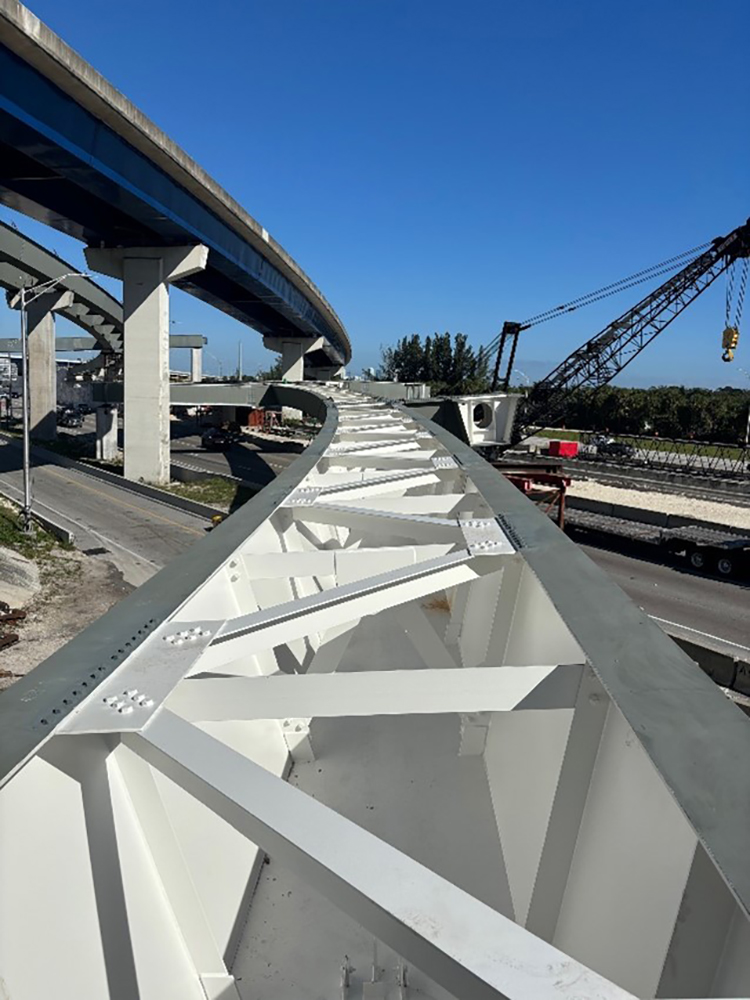

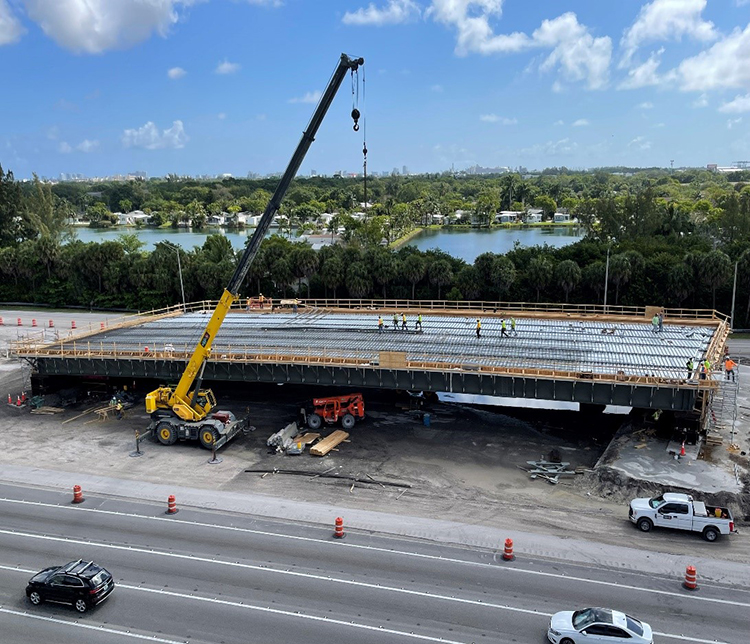

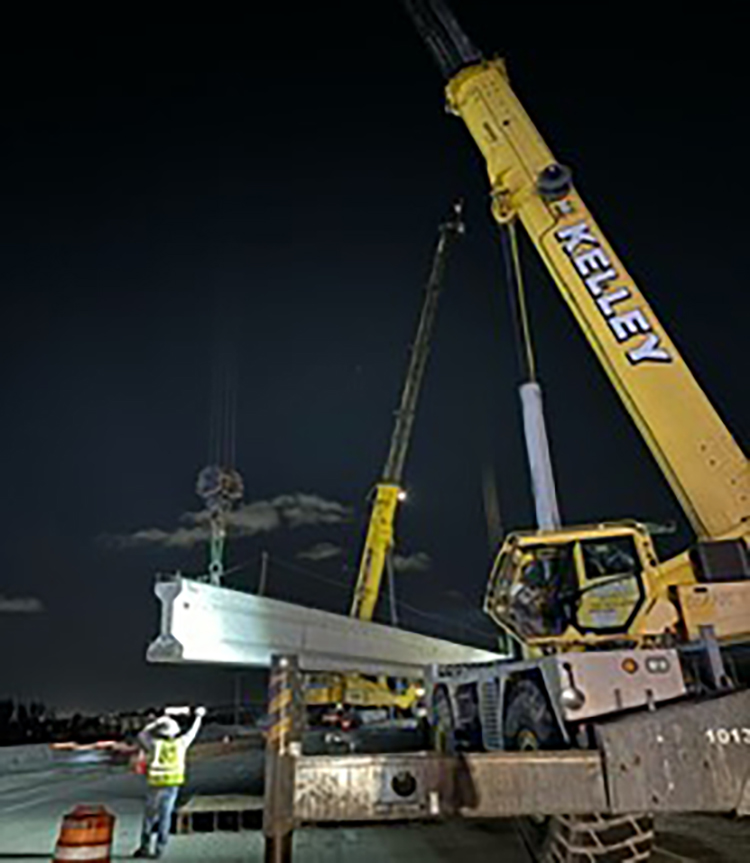

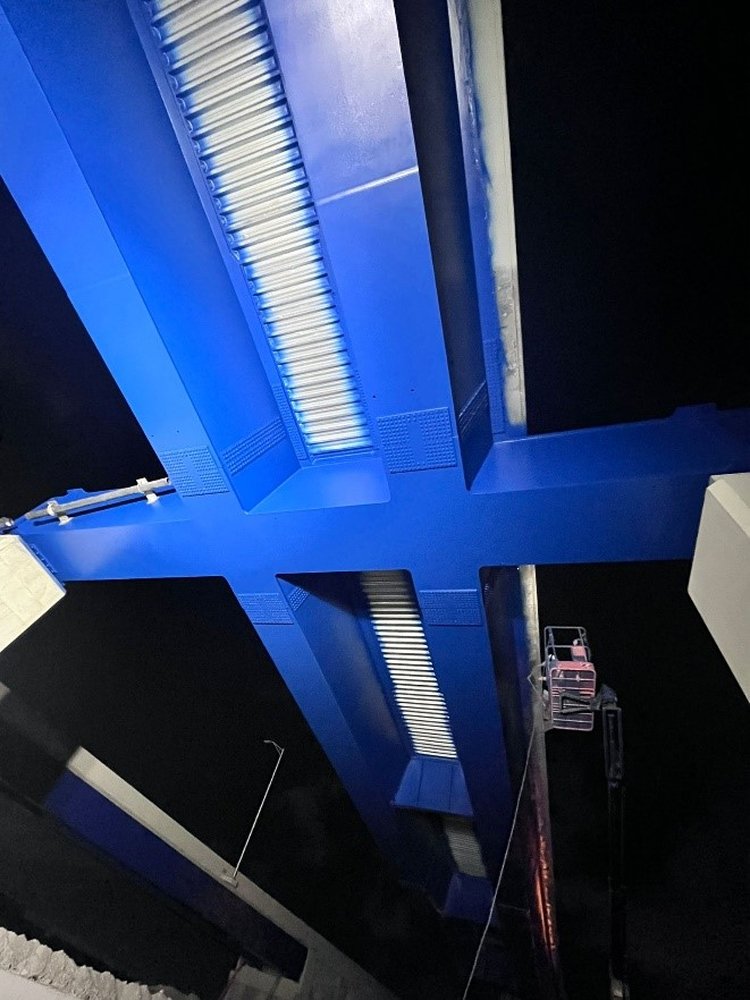

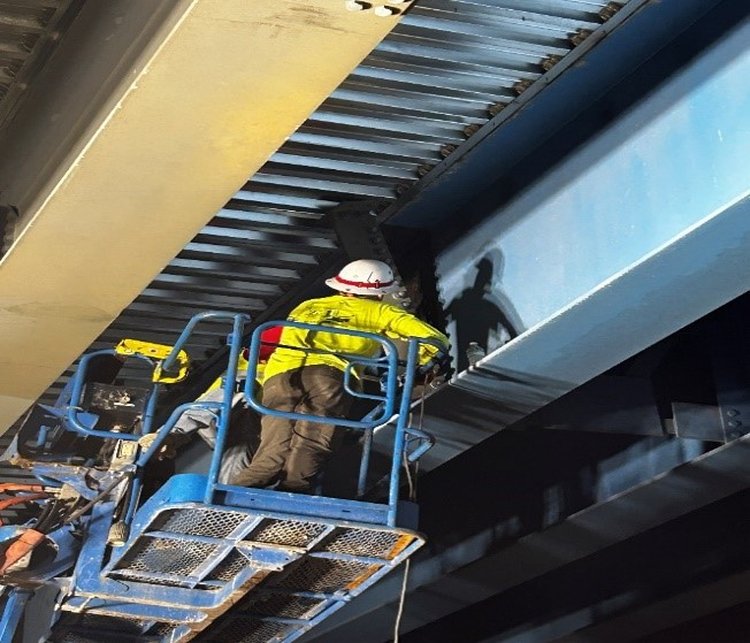

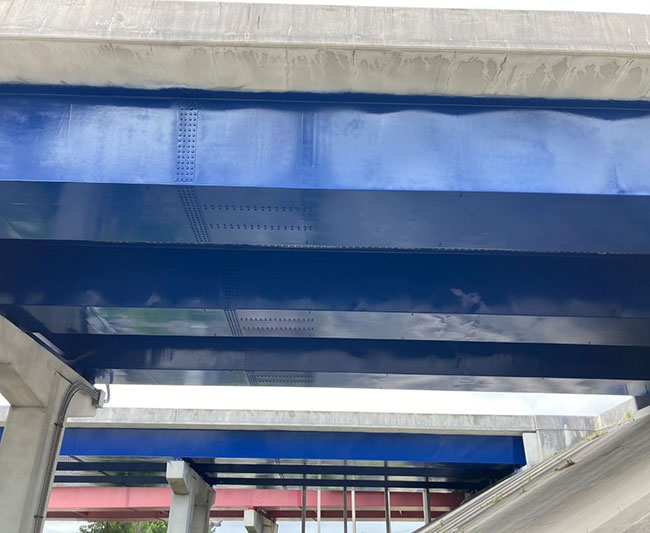

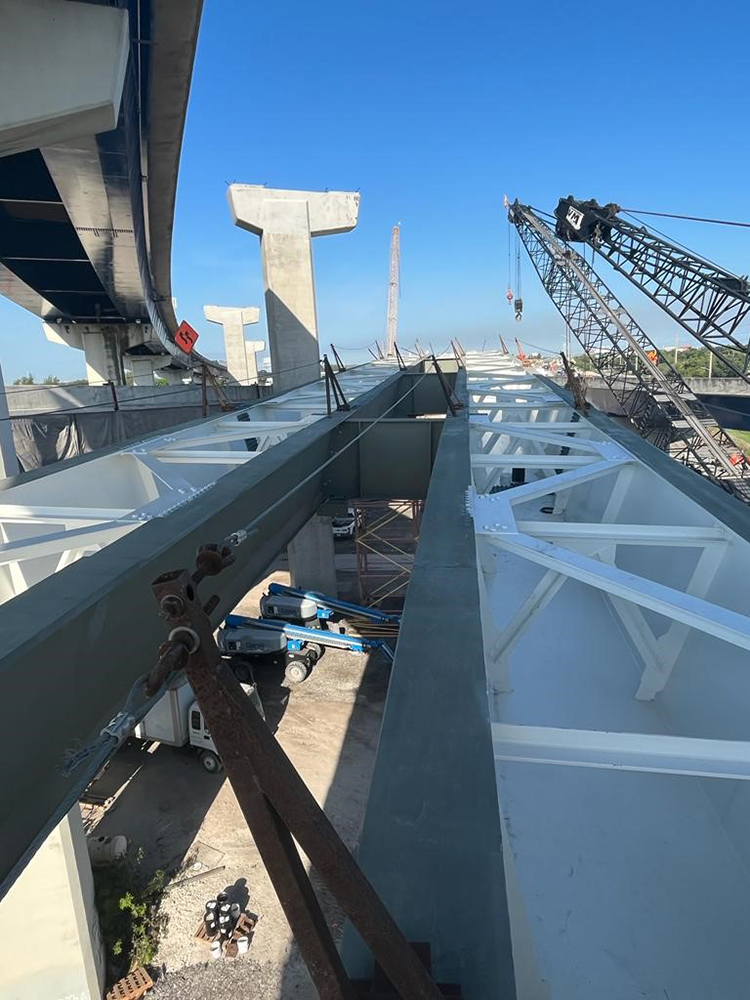

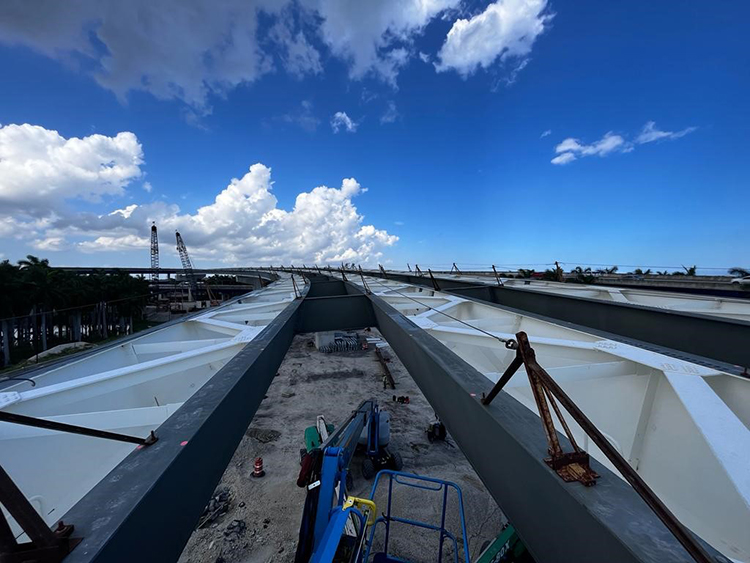

Installation of toll rate DMS panels on new sign structures on I 95 NB  July 2024 Bridge 14 propose direct connector structural steel erection July 2024 Bridge 11 outside superstructure construction July 2024 Bridge 11 nightly beam erection  and outside superstructure construction  July 2024

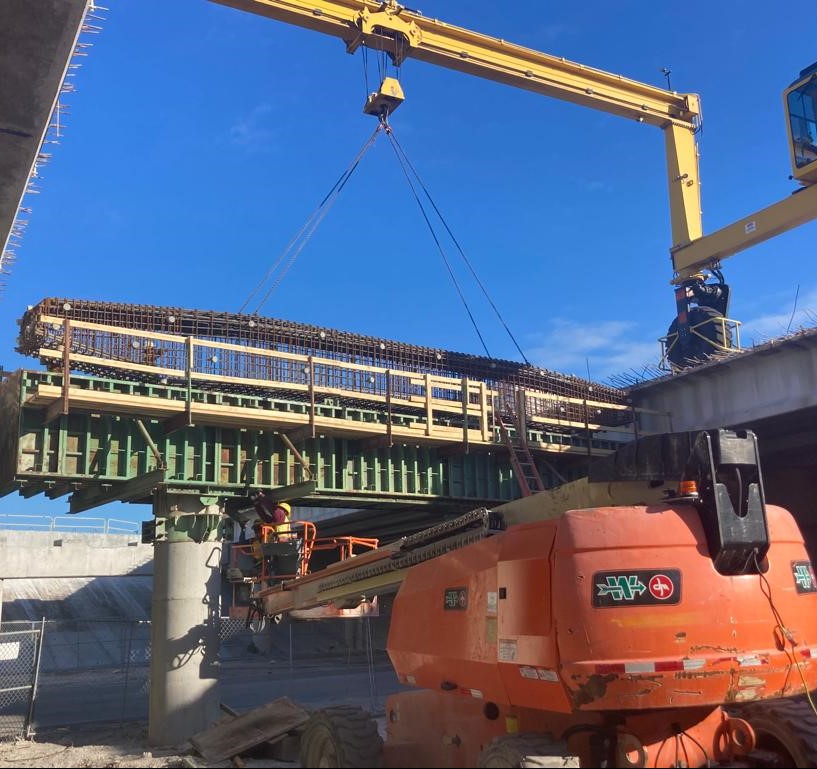

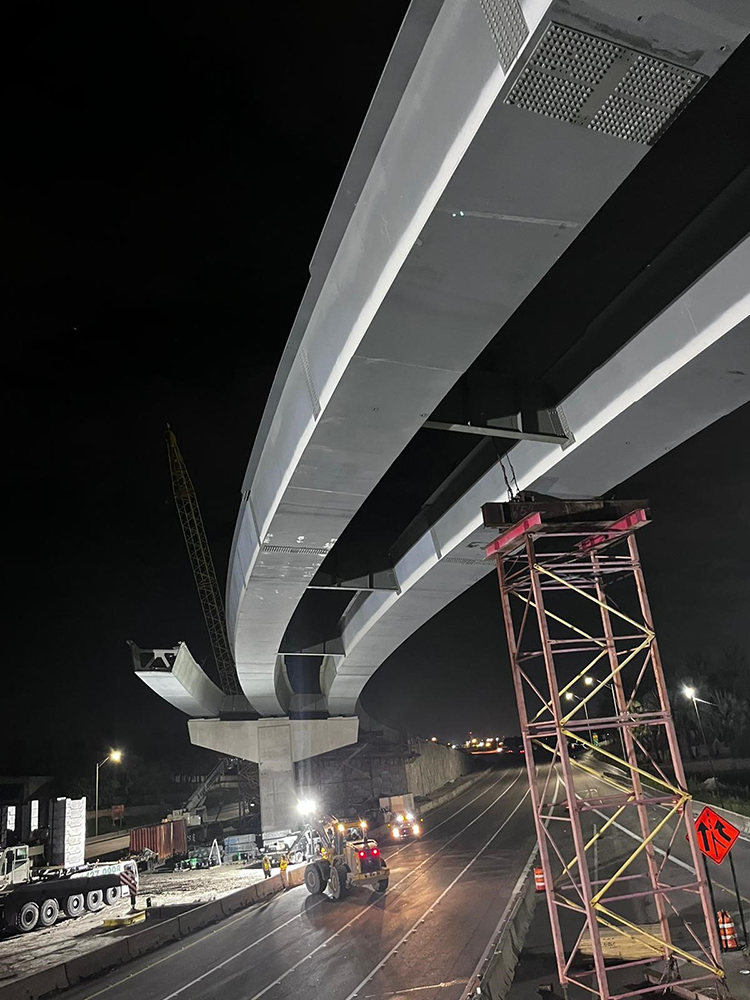

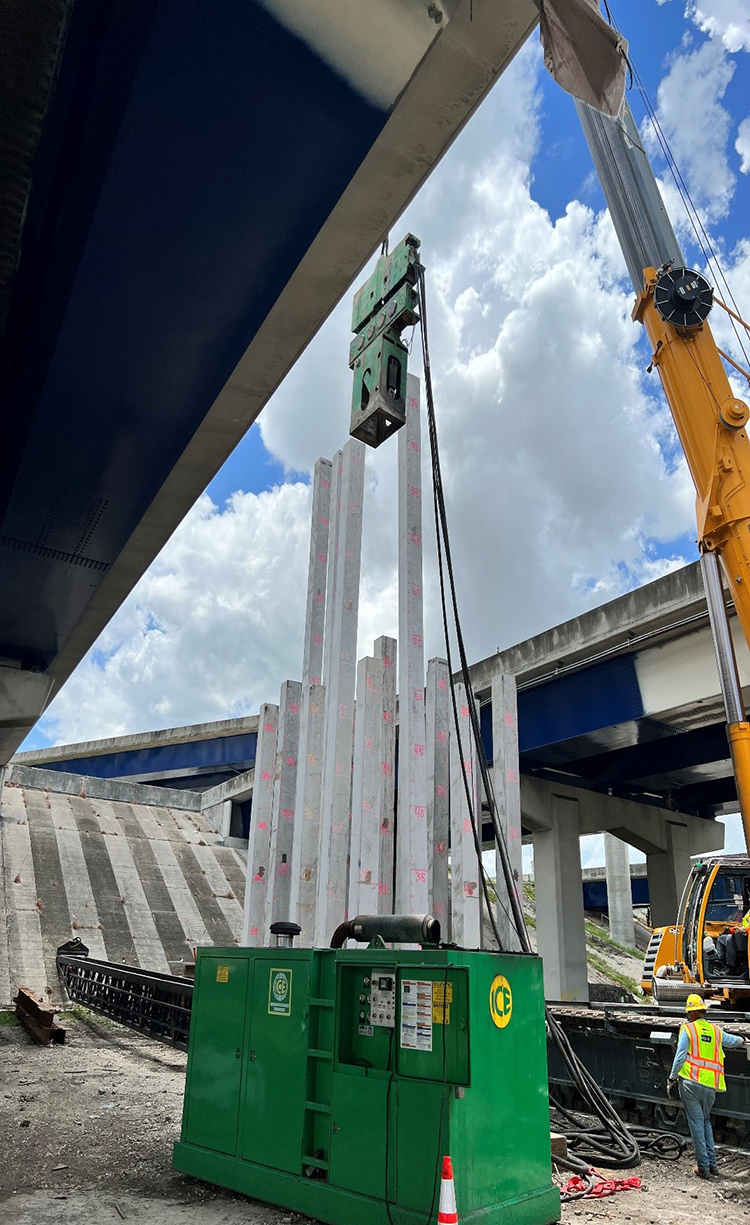

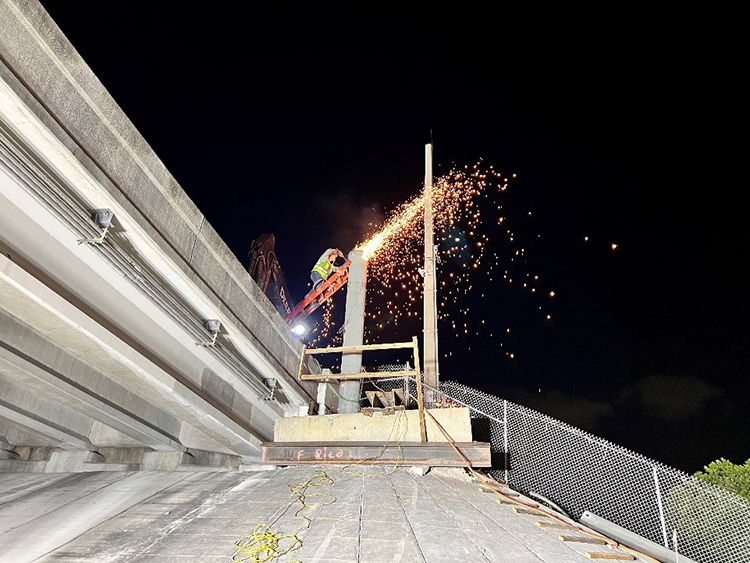

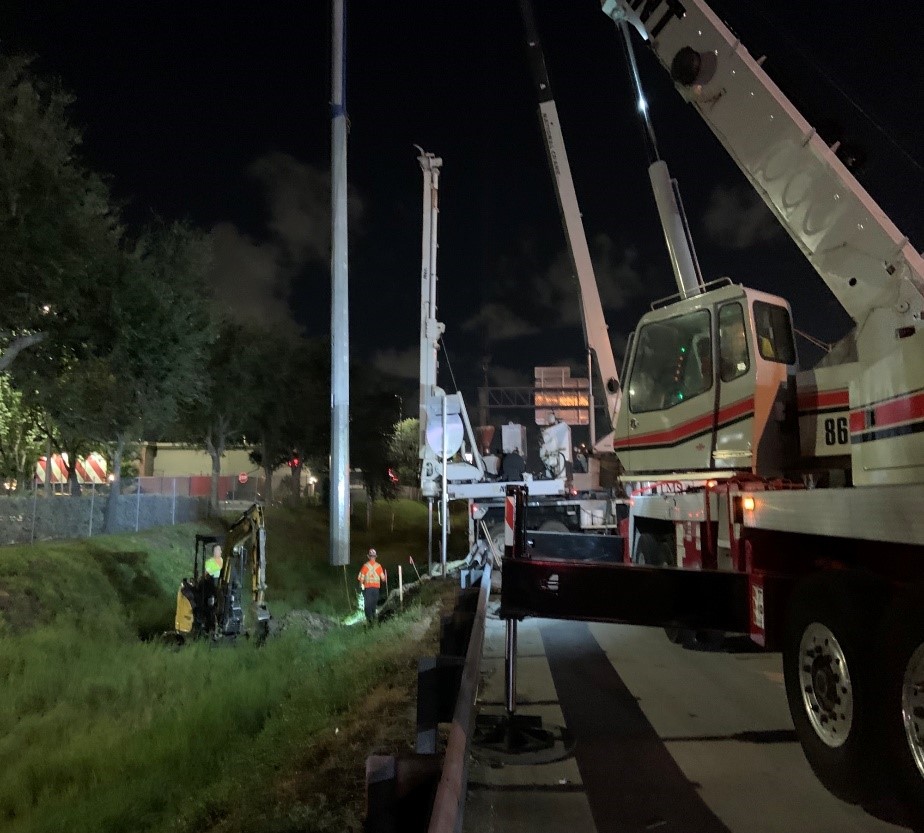

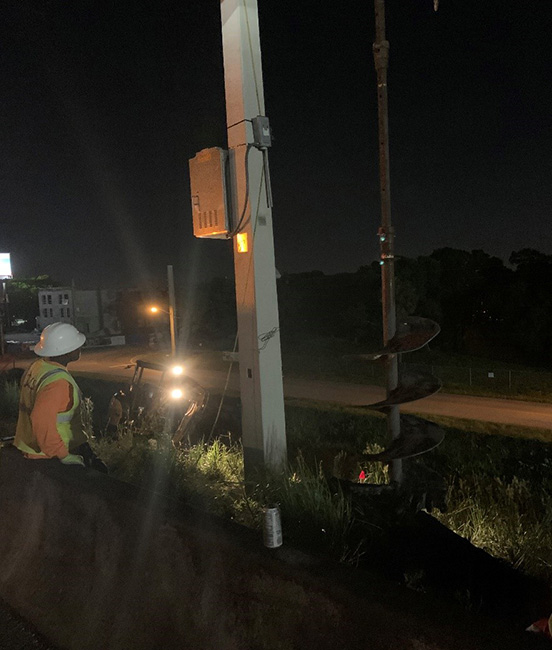

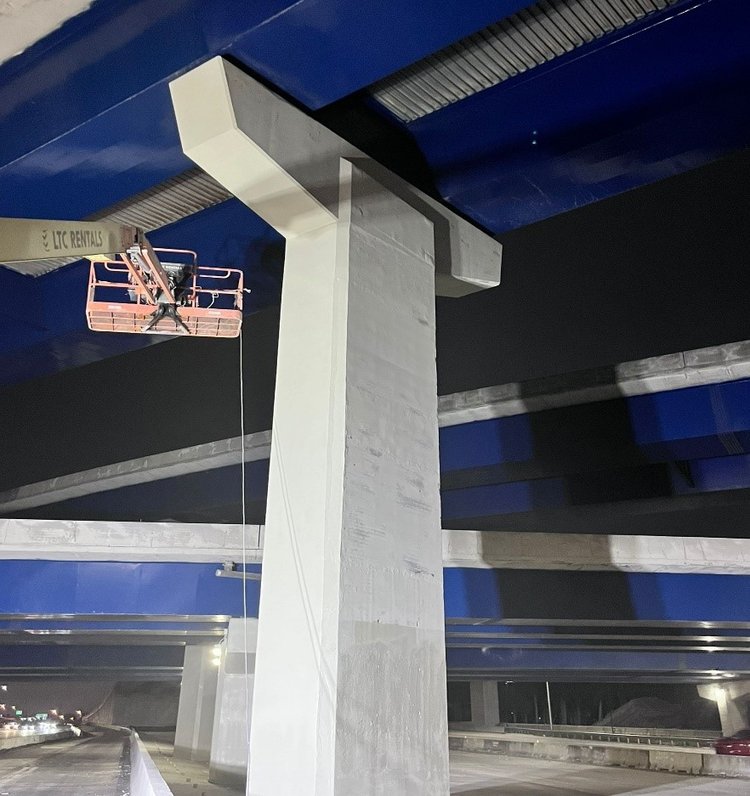

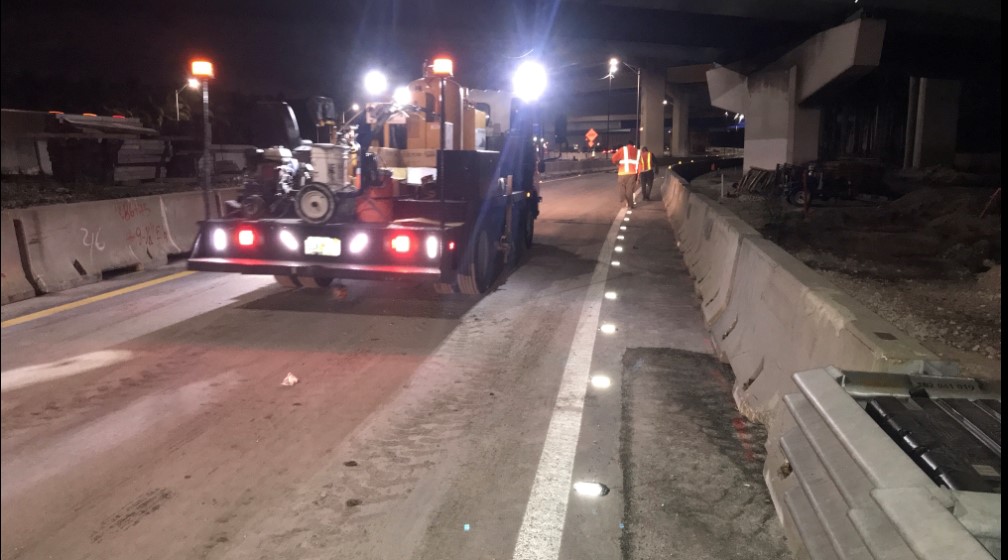

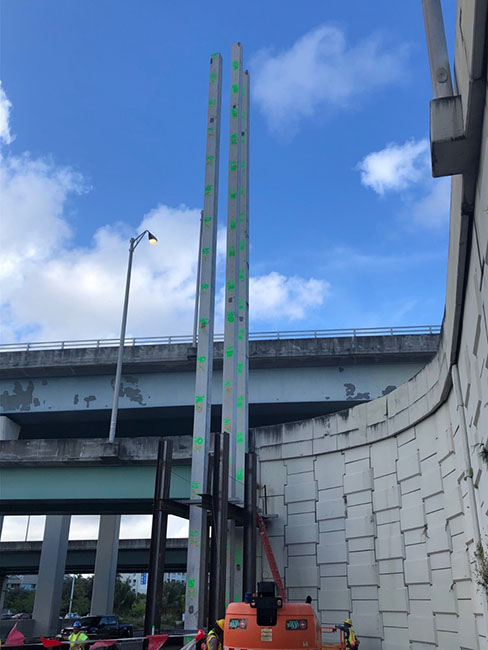

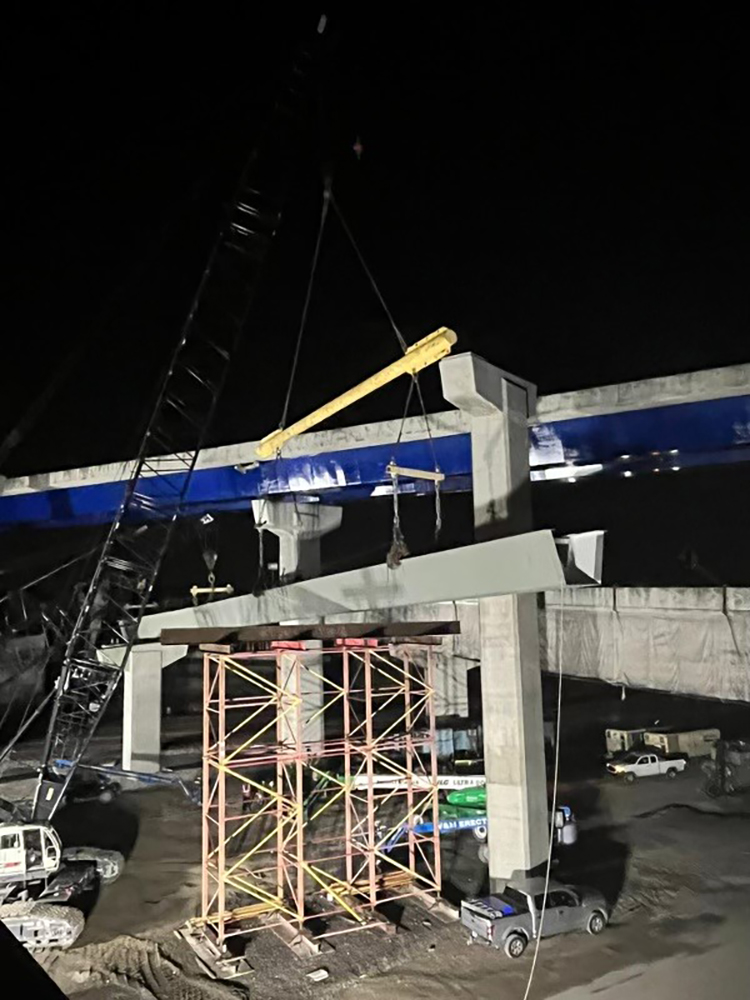

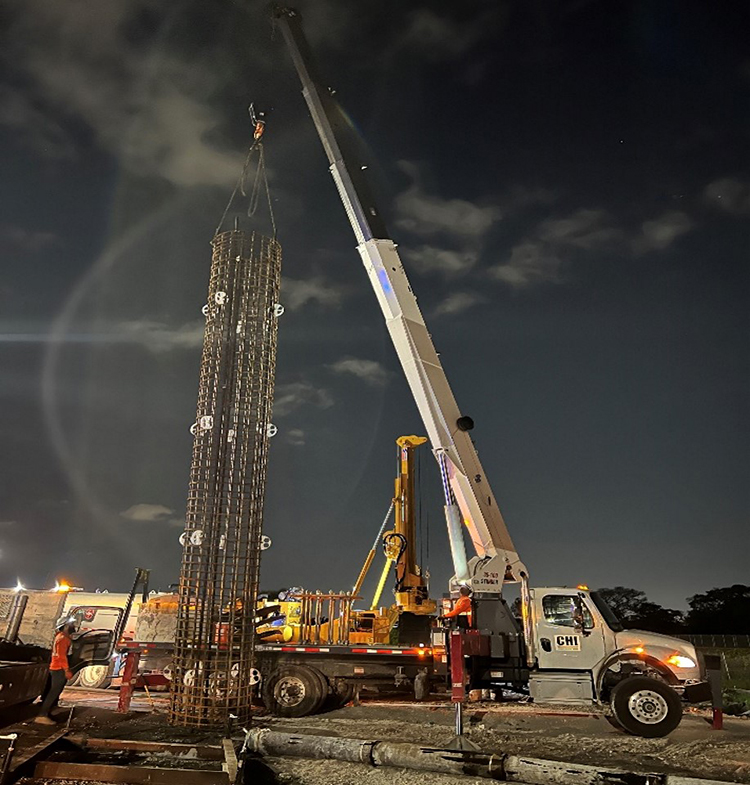

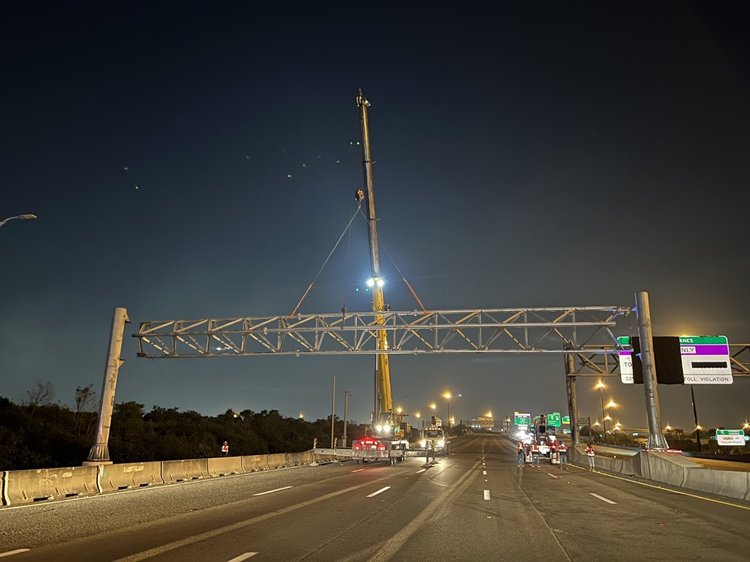

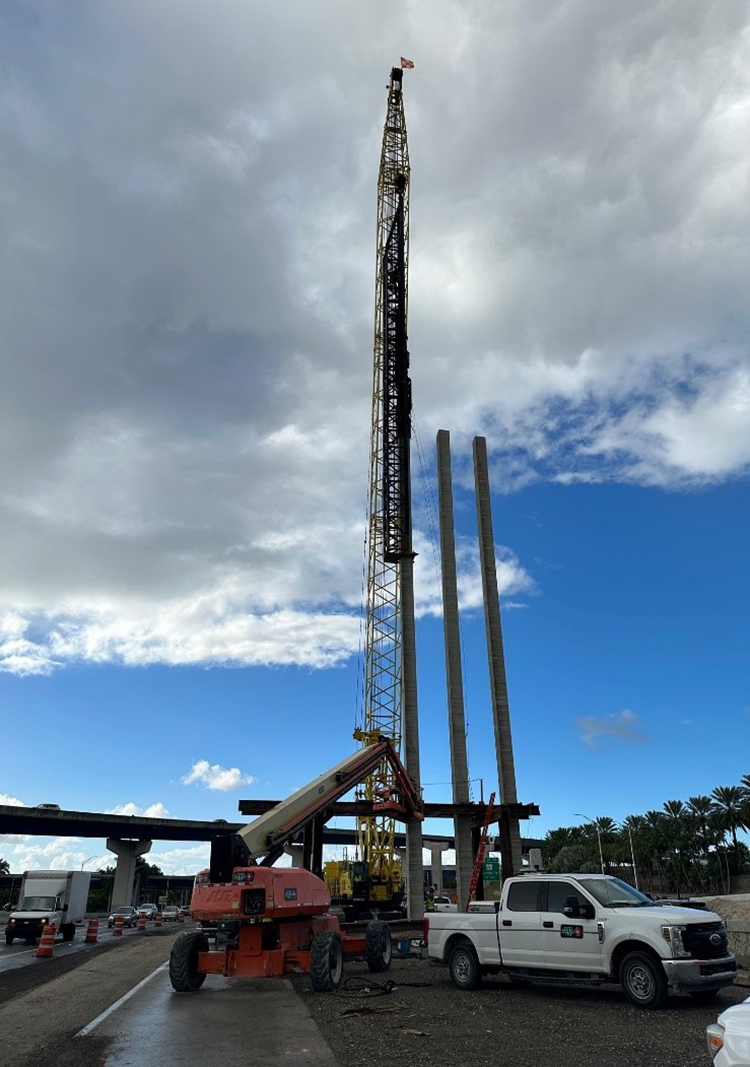

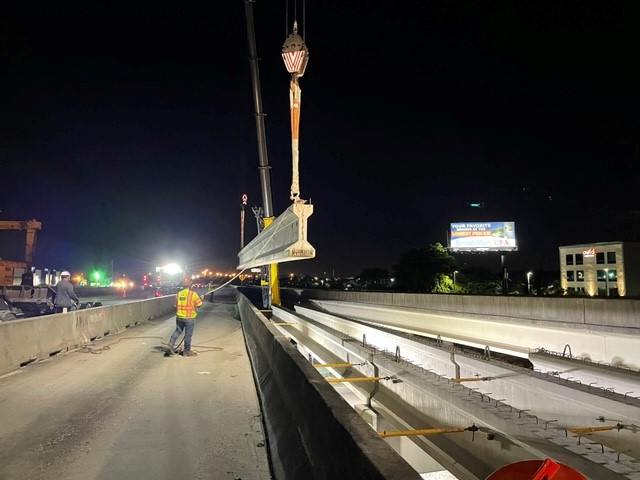

Bridge 14 Structural Steel Erection July 2024 Structural steel erection July 2024 Structural Steel Operations  August 2024WWD Detection System at the I 95 NB Exit Ramp to Hollywood August 2024

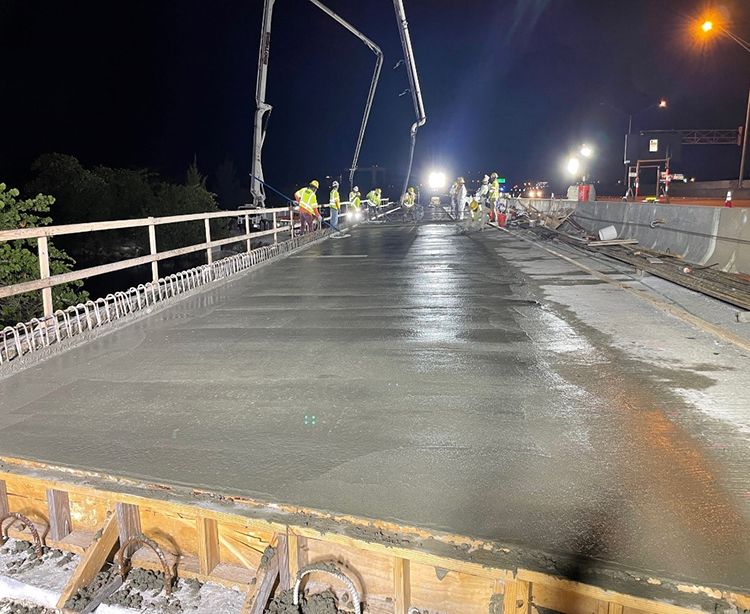

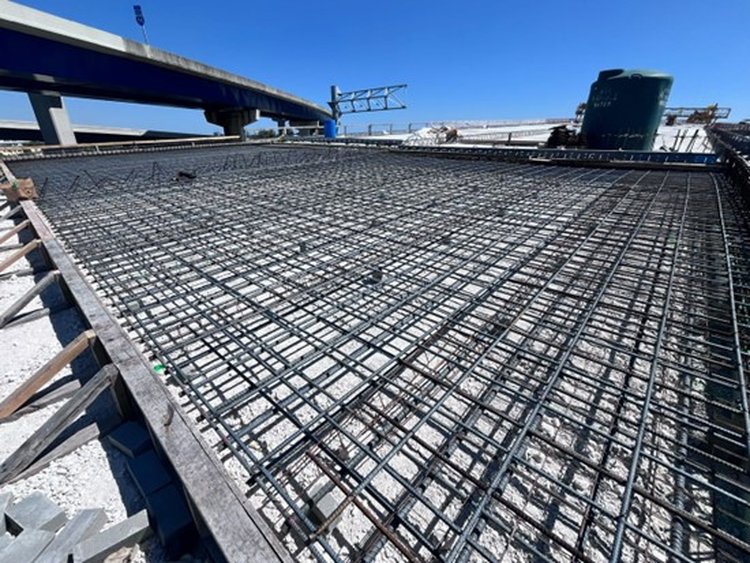

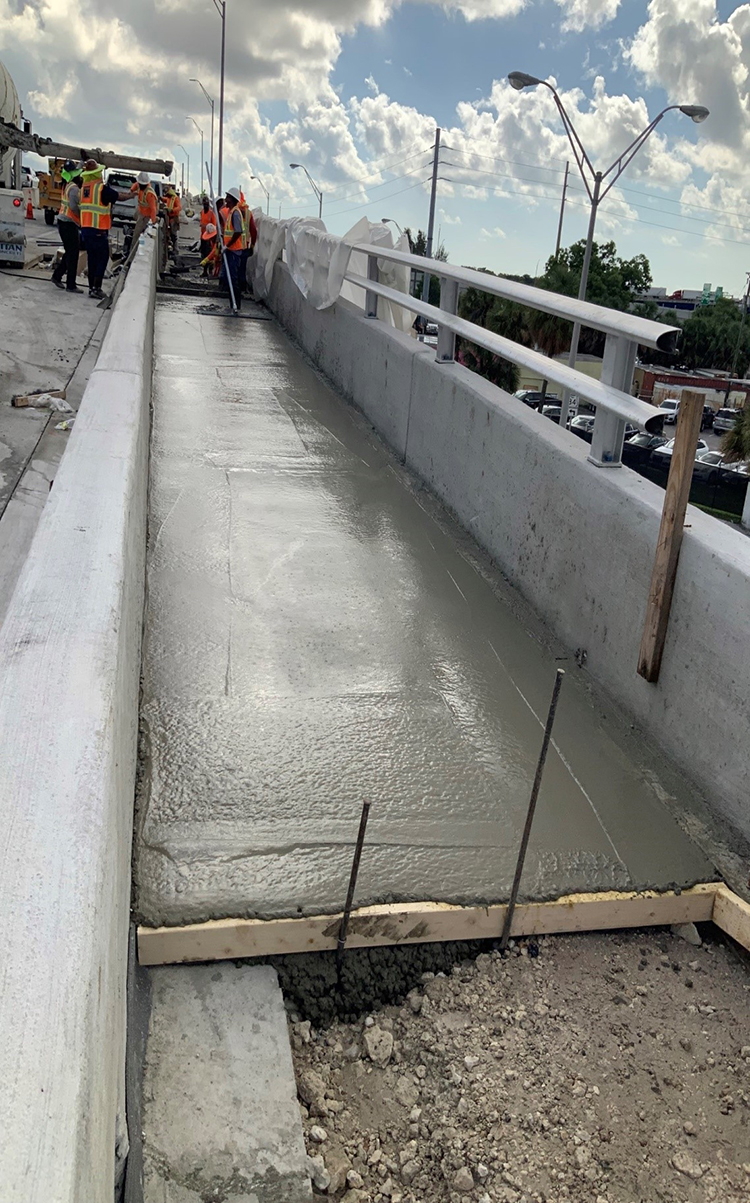

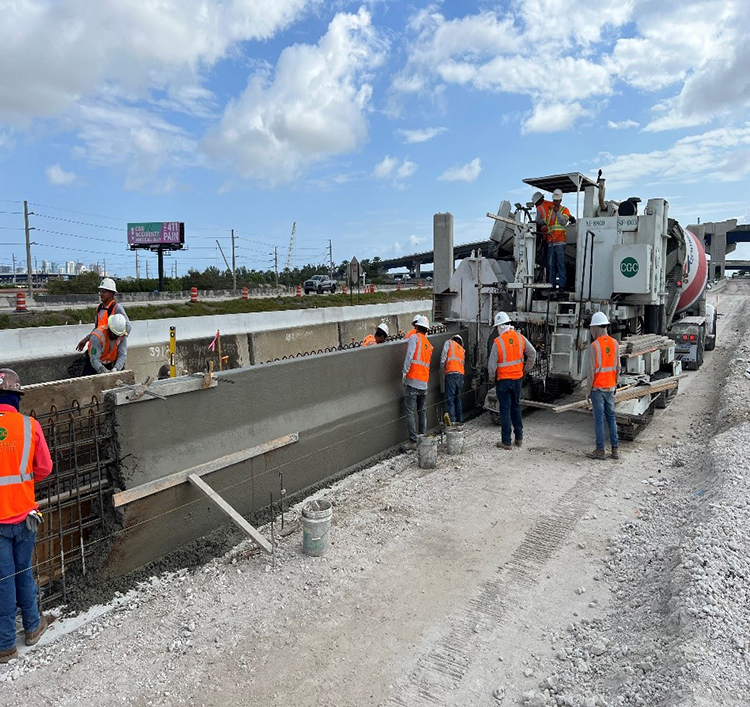

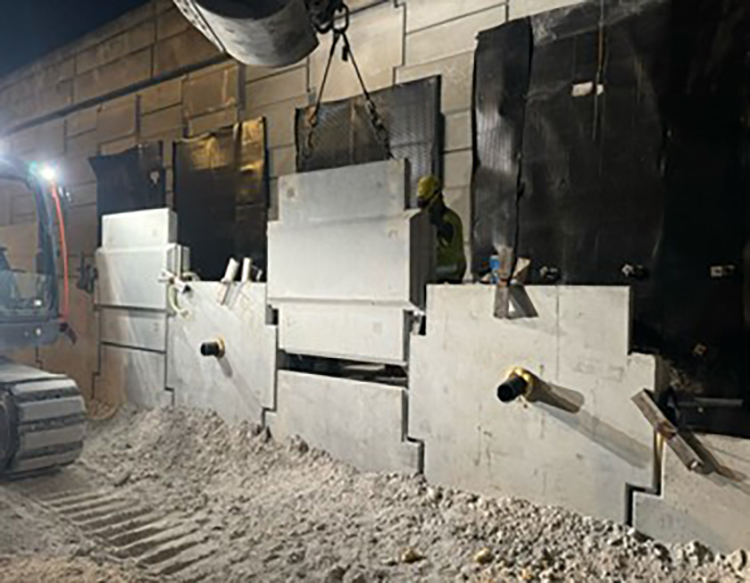

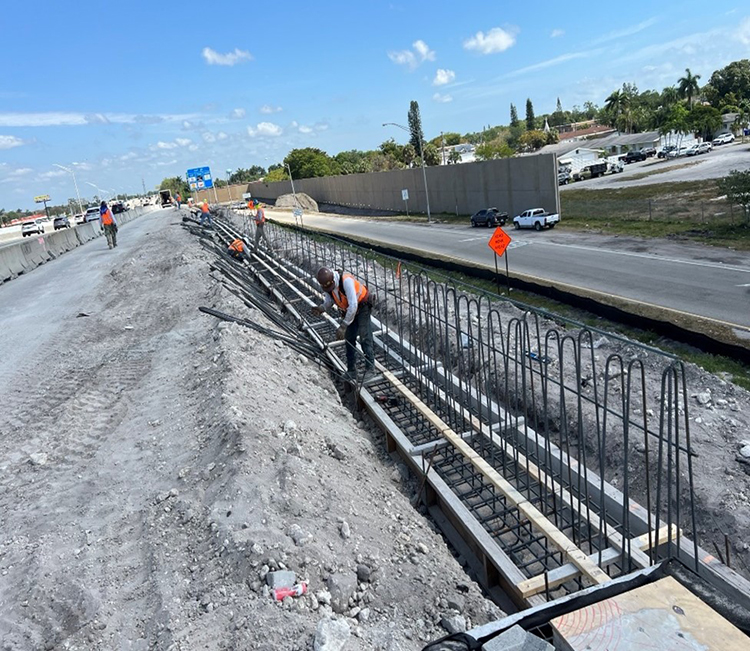

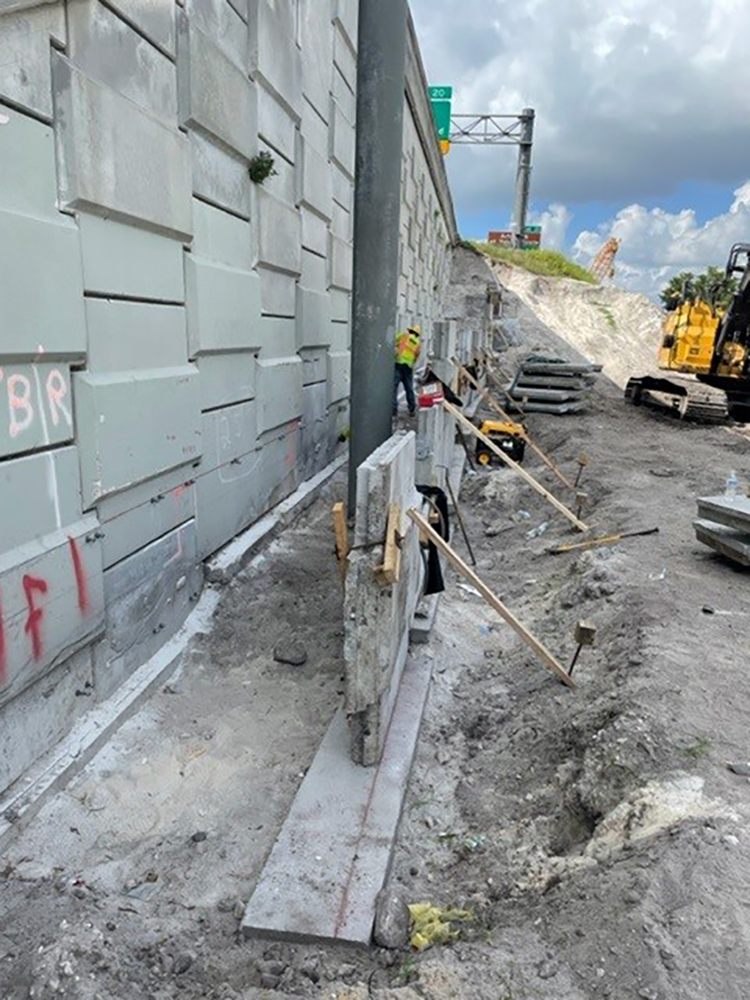

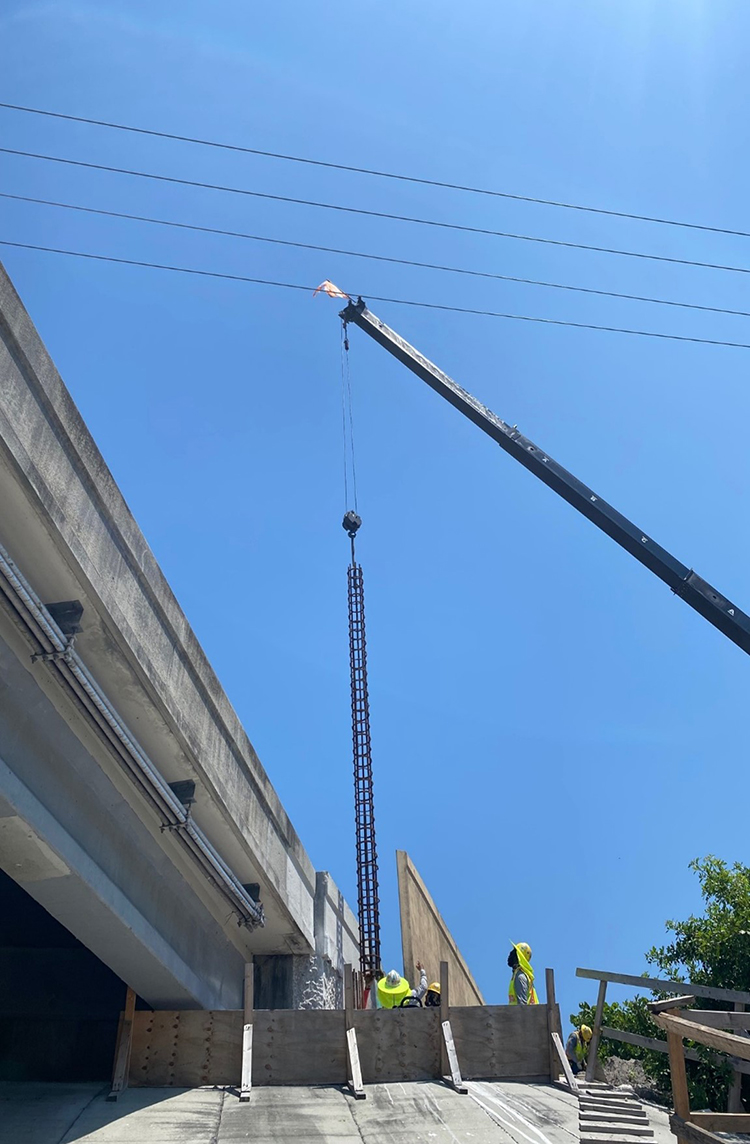

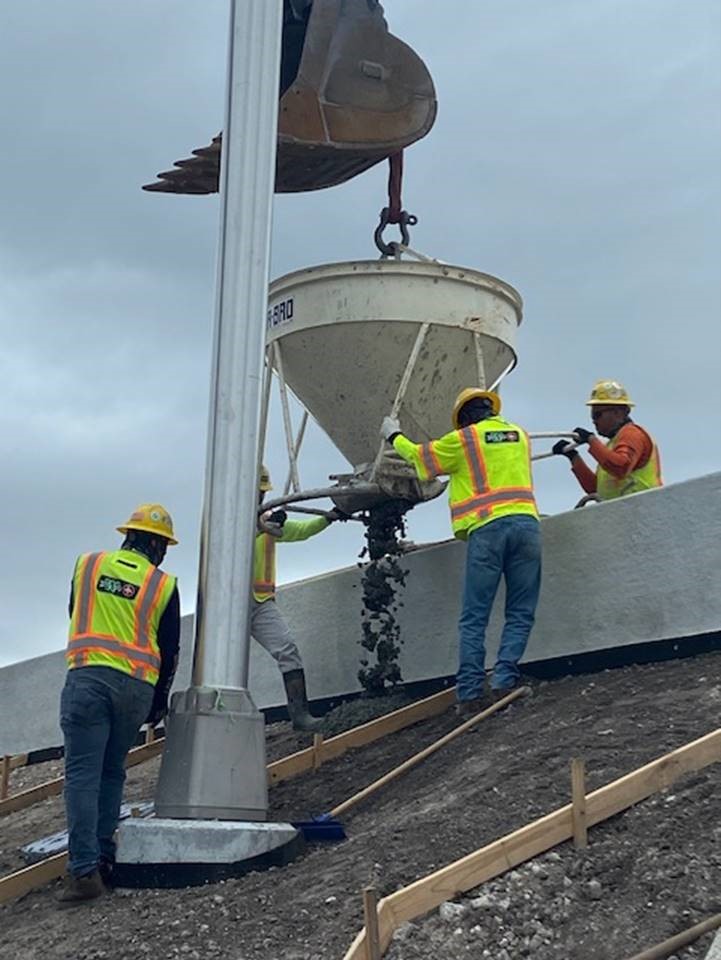

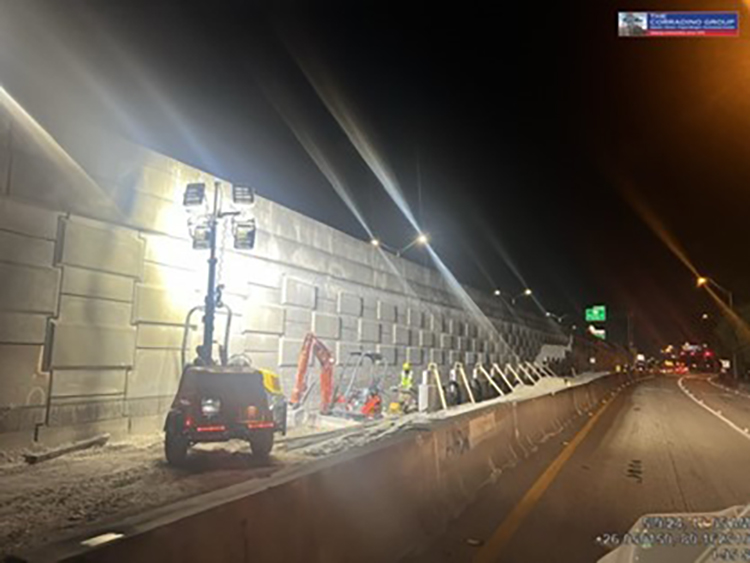

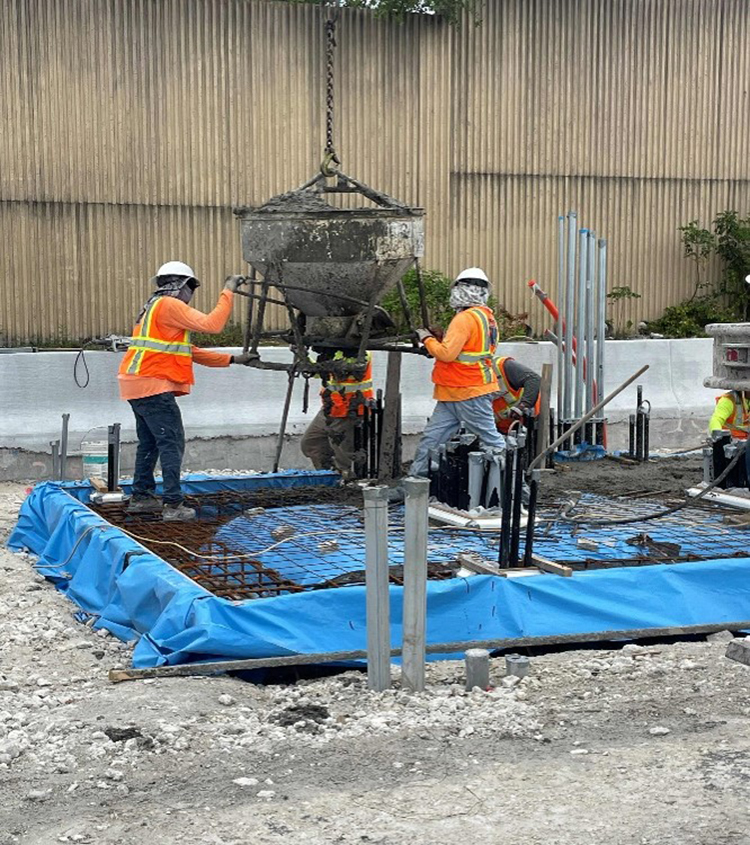

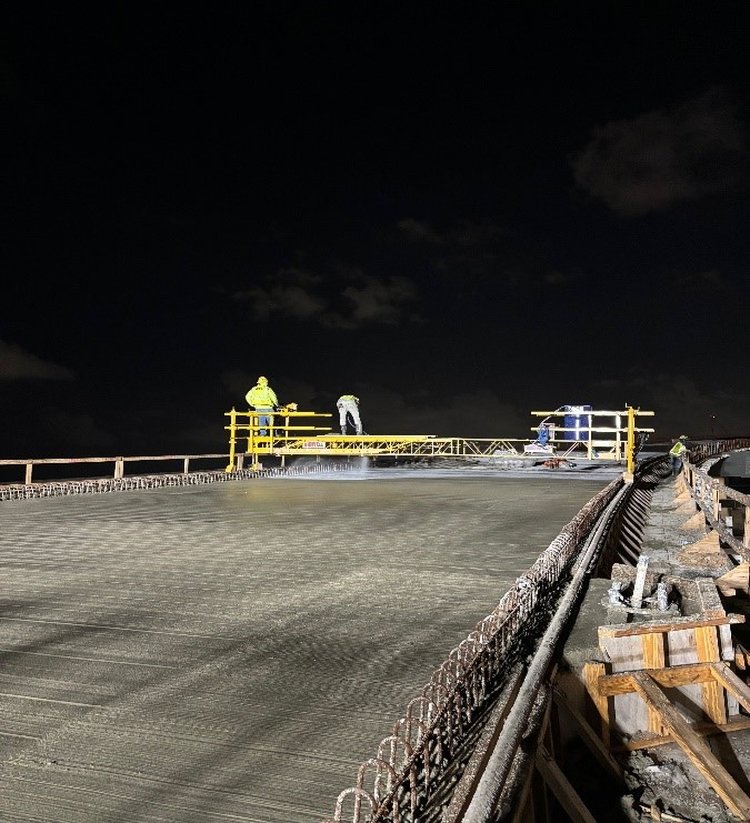

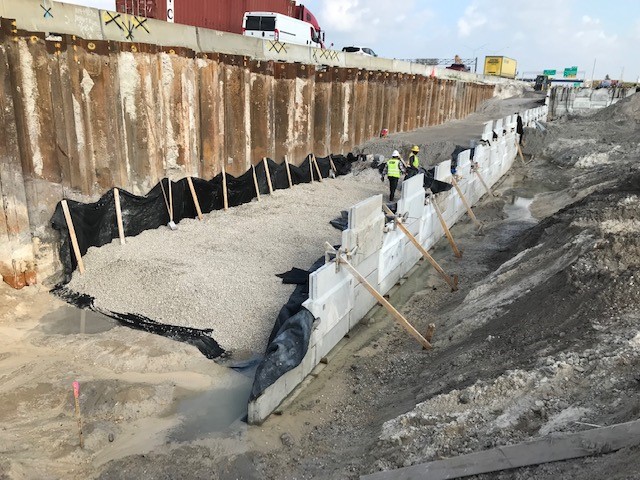

MSE Wall Panel Installation at the Stirling Road Exit Ramp August 2024Approach Slab Construction August 2024Concrete Deck pour Operations August 2024Beam Placement over I 595 August 2024

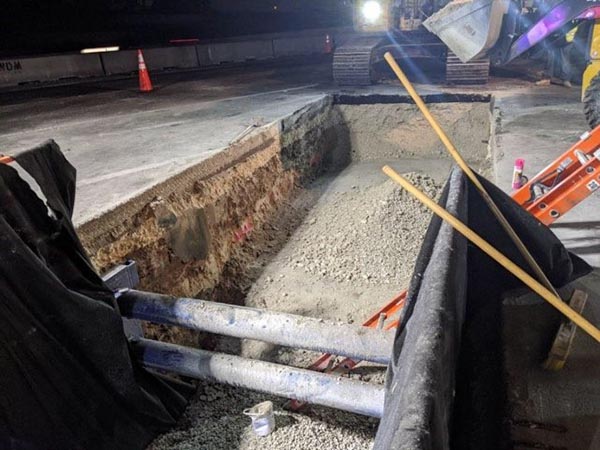

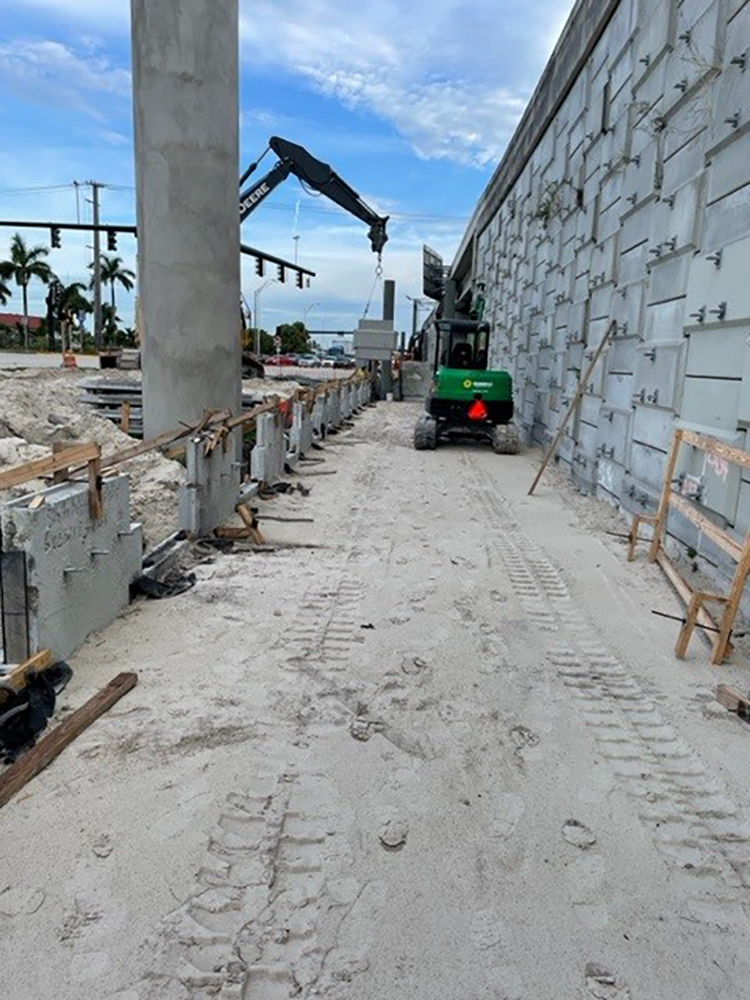

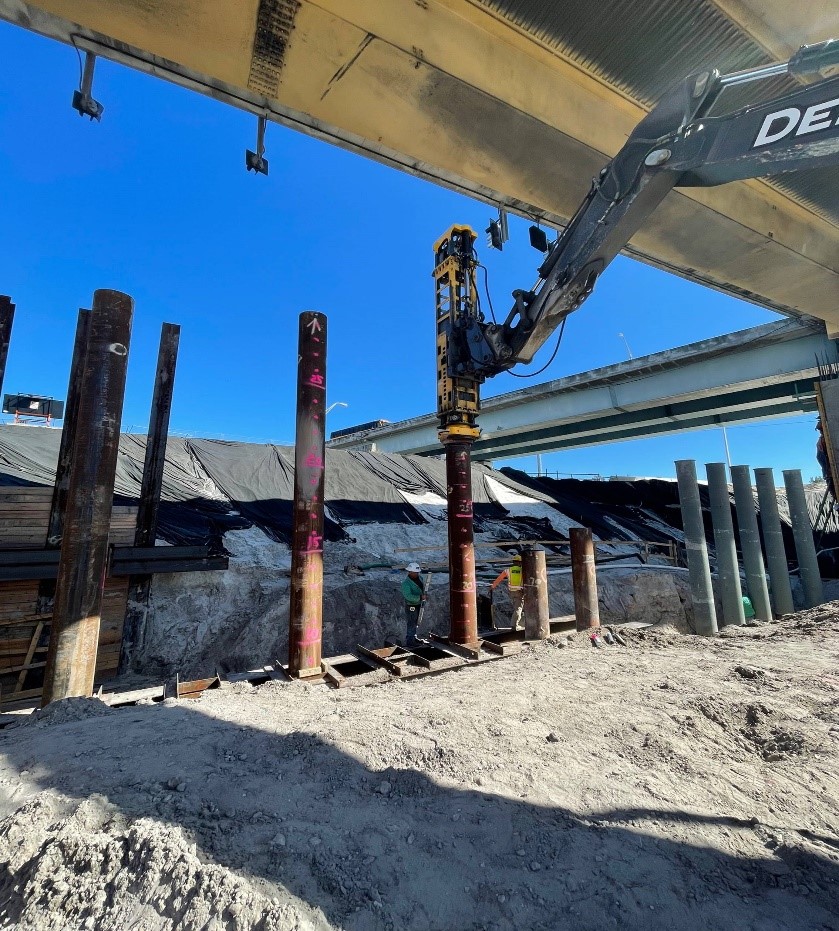

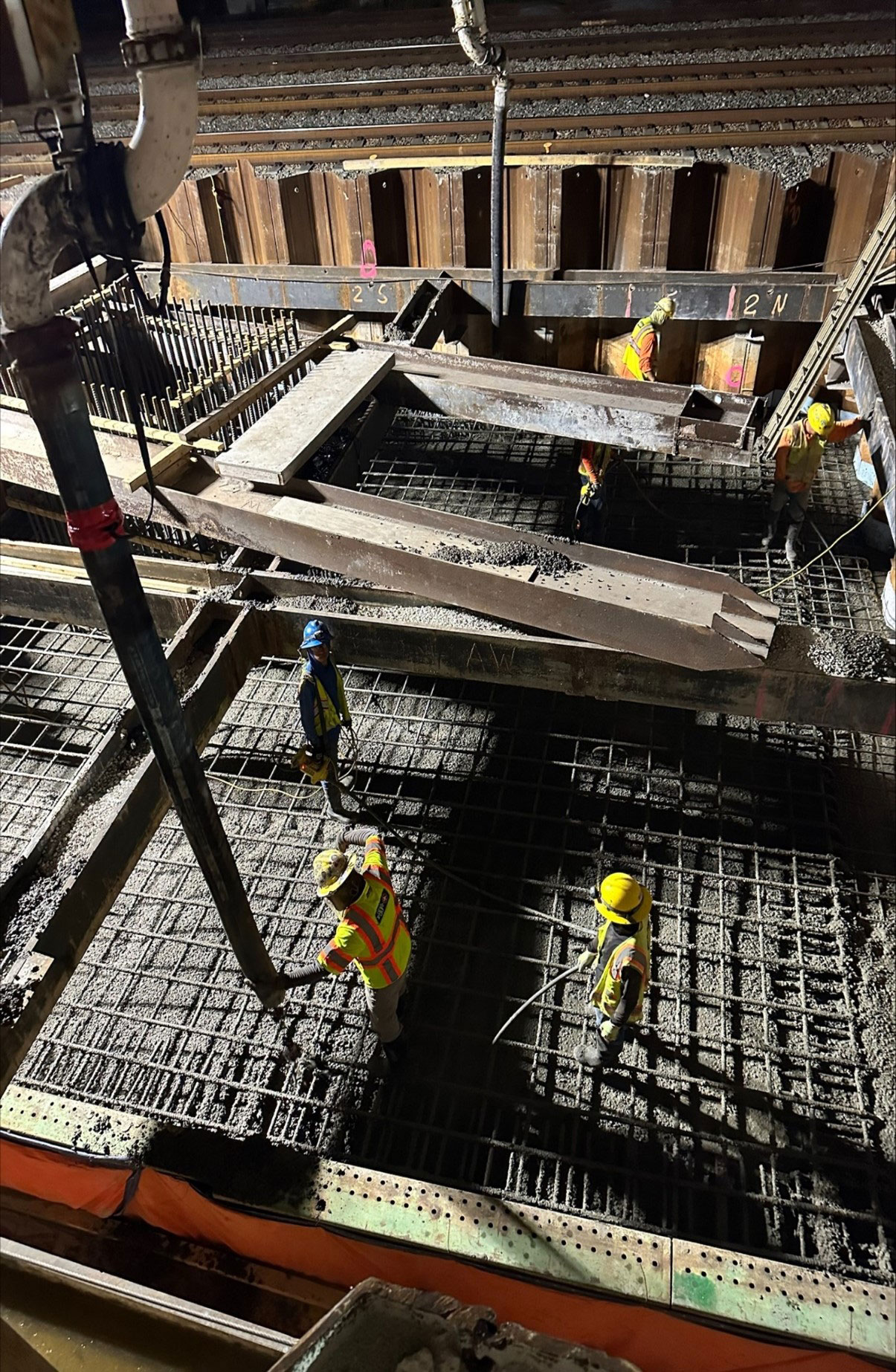

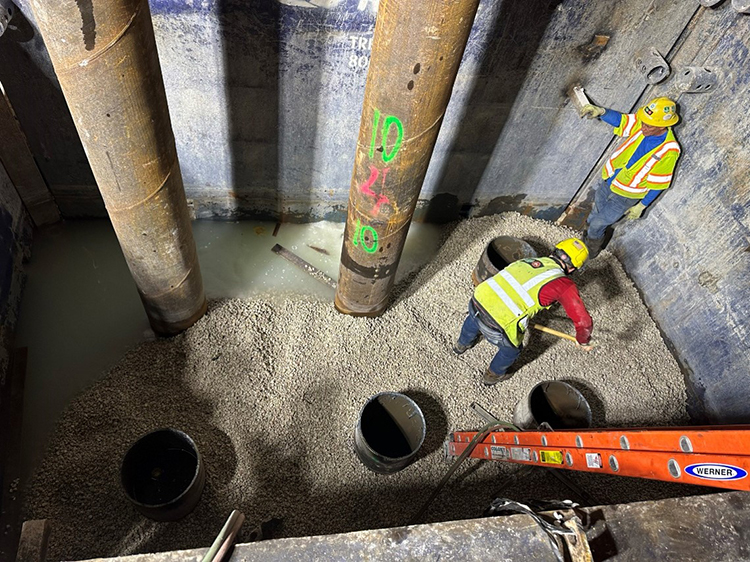

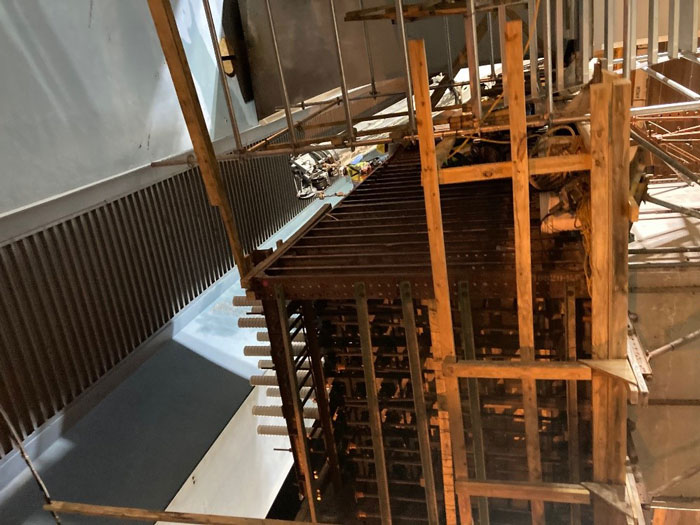

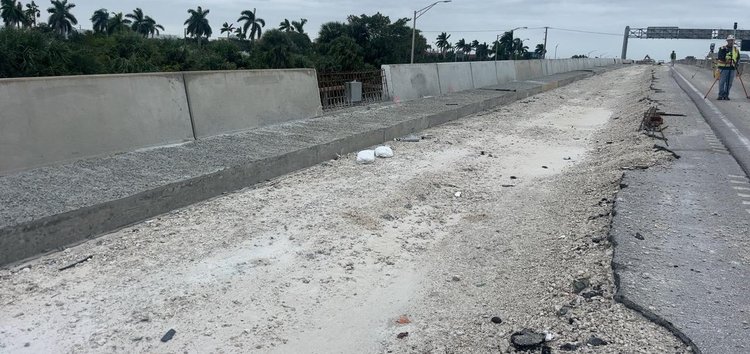

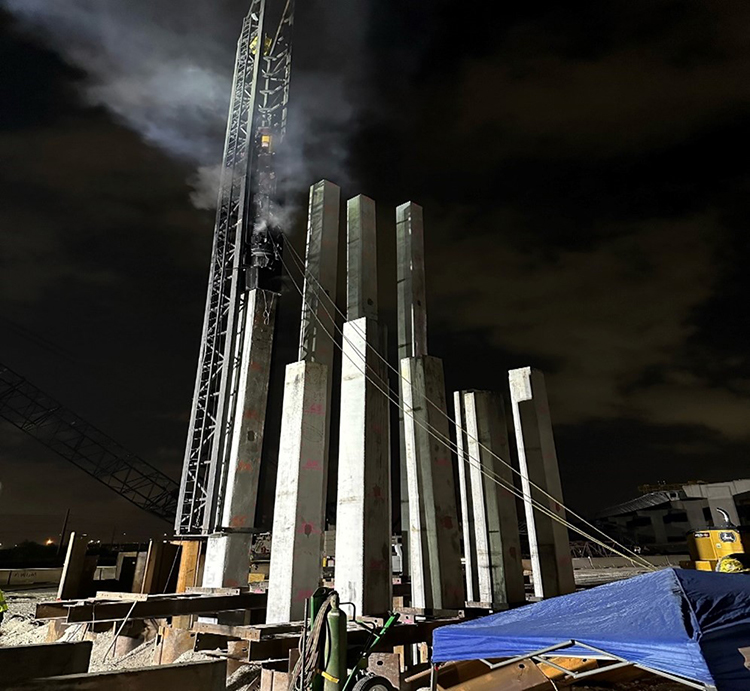

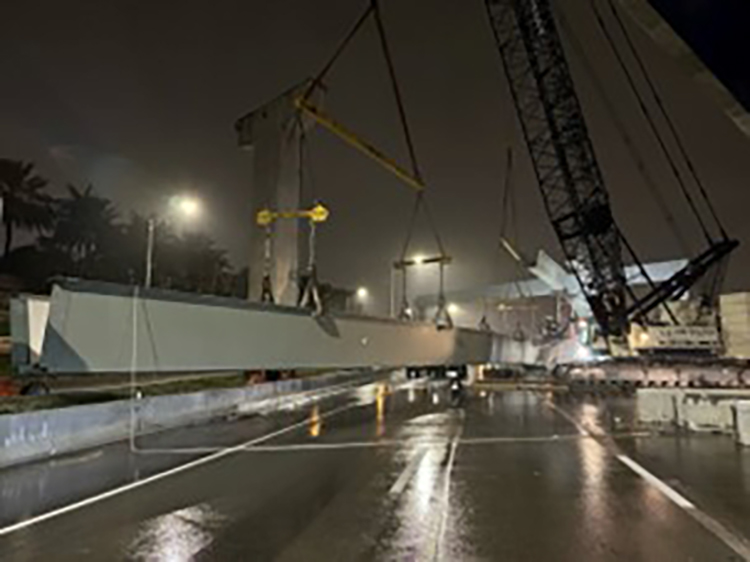

Steel Placement Operations Completed For New Direct Connector Ramps  August 2024Conduit Installation for New Direct Connector Ramp August 2024Direct Connector Deck Pour August 2024Drilled Shaft Foundation along I 95 SB to I 595 Ramp  August 2024

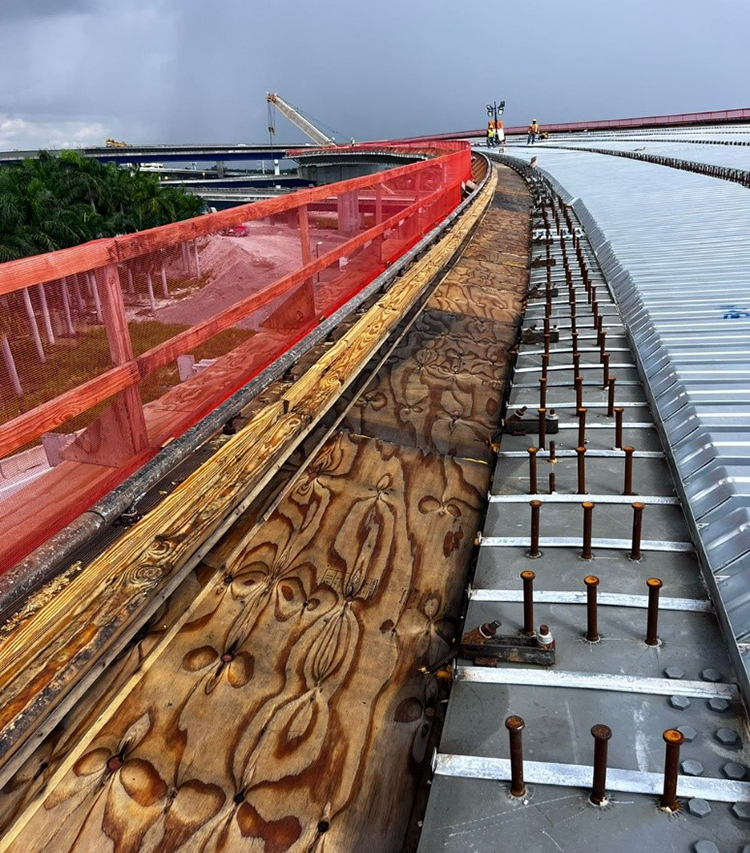

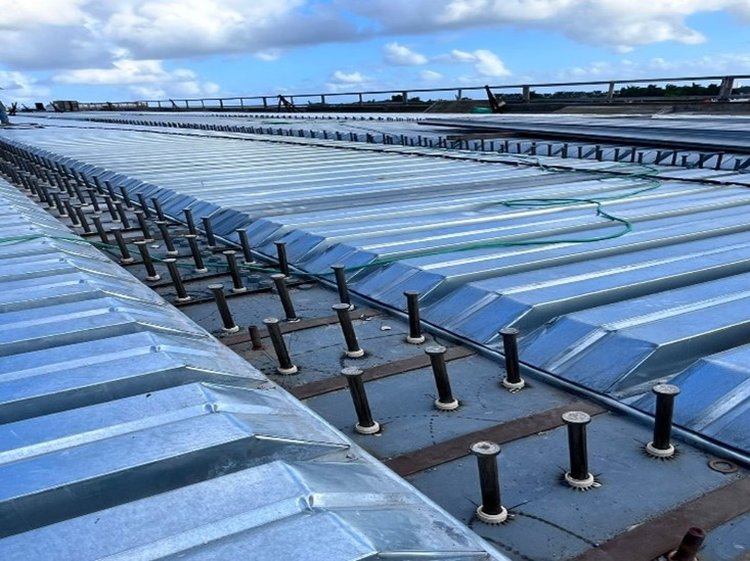

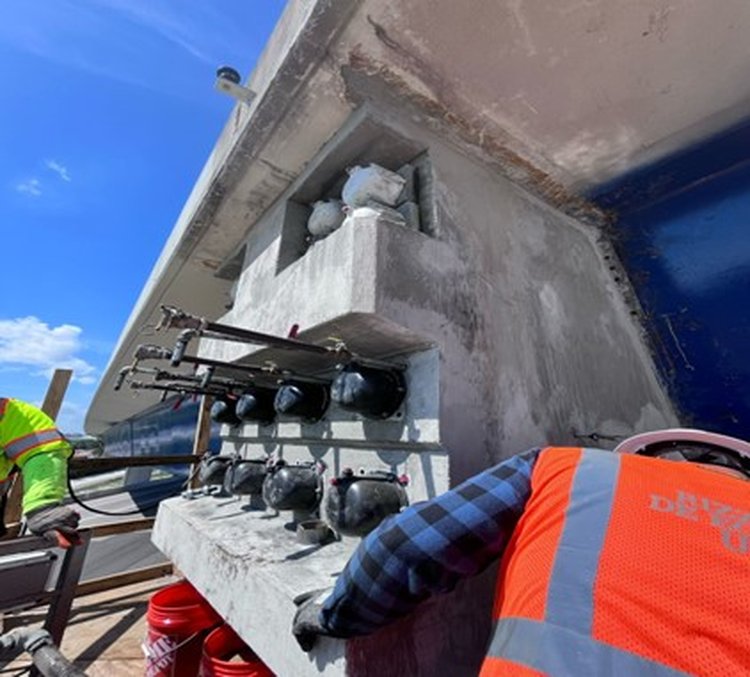

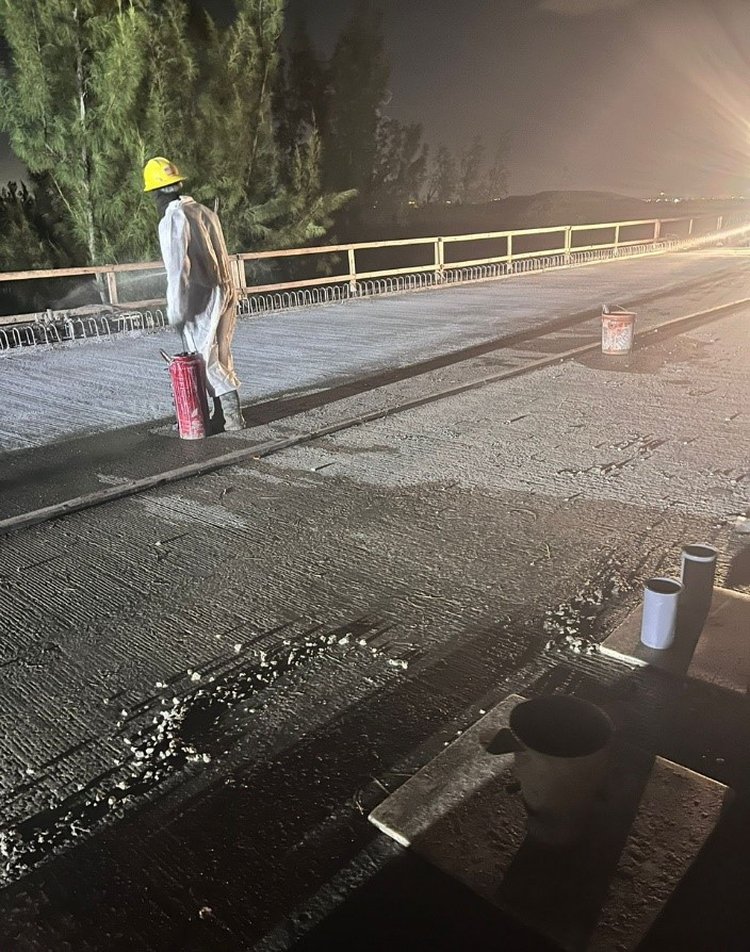

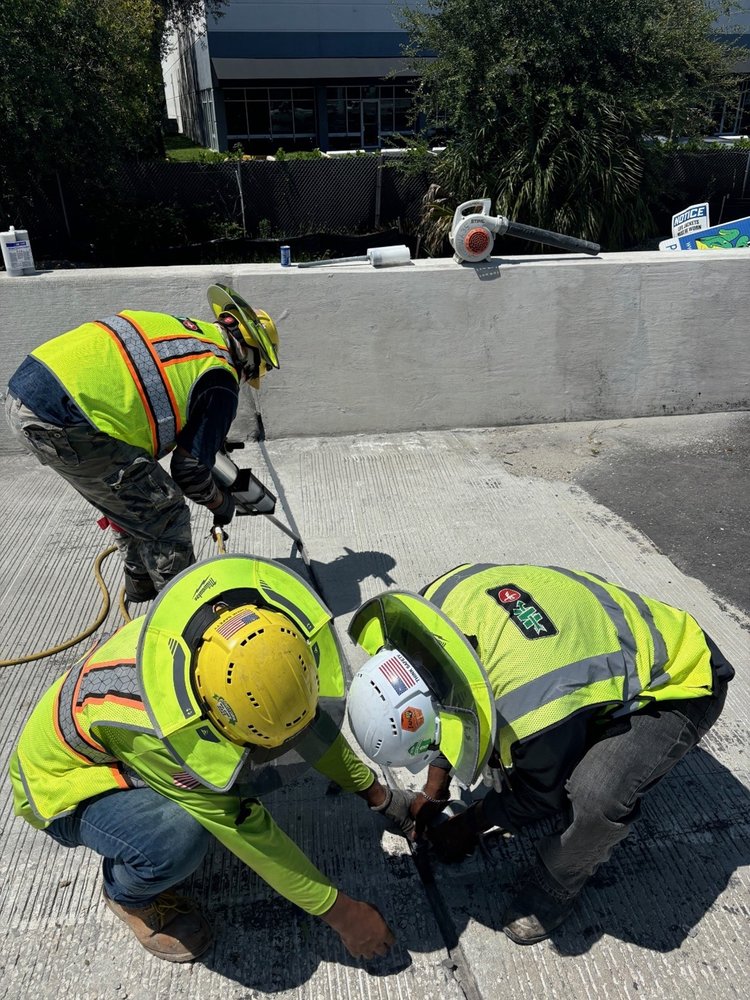

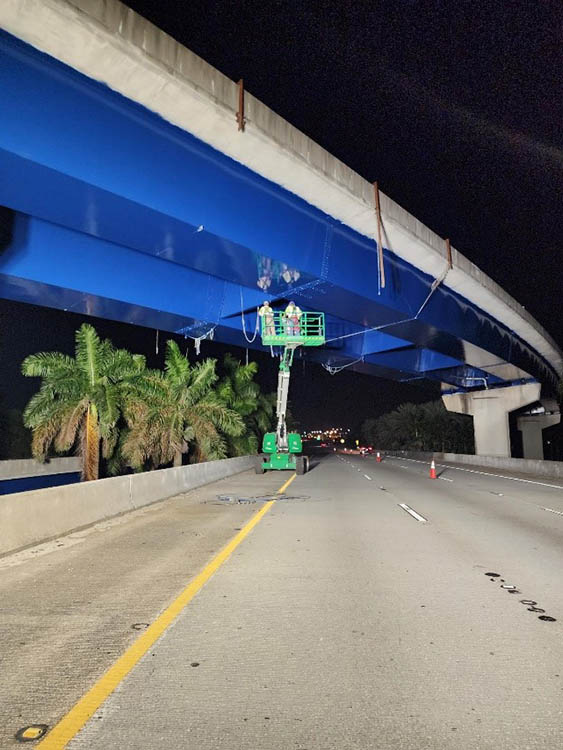

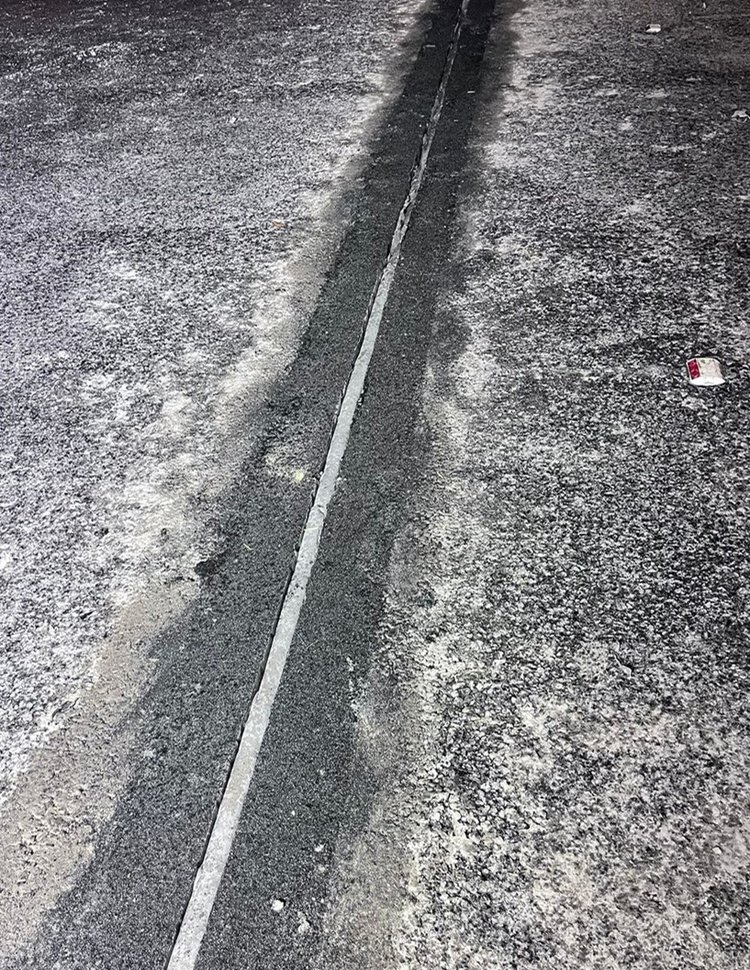

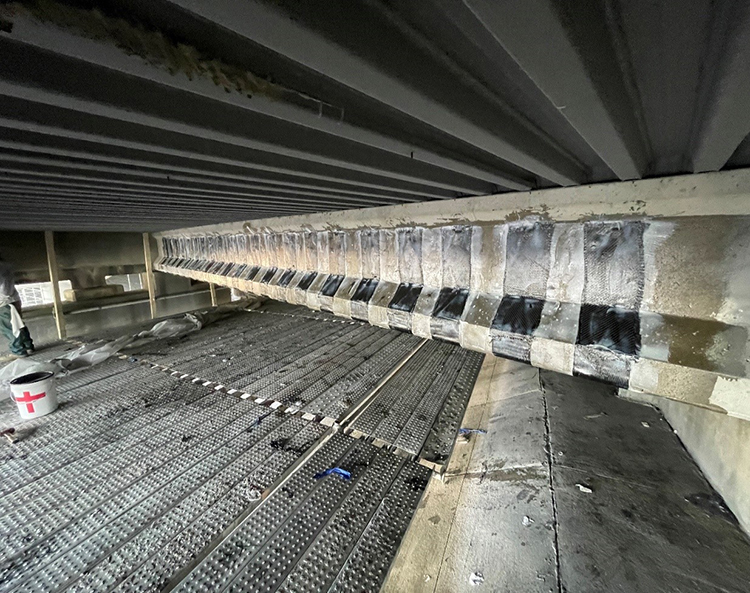

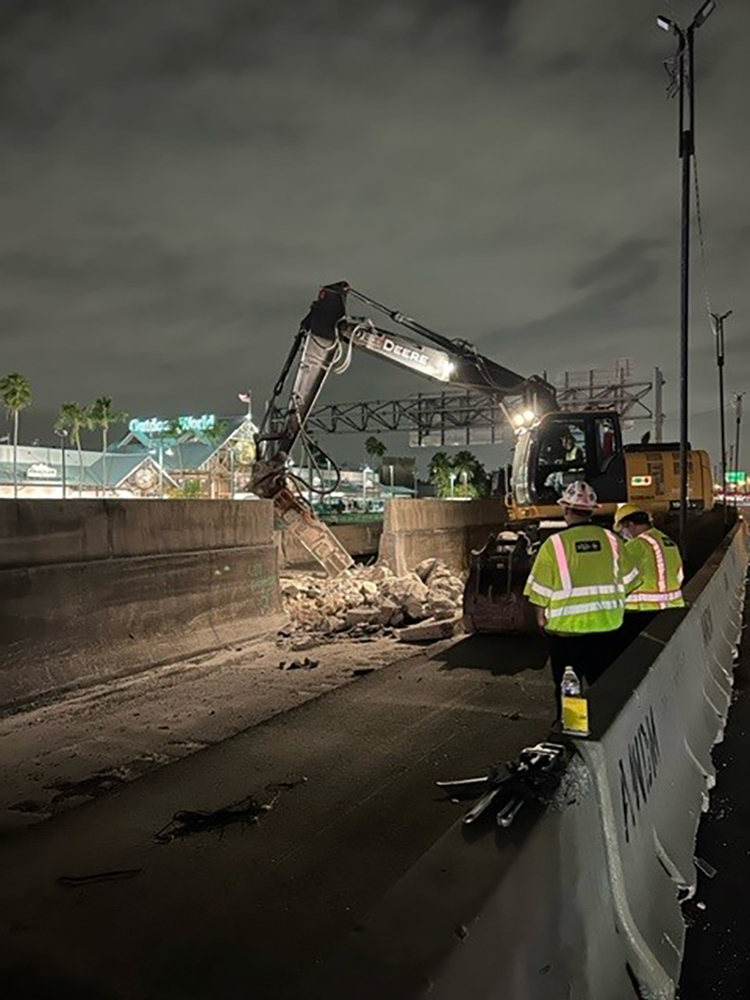

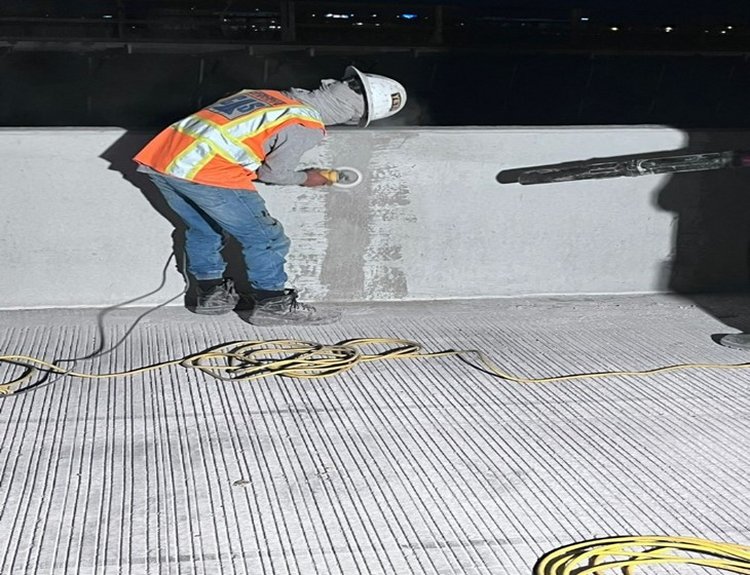

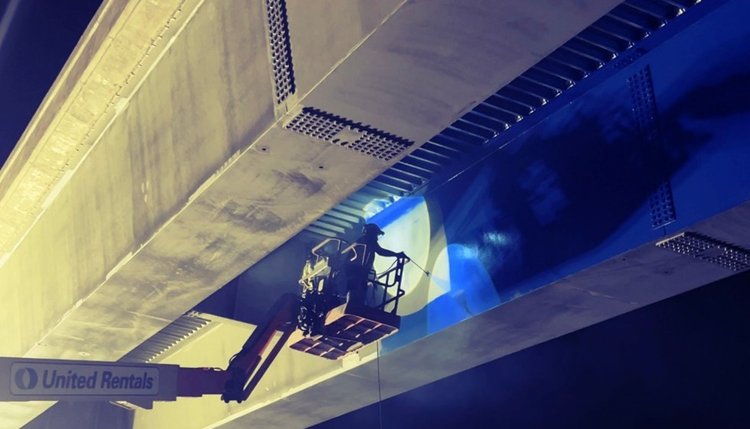

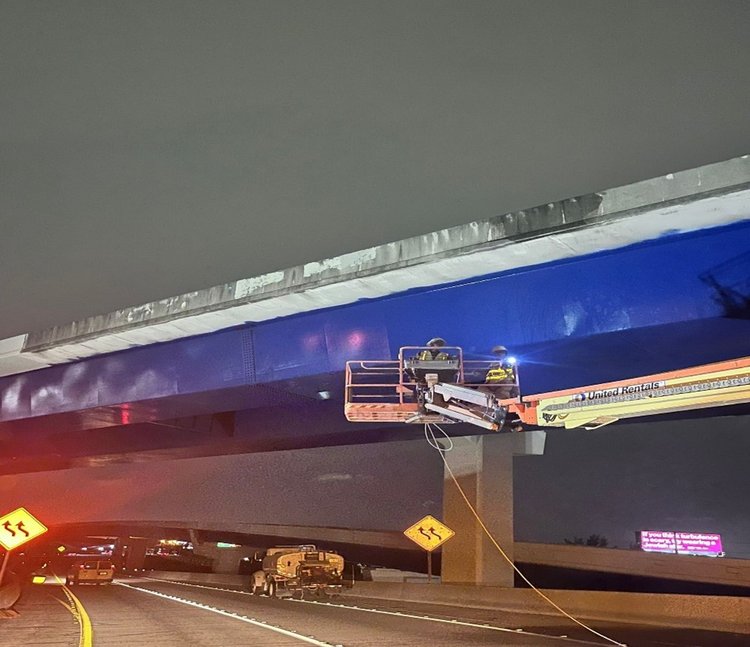

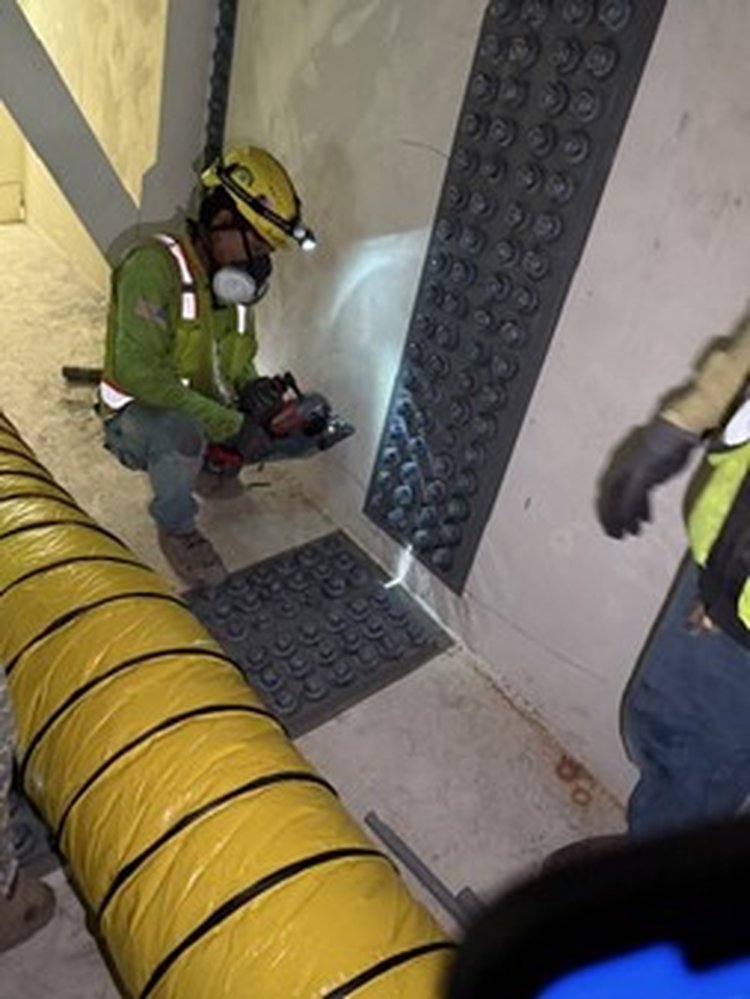

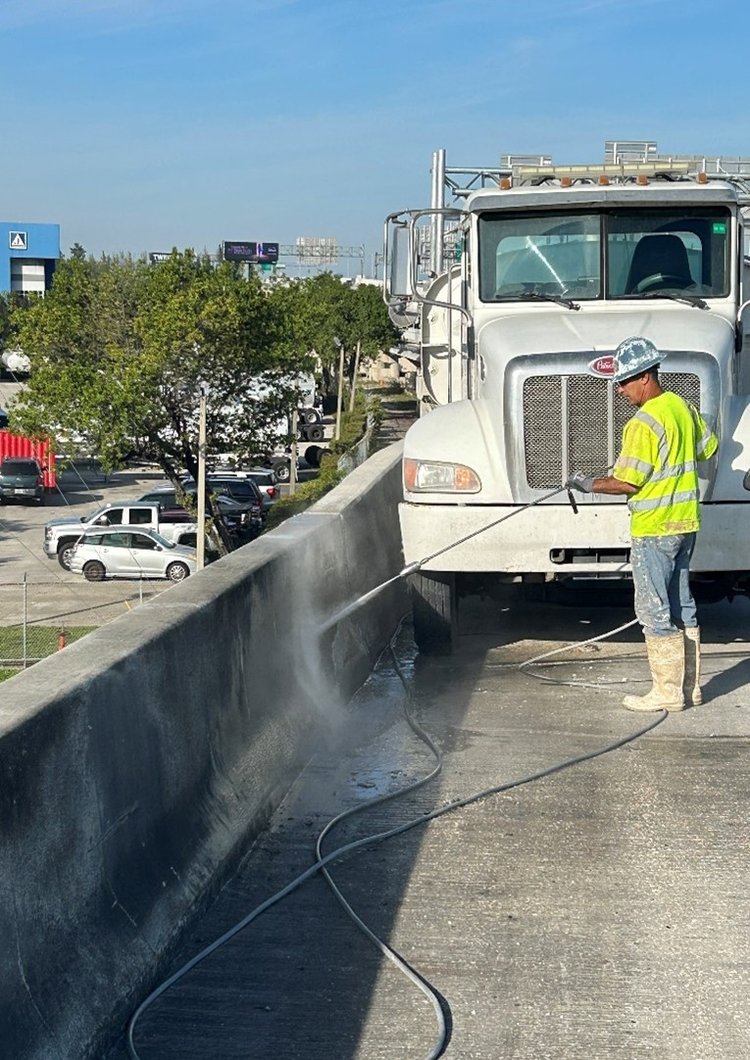

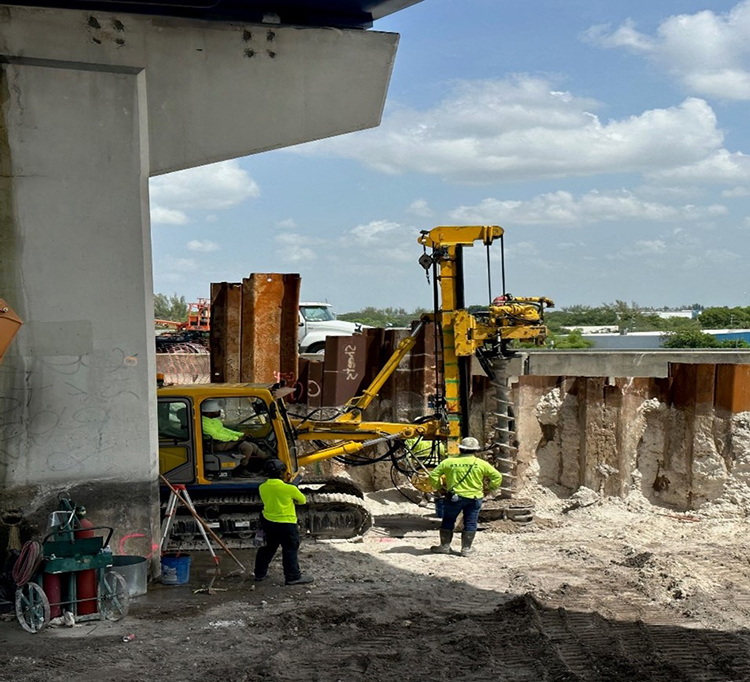

Class V Coating Operations August 2024Class 5 Coating   Nightly Operations at SR 84 Interchange   02   September 2024Temporary Sheet Piles Driving  02   September 2024Bridge 3   Expansion Joints Installation   September 2024

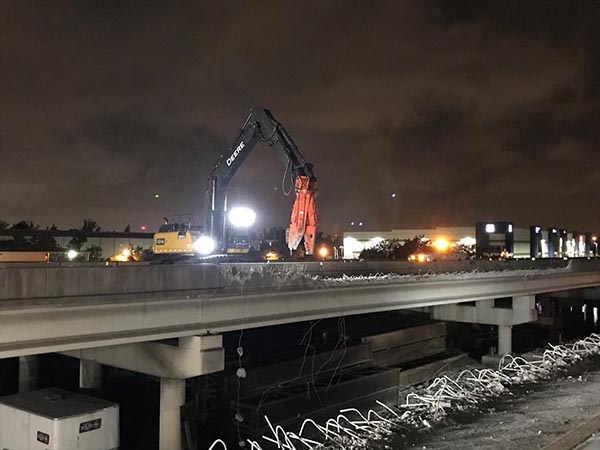

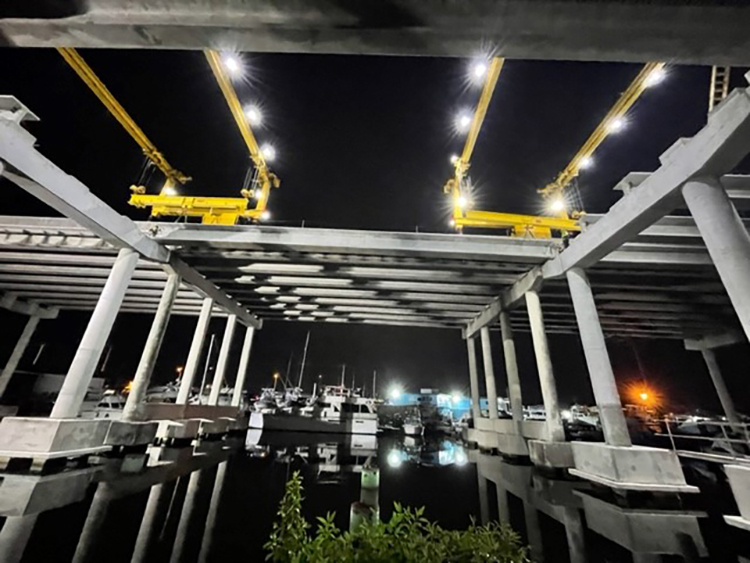

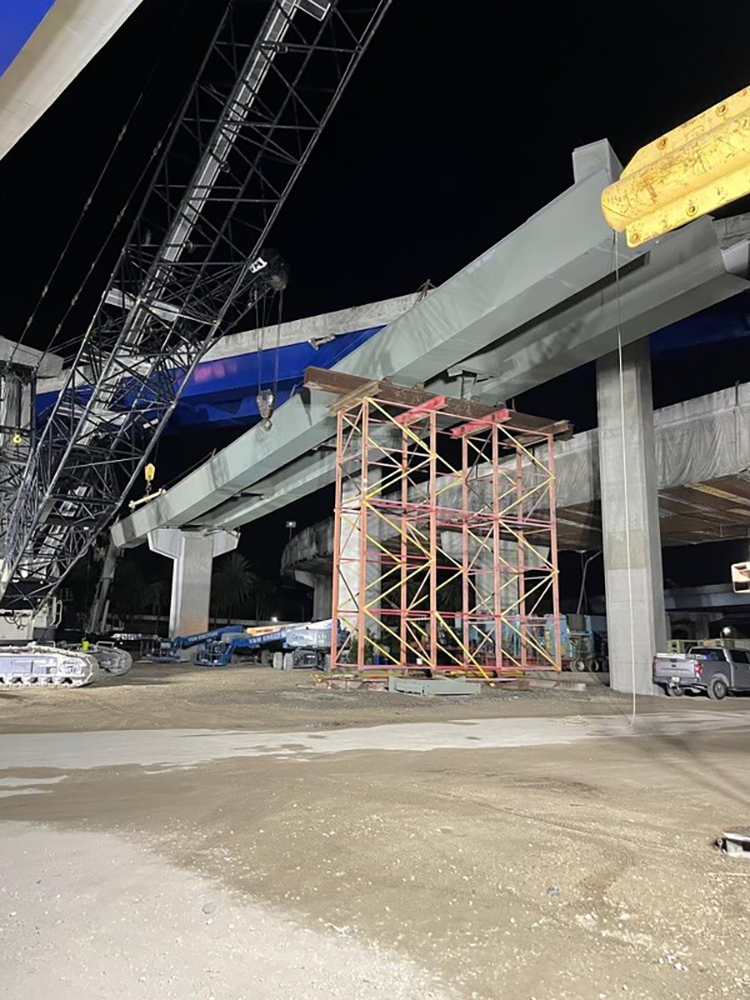

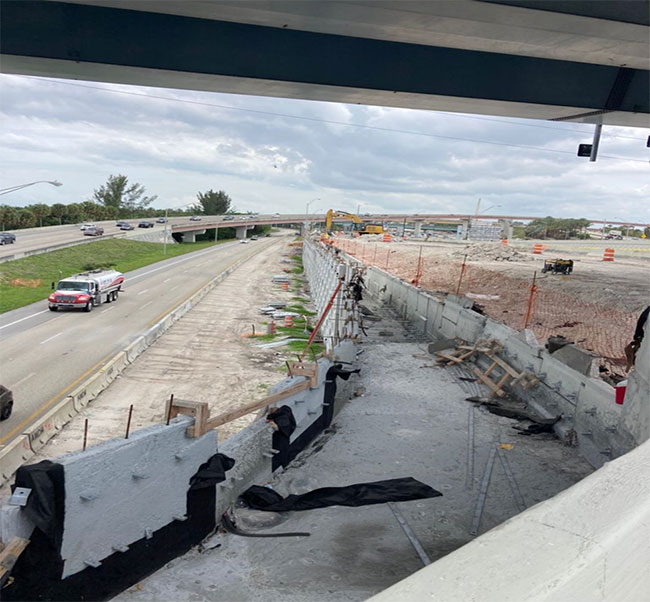

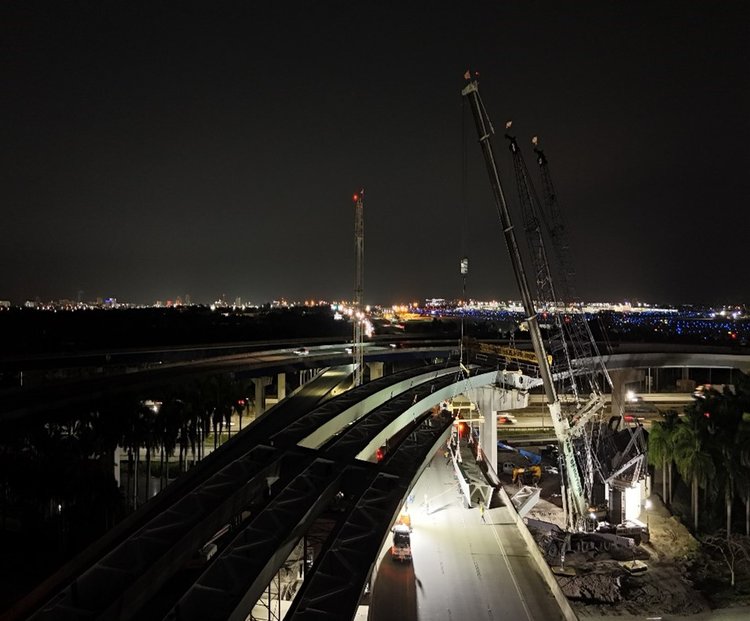

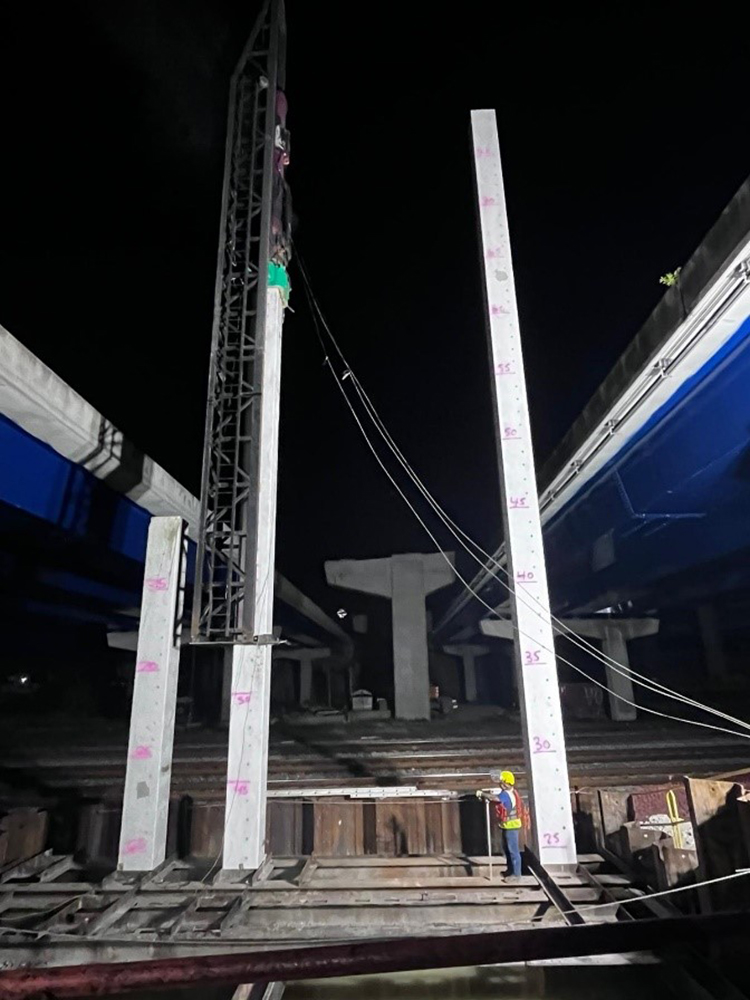

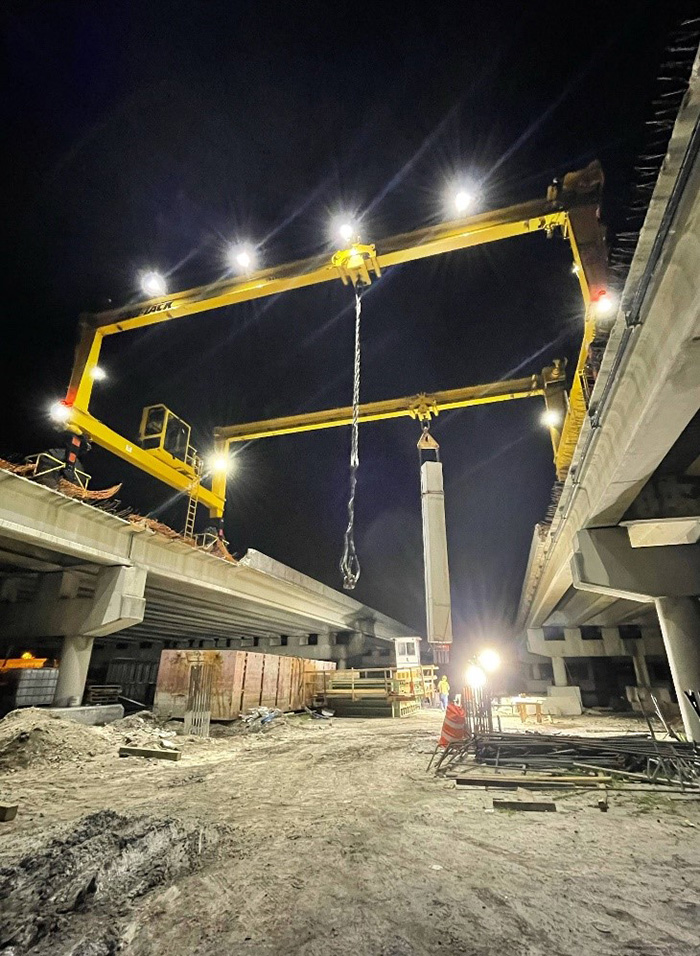

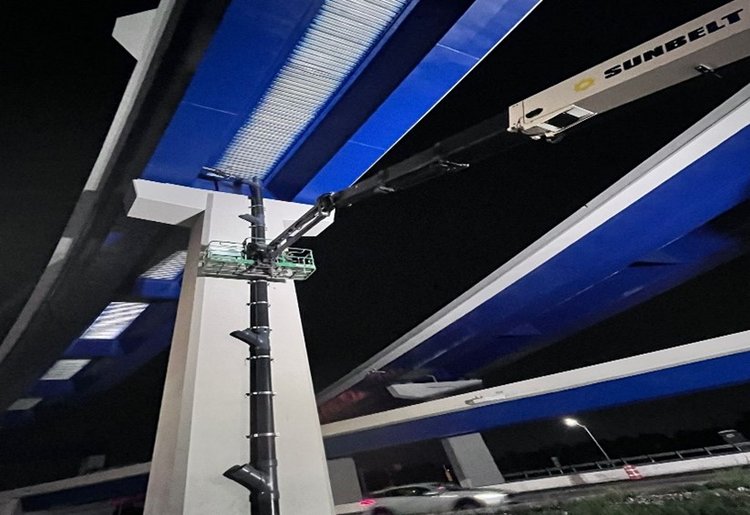

Bridge 11 – Nightly Construction   September 2024Structural Steel Erection at I 595_I 95 Interchange   02   September 2024Bridge 14 ? Structural Steel Bo lting   02   September 2024Existing Bridge Demolition ? Ramp I 5 95 WB to Turnpike   September 2024

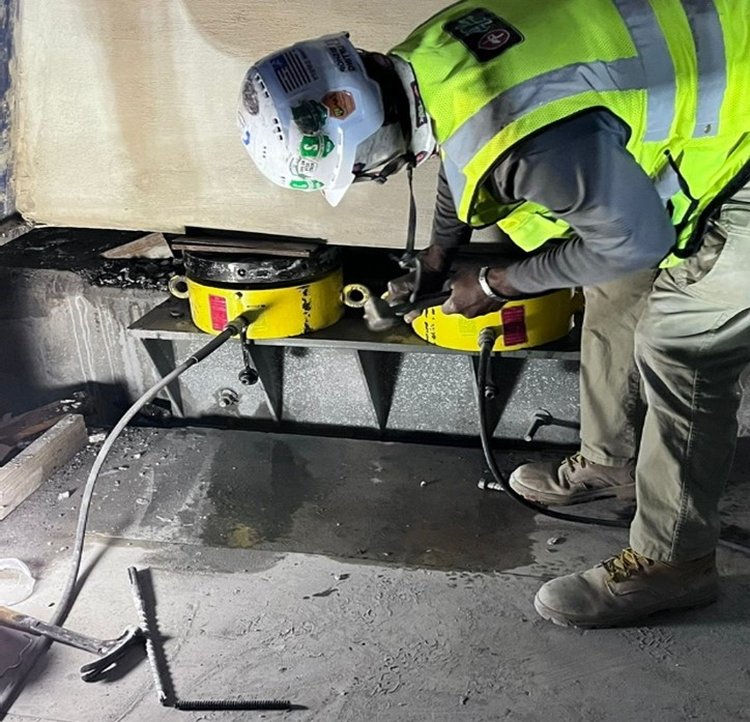

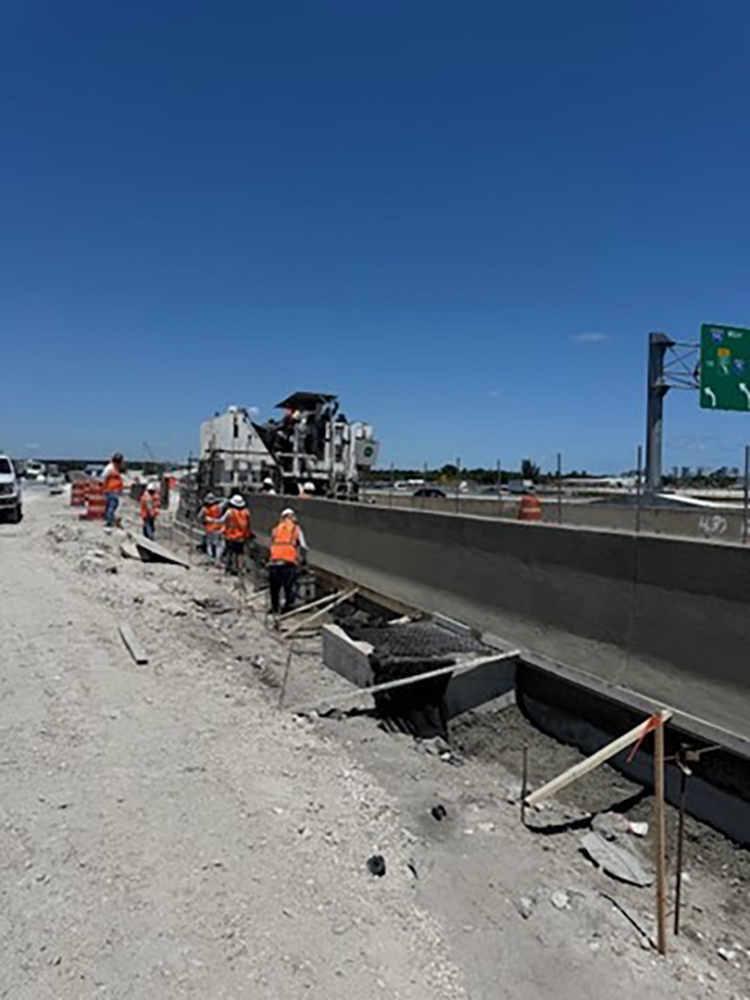

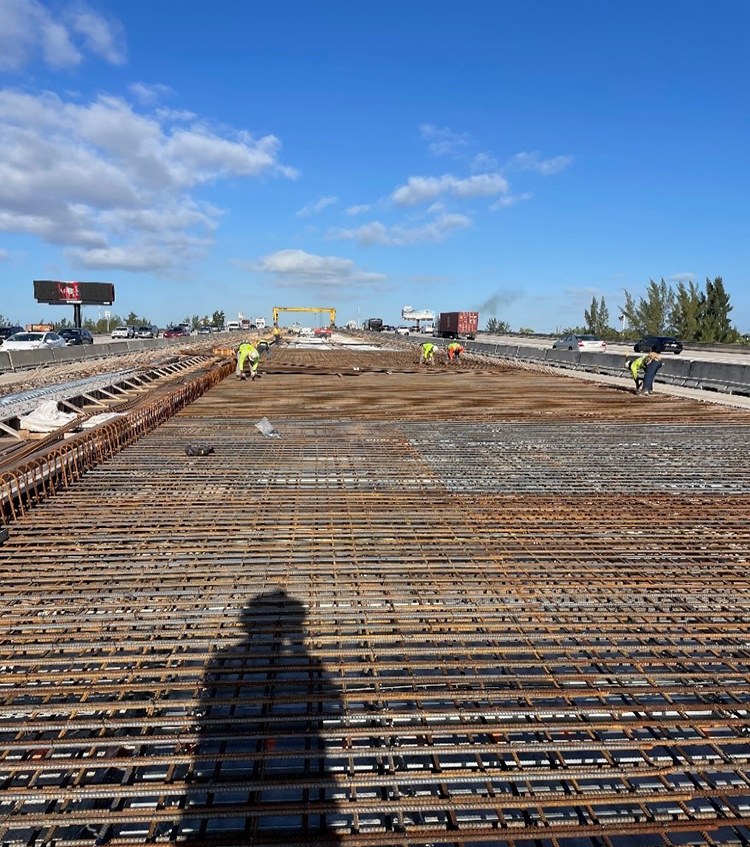

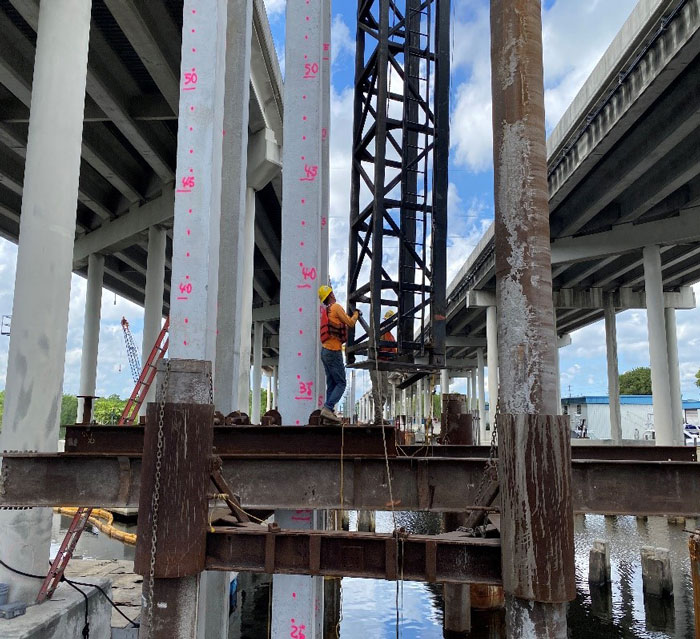

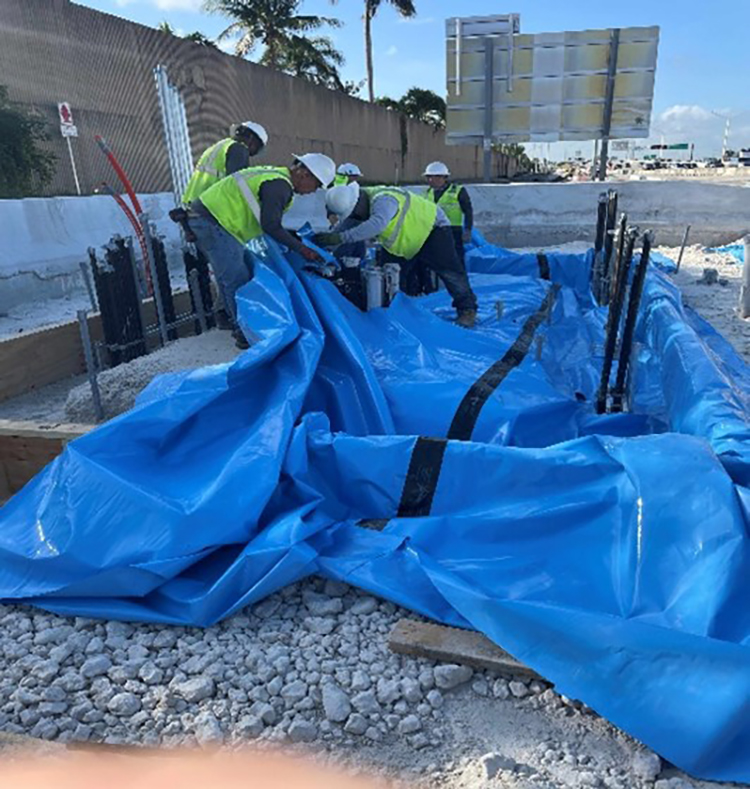

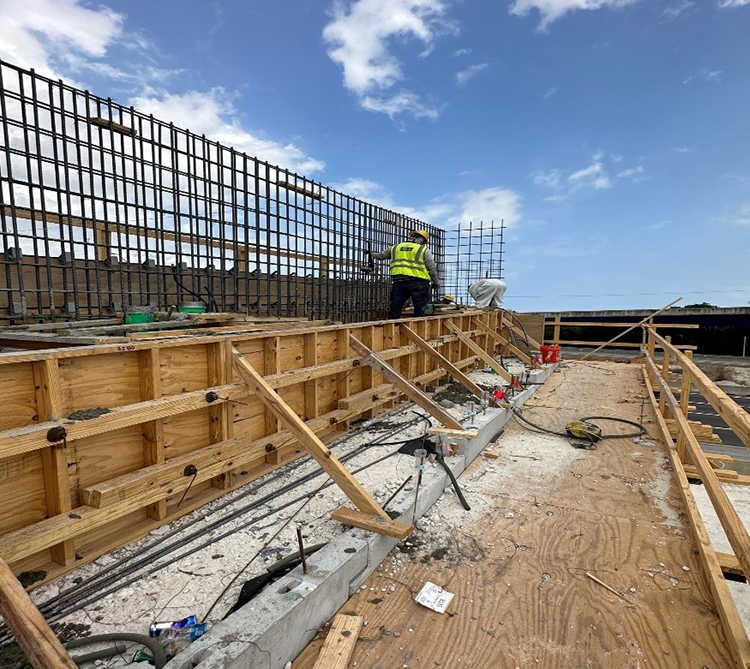

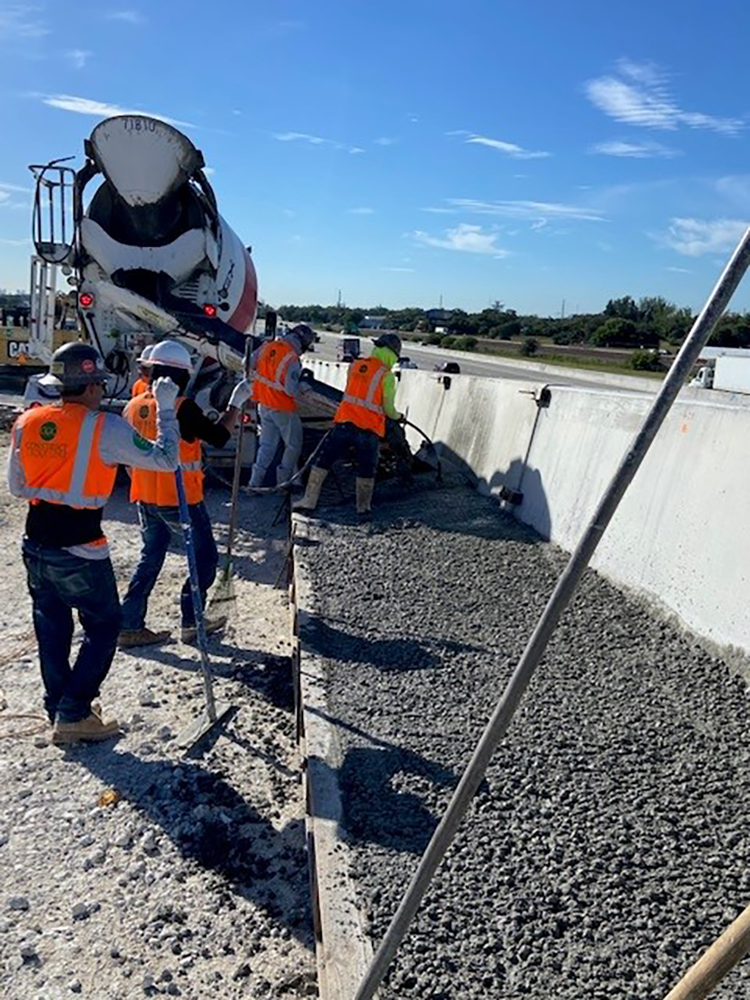

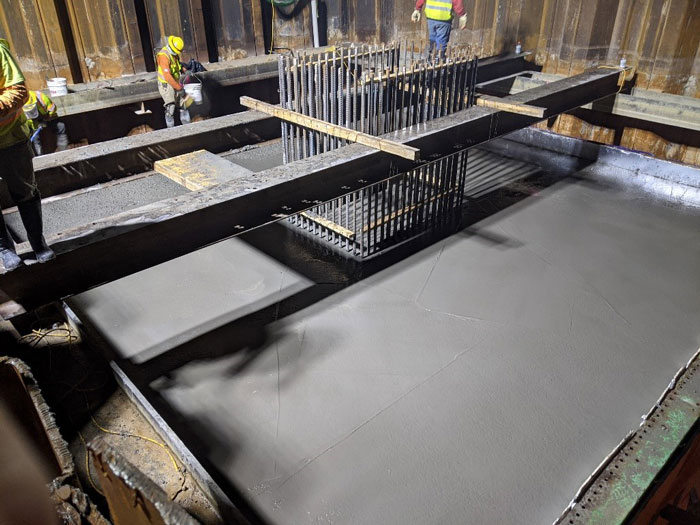

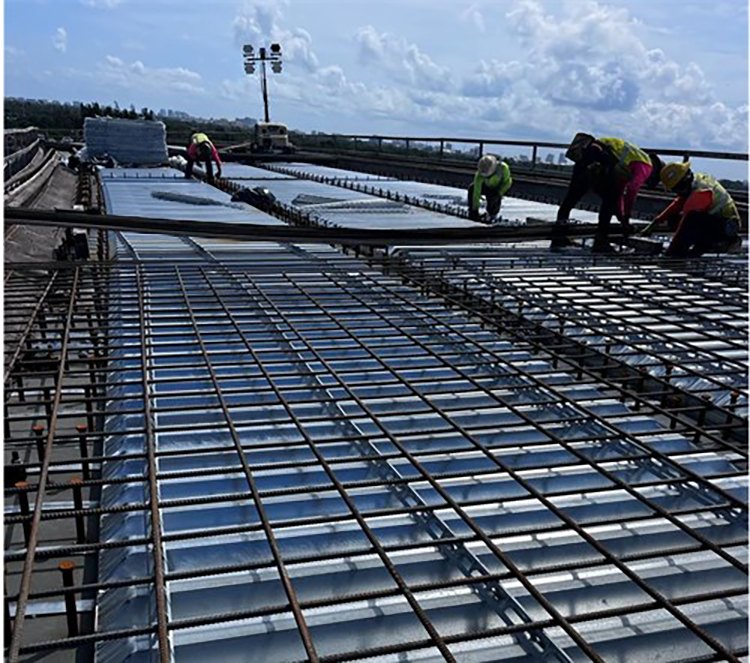

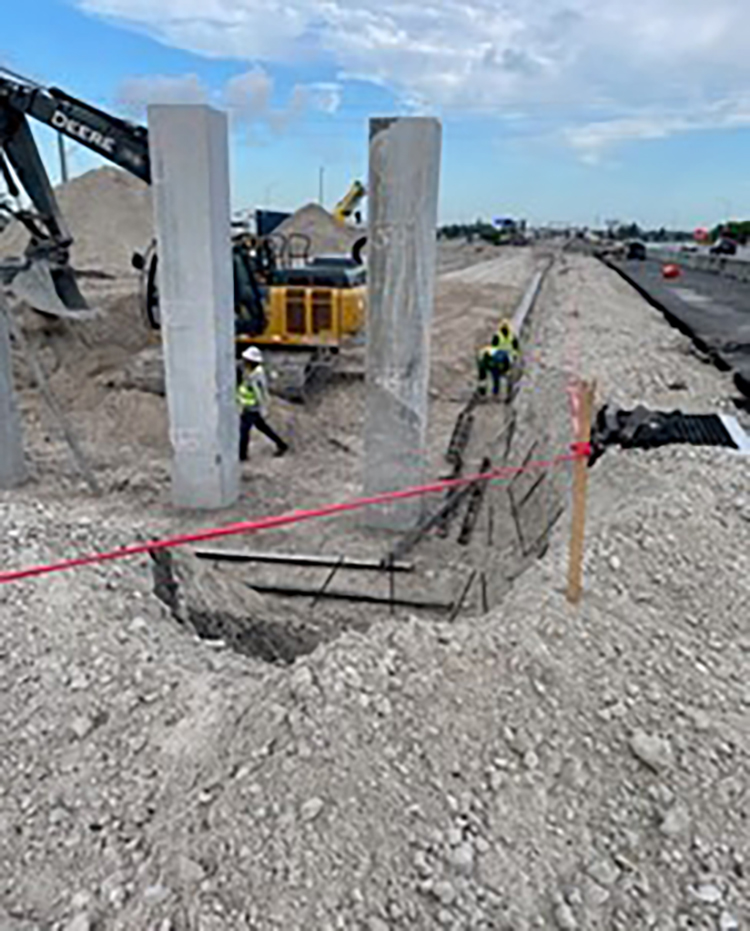

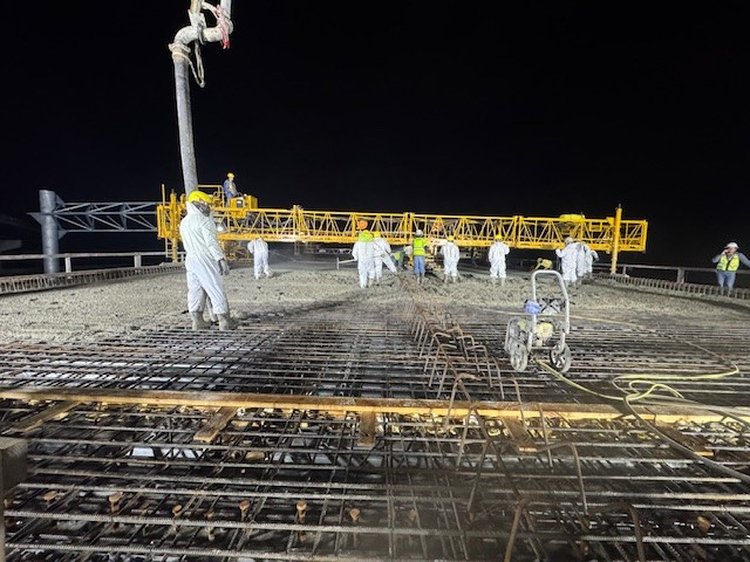

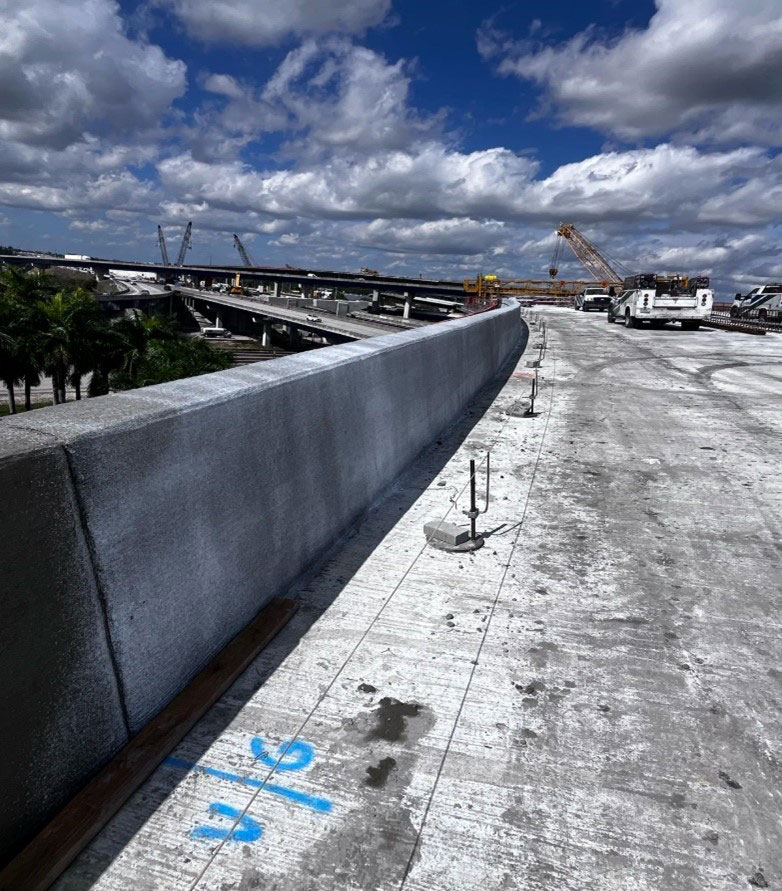

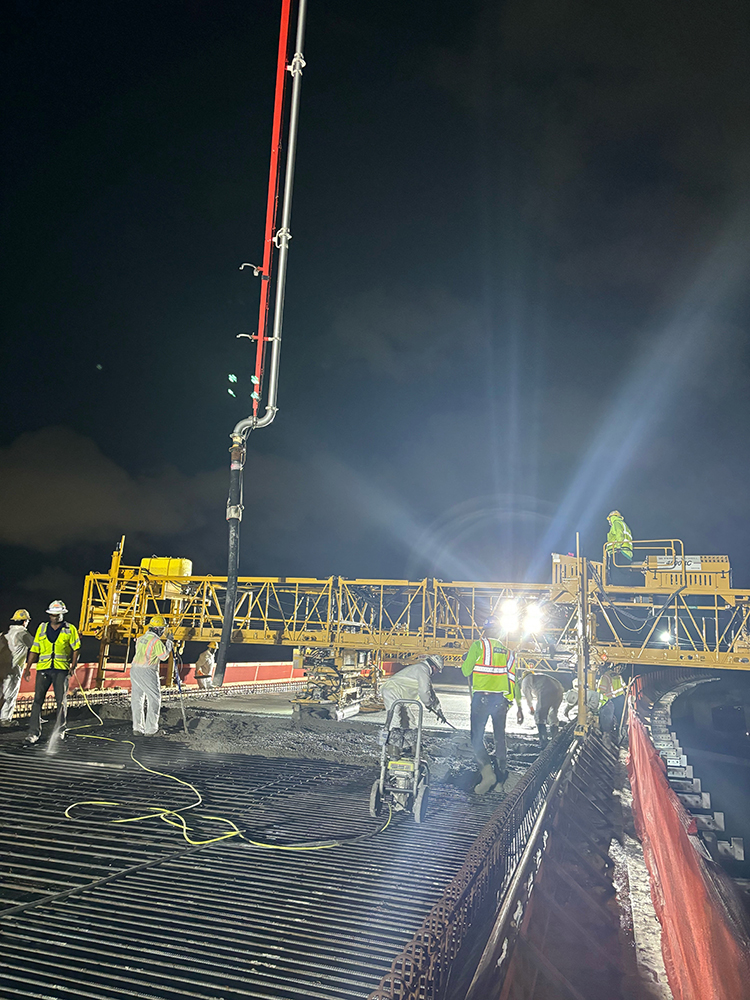

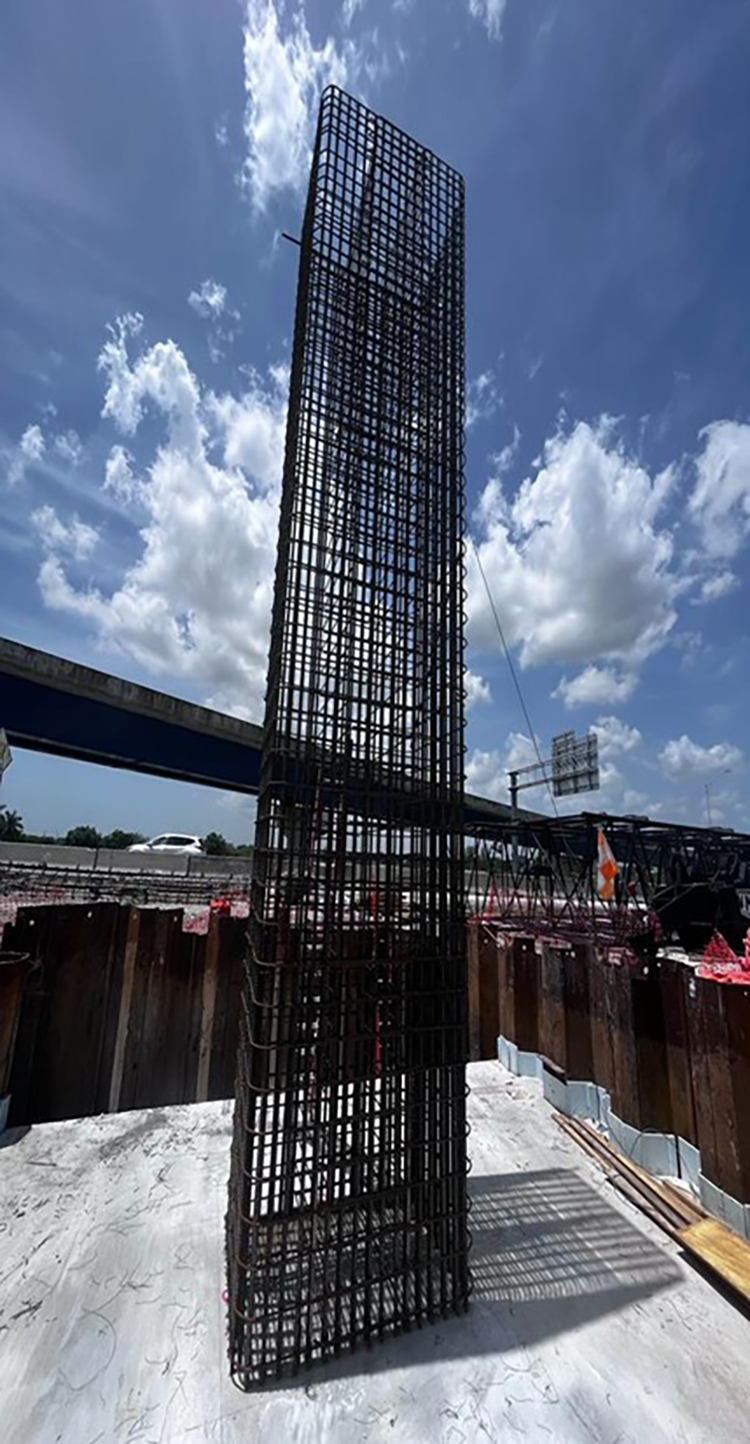

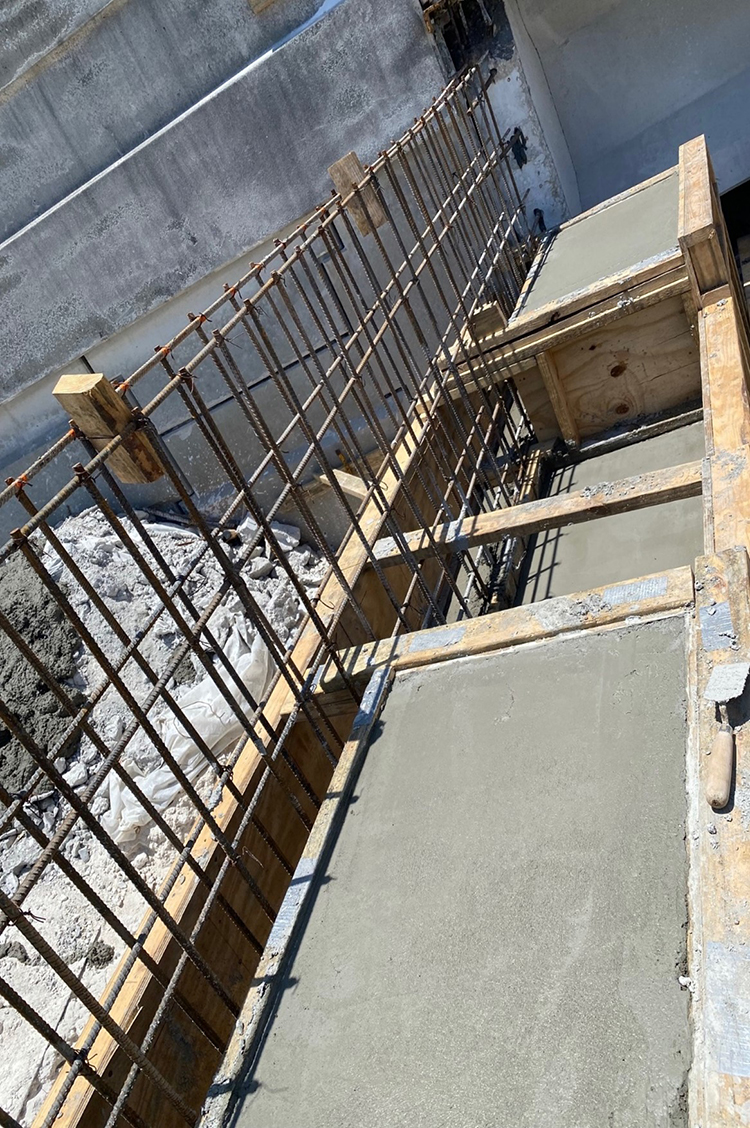

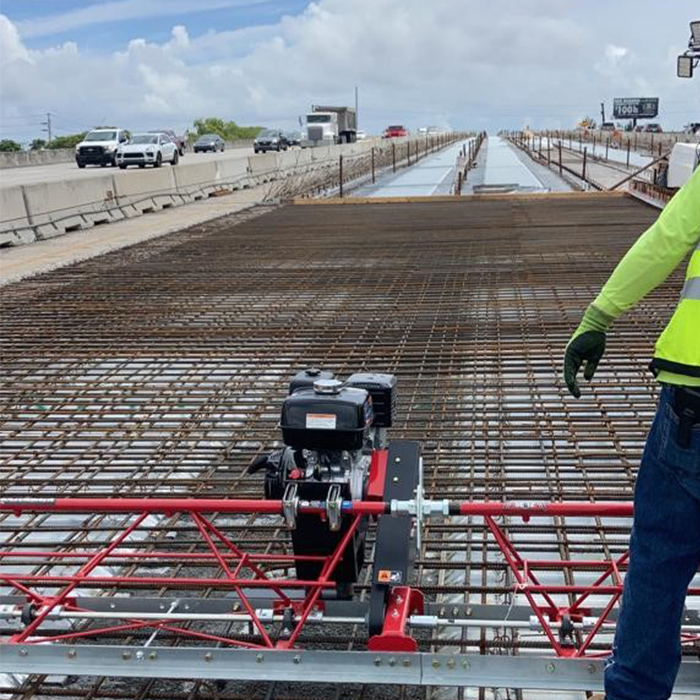

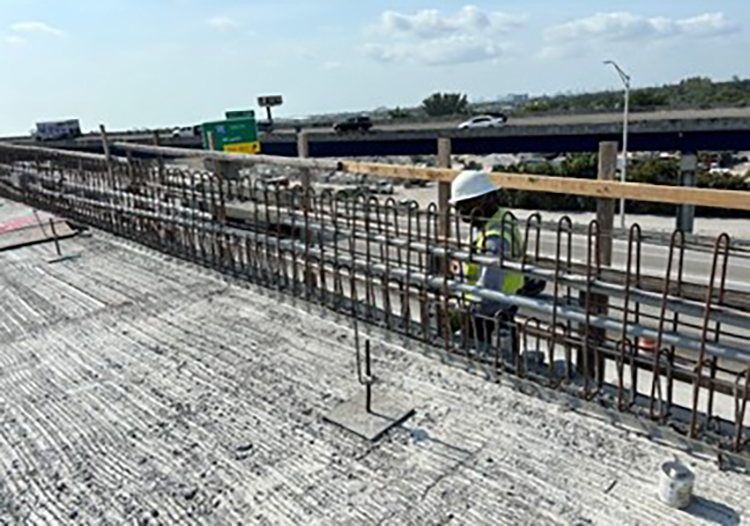

Bridge 26 Post Tensioning Mockup   03   September 2024I 95 SB on Ramp from Hollywood Blvd.   September 2024Forming and installing reinforcing steel for junction slab   September. 2024Placement of reinforcement and post tensioning system _October 2024

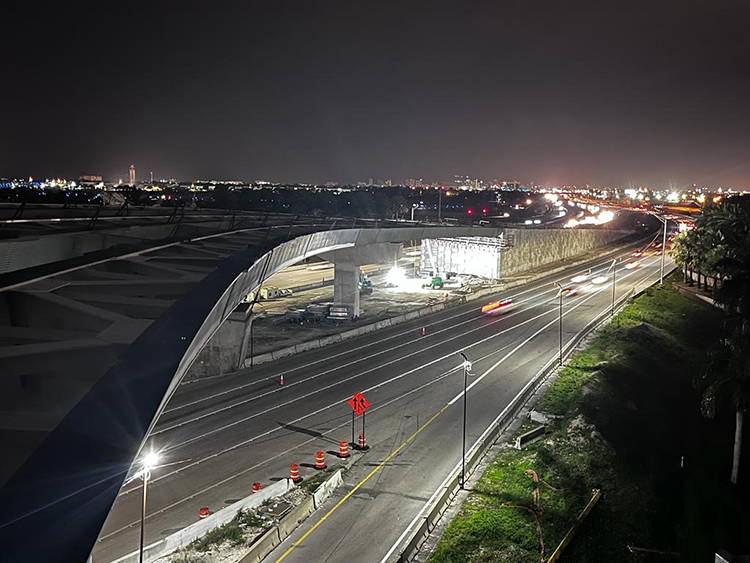

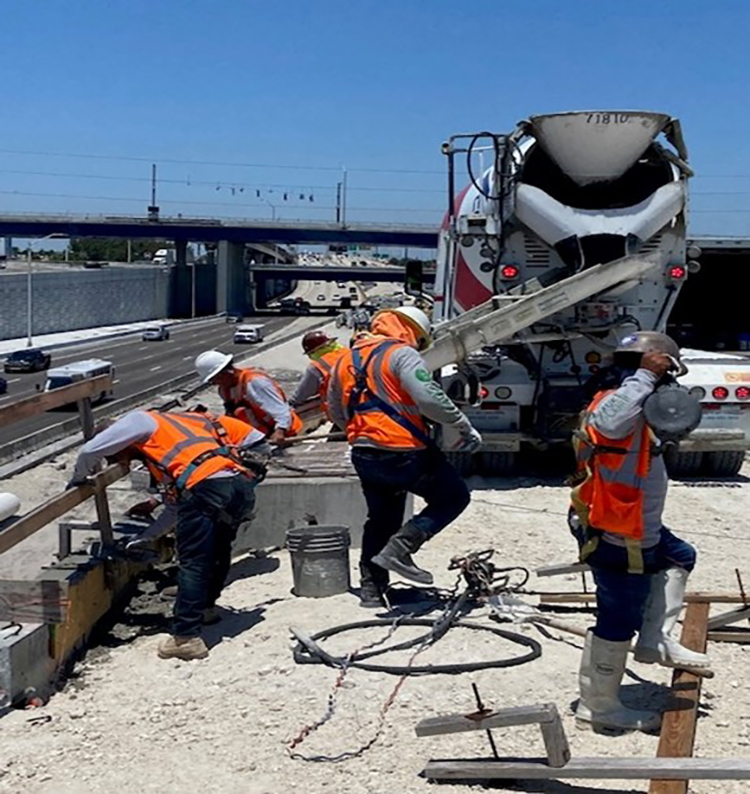

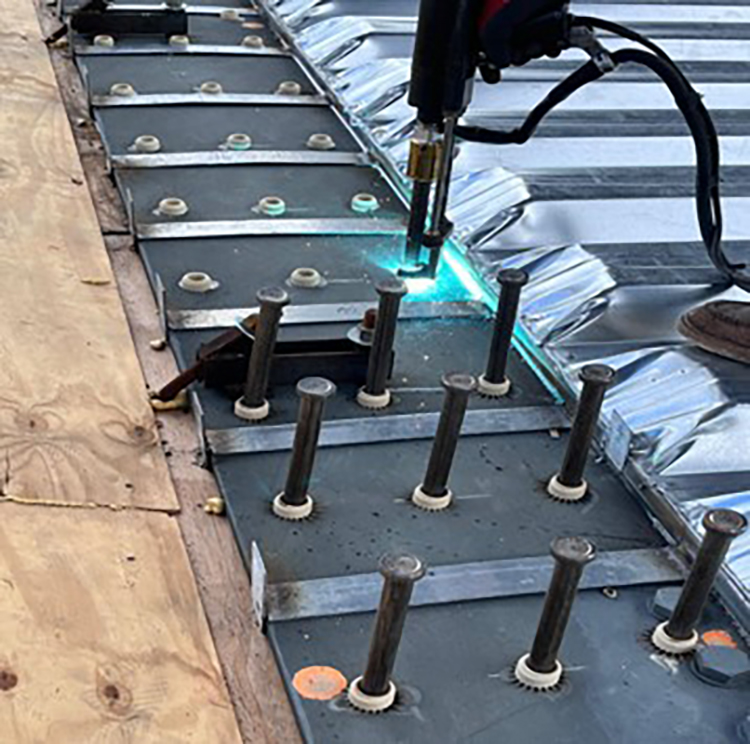

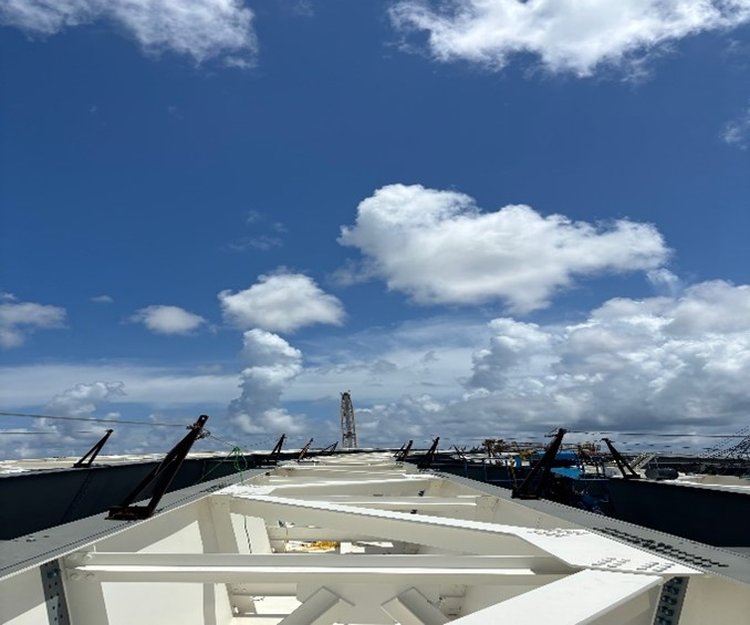

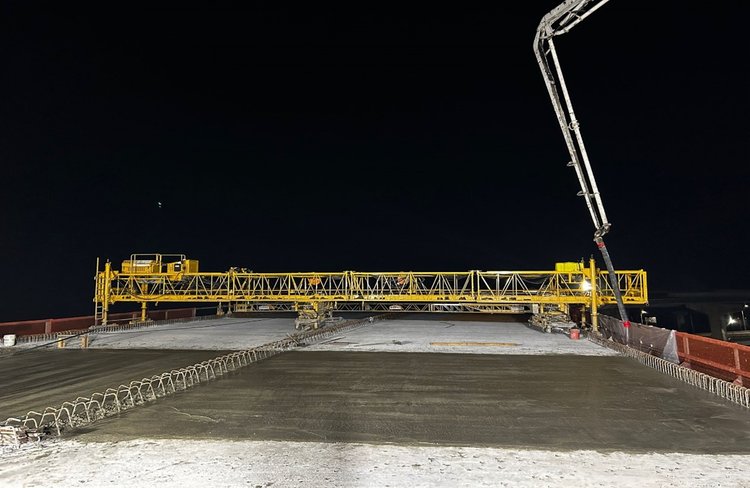

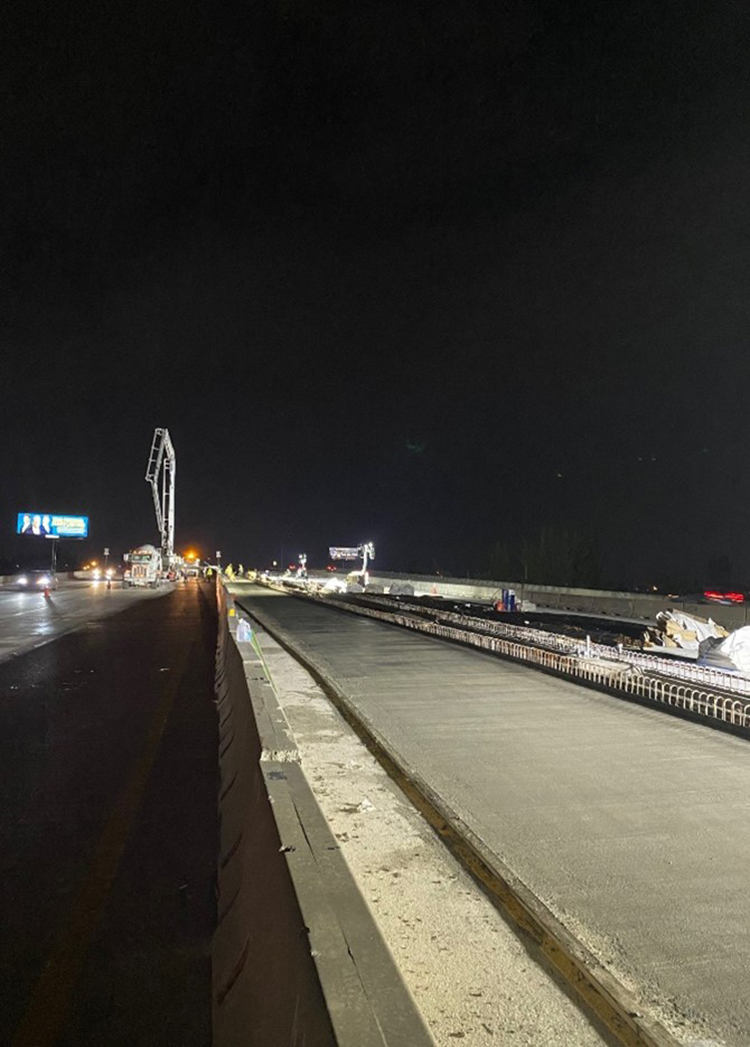

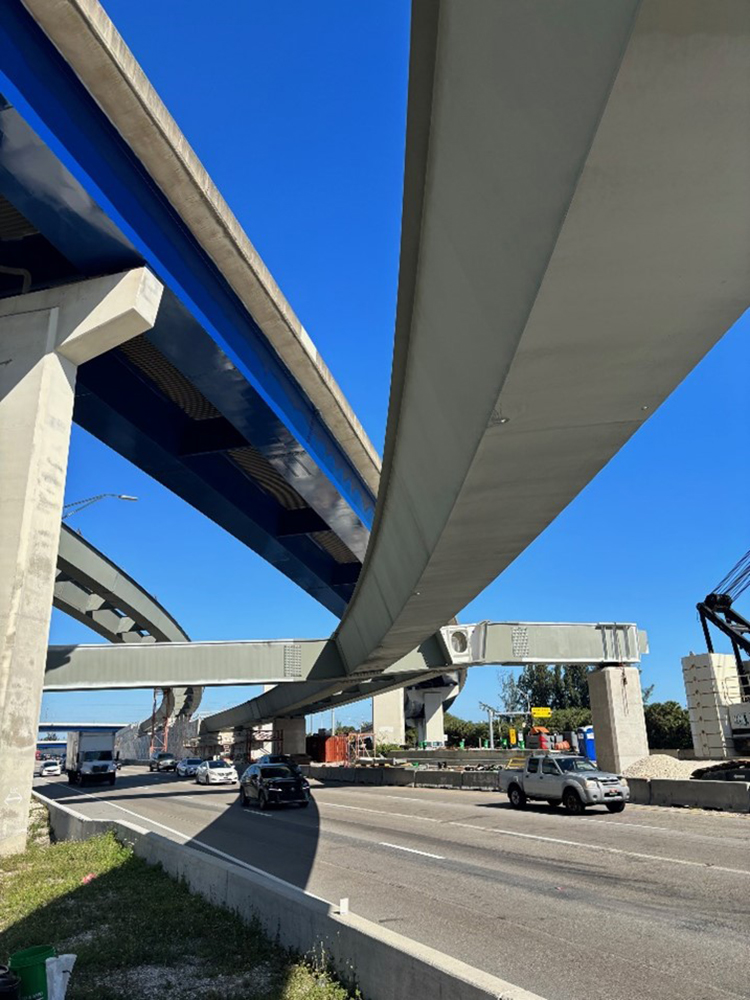

Overhead Sign Installation on I 595 WB_ October 2024Class V Bridge Coating_ October 2024I 595 WB Bridge Widening Deck Pour_ October 2024Direct Connector Ramp Finger Joint Installation_October 2024

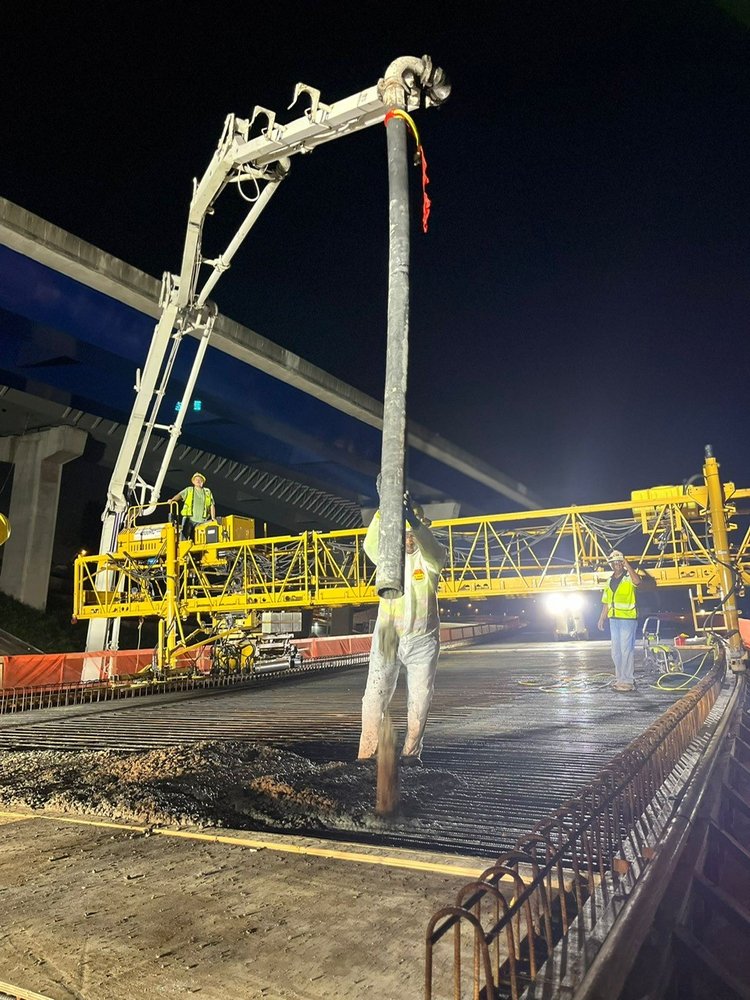

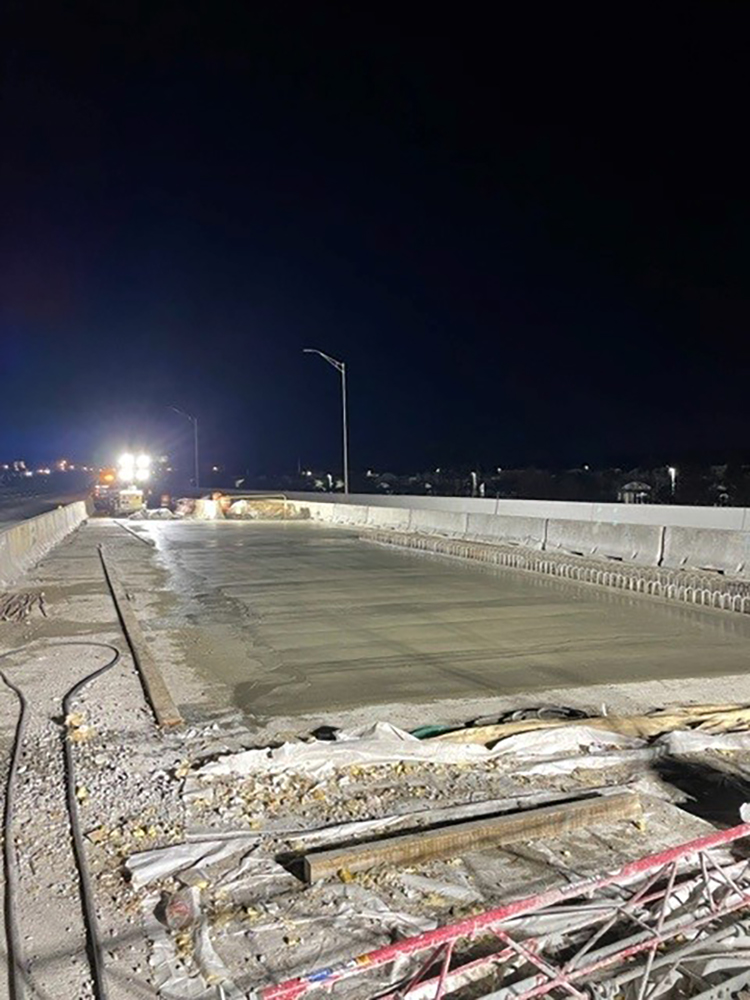

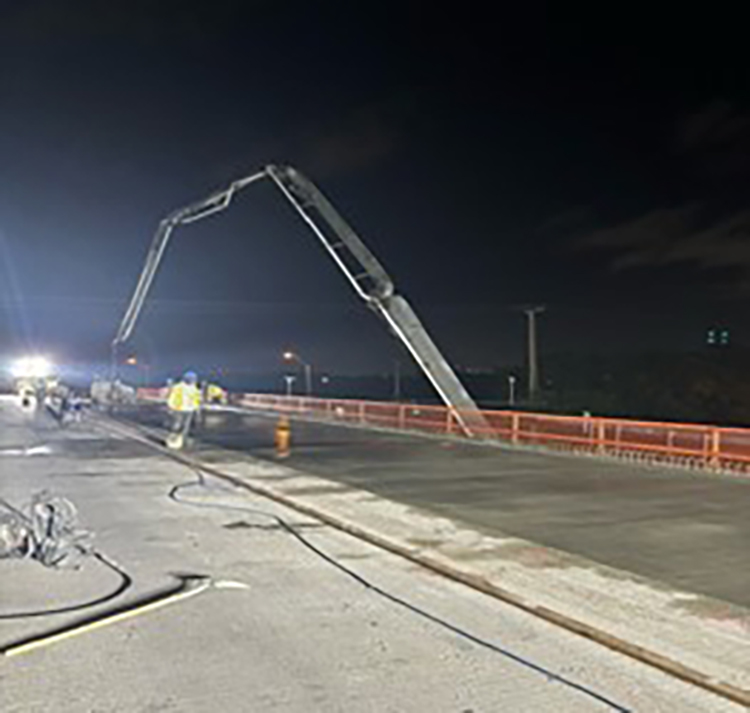

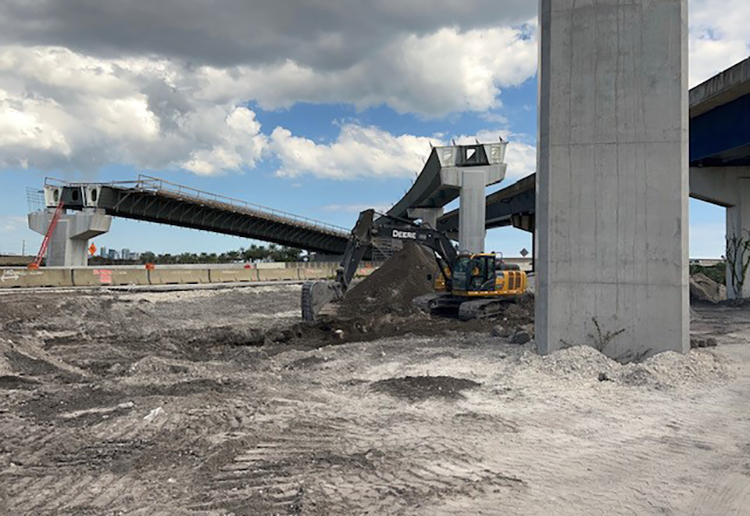

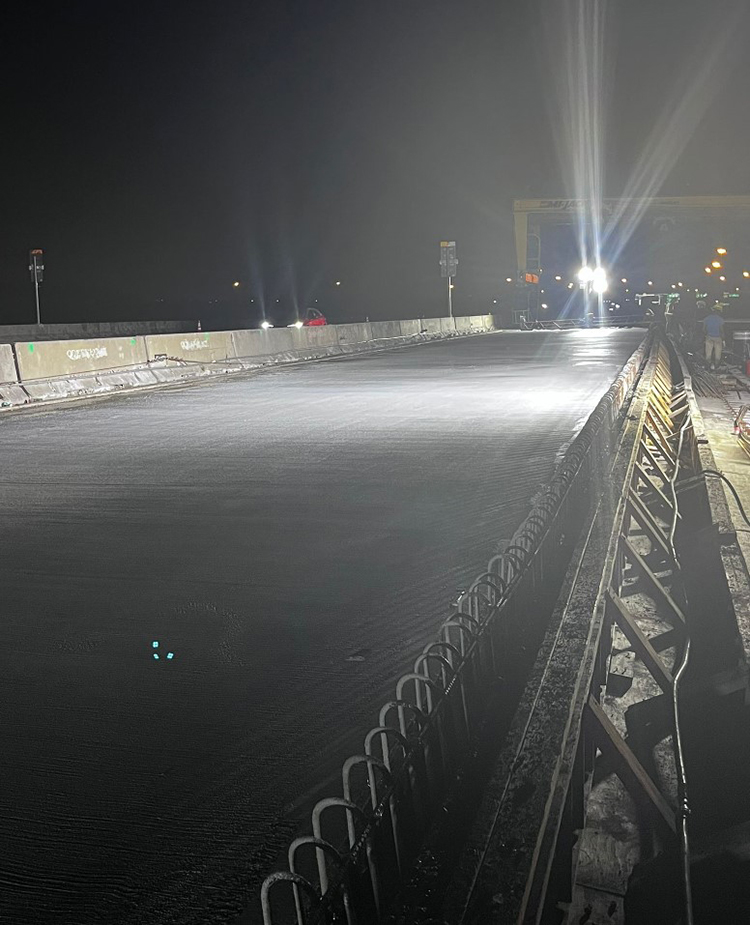

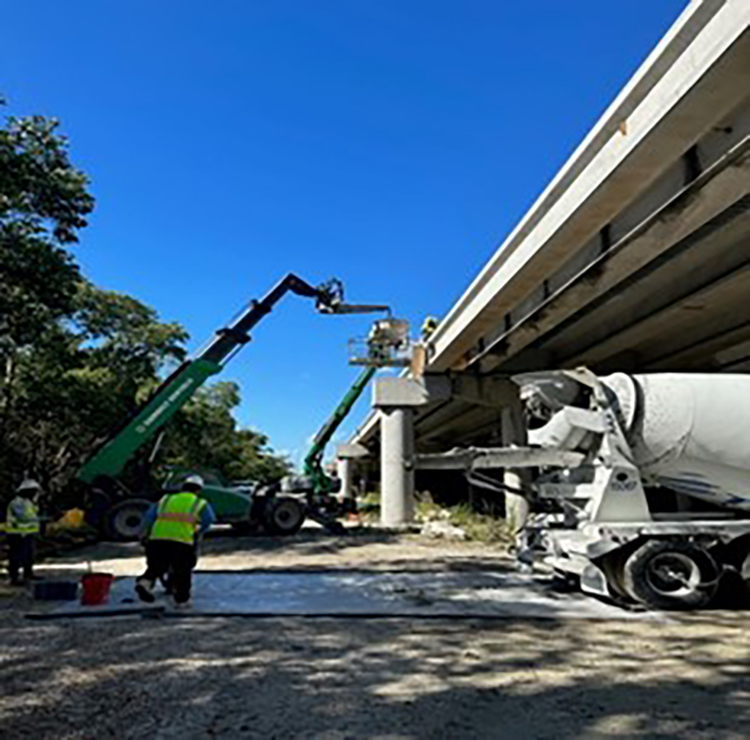

Post tensioning System _October 2024MSE Wall Junction Slab_October 2024New Direct Connector Ramp Bridge Deck Pour_ October 2024Bridge 11 (Pond Apple Slough) Nightly Deck Pours Nov. 2024

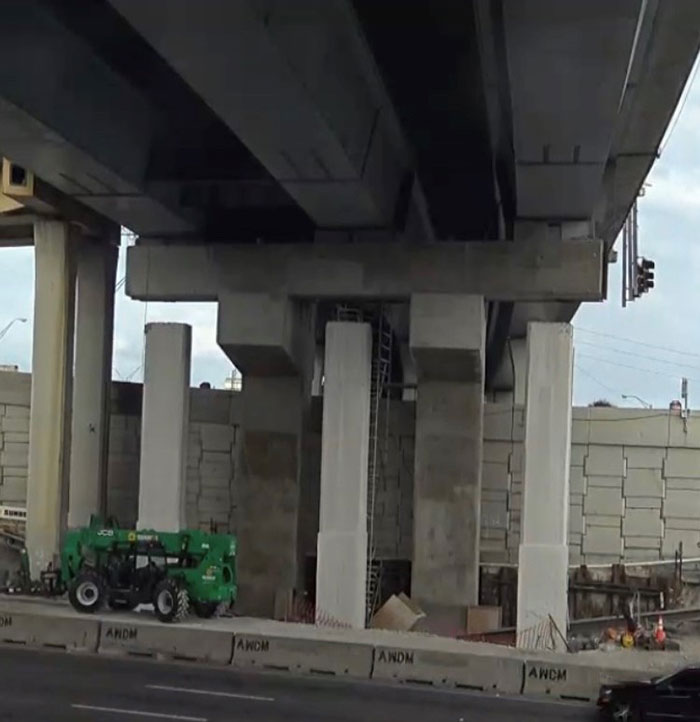

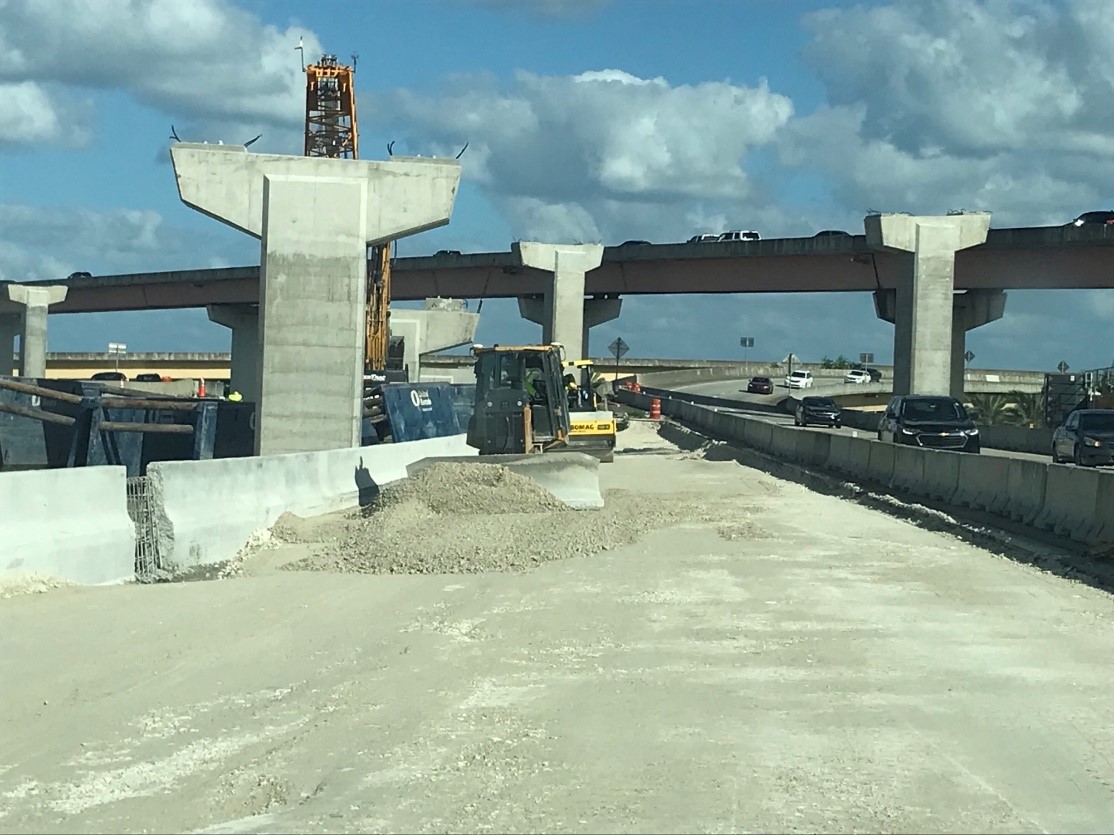

Bridge 12 (Direct Connect) ? Deck  Grinding & Grooving   Nov. 2024Bridge 7 & 8 Widening   Nov. 2024Class 5 Finish Coating at SR 84 I 95 Interchange   Nov. 2024Bridge 11 (Pond Apple Slough) Fender System Restoration   Nov. 2024

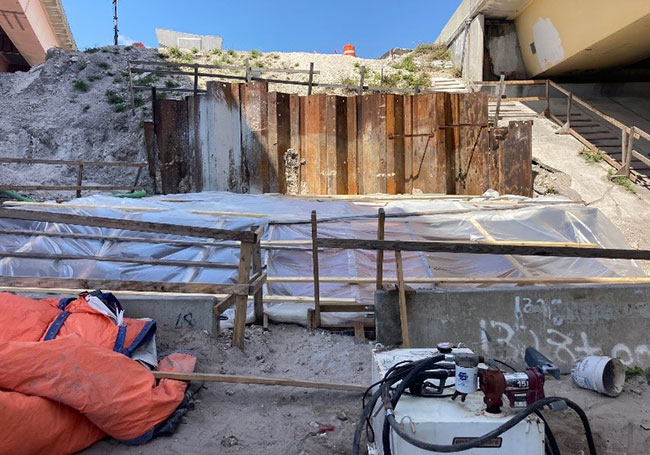

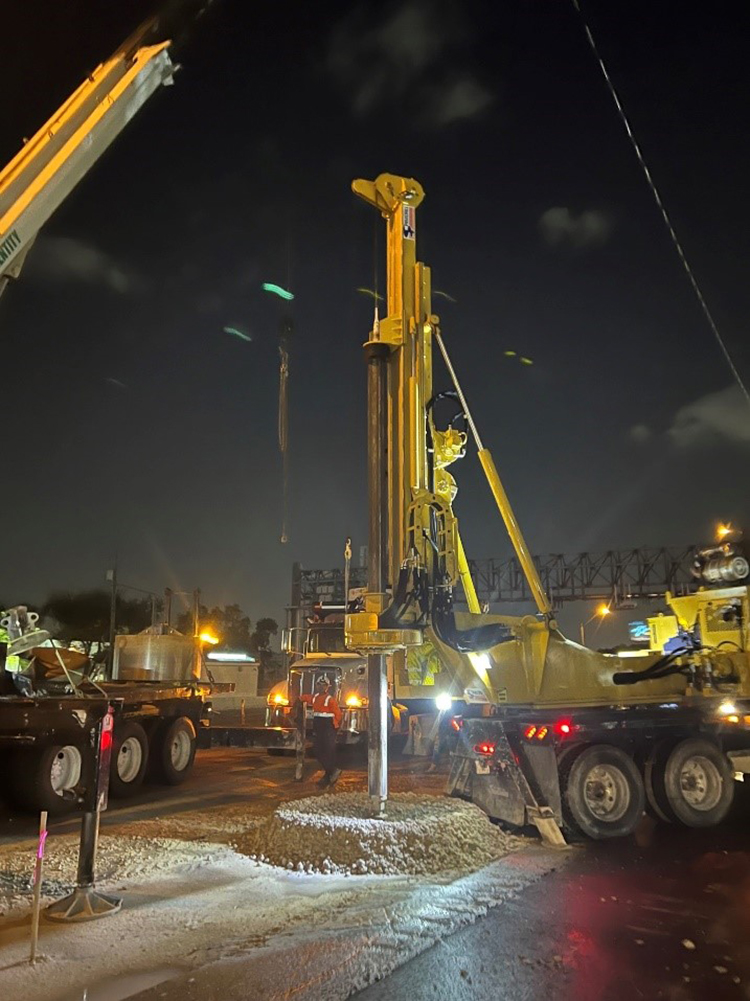

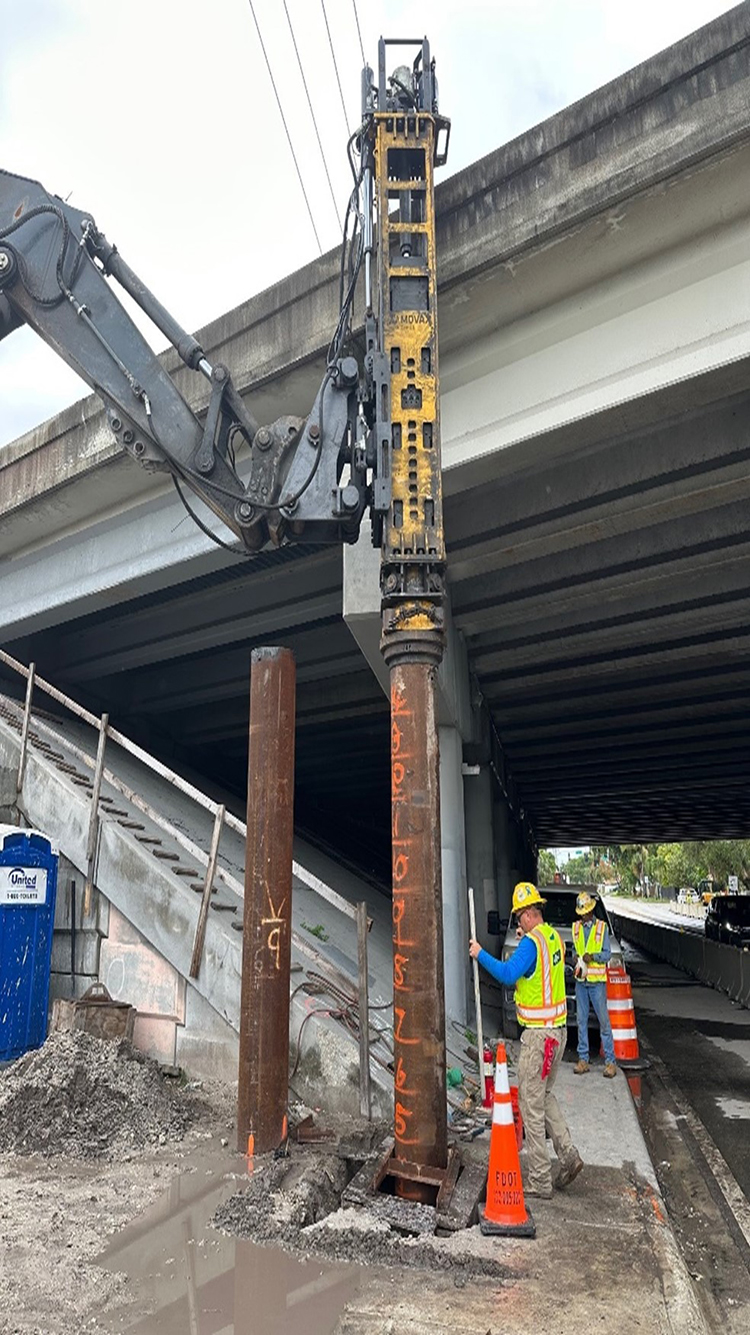

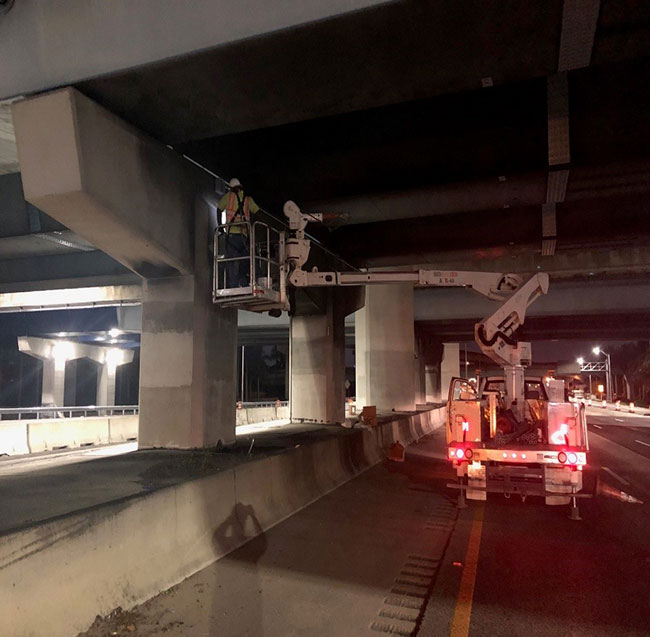

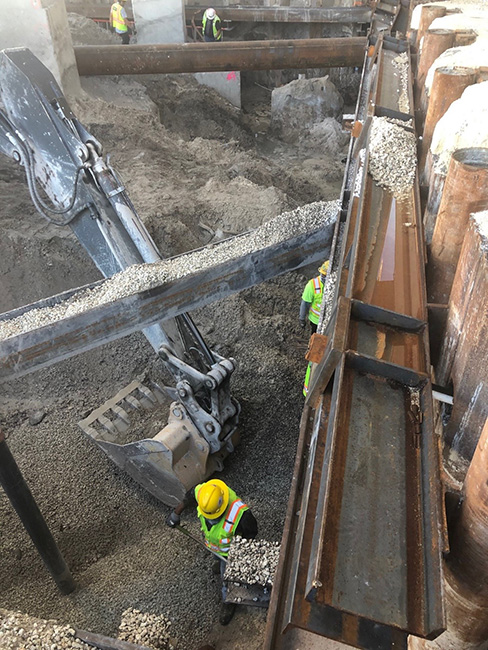

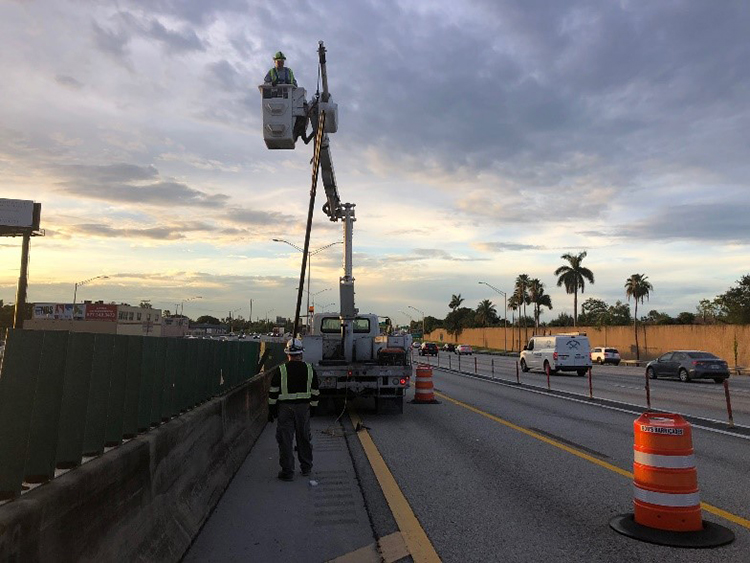

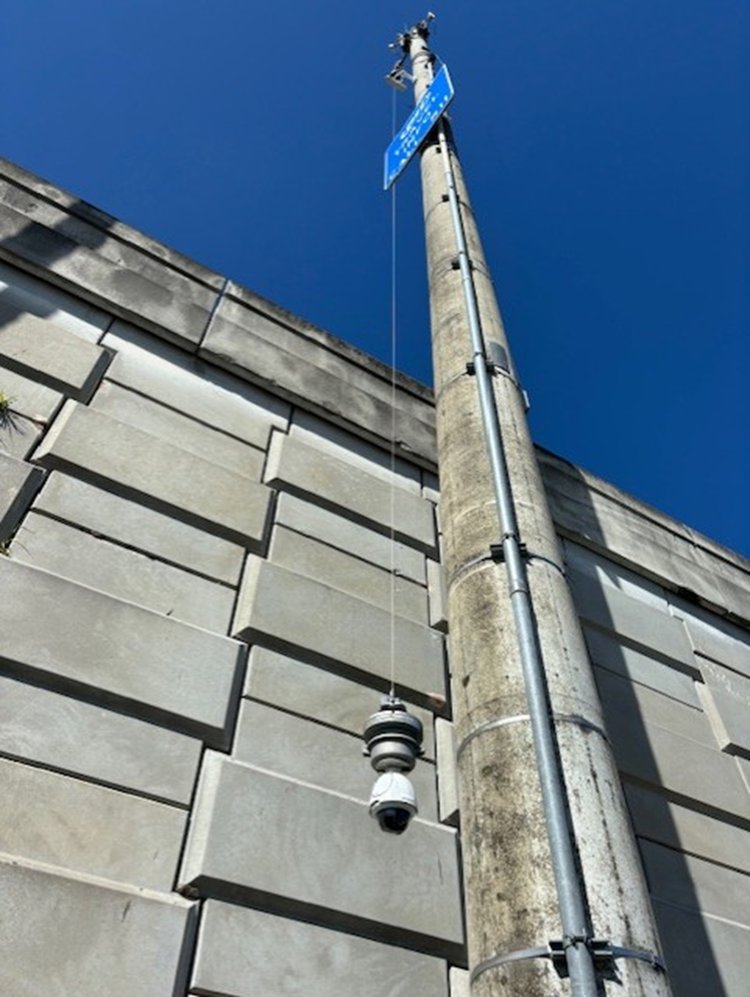

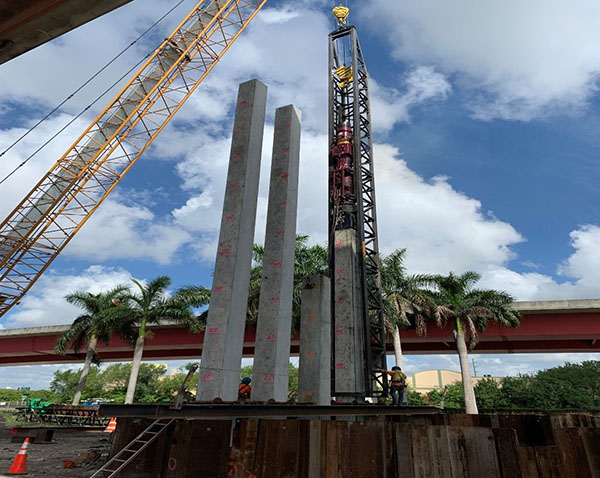

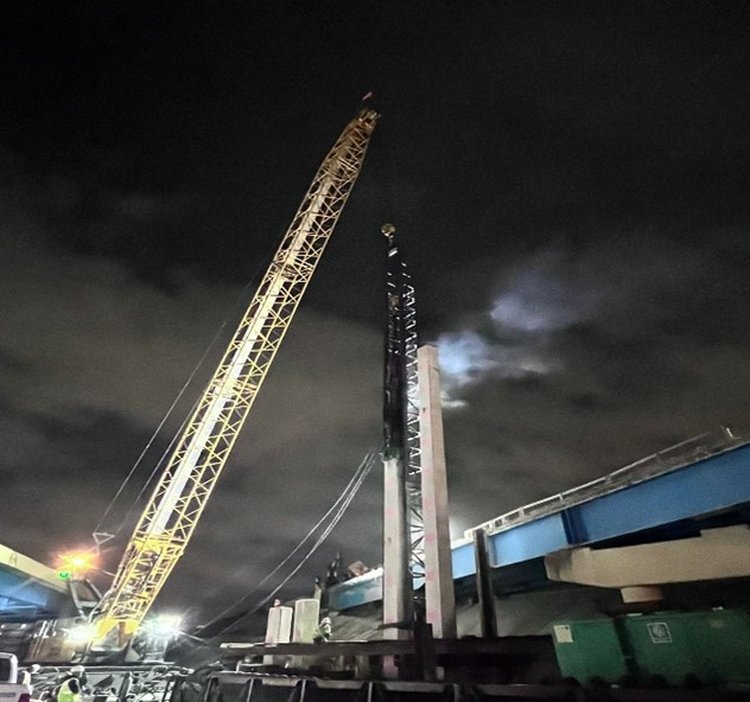

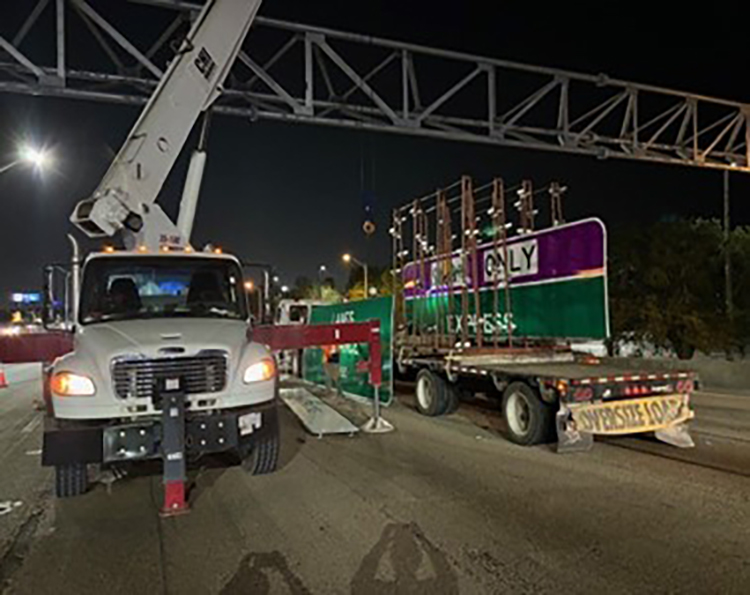

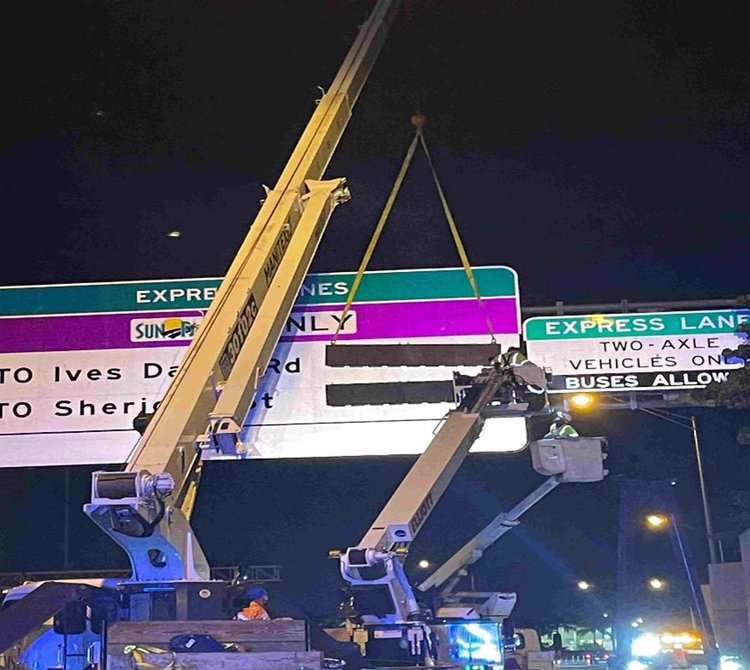

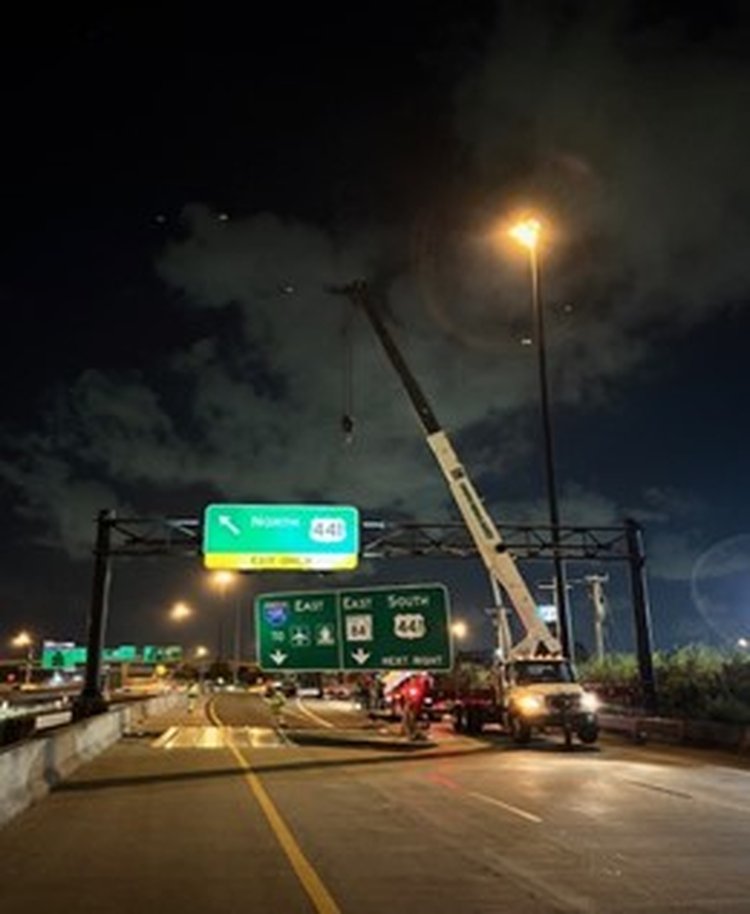

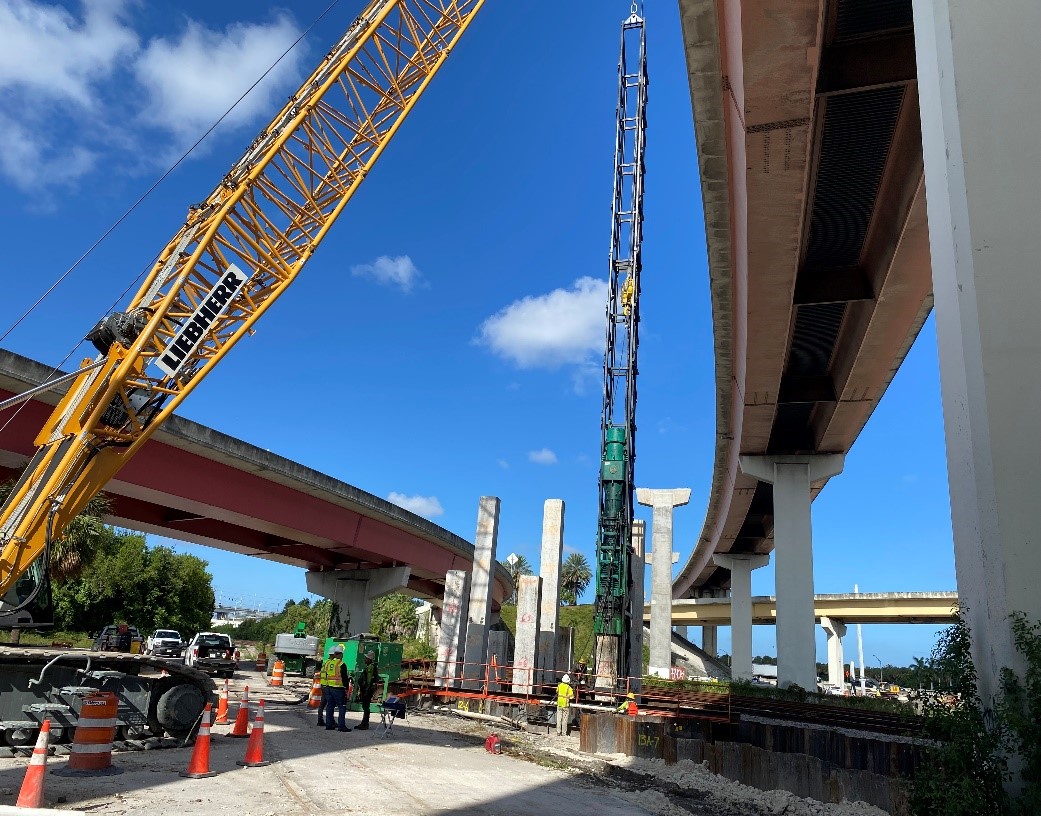

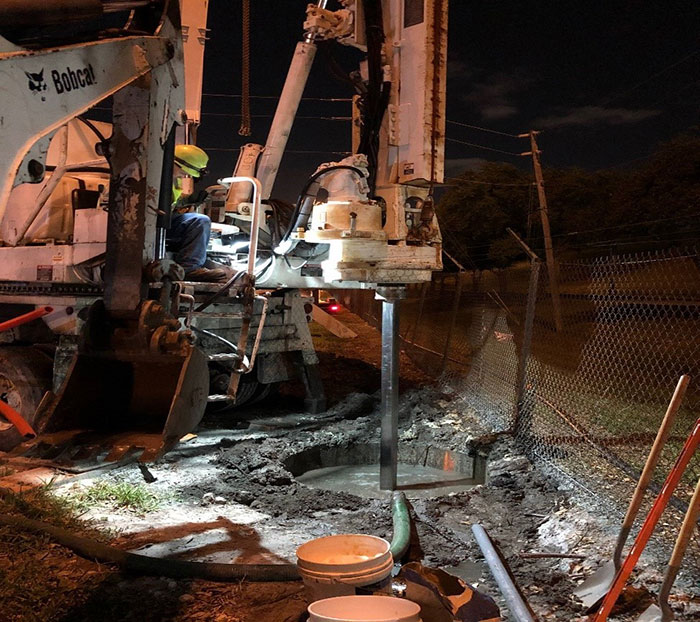

Installation of new toll rate DMS panels   Nov. 2024Delivery and installation of overhead sign structure on I 95 SB, south of Sheridan Street   Nov. 2024Bridge 10 ? Pier 3 & End Bent 4  – Pile Driving   Nov. 2024Installation of a new CCTV camera on lowering device   Nov. 2024

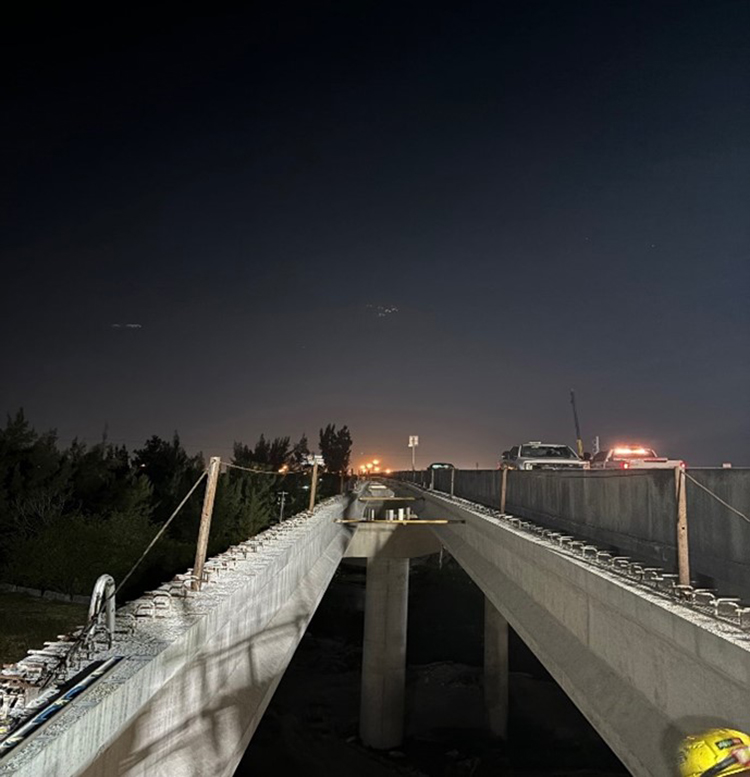

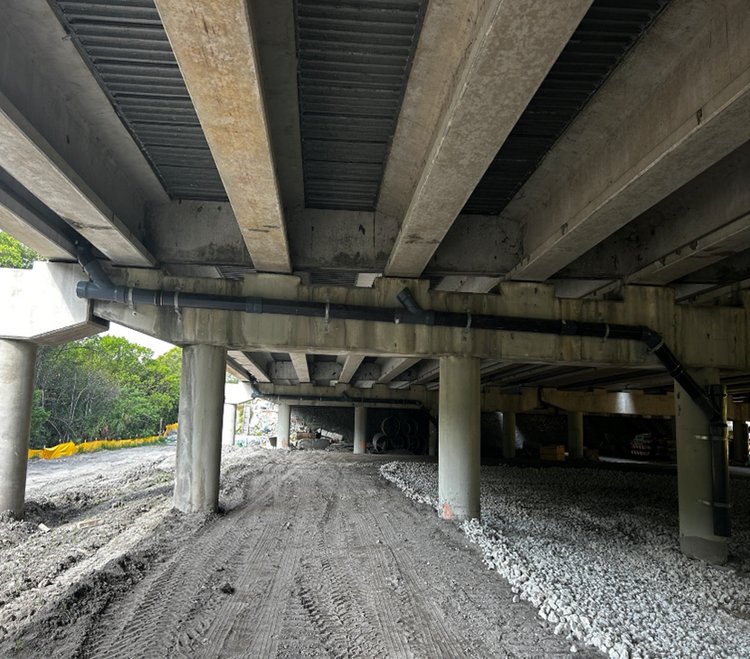

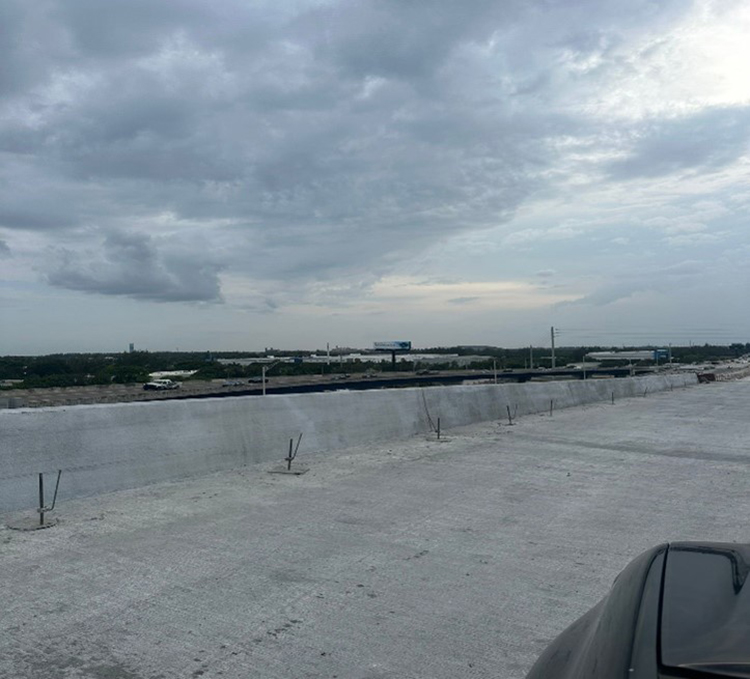

Final grading slope on I 95 SB   Nov. 2024Pouring junction slab at MSE Wall 8 6   Nov. 2024Bridge 13A – Concrete Deck Pours   Nov. 2024Bridge 14 (Proposed Direct Connect)    Nov. 2024

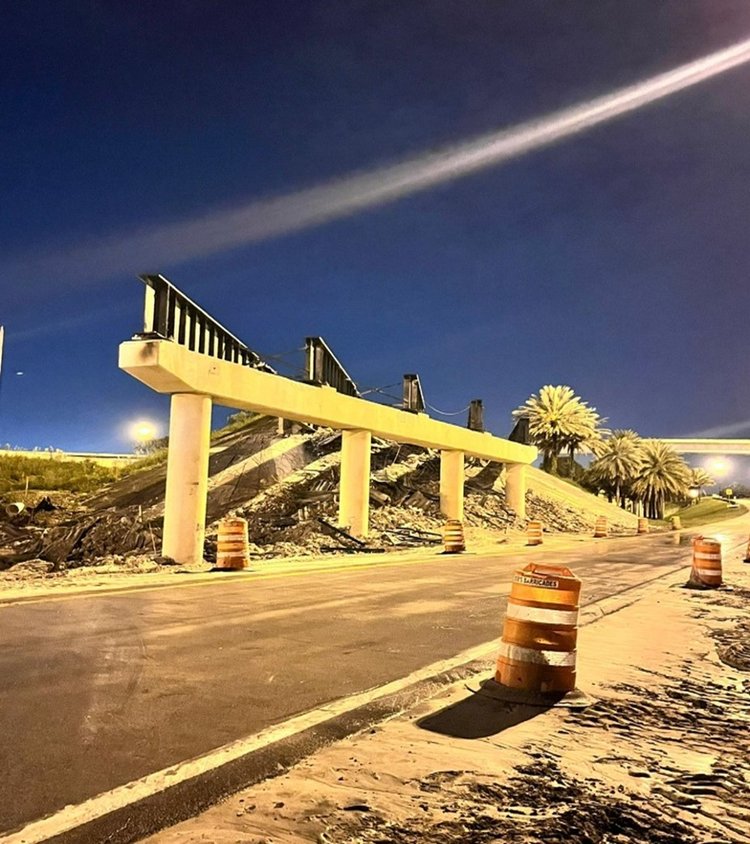

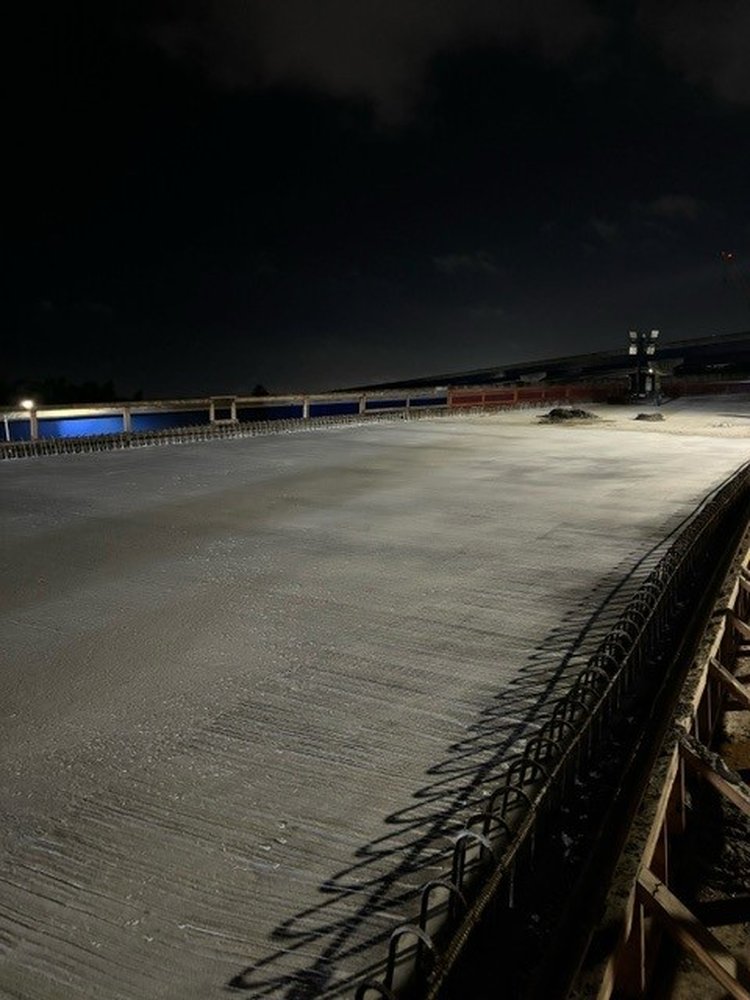

Bridge 11 (Pond Apple Slough) Nightly Deck Pours   Nov. 2024

Please click on a link below to view construction projects
in other areas of Broward County:
I-95 Palm Beach CountyInterstates Northern Palm Beach CountyNortheast Western Palm Beach CountyNorthwest
I-95 Palm Beach CountySoutheast Northern Palm Beach CountySouthwest
Florida Department of Transportation
Florida Department of Transportation
Florida 511 Travel Info
FDOT District Four Youtube
SunGuide
Kids Zone
75 Express
95 Express
zero
